Presentation for LFPH AG September 18th 2018
Presentation for LFPH AG September 18th 2018

• Status on fund - Prins Henriks Skoles Ejendomsfond
• Budget and funding – New Prins Henriks Skole
• Status on the NPHS building project
      • Preliminary sketches of the new school will be presented at the meeting        Ejendomsselskabet
                                                                                       Den Franske Skole
• Project organization, process, communication and main schedule

• N

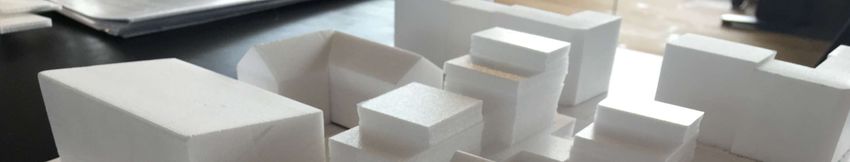

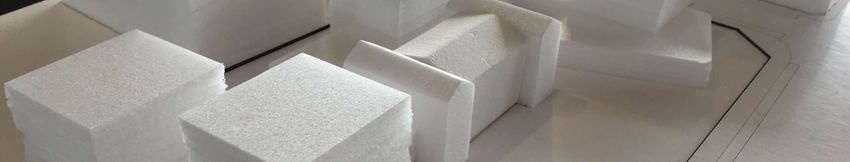

                                            Master plan Rolighedsvej

                                                                              The area dedicated
                                                                              for the sports faclities

                                                                              The area dedicated
                                                                              for the new school

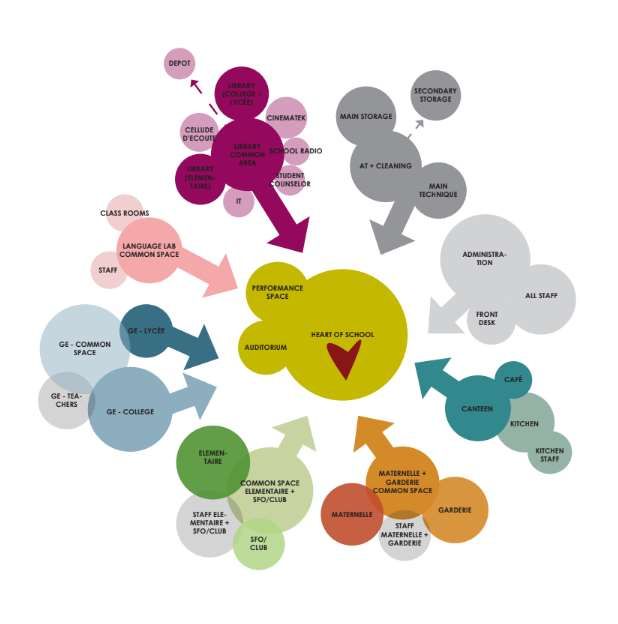

Room program diagram of new LFPH
Presentation for LFPH AG September 18th 2018
Status on fund - Prins Henriks Skoles Ejendomsfond

• The purpose of establishing the fund
    •   The most adequate legal construction
    •   Contrary to the present structure a fund is able to grant all profit to the School
    •   Condition for donors to contribute
    •   A tax saving of DKK 38.000.000 on sale of the Værnedamsvej buildings is essential
        to the project
• The fund – Prins Henriks Skoles Ejendomsfond (PHSE)
    • The primary aim of the fund is to build and maintain adequate education facilities
      for LFPH, secondly to support children and the schools activities
    • All shareholders, except LFPH, have been asked to donate their shares to the fund
    • LFPH must sell it’s shares – an evaluer will evaluate the market price of the shares

    • LFPH AG (in October) must decide on selling the shares
• Governance
    • LFPH board appoints 4 members (2/3) of the PHSE Board
    • The members must be appointed in respect of the arms lenght principles for funds
    • The donors will appoint 2 members
Presentation for LFPH AG September 18th 2018
Budget for the new Prins Henrik School (NPHS)

• The budget for the NPHS has been adjusted to DKK 395.628.000 (land included)
  based on an evaluation of price development since recent projects
• The initial budget was based on advise from Henning Larsen Architects based
  on an analysis of the price for construction of schools
• The increase of the budget from DKK 347.300.000 relates to reserves (DKK
  30.000.000) to create a buffer, should construction market prizes increase, and
  developer costs (advisors, parking, insurances, own cost etc.)

Prize/sqm for other school projects (exclusive owners costs)                  DKK
Ny Islands Brygge Skole                                                    23.990
CIS Nordhavn                                                               25.057
New Prins Henrik School (owners cost and reserves not included)            23.988
Presentation for LFPH AG September 18th 2018
Project cost

New Prins Henrik School budget
Advisors (Architect, Engineer, Management Contractor)    48.878.000
Building/constructions cost                             219.900.000
Owners other                                             16.350.000
Security buffer                                          30.000.000
In total                                                315.128.000
Cost of land                                             80.500.000
Project cost in total inclusive land                    395.628.000

Prerequisites – sqm for 1.200 pupils
Demolishing sqm                                               3.300
Renovating sqm                                                1.400
New building sqm                                              9.800
New school in total                                         11.200
Landscape sqm                                                 3.500
Presentation for LFPH AG September 18th 2018
Financing

• Donations
    • EURO 1,5 million/DKK 11.350.000 has been donated to the project
    • Meetings with 2 major funds with the participation of the ambassador planned for
      September
    • TOTAL will host ‘donation’ dinner for large french companies (September)
• Bank/realkredit
    • Positive dialogue with bank/mortgage institute on building credit and loan
    • Loan agreement with bank/mortgage institute will be concluded at market terms
• Further donations needed for establishing sports facilities

Financing                                                                          DKK
Profit to fund on sale of Værnedamsvej buildings                           190.000.000
Donations by end of August 2018                                             11.350.000
Expected morgage loan                                                      196.000.000
Expected financing in total                                                397.350.000
Presentation for LFPH AG September 18th 2018
LFPH and PHSE running cost (1)

• LFPH
      • LFPH budget based on current pupil numbers (927) and a yearly increase of 1% pr.
        year
      • School fees maintained at present level apart from an increase of 2 %/year of both
        current costs and school fees
      • A yearly rent of DKK 10.500.000 plus VAT is affordable
      • Rented sports facilities
        (there will be no rent,
        but operation cost, if the
        sports facilities is
        funded)
      • LFPH accountant and
        intendance are
        reviewing and detailing
        numbers

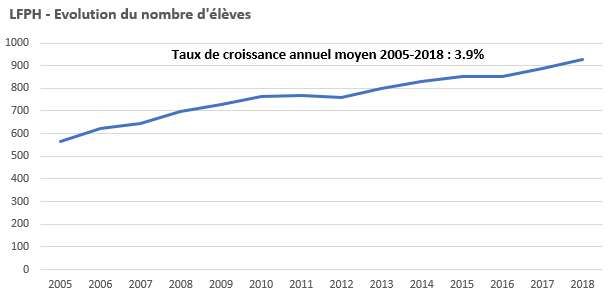

Historical data - number of pupils per year
               2005 2006 2007 2008 2009 2010 2011 2012 2013 2014 2015 2016 2017 2018      CAGR
# of pupils      567 623 643 698 729 762 769 761 801 830 851 850 886 927                   3,9%
Variation            9,9% 3,2% 8,6% 4,4% 4,5% 0,9% -1,0% 5,3% 3,6% 2,5% -0,1% 4,2% 4,6%
Presentation for LFPH AG September 18th 2018
LFPH and PHSE running cost (2)

PHSE
Revenue (as fund) on sale of Værnedamsvej                                  190.000.000
Actual donations                                                            11.350.000
Loans * up to                                                              194.650.000
Financial sources in total                                                 397.350.000
*         Half 30 year loan with grace period of 10 years (3,25%)
          Half 30 year loan (3,25%)
• Lease contract between LFPH and PHSE on the new premises
     • 30 years
     • Must define responsabilities (internal/external maintenance etc.)
Presentation for LFPH AG September 18th 2018
Project plan and process

• Considerations on time schedule/project plan
    • Pupil numbers are growing (need for more space and better facilities)
    • The project needs an optimal timeschedule/project plan incl. time buffer in order
      to be realized
    • The potential buyer of the Værnedamsvej buildings must take over the buildings no
      later than July 1th 2022
    • In order to hand over the Værnedamsvej buildings to the buyer on time the new
      school must be ready in due time, thus the preliminary design and work of the new
      building has begun in August 2018.
    • The zone plan processes for Værnedamsvej and Rolighedsvej will be performed in a
      close dialoque with Frederiksberg Kommune
    • The zone plan process is expected to end in November 2019
Presentation for LFPH AG September 18th 2018
Payment plan

• Phase one (until December 31th) – DKK 10.000.000
    • Design activities - architect/engineer/contractor etc.
    • Financed by bank building credit at market terms and below 3,25%
    • The credit can be converted into a mortgage loan honored within the EDFS budget
      without influence on the rent – terms will be negotiated
• Phase two (Jan. 2019 until Nov. 2019) – DKK 15.000.000
    • Detailed Design - architect/engineer/contractor etc.
    • Financed by bank building credit at market terms
    • The credit can be converted into a mortgage loan which must be honored by a rent
      increase at DKK 800.000/year.
• Phase three (Nov. 2019 until Dec. 2021) DKK 371.850.000
    • Construction
    • Financed by bank credit and donations and the revenue of the sale of the
      Værnedamsvej buildings
    • The bank building credit will be converted into a mortgage loan when the buildings
      are ready to move in to.
Status on the NPHS

• The masterplan for the area has been adopted by Frederiksberg Kommune
• The room program for the NPHS has been adopted by LFPH
• The architects are working on preparing input for the ‘start document’ (defining
  the frames) for the zone plan process
• More illustrations will follow at the AG september 18th
NPHS- Project organization

                              Board
                        Prins Henriks Skoles
                           Ejendomsfond                                            Steering
      Legal                                                                       Committee
                                                      Accountant                  (meetings to be      Parent Group
     Advisor                                       Sten Peters, Deloitte        scheduled every 4 to
(Erik Larsson, NJORD)                                                                6 weeks)
                            Director
                        Prins Henriks Skoles                                     Director PHSE
                           Ejendomsfond                                          Per Anker Hansen

                                                                                     LFPH
                                               Director PHSE
                                                                                 management
                           Project             Project managers from            representatives
                         management            • Management contractor (lead)     Michel Chesne
                                               • Architect                        Laure Cassiers
                          New LFPH
                                               • Engineer
                                                                                  LFPH Board           User Group
                                                                                representatives
                                                                                 Representative 1
 Management                 Advisor                    Advisor                   Representative 2
  Contractor               Architect                   Engineer
 Arpe & Kjeldsholm      Holcher Nordberg              To be decided
Communication

• Regular newsletter on the website
    •   The newsletter will be launched after each the meetings of the Steering Committee
    •   The newsletter will be published in Danish and French
    •   The newsletter will be distributed by mail thefirst time, thereafter on website
    •   The newsletter should also be relevant to secondary stakeholders
• Stakeholders in the New Prins Henrik School Project
    • LFPH Parents
    • LFPH Pupils
    • LFPH Management
    • LFPH Teachers and other staff
    • Potential parents
    • Donating funds, companies
      and persons
    • Bank/credit institute
    • Frederiksberg Kommune
NPHS – Project process

School management
                         Vision                              Furniture
Teachers, Pupils,
                       Language                              specifications

School management
                        Room
and board

                                                                              Furnishing
                       Program

                                                                                           Construction
specifikations

                                                                               project
                                         Vision and room
                                        program approved
                                               by SC
                     Sketch Project
                                                             Furnishing
                                       Comments and accept   project
                                           by SC on the      approved by SC
                                          sketch project
                    Project proposal

                                       Comments and accept
                                           by SC on the
                                         project proposal                             Commissioning
                       Detailed
                                                                                        furnishing
                       Project
                                                                                      and moving in
                                         Presentation to
                                         all stakeholders
NPHS – main schedule

          2018                          2019                          2020                          2021
J FMAM J J A S ON D J FMAM J J A S O N D J FMAM J J A S ON D J FMAM J J A S ON D
       Contribution to zone plan
                          Zone
                Start            Approval process
                        planning
              Sketch project

                     Project proposal

                         Project for the commune

                                        Detailed project
              J                             J                             J                             J
                                              Contracts

                                            Demolition                     Construction phase
                                                                                                      Commissioning
                                                                                                         Furnishing
                                                                                                         Mooving in

NB. The project plan requires that permission to start demolition can be given before the zone plan is adopted
