Building Committee Update & Recommended Action - 9 May 2016 - Abiding Savior ...
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Strategic Mission Plan Outcomes/Ends A. Enterprise 1. The congregation of Abiding Savior Lutheran Church and School (ASLC) commits to increasing the number of people it serves in mission in the surrounding 7 mile radius of the church by 2000 each year through June 2019 inclusive of all ministries. 4
Strategic Mission Plan Outcomes/Ends B. One Mission Outreach and One Major Program (Expand Strengths) 1. Abiding Savior Lutheran School will be recognized as a premier school in South Orange County serving congregation members, our constituents, and friends and families of our congregation with a student population at capacity (300) by August 2019. 2. Abiding Savior Lutheran Preschool will increase the enrollment in our preschool to capacity (75) by August 2019. 5
Strategic Mission Plan Outcomes/Ends C. Significant Relational Groupings and Shepherding Visitation (Add Strengths) 1. 100 percent of our active members and constituents will be a part of at least one Significant Relational Grouping by June 2019. 6
Gym/Kitchen Renovation & Youth Center Above Admin Building 8
Gym/Kitchen Renovation & Youth Center Above Admin Building Pros: Meets all missionary needs Keeps all green space Cons: Cost is more than approved loan Requires additional design time and costs Requires temporary office move Glulam Beam Capacity of Admin Building is designed for roof loads only, not capable of supporting a second floor Cost: Approximately $2.3M + $2.5M = $4.8M (hard & soft costs) 9
Gym/Kitchen Renovation & Parking Structure Pros: No reduction in Green Space Added parking space Cons: Does not fit with SMP Does not provide adequate youth space, meeting space or storage space Project is highly unlikely to be approved by City Cost: Approx. $2.3M + $2.5M = $4.8M minimum (does not include all soft costs for parking garage) 10
Gym/Kitchen Renovation & Underground Parking Structure Pros: No reduction in Green Space as that would be the top level of the parking structure Added parking space Cons: Does not provide adequate youth space, meeting space or storage space Does not fulfill SMP Needs substantial retaining wall along Whistler St., Gym and Teachers Parking Lot. Requires 100’ to 200’ feet of ramp Providing approximately 18 spaces Cost: $2.3M + $2.5M = $4.5M minimum (does not include all soft costs for parking garage) 11
Gym/Kitchen Renovation & Renovation of 2nd Story E Bldg. Classrooms to Youth Rooms 12
Gym/Kitchen Renovation & Renovation of 2nd Story E Bldg. Classrooms to Youth Room Pros: Avoids loss of Green Space Cons: Does not aid in fulfilling Strategic Mission Plan Does not provide enough storage space Loss of 4 classrooms limiting growth potential of school Large Print Center, English Learning Lab and School Wear Shop would need to be relocated - To where? Cost: Requires the upgrade of all redesigned building rooms to current building and ADA codes. Estimated: $2.3M + Unknown Additional Cost Additional Architectural study and G.C. involvement needed 13
Gym/Kitchen Renovation Only Pros: No reduction in Green Space Cons: Does not provide youth space Does not provide adequate meeting space Does not provide adequate storage space as renovation includes the elimination of the Youth Center due to stage upgrades Hinders fulfillment of Strategic Mission Plan Cost: Approx. $2.2M (hard & soft costs included) 14

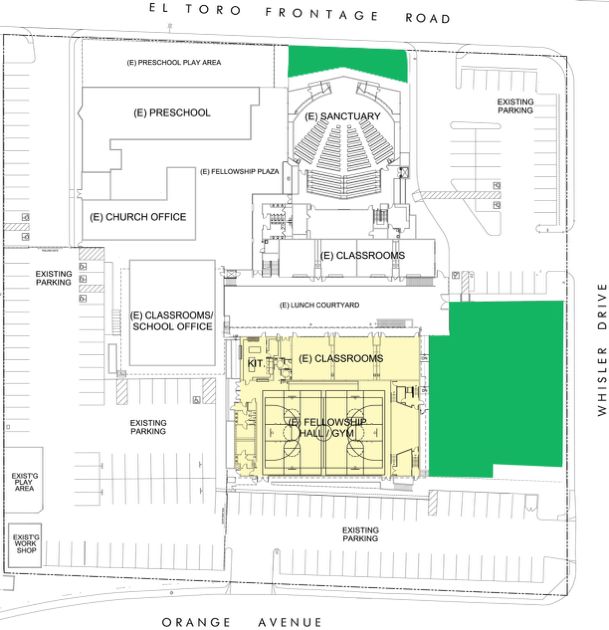

Concept Level Drawings (Space Plans) 15

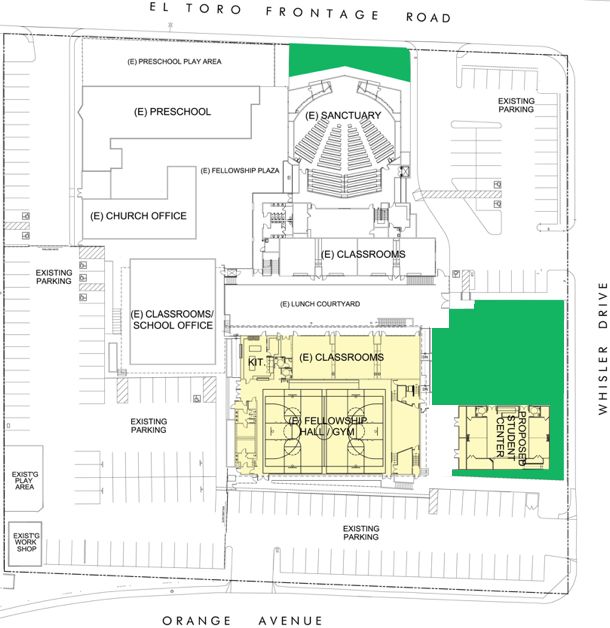

Concept Level Drawings (Space Plans) 16
Crean Lutheran High School Example of a Permanent Modular (Prefabricated) Building 17
Gym/Kitchen Renovation & Youth Center (Multi-Purpose Building) At Back Of Lot Pros: Meets all Strategic Mission Plan Outcomes Allows for 66’ x 92’ Green Space (approx. 6,100 SF) Allows for overflow parking Total Construction Time: Approximately 90 days (including 6 weeks on site) Cons: Reduces Green Space by 38% Cost: Approx. $2.3M + $600K = $2.9M (hard & soft costs included) 18
Preliminary Construction Budget Revised Cost Estimate Gym Renovation Construction: $1,293 K Prefabricated Youth Center NTE: $600 K Plan Check & Permit Fees: $38 K Architecture & Engineering: $234 K Equipment & Furnishings: $773 K Additional Contingencies: $30 K TOTAL PROJECT INITIAL COST ESTIMATE: $2.9 MILLION Initial Budget of $3.3M reduced to $2.9M through alternate construction methods and we continue to review other alternatives to reduce/mitigate overall construction costs. 19
BTB Fund Thru April 30 Total Pledges: $939,012* Received: $267,217¤ Expended: $133,170 Balance: $134,293 * Includes PTL Pledge of $20,000 ¤ Includes PTL funds and over $7,000 youth/student raised funds 20
LCEF Loan LCEF has reviewed our loan application and green lighted the project based on: Total Loan: $2,811,000 = $2.9M + $700K - $800K (Building To Bless Funds as buy down of principle over next 3 years) Current Interest Rate: 3.875% adjustable monthly plus 1% during construction Monthly payment on the total would be $13,218 with pay down using Building To Bless Pledged Funds (current loan payment $9,500) 20 year loan 30 year amortization We pay interest only on the construction loan and only for the amounts actually funded during construction 21
Why Gym/Kitchen AND Youth Center Supports fulfilling Strategic Mission Plan Promotes growth of the school Promotes growth in membership Helps communicate importance of youth ministry and aids in keeping youth engaged through high school Provides much needed storage space Provides additional meeting space 22
Action Item The Leadership Board moves that the congregation approve: (1) a construction project for renovating the gym and building a new youth center, with a budget of $2.9 million for completing the project, and (2) obtaining a loan with LCEF in the amount of $3.6 million to cover the construction project’s $2.9 million estimated cost and refinance of our existing loan of approximately $700,000 resulting in a monthly payment of approximately $13,218. 23
