Fire Response Recovery Concepts Draft #2 for Discussion July 16, 2021
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Context • On June 30 Ly+on BC experienced a devasta9ng fire resul9ng in the loss of approximately 90% of the community’s structures • This included the loss of key community buildings, many residen9al homes and infrastructure • Kanaka Bar has also been impacted by these fires in many different ways, however, the community itself remains: • Safe from current fires • A FireSmart Community • Home to opera9ng community infrastructure • E.g. Water, power, telcom • Ready to advance projects that support our friends and family in this tough 9me • Therefore, Kanaka Bar is proposing to offer temporary housing and administra9ve buildings to help those in need
Four Potential Sites in Kanaka Thus far, Kanaka’s team has considered four key sites: • Lot 4 • HWY 1 • Lot 16 • Areas in Upper Kanaka Proposed concepts aim to expedite construction, align with long-term projects, and be as cost effective as possible Based on efforts to date focus is on HWY 1 and Lot 4 Working to advance a concept for Lot 16
Highway 1 – Community Recovery Centre Purpose: - Provide a temporary service hub for the region Proposed Recovery Concept: - A large community resource building with meeting space, kitchen, dinning area, and multi-purpose rooms (e.g. daycare, small store). - building can be re-scoped to include a temporary housing solution - Two additional multipurpose buildings that can be customized to meet the specific needs of the Lytton Fire recovery effort - To be used for essential services such as RCMP, first aid, etc. based on regional need - A fueling station (if required)

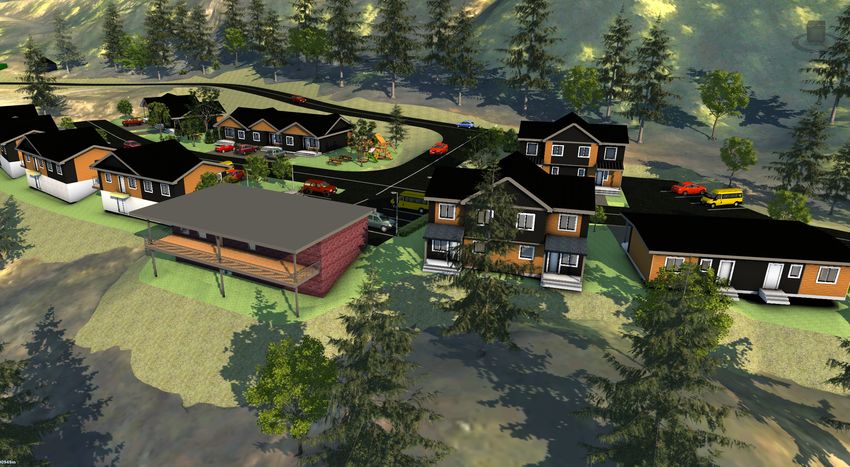

HWY 1: Visualization of Recovery Project Proposal 1.1 /1.2 Community Resource Building Mul9-‐purpose Office Space and Fueling Sta9on
Project Cost Estimate for Highway 1 Concept Highway 1 Recovery Project Estimate NOTES PROFESSIONAL SERVICES AND PERMITTING Geohazard Review $10,000 Allowance -‐ i nitiated Civil and planning $25,000 Allowance Contract Administration $15,000 Allowance Project Management $15,000 Allowance Professional Services Sub-‐Total $65,000 SITE WORKS 2 x 200 AMP service (requires further upgrade post Electrical $25,000 recovery) Water (longer term solution) $505,000 Optional -‐ based on 2020 cost e stimate (with ClearFlow) Sanitary $0 Holding tank (assumed to be i n building) Type 2 B Driveway $115,000 Confirm with MOTI i f needed for temp solution Other $25,000 Site Works Sub-‐Total $670,000 BUILDINGS Fuel station $30,000 based on preliminary quotes East Side Buildings $654,000 5 unit Kitchen / Diner complex (Seko) 2 generic buildings on West Side; fueling station West Side Buildings $100,000 (Seko/NRB) Buildings Sub-‐Total $784,000 Sub total without Contingency $1,519,000 Project Contingency (10%) $151,900 Estimated Total Project Cost $1,670,900
Lot 4: Residential Area for Regionally Displaced Residents Purpose: - Provide a temporary safe, secure and pleasant living environment for those who have lost their homes. Proposed Recovery Concept: - A 19 bedroom unit (scalable) with a shared kitchen, dinning area and recreational space - A 10 to 19 bedroom building with individual washrooms and a shared kitchen a living area and customizable space for resident use - Areas for longer-term RV/trailer use, or additional modular housing units Long-term: - 50 bedrooms as part of the 24 affordable units (shovel ready) as part of Kanaka’s long- term housing strategy
Lot 4: Visualization of Recovery Project Proposal 2.0 Temporary Residen9al Buildings: 29-‐38 rooms TCP 24 units TCP laydown / RV area/ addi9onal units* TCP Sanitary/Solar Field Available for expansion
The Crossing Place The Crossing Place 24 units / 50 beds
Floor plan for 19 bedroom (NRB) on Lot 4
Floor plan for 10 bedroom (Seko) on Lot 4
Project Cost Estimate Lower Kanaka Recovery Project Estimate NOTES PROFESSIONAL SERVICES AND PERMITTING Civil and planning $15,000 Allowance Arch monitoring $20,000 Allowance Contract Administration $15,000 Allowance Project Management $15,000 Allowance Professional Services Sub-‐Total $65,000 SITE WORKS Required upgrades for Lot 4 (Allowance -‐ recommended from BCH) and Electrical $200,000 temp generator Longer-‐term based on Kanaka water plan ($500,000 + temp water Water (long-‐term) $0 treatment) Water (short-‐term) $30,000 T-‐ from e xisting potable l ine i n Lower Kanaka (may cause disruption l ater) Sanitary $0 Holding tanks Road $430,000 Required for TCP (Kanaka Station Road, HWY 1 i mprovement and Egress) Strip Topsoil $26,000 calculated as $5/m2 for 5,200 m2 Gravel Pad $50,000 Allowance i f needed Site Reclamation $100,000 Removal and return to agriculture Site Works Sub-‐Total $836,000 BUILDINGS 19 bedroom "drill camp" $450,000 NRB -‐ 19 bedroom complex 10 bedroom residential $726,000 Seko -‐ 10 bedroom complex Permits $10,000 Building Sub-‐Total $1,186,000 Sub total without Contingency $2,087,000 Project Contingency (10%) $208,700 Estimated Total Project Cost $2,295,700
Lot 16: Housing and RV Spaces 3.1/ 3.2 • Proposing to: – bring up existing home up to code – create new spaces RVs • This can help create space for another five families Reno • Initial costs estimates $250,000 + RV areas home (benches)? water servicing improvements – Still under review
Anticipated Operational Costs • Based on initial estimates and assumptions Anticipated Operational Cost Allowance Power Residential $ 40,000 Power Community Buildings $ 15,000 Sanitary pump outs $ 60,000 Water Operations $ 20,000 Janitorial $ 175,200 Security $ 262,800 Grounds maintenance $ 22,000 Insurance $ 25,000 Pest control $ 20,000 Project management $ 75,000 Management, Legal and Professionals $ 150,000 Telcom (internet/phone) $ 20,000 Waste management $ 15,000 Generator + fuel $ 100,000 Annual operating allowance $ 1,000,000
Proposed Schedule • Project funding approval: July 16, 2021 – Total estimated cost: $4 million • Place order for building structures: July 16, 2021 • Site works: July 19 – August 1 • Buildings arrive to Kanaka: August 2 • Installation and commissioning: August 9 - 20
Summary of Kanaka’s Recovery Offer of Support • Total number of temp. beds: 38 – With room for more as needed • Spaces for RVs/Trailers: 10-15 • Estimated temp. population: 70-100 • 4 buildings serving regional essential services • Delivered in approximately 4-5 weeks • Estimated development cost: Approx. $4 million • Operating allowance: Approx. $1 million
Next Steps • Review initial concepts with Kanaka, regional partners and incorporate feedback • Prepare revised concepts and advance applicable planning and engineering work – Update cost estimates and schedule based on input and specific regional needs • Formally secure Federal/Provincial emergency funding support • Advance construction
