TII - Major Projects in the South West Region Paul Moran Regional Manager, SW Region, TII 4th September 2019
Contents 1. Programmes & Plans…. 2. Some Timescales….. 3.Updates on Schemes in the SW 4. Update on M20 Cork to Limerick Scheme 5. In the pipeline…… Finally…..questions…..comments…….views 2
1. NPF and NDP background Increased Investment in Roads Programmes • Investment in national, regional and local road infrastructure will be delivered in accordance with the NPF. • It will be guided by the findings of the Department of Tourism, Transport and Sport’s SIFLT analysis. o Roads will be maintained to a high quality. o Roads will be improved to reduce journey times, remove bottlenecks and improve safety. o New roads will be built to connect communities and encourage economic activity. • A full list of projects and programmes included in the National Development Plan, are set out on the Department of Public Expenditure and Reform website www.per.gov.ie.
1. NPF and NDP: TII SW Projects Heading for Construction…. • M8/N8/N25/N40 Dunkettle Interchange • N22 Ballyvourney Macroom • M28 Cork Ringaskiddy (JR pending) • N69 Listowel Bypass Heading for Planning….. • M20 Cork to Limerick • N72/73 Mallow RR • N21/69 Adare/Foynes/Limerick (Adare Bypass) In Appraisal….. • N25 Carrigtwohill Midleton • N24 Cahir to Limerick Junction….. and on to Waterford • N22 Farranfore Killarney (Killarney Bypass) • N21 Abbeyfeale and • N21 NewcastleWest Town Bypasses
Dunkettle Interchange, Cork • June 2018 – Contractor led Design & Enabling works • August 2019 – TII issue statement confirming Contractor will deliver advance works but not main Construction works. • Sept 2019 – TII to advertise new competition • Works on site continuing for next 10 months on Service diversions and further enabling works • Summer 2020 – BC review by DPER &Recommendation to Government to Award Main Works • 2022 – Sectional opening of Ramps & access roads envisaged • End 2023 – Completion of Main Works
Dunkettle Interchange - advance works (next 10 mths) • ESB Diversion works • Gas Main Protection • Enet Diversion • 600mm watermain diversion • 900mm watermain diversion • East West Ped/cycleway • Flood compensation areas • Jap Knotweed • Culvert construction • Brury’s Bridge works • Possible link Q service corridor?
N22 Baile Bhuirne to Macroom Bypass • Market Consultation • New pilot award criteria • Tenders now in…… • BC approval with DPER • Government Approval for Award? • 39 month build

M28 Cork to Ringaskiddy • JR decision in Oct 2019 • Leave to appeal? • Advance works contracts • Access to land critical • Site clearance • 2 yrs min Archaeology • Powerline diversions • Watermains diversions • Fencing contracts • Other service work and enabling works • Earliest Main Works start is mid/late 2023 (but could realistically 2024) • 3 to 4 years to complete
N21/N69 Foynes to Limerick (incl. Adare Bypass) • Ready to Publish late Sept • Awaiting DPER Review • Need Government Approval ??? • Strategy under development to bypass Adare before 2026 (Ryder Cup)
4. M20 Cork to Limerick (NDP) • The previous application was in 2010 and withdrawn in 2011 • NDP has 2027 completion date (subject to appraisal, planning & procurement) • Estimated cost in the NDP of €850-900m………… • Cork NRR will be “examined”…..complimentary scheme • It may take 5 years to achieve ABP consent. • Safety dividend significant due to high level of fatal head-on collisions. p46 of the NDP
16 fatalities on the N20 since 2014…… plus 19 seriously injured Approx 85 killed since 1994. Ranked second highest in the Country for fatal & serious collisions……
Populations • NPF - Cork City and Suburbs: +105,000 – 125,000 people • NPF – Limerick City and Suburbs: +50,000 – 55,000 • Mallow - +20,000

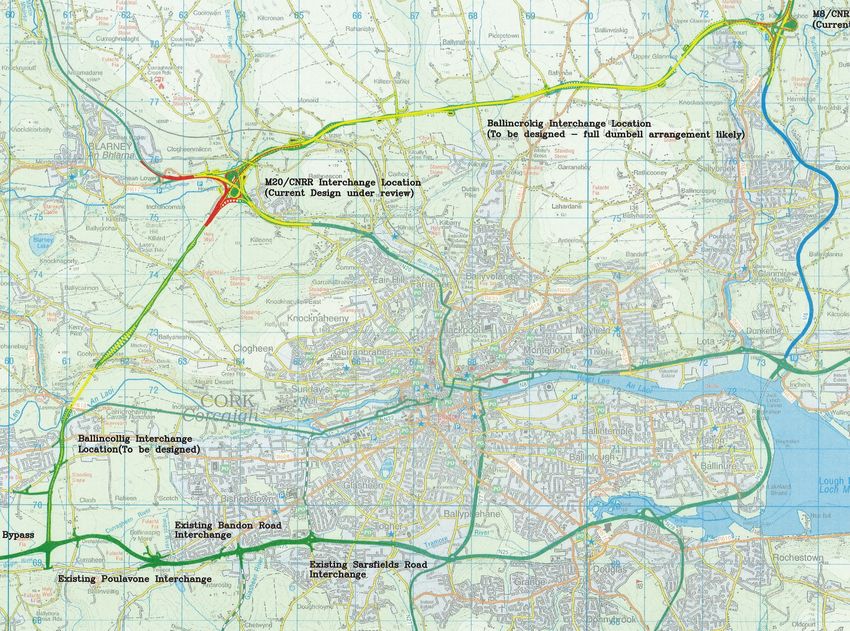

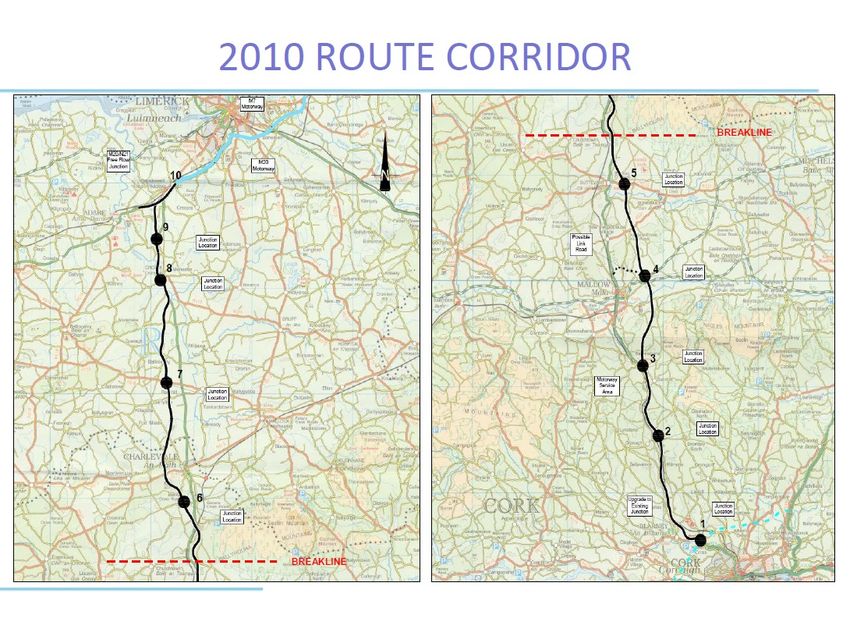

M20 Cork to Limerick – 2020 Route?

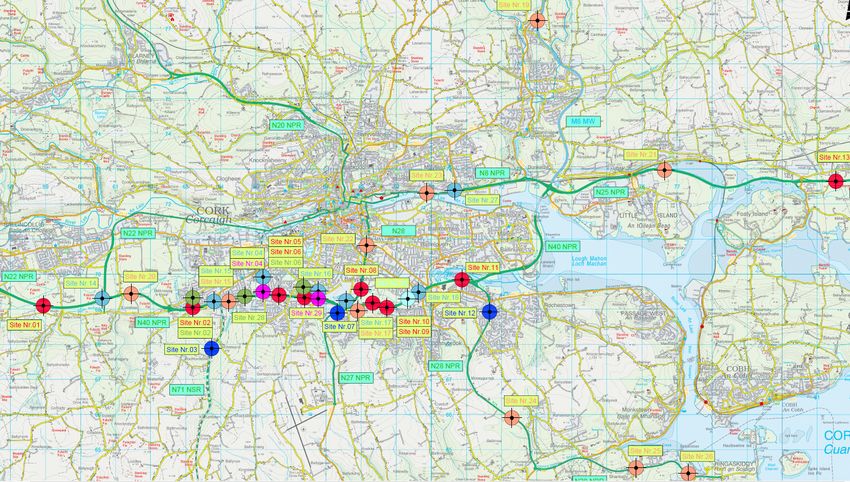

Appraisal: Some Strategic Corridor Alternatives & Options
4. M20 Cork to Limerick (NDP) • TII, LC&C and Cork will endeavour to make the ambitious timelines/targets However significant challenges will be….. • Statutory Process (JR’s & other…) • Public Procurement (scale/size & challenges….) • Appraisal & Oversight (increasing….) 19
5. In the Pipeline….. At various stages of delivery….. • N40 ITS along the southern ring road (3 contracts) • N40 Ten-T Study (Freight) – Capacity Enhancements? • As well as the Planning/Appraisal schemes listed earlier (N25 “Amgen” Scheme) • The Cork NRR………… CMATS….. • Cork NRR referenced and included….. • The Cork NDR….. and its impact • And other roads such as SDR and other vital Non Nat. Links • East West Light Rail for Cork 20
21
Current Scope of N40 ITS
The Cork NRR….. • CMATS envisages it will not be delivered in advance of substantive PT elements • Latter end of Strategy 2031- 2040 • Finalisation of its route and protection from development is an objective (short term) • Potential for earlier delivery?? • Commencement on scheme planning & Design envisaged • M20 scheme will examine its impact…….”complimentary” 23

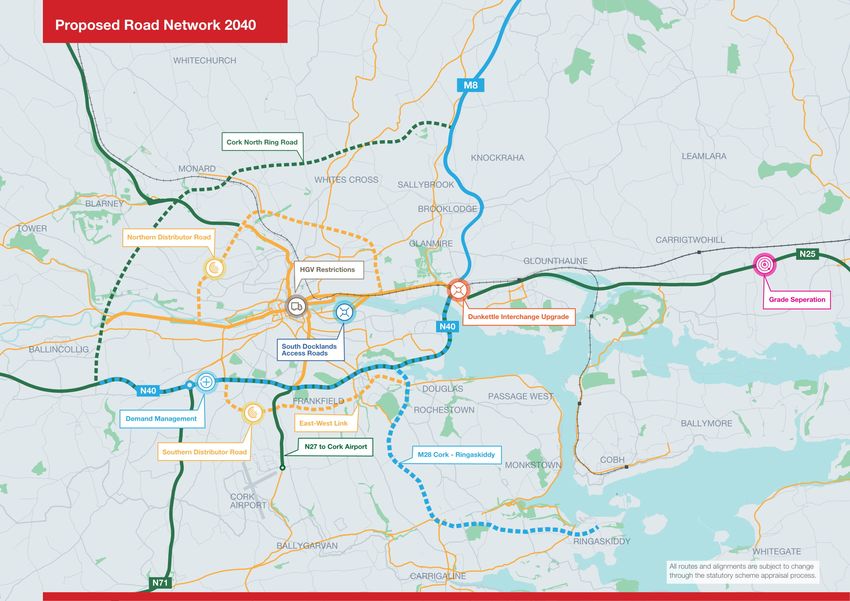

CMATS – Cork Proposed Road Network 2040 Key Aspects • Cork NDR • Cork SDR • Park ‘n Ride sites • N27 Transport Corridor • N40 Demand Management • N25 Enhancements • HGV Restrictions in city • South Docklands access roads

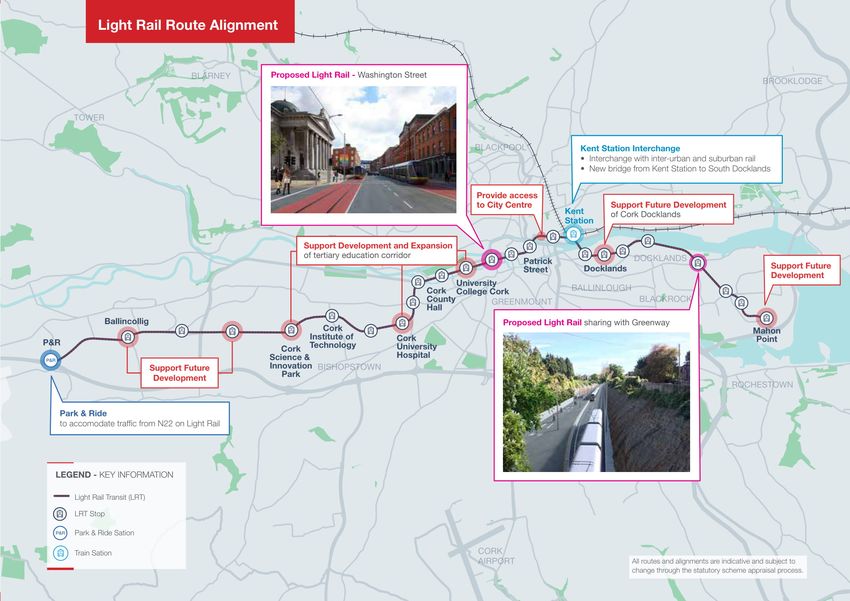

6. CMATS – Light Rail…(NTA) 25

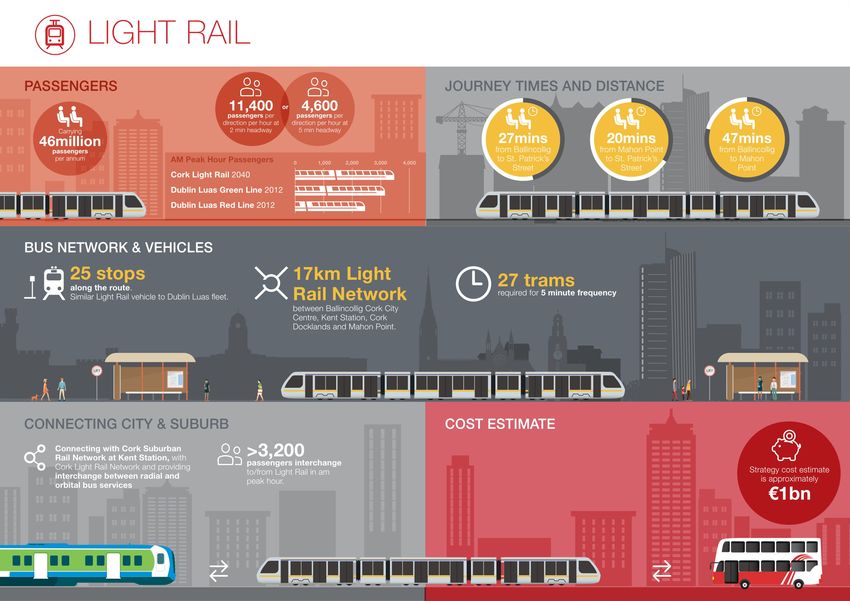

6. CMATS – Light Rail…(NTA) 26
Summary • The Southwest is doing well out of the NDP • €2-3bn + in Major Road Schemes • CMATS ~ €3.5bn • Delivery timescales will be dependent on many factors….. • TII will always do our best …… 27
