LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019

Page created by Marion Jacobs

CONTINUE READING
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019
LNG TERMINAL ON
THE ISLAND OF KRK
 Status and Project
      Update

         December 2019
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019
Project Background

➢   LNG Terminal on the Island of Krk has important role in facilitating European Union Energy
    Security Strategy.

➢   It is a game changer to the security of supply of the Republic of Croatia and Central and South
    Eastern Europe.

➢   Project realization will strengthen security of supply, create new market opportunities, increase
    market competition and have positive impact for final consumers.

➢   The project is of strategic importance for the
    Republic of Croatia and the European Union.

➢   It is included on the EU List of the Projects of
    Common Interest and is one of the projects of
    the Three Seas Initiative.

➢   The project received EU Grant of maximum
    101,4 mil EUR under the Connecting Europe
    Facility (CEF).
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019
Basic Project Information
➢   Project is divided into two phases, first phase is Floating LNG Terminal with total capacity of 2,6 bcma, and
    second phase which will depend on the future market development and demand is Onshore LNG Terminal
    with total capacity of 5 bcma.

➢   According to the current market circumstances and demand (total Croatian gas consumption is
    approximately 2,6 bcma), the decision is to proceed with the first phase of the project and to realize floating
    LNG terminal.

➢   Transmission system with the development of Omišalj-
    Zlobin pipeline can accept 2,6 bcma from the Terminal
    (Omišalj-Zlobin pipeline is under realization and will be
    operational by the end of 2020).

➢   In order to accept more than 2,6 bcma additional
    investments in transmission system are necessary
    (additional investment of approximately 200 mil EUR is
    necessary in order to accept 3,5 bcma from the Terminal
    and additional investment of approximately 100 mil EUR
    to accept 7 bcma).

➢   Interconnection with Hungary which is currently under
    construction and will be fully operational by the end of
    2019 will have the capacity of 1,7 bcma to be exported
    through Hungary on a yearly basis.
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019

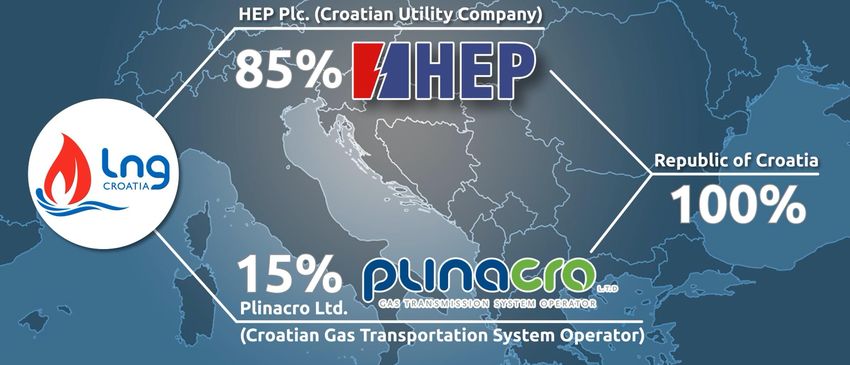

Ownership Structure

LNG Croatia LLC was established with the purpose to realize LNG terminal on the Island of Krk
and to operate the terminal (according to the EU Directive and Croatian Gas Act LNG terminal
operator is regulated business).
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019

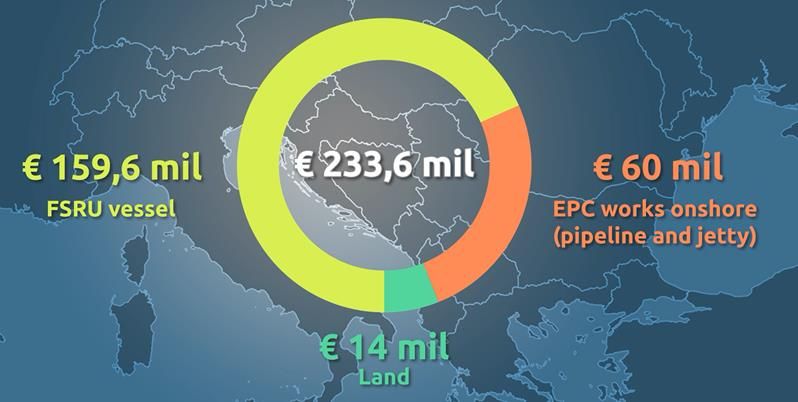

Project Investment

Total project investment costs are based on the closed procurement procedures and valid contracts for all
necessary onshore EPC works, FSRU vessel together with land acquisition/expropriation costs.
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019

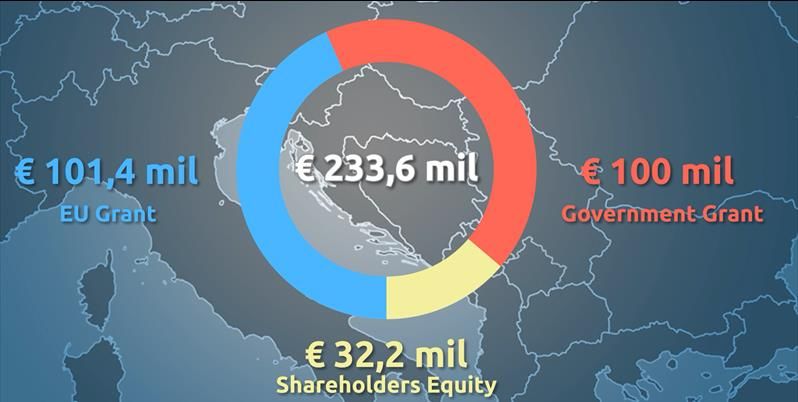

Project Financing
On 30th January 2019 the Government of the Republic of Croatia adopted Decision on financing the Project
in the amount of € 100 million.
On 31st January 2019 LNG Croatia Shareholders adopted Final Investment Decision.
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019
Activities Accomplished

➢ Project documentation

➢ Procurement procedures

➢ Contracts for EPC works and FSRU
  Vessel

➢ Necessary permits

➢ Rules of operations and tariff
  implementation

➢ Market Test (0,52 bcma capacity booking was obtained out of 2,6 bcma)

➢ Project financing
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019
Market Potential and Market Test
➢   European Union import dependence on natural gas in the last ten years has increased from
    43,4% to 70,4%. Dependency on natural gas import is expected to rise to almost 90% by 2040.

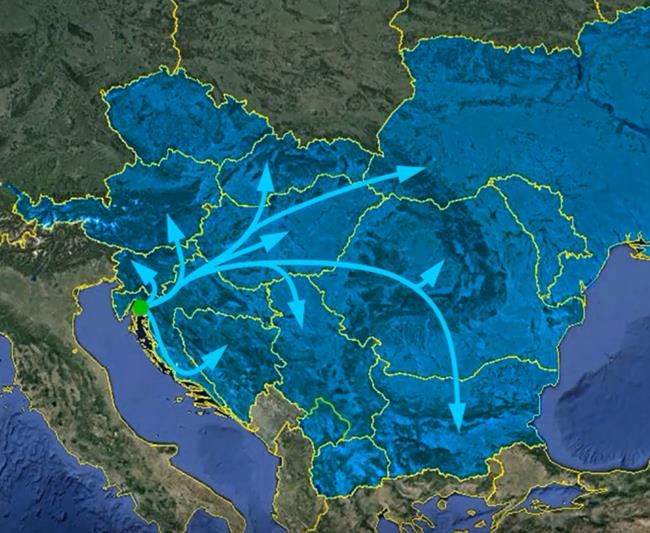

➢   The target markets for LNG Croatia have been identified in 8 countries for a total demand of
    approximately 37 bcma.

➢   The primary markets are considered in Croatia and Hungary for a total demand of
    approximately 13 bcma.

➢ There is a significant potential of the LNG use as a
  fuel in transport sector as an obligation for all EU
  Member States in the region.

➢ According to the moderate scenario of economic
  development and energy transition, in the North
  Adriatic maritime traffic and heavy road traffic on the
  main corridors of Croatia, Slovenia and Hungary on
  the core TEN-T network, regional market by 2025 is
  expected to consume around 523,000 m3 of LNG
  annually as a fuel (0.306 bcma), while by 2030 region
  that gravitates to the LNG terminal on the Island of Krk
  will consume about 1,323,000 m3 of LNG annually
  (0.774 bcma).
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019
Market Test and Tariff Methodology
➢   Indicative tariff for regasification service was set during Open Season procedure at 1,39
    EUR/MWh NCV (1,25 EUR/MWh GCV) for 20-year period. It was envisaged that at the level of
    1,5 bcma capacity booking with minor introduction of SoS charge, Final Investment Decision
    will be obtained, and the project will be financed from its own resources through loan (132.2 mil
    EUR).

➢   Since the Open Season resulted with 0,52 bcma capacity booking in order to cover the gap
    between allowed revenues and regasification revenues and to close the project in order to
    adopt positive final investment decision, Government grant measure was introduced (100 mil
    EUR Government grant) together with SoS charge.

➢   Investments that are being financed from EU or Government Grants, as well as purchase of the
    land, according to the Tariff Methodology, are not eligible as regulated assets, and therefore are
    excluded from the calculation of the return on assets and thus we sould keep the same tariff on
    0,52 bcma.

➢   SoS charge is covering the gap between allowed and actual revenues in case of lower capacity
    booking as it is the case with 0,52 bcma (it is envisaged by LNG Act as security of supply
    measure).

➢   Based on the 0.52 bcma capacity booking, in accordance with the allowed income regulated by
    the Methodology adopted by the Croatian Energy Regulatory Agency and taking into
    consideration that the majority is financed through grants, the investment will have a positive
    return on investment for the shareholders of LNG Croatia LLC.
LNG TERMINAL ON THE ISLAND OF KRK - Status and Project Update December 2019
FSRU – Golar Viking Conversion

Main Technical Specifications                                          ➢   At the time of delivery (30 October
                                                                           2020), the vessel will be delivered to
Capacity of an LNG carrier to be                                           the LNG terminal location from the
                                              3,500 m3 to 265,000 m3       shipyard as a new FSRU conversion in
accommodate on Terminal
                                                                           accordance with the highest technical
Total capacity of LNG storage tanks           140,206 m3                   and      environmental      protection
                                                                           standards.
Nominal LNG loading rate from LNG carrier     8,000 m3

Nominal LNG re-loading to LNG
                                                                       ➢   Currently all long lead items such as
                                              1,500 m3                     LNG pumps, engines, regasification
bunker/feeder vessel
                                                                           unit, power module, instrumentation
Nominal LNG re-loading to LNG truck-trailer   40 m3                        and other equipment are under
                                                                           production and FATs are currently
Regasification operation mod                  Open loop                    ongoing.

Maximum LNG regasification rate
                                              300,000 m3/hr            ➢   All main equipment together with the
(limited by the national gas transmission                                  vessel will be shipped in the Hudong
                                              2,6 bcma
system)                                                                    shipyard in Shanghai in February 2020
                                                                           when conversion will start.
Maximum installed natural gas sendout rate
                                              451,840 m3/hr
(second development phase of national gas
transmission system
                                              3,5 bcma                 ➢   Once conversion starts it takes 6
                                                                           months to finalize everything together
                                                                           with     necessary      approvals and
Maximum natural gas sendout pressure          100 bar
                                                                           classification certificates from DNV
Terminal availability                                                      classification society.
(24/7 with maintenance period 7               98%
days/annually
EPC Works Started in April 2019
The scope of EPC contract work is the design, engineering, procurement and construction of
jetty, connecting gas pipeline (4,20 km), high-pressure installation including pigging station,
water and drainage, auxiliary facilities and buildings, a dynamic and multi body mooring
analysis, terminal HAZOP and other relevant studies, including the commissioning and trial
operation.
➢ EPC works will be finalized by
  October 2020.

➢ FSRU Vessel will arrive to the
  terminal location by 30 October
  2020.

➢ During November and December
  2020 commissioning and trial works
  will be executed.

 ➢ LNG terminal will start to be fully operational from 1st January 2021.
THANK YOU!
