Smart Grid Small Generator Interconnection Procedures (SGIP) PSEGLI - Power Asset Management (PAM) 10/23/14 LONG ISLAND LONG 1 ISLAND
Overview of Interconnection Procedures • Adopted June 2012 • Establishes requirements to attach any small generator (0 to 20 MW) to the LIPA system. • Replaces existing “Interconnection Guide for Independent Power Producers” • Generally consistent with NY Public Service Commission (“PSC”) small generator interconnection procedures • Also incorporates modifications to net metering eligibility to be consistent with Public Service Law 66-j, which LIPA is obligated to follow • Interconnections greater than 10 MW must be at transmission level and will fall under NYISO SGIP process. LONG 2 ISLAND

Reasons for Modifications (NYS Mandate) Interconnection procedures determine method for attaching customer-owned generators to the LIPA system – Generators need to attach or else they are truly “off the grid” and would have to be entirely self- reliant on their systems – The benefits associated with solar and wind generation, as well as fossil fuel generation, are all predicated on operating in parallel with the LIPA Electric Grid Interconnection procedures need to balance the interests of the customer-generators with the interests of all other customers on the system – Shouldn’t create safety risks for line workers or the public – Shouldn’t impact reliability of the delivery system for all other customers – Shouldn’t impose costs on all other customers beyond what is authorized by law for net metering participants Interconnection procedures help by: – Standardizing and shortening the process, especially for smaller generators – Conforming to common standards and processes across the state, which helps the developers to keep costs down and work more efficiently LONG 3 ISLAND

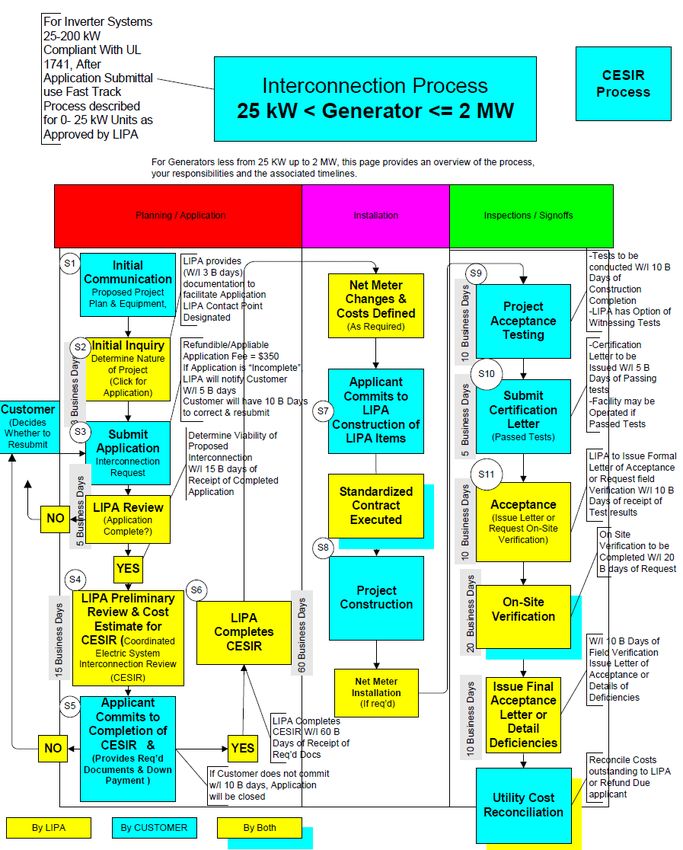

SGIP Modifications 25 kW to 2,000 kW to Feature 0 kW to 25 kW 2,000 kW 20,000 kW Yes for Yes for Fast Track standardized, type standardized, type No Timetable tested equipment tested equipment Coordinated Full System System Studies Electric System Impact Study Requirement No Interconnection based on position Review (CESIR) in study queue $350 (refundable $350 plus Applicable Fees No for net metering $10,000 system projects only) impact study fee. Interconnection Maintenance No No 11.4% per year Charges LONG 4 ISLAND
SGIP Interconnection Fee Structure LONG 5 ISLAND
SGIP Interconnection Modifications LONG 6 ISLAND

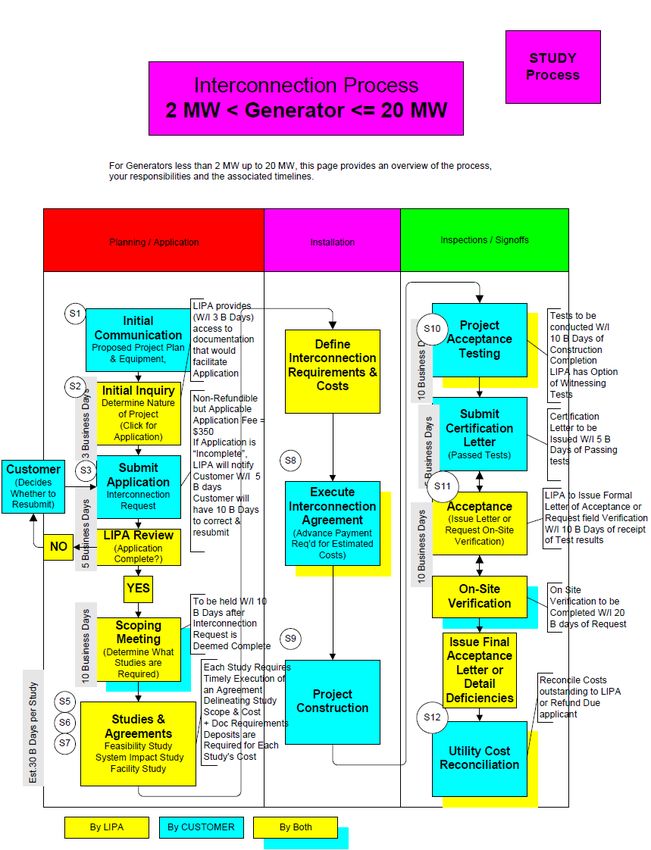

SGIP Process Times Not Applicable Not Applicable TBD 10 BD 10 BD Not Applicable Not Applicable TBD LONG 7 ISLAND
LONG 8 ISLAND
Changes Implemented as of June 1, 2014: Rebates Processing SEPARATED from Power Asset Management Interconnection Processing Incentives Application to be submitted through NYSERDA’s system PAM Solar Technical Documents to be submitted via email to PAMSolarLI@pseg.com Only interaction is submittal of COD Letter to receive rebate PAM Solar to request/schedule Net Meter Installation upon Initial Technical Approval of New Solar Application within 10 business days Net Meter to be installed before Close Out (Final) Documents are submitted by Solar Contractor. In most cases, net meter will be installed before construction of project. Use of self certification to verify inverter compliance with UL 1741 5 minute time-out test COD (Commercial Operation Date) Letter to be issued within one business day of receipt and review of Close Out documents and verification of Net Meter Installation LONG 9 ISLAND
LONG 10 ISLAND
LONG 11 ISLAND
DG Screening Criteria & Tools – Key Assumptions: LIPA Distribution System design & Operating Characteristics LIPA DG Interconnection Policies – PAM worked with GE and internal organizations to come up with a screening methodology that can determine whether the DG interconnection request (including inverter-interfaced DG interconnection) should be Fast Tracked or if the particular DG (see below) project requires further engineering study: Inverter Based (Solar, Wind, etc.) Synchronous Generators Induction Generators Other LONG 12 ISLAND
It is a Team Effort • Power Asset Management is the lead organization: – Receive Inquires – Process Applications – Request Net Meter Installations – Request Solar Billing Inquires – Manage the Process – Handle the Paperwork – Monitor Process Times – Respond to customer interconnection and net meter issues • Other Groups will be called upon for: – In-depth Technical Analysis and Studies – Detailed Interconnection Design – Cost Estimating – Support to resolve customer complaint issues LONG 13 ISLAND
SGIP Support for Customers – Approved Final SGIP Document in place since June 2012 – SGIP documents on LIPA WEB • Applications and forms • Reference documents • Process flowcharts • PAM contact information • DG Screening Criteria • Interconnection costing guidelines for estimating purposes • SGIP Interconnection Queue (Updated and posted bi-monthly) – Continued evaluation and updating of SGIP to consider: • NYISO modifications • NY State PSC modifications • Industry standards – UL 1741, IEEE 1547 LONG 14 ISLAND
PAM single point of contact for: – Interconnection and SGIP application status issues – Net meter issues – Billing issues Contact Info: – PAMSolarLI@pseg.com – Julia Uddin (516) 545-4792 – Steve Cantore (516) 545-4820 – Or in writing to: Steve Cantore Power Asset Management (PAM) PSEG-Long Island 175 E. Old Country Road Hicksville, NY 11801 LONG 15 ISLAND
You can also read
