Technical article Gennady Walder Ductile cast iron pipe as a problem solver A jack of all trades with many advantages The Devoll hydropower project Devoll, some 70 km to the South- The Devoll Hydropower project is in Albania East of the Albanian capital of one which has been well thought Tirana: Banjë and Moglicë. The two out and well planned and which is The company undertaking the together will have a capacity of being implemented according to project, Devoll Hydropower Sh.A. 256 MW and an annual production international best practices. It of- (DHP), is an energy company ac- of around 729 GWh. The Banjë fers the best financial, technical, tive in Albania with its head office power station took three years to environmental and economic de- in Tirana; the umbrella organisa- build and was put into operation signs with some important advan- tion is Statkraft AS based in Oslo. in 2016; for the Moglicë power sta- tages as regards energy, flexibility DHP was originally a 50/50 joint tion, commissioning was planned in production and supply, regional venture between Statkraft AS and for 2019. economic development, job crea- the Austrian energy company EVN tion as well as diverse advantages AG in Maria Enzersdorf. In March The power generated by the two for the communities concerned. In 2013, Statkraft AS took over the hydropower stations is badly need- addition, this means that DHP will 50 % shares of EVN AG and is now ed in order to meet the sharply be contributing to an improve- the 100 % owner of the company increasing power consumption in ment in road transport in the pro- and the project. Albania. On completion, Devoll Hy- ject area in that more than 100 km dropower will increase the gener- of roads and bridges will be newly In the context of the Devoll pro- ation of renewable, clean power in constructed or extended. ject, Statkraft AS is building two Albania by 17 %. hydropower stations on the River A view from the dam down to the emergency Deflected pipes in the curved course of the An assembly team installing a DN 800 pipe. spillway. tunnel. EADIPS FGR DUCTILE IRON PIPE SYSTEMS 54 50

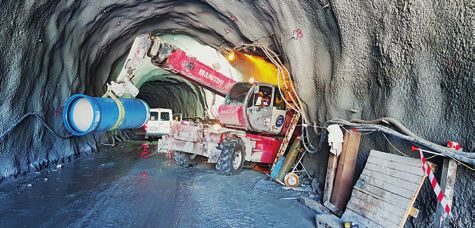

the impacts of the construction pro- ject on the environment as low as possible, an attempt was made to in- stall a steel pipeline using the micro- tunnelling technique. Unfortunate- ly, this attempt failed right at the starting pit because of the difficult and complicated geological condi- tions there. It was therefore decided, at short notice, to install the pipe- line directly in the supply tunnel. This meant that the length of the DN 800 turbine pipeline increased to an overall length of 354 m, meas- ured from the barrage wall to the turbine house. A view from the temporary storage area for pipes to the dam and emergency spillway. Cast iron pipes instead New decision at short notice to the underground hydroelectric of steel pipes power station with two main Fran- The power station at Moglicë, with cis turbines from General Electric. The original plan to construct the a height of 186 m, is the high- pipeline using steel pipes was dis- est dam of this type in the world. A third Francis turbine will oper- carded not only due to the complex A lake surface of 7.2 km² with a ate via a piping section at the foot geological conditions but also be- volume of 360 million m³ is being of the 186 m high barrage so as not cause producing the welding seams dammed. The water will be routed to entirely cut off the water supply was too expensive and would have via a 10.7 km long headrace tunnel in the project area. In order to keep taken too much time. Also, because From the barrage wall to the headrace tunnel. Cross-section of the supply tunnel with DN 800 turbine pipeline (penstock). EADIPS FGR DUCTILE IRON PIPE SYSTEMS 54 51

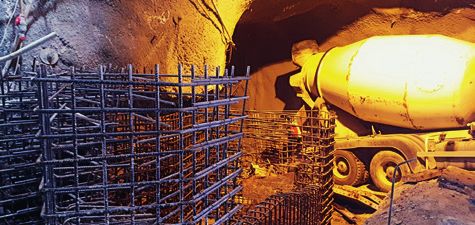

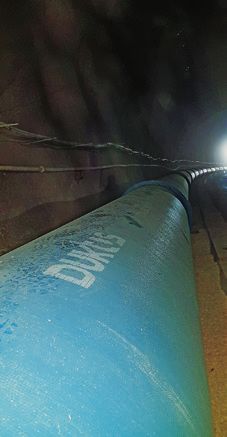

Working in restricted spaces: Top left: transport for assembly with a telescopic handler. Bottom left: concreting work. Right: DN 800 turbine pipeline after installation in the setting-up area of the supply tunnel. of various changes of direction, a The decision went in favour of ating pressure (PFA) of 18.3 bars. few pipe bends would have to be ductile iron pipes with the proven For wall thickness class K10, the produced on the construction site. BLS® restrained pipe joints. PFA = 25 bars. In the search for alternatives and The first-draft plans envisaged in order to solve the problems No compromises even under mounting the pipes on brackets. they were facing, the Turkish gen- pressure These would absorb any possible eral contractor Limak turned to subsidence or landslides. Changes the Duktus company. What they The Norwegian client Statkraft AS of direction along the pipe- were looking for was a pipe sys- is known for its high safety stand- line route, which were originally tem with which the entire turbine ards and does not accept any com- planned with steel pipe bends, pipeline could be constructed sim- promise in the selection of pres- were now able to be dealt with ply, safely and in highly restricted sure classes either. For the entire easily and without problem with spaces. 354 m, pipes with wall thickness the ductile iron pipes and the use class K10 with BLS® restrained of plain ended pipe sections and The safety factors had to be given joints, suitable for PFA = 25 bars, standard fittings. priority and the changes of direc- were selected. The resulting pres- tion in the route needed to be se- sure results from the geodetic cured with thrust blocks. Included height difference of 138 m. With among the selection criteria were, a closing time of 6 seconds for the among other things, the possibil- guide vanes at the turbine in the ity of vehicle impact protection centre of the power station a theo- and resistance to the earthquakes retical pressure increase of 20.4 % which can occur in this region. is calculated; with an additional safety margin of 10 %, this results in a permissible component oper- EADIPS FGR DUCTILE IRON PIPE SYSTEMS 54 52

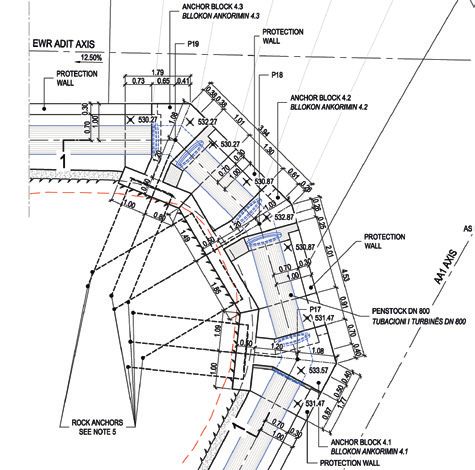

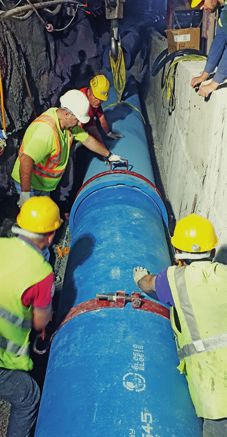

Mastered together Construction site briefing and moni- toring was attended by the appli- cation technology people from the Duktus company at the site in Al- bania. With the help of the briefing, the Limak assembly team was able to lay a pipe system, which was ini- tially completely unfamiliar to them, to a quality level considered excel- lent by all participants. The team around Erion Hysa was cautious at first but in the later stages they achieved a daily rate of up to 20 joints. By a skilful arrange- ment of the plain ended pipes in- cluded in the delivery into pre- fabricated lengths, the number of cuts on site with new welding beads was able to be reduced to a mini- mum. Keywords Turbine pipeline, BLS® restrained- joint, hydropower plant, Albania, Moglicë hydropower station Author Gennady Walder Duktus (Wetzlar) GmbH & Co. KG Sophienstraße 52-54 D-35576 Wetzlar Phone: +49(0)6441 491249 gennady.walder@duktus.world duktus.world Directional change in the supply tunnel. Top: the plan with a welded steel pipe bend. Bottom: execution planning with plain ended pipe sections (spigot end to spigot end) and double socket bends. EADIPS FGR DUCTILE IRON PIPE SYSTEMS 54 53
