Construction Management Plan - The Naples Beach Club Hotel, Residences and Golf Course
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Project Team The Athens Group The Athens Group has extensive experience in effectively managing Kim Richards – Chief Executive Officer complex construction projects within Jay Newman – Chief Operating Officer sensitive residential communities. Our Dave Zimmerman – Vice President, goal at the Naples Beach Club is to Engineering & Design mitigate construction impacts to our neighbors throughout the Bill Ford – Vice President, Construction redevelopment process by James Krall, P.E. – Director of Construction implementing a responsible Matt Driscoll – Director of Development Construction Management Plan to guide the team. 2
Project Team Suffolk Construction Company Suffolk is a highly respected national Gulf Coast Division company with experienced local leadership. Suffolk’s team will develop and implement effective construction Peter Tuffo – President SE Region management measures for the Josh Christensen – General Manager redevelopment of the Naples Beach Hotel. Suffolk has the experience to Ben Wilson – Chief Operating Officer mitigate noise and vibration, Chris Lewis – Sr. Project Manager implement dust control measures, provide project efficiencies, manage logistics, ensure cleanliness, and require safety protocols for the entire construction team and site. 3
Construction Fence Locations and Type Type 2 Type 1 Type 1 Type 2 Type 2 Type 1 Type 2 Type 1 Type 1 Type 1 8
Perimeter Fencing – Type 1 Beachside and residential fence locations will include a 6-ft. high fence and custom fabric with an “Evergreen Hedge” image 9
Perimeter Fencing – Type 2 Market Square and other internal fence locations (haul road, entrance gates) will have a 6-ft. high fence with dark green fabric 10

Construction Entrance / Haul Road Alignment 11
US-41 Construction Entrance / Haul Road Details 12

Regional Haul Route for Trucks 13

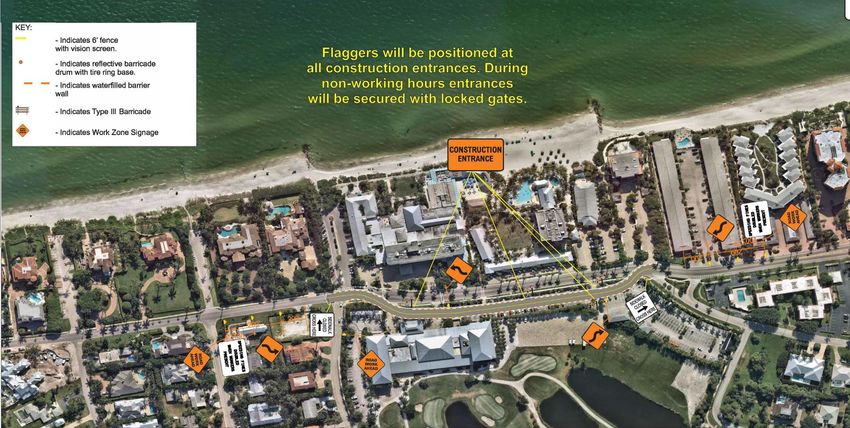

Construction Site Access and Security Controlled access at all times - Entrances will be manned with flaggers, traffic control devices and signage - All gates locked at night - Closed circuit cameras within construction site will monitor activity to ensure safety and security Trade partners will be required to wear a photo ID badge at all times 14

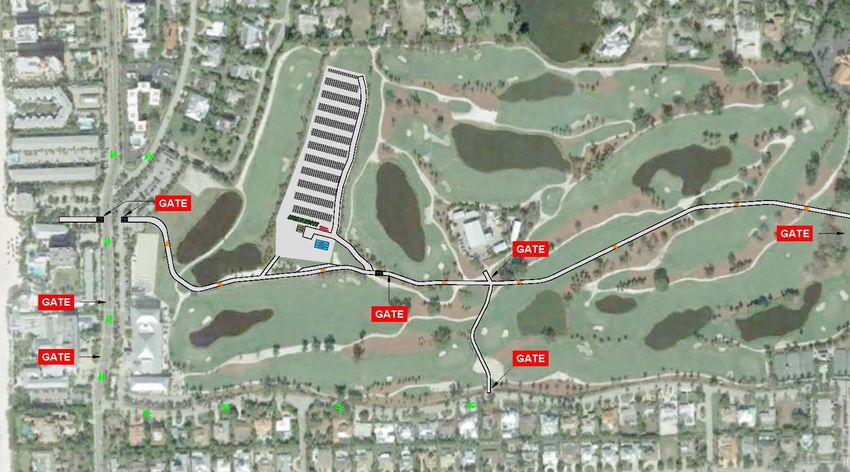

Construction Gate Locations 15
Life Safety and First Responder Access Locations 16

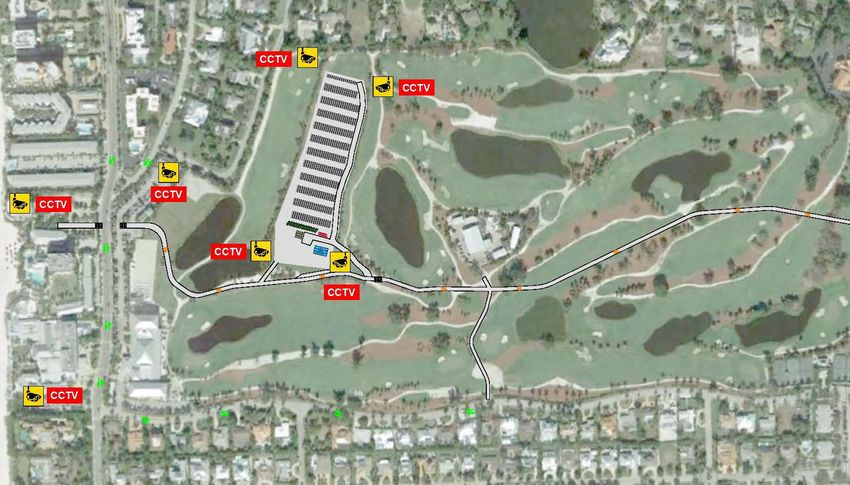

Proposed contractor CCTV Security Cameras 17
Hours of Operation (per city ord. 16-291) Demolition activity hours are Monday through Friday, 8 a.m. to 6 p.m. Construction site hours are Monday through Saturday, 7 a.m. to 6 p.m. The site will be closed during federal holidays. 18
What should neighbors expect? - Gulf Shore Boulevard Bypass Road 19
Gulf Shore Boulevard Bypass Road Alignment 20
Gulf Shore Boulevard Bypass Road Clubhouse Naples Beach Hotel Southbound General Note: Northbound approach Bypass roadway and maintenance of traffic signage to be submitted approach and approved by City of Naples Streets and Stormwater Department 21
Gulf Shore Boulevard Bypass Road 2-11’ wide asphalt travel lanes 5’ wide southbound 6’ tall fence bike lane 5’ wide pedestrian sidewalk 5’ wide 6’ tall Fence northbound bike lane Traffic barrier & valley gutter Northbound approach Southbound approach 22
What should neighbors expect? - Gulf Shore Boulevard Bypass Road - Storm Water Pollution Prevention Plan 23
Storm Water Pollution Prevention Plan to be permitted by FDEP and South Florida Water Management District 24
What should neighbors expect? - Gulf Shore Boulevard Bypass Road - Best practices in water and stormwater management - Dust control measures 25
Dust Control - Water trucks will help to manage dust control by applying water several times a day. - Mechanical vacuum/street sweepers will be used to maintain roadways and to keep paved surfaces clean from dust and dirt.
Dust Control • Perimeter construction fencing will act as a wind barrier to obstruct wind and help prevent soil from blowing off-site. • Crushed stone will be used over exposed soil to manage dust and dirt migration. Asphalt or concrete will be used at all construction entrances and material laydown areas. • Contractor parking shall be paved with appropriate stormwater collection. • Golf course haul road will be asphalt with stormwater swales to manage watershed and improve water quality discharge. • The golf course will continue to be irrigated and mowed to maintain appearance and stormwater management.
Dust Control Measures Outbound haul trucks will be Trucks will receive a wheel covered to prevent dust migration wash prior to leaving the site 28

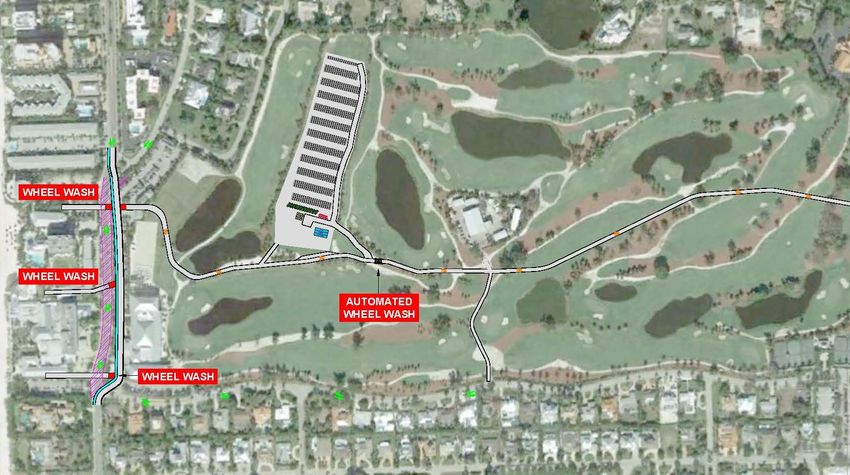

Truck Wheel Wash Stations 29
What should neighbors expect? - Gulf Shore Boulevard Bypass Road - Best practices in water and stormwater management - Dust control measures - Pre-Construction Surveys 30
Pre-construction Surveys Pre-construction surveys will be offered to owners within 100 feet of adjoining properties where demolition or vibratory construction will take place. The surveys will be prepared by a professional engineer or a city-approved inspector to document existing conditions of adjacent residential homes and other on-site structures to create a baseline of existing conditions. In the unlikely event that any damage occurs as a result of construction, the baseline survey will be used to measure the extent of the damage. • Neighbors will be contacted at least 14 days before demolition begins. • Allowable vibration levels shall comply with Naples City Ordinance 16-291 for seismic monitoring and preconstruction structure inspection. Seismic readings will be reviewed at the end of each day for all roof, wall, foundation & pool removal aspects. Final reports will be shared with City inspectors upon completion of the demolition work. Seismic monitoring will be completed by an independent third party consultant. • Athens will provide to the city pre-construction photographic surveys of right-of- way areas on South Golf Drive, Gulf Shore Boulevard North, and Oleander Drive. 31
Site Plan Study of adjacent properties within 100-ft. radius of the project 32
Residential Pre-construction Survey includes visual and photographic documentation Existing conditions will be photographed and carefully documented for future reference.
Demolition of Existing Buildings • The Athens Group has retained a third-party licensed environmental consultant to review all aspects of the property and to document that the structures are safe for demolition. • All on-site demolition activity will comply with applicable City, County, State and Federal regulations. Demolition permits will be issued by the City of Naples and Collier County; inspectors will be present throughout the demolition process. Seismic monitoring will be required per City ordinance 16-291 • Suffolk will use precision-style demolition techniques with high-reach excavation equipment to minimize construction noise, vibration and dust. Use of a wrecking ball for demolition is not anticipated. Wind speed and direction will be monitored.
Noise and Seismic Monitoring Professional engineers will use state-of-the-art seismic and noise monitoring devices during demolition and other construction activities to ensure that construction-related vibration and noise are in compliance. Noise monitoring equipment Vibration monitoring equipment 35
Demolition Program and Schedule Chiller Plant Parking Lot Hotel structures Northern 1/3 of Clubhouse 36
Anticipated Project Schedule • Naples Beach Hotel and Golf Course operations will close on May 30, 2021 - Hotel, Clubhouse, HB’s, Sunset Bar, golf course, tennis facility • Preparation for site construction will begin June 1, 2021 • Gulf Shore Boulevard bypass road construction will begin June 1 with expected traffic use beginning August 1, 2021; Gulf Shore Blvd. will remain in use during bypass construction • Haul road construction will begin June 1 with expected use beginning July 15, 2021 • Demolition of existing structures is expected to begin mid July and be completed in November 2021 • Vertical construction of new structures to commence in November 2021 • 8th Ave Beach Parking – Northern side of the parking lot is privately owned by NBH and will be closed during the demolition and construction phase. Public parking will remain open except for a 6 month period for renovation and landscape upgrade. Timing of the shutdown will be advertised in advance. • Gulf Shore Boulevard reconstruction is expected from August 2022 through May 2023; bypass road will continue to be in use during this time • Grand Opening of Phase One is anticipated in 4th Quarter 2023 37
Construction Site Viewing Once the project is underway, live webcam feeds will be available on the NaplesBeachClub.com site so neighbors and the general public can monitor progress. 38
Master Landscape Plan – Phase I 39
Athens Group construction contact: James Krall, P.E. JKrall@AthensDevCo.com (239) 326-0202 (office) 40
Thank you! All site plans, renderings and lifestyle images throughout this document are for illustrative purposes only and are subject to change. 41
