Acton Storm Tanks Community Liaison Working Group 15 May 2018

Page created by Bernice Deleon

CONTINUE READING
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
Community Liaison Working Group
15 May 2018
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
 Overview
Acton Storm Tanks is an existing Thames
Water pumping station and storm water
tanks site.
                                                   Acton Storm Tanks
The site will be used to receive the main          Site

tunnel from Carnwath Road Riverside as
well as intercept the existing Acton Storm
Relief combined sewer overflow.

The Problem:
At this location, in a typical year, there would
be 29 discharges of untreated sewage with
a volume of about 312,000 tonnes into the
tidal River Thames.

The Solution:
Our Acton Storm Tanks site will control the
discharges from Acton Storm Relief
combined sewer overflow. When the tunnel
is in operation it is expected that no
discharges will occur.
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Current operation
 Acton Storm Tanksat Acton Storm Tanks

                               Storm flows overflow the weir

                                                   Tanks 5 & 6 occasionally used for
                                                            extra storage

                                  6
                           5                                   Distribution channel directs flow
                                                                         to tanks 3 & 4

                                               4
                                        3
  Stamford Brook Sewer fills
      up during a storm

                                                                 2
    Distribution channel directs flow                  1
              to tanks 1 & 2

     When 4 tanks full pumps return flow to
           Stamford Brook Sewer
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
What we are doing
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
   Timeline

Project Duration:

BMB officially took possession of site on 13th November 2017. The project will take
approximately four years to complete.
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
  Last 3 Months                                                      Site Perimeter
                                                                     Hoarding Installation
                                                                     Continues
Footpath Widening
& Permanent
Access Installation                                                          Remove Temporary
is on-going                                                                  Welfare & Office Facility

                                                                                 Install Temporary
        Decommission                                                             Drainage & Hardstanding
        Existing Sewer &
        Install Sheet Piling

          Storm Tank 5 & 6 Decommissioning:
          • Strip-out of electrical & mechanical items
          • Removal of surface infrastructure
          • Preparation for demolition
                                                                                              Works not yet
                                                                                              commenced
                                      Commissioning of Permanent
                                                                                              Works complete or
                                      Welfare & Office Facility,                              ongoing
                                      currently partially occupied
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
Last 3 Months – Storm Tank Decommissioning

        Removal of electrical and mechanical infrastructure
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks
Last 3 Months – Storm Tank Decommissioning

        Removal of electrical and mechanical infrastructure
Acton Storm Tanks Community Liaison Working Group 15 May 2018
Acton Storm Tanks

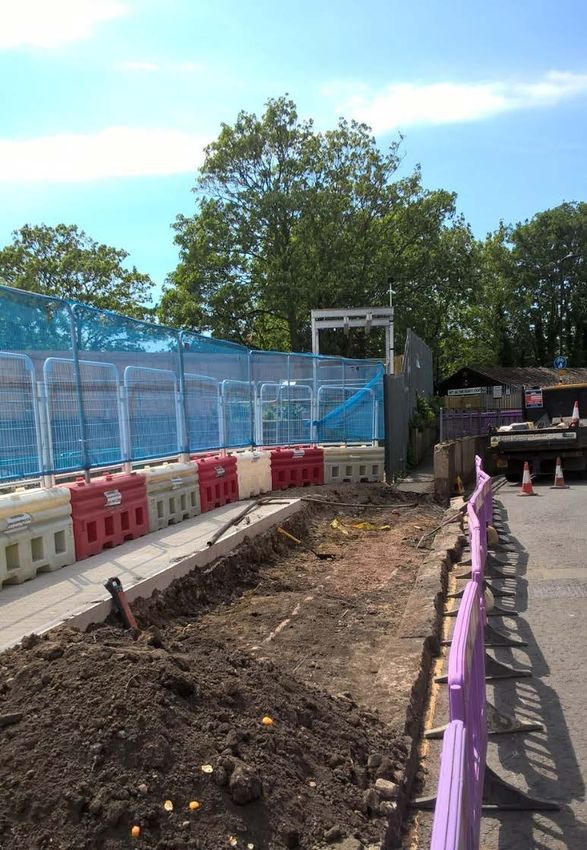

Last 3 Months – Canham Road Footpath Works

     SSE Cable Lowering   LBE Footpath Widening
Acton Storm Tanks
  Next 3 Months                                 Site Perimeter
                                                Hoarding Installation
                                                Continues
Complete Footpath
Widening &
Permanent Access                                       Remove Temporary
Installation                                           Welfare & Office Facility

                                                               Complete Installation of
Decommission Existing                                          Temporary Drainage &
Sewer & Install Sheet Piling                                   Hardstanding

                          Demolition of Storm
                          Tanks 5 & 6
BMB Predicted and Actual Vehicle Movements:
February 2018 – April 2018Movements: Sept to
Dec 2017
          Vehicle Movements (Monthly Daily Average)
   14

   12

   10

    8

    6

    4

    2

    0
         Feb-18                 Mar-18            Apr-18

                          Predicted   Actual
BMB Predicted Vehicle Movement Forecast :
May - September 2018 Movements: Sept to Dec
2017
                Predicted Forecast Vehicle Movements
                        May - September 2018
   6

   5

   4

   3

   2

   1

   0
       May-18      Jun-18        Jul-18       Aug-18   Sep-18
S61 Summary – Acton Storm Tanks
Acton Storm Tanks- Site Plan with Noise and Air
Quality Monitor locations

•   No exceedance of the DCO   •   No exceedance of the Mayor of
    set noise level of 75db        London recommended alert
                                   level
Muster point location
  A designated assembly point has been agreed for a place where our
  staff have been told to wait after evacuating a building in the event of a
  fire alarm or other emergency.

  The muster point is located at the large open area of pavement on
  Warple Way next to Tesla Court.
COMMUNITY ENGAGEMENT
Update - Community Engagement and Complaints

• 1x Information notices sent out since last meeting
    1 x Site Entrance and Footpath Widening
• Four complaints received since last meeting
     Two complaints were in regard to ‘Noise arising from a
      generator’ – Advised the residents we have replaced the
      temporary generator with permanent .
     One complaint was regarding to ‘noise at night’– Advised
      resident no 24 hour works taking place at our worksite. Residents
      address was also closer to Turnham Green underground station.
     One complaint was regarding ‘breaking out works’– Advised
      resident that no breaking out works were taking place but we were
      excavating the drainage run in the way of the hoarding line.
      Ongoing liaison with resident.
• All other enquiries have been responded to within 24 hours (where possible)

                               Call: 08000 30 80 80
                               Email: helpdesk@tideway.london
                               Write to: Freepost TIDEWAY
Community Engagement
Community Investment Update
Following feedback received from a local resident at a previous CLWG, we have
recently carried out STEM session to Southfield Primary School where a
presentation was given to over 200 students.
HOW TO MAKE A CLAIM IF YOU ARE AFFECTED BY
TIDEWAY’S WORK
Who do I go to for advice?
• Independent Advisory Service (IAS) Helpline for independent advice:
   0800 917 8845 or info@tidewayias.co.uk
• Tideway’s Compensation Officer, Louise Davis, for personal assistance
  and advice: via Tideway Helpdesk 08000 30 80 80 or
  helpdesk@tideway.london or direct 07971 077165 or
  louise.davis@tideway.london

How do I submit my claim?
• Louise can submit your claim to the Independent Compensation Panel
  (ICP) on your behalf, or
• You can submit your claim direct to the ICP: admin@tidewayicp.london
• The IAS can send you a claim form, or you can download a claim form off
  the Tideway website: www.tideway.london/help-advice/compensation-
 information/Independent-Compensation-Panel

                                                                            20
Acton Storm Tanks Indicative Landscape Plan
Parking suspensions and waiting restrictions as
per DCO
                   •   Several sections of parking suspensions and waiting
                       restrictions are required to enable access for larger
                       HGVs to the site. London Borough of Ealing have
                       begun the implementation of these.

                   •   Vehicle swept path analysis was been carried out
                       during the DCO process to determine where these
                       were required.
You can also read
