2018 Spring Update Customer Service - WE MAKE ENERGY HAPPEN - Williams
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Forward-looking Statements > The reports, filings, and other public announcements of Williams Partners L.P. (WPZ) and Transcontinental Gas Pipe Line Company, LLC (Transco) may contain or incorporate by reference statements that do not directly or exclusively relate to historical facts. Such statements are "forward-looking statements" within the meaning of Section 27A of the Securities Act of 1933, as amended, and Section 21E of the Securities Exchange Act of 1934, as amended. We make these forward-looking statements in reliance on the safe harbor protections provided under the Private Securities Litigation Reform Act of 1995. Forward-looking statements can be identified by various forms of words such as “anticipates,” “believes,” “seeks,” “could,” “may,” “should,” “continues,” “estimates,” “expects,” “forecasts,” “intends,” “might,” “goals,” “objectives,” “targets,” “planned,” “potential,” “projects,” “scheduled,” “will,” “assumes,” “guidance,” “outlook,” “in service date” or other similar expressions. These forward-looking statements are based on management's beliefs and assumptions and on information currently available to management and include, among others, statements regarding: – Our and our affiliates future credit ratings; – Amounts and nature of future capital expenditures; – Expansion and growth of our business and operations; – Financial condition and liquidity; – Business strategy; – Cash flow from operations or results of operations; – Rate case filings; – Seasonality of certain business components – Natural gas, natural gas liquids, and olefins prices, supply, and demand; and – Demand for our services > Forward-looking statements are based on numerous assumptions, uncertainties and risks that could cause future events or results to be materially different from those stated or implied in this presentation. Many of the factors that will determine these results are beyond our ability to control or predict. Specific factors that could cause actual results to differ from results contemplated by the forward-looking statements include, among others, the following: – Availability of supplies, market demand, and volatility of prices; – Inflation, interest rates, and fluctuation in foreign exchange rates and general economic conditions (including future disruptions and volatility in the global credit markets and the impact of these events on customers and suppliers); – The strength and financial resources of our competitors and the effects of competition; – Whether we are able to successfully identify, evaluate and execute investment opportunities; – Our ability to acquire new businesses and assets and successfully integrate those operations and assets into our existing businesses as well as successfully expand our facilities; – Development of alternative energy sources; – The impact of operational and developmental hazards and unforeseen interruptions; – Costs of, changes in, or the results of laws, government regulations (including safety and environmental regulations), environmental liabilities, litigation, and rate proceedings; 2
Forward-looking Statements (cont’d) – Williams’ costs and funding obligations for defined benefit pension plans and other postretirement benefit plans; – Our allocated costs for defined benefit pension plans and other postretirement benefit plans sponsored by our affiliates; – Changes in maintenance and construction costs; – Changes in the current geopolitical situation; – Our exposure to the credit risk of our customers and counterparties; – Risks related to financing, including restrictions stemming from debt agreements, future changes in credit ratings as determined by nationally-recognized credit rating agencies and the availability and cost of capital; – The amount of cash distributions from and capital requirements of our investments and joint ventures in which we participate; – Risks associated with weather and natural phenomena, including climate conditions and physical damage to our facilities; – Acts of terrorism, including cybersecurity threats and related disruptions; – Additional risks described in our filings with the Securities and Exchange Commission (SEC) > Given the uncertainties and risk factors that could cause our actual results to differ materially from those contained in any forward-looking statement, we caution investors not to unduly rely on our forward-looking statements. We disclaim any obligations to and do not intend to update the above list or announce publicly the result of any revisions to any of the forward-looking statements to reflect future events or developments. > In addition to causing our actual results to differ, the factors listed above may cause our intentions to change from those statements of intention set forth in this presentation. Such changes in our intentions may also cause our results to differ. We may change our intentions, at any time and without notice, based upon changes in such factors, our assumptions, or otherwise. > Investors are urged to closely consider the disclosures and risk factors in WPZ’s and Transco’s annual reports on Form 10-K filed with the SEC on Feb. 25, 2015, and each of our quarterly reports on Form 10-Q available from our offices or, in the case of WPZ, from our websites at www.williams.com and www.investor.williams.com 3
Commercial Operations - Customer Services Gary Duvall VP Transco Commercial Hector Alatorre Director Customer Services Keith Higginbotham John Cassapo Suzanne Heiser Bill Eiser Martha Janousek Manager Laurie Catlett Manager Leads Business Business Development – Development – Customer Service Customer Service Production Area Market Area Contracts Transportation Marketing Paul Prodoehl Toi Anderson Celyna Ebohon Cindy Hungate Laarni Hernandez Andrea Beltran Karen Gallardo James Corley Liz Hughes Contract Analysts Sean Xin Customer Service Representatives 4

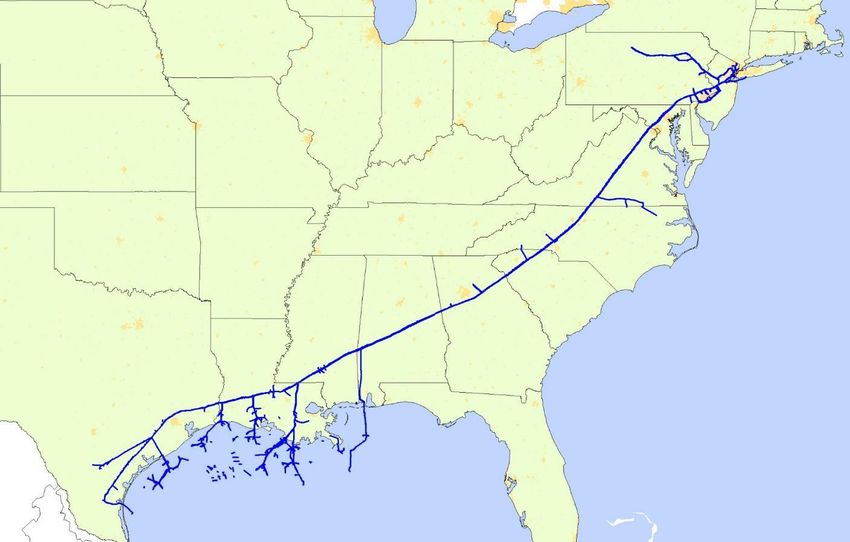

Strategic Asset Position CONNECTING THE BEST SUPPLIES Marcellus-Utica, Gulf Coast TO THE BEST MARKETS New York City, Washington D.C., Philadelphia, Florida, Atlanta, LNG export • Nations largest-volume interstate pipeline system • 9,700 miles of pipeline with 14.98 MMdth of gas per day for system- wide delivery capacity (As of 12/31/17) • 50 compressor stations, four underground storage fields and one LNG storage facility • Competitively positioned between strong supply and demand areas along eastern seaboard 5
Transco Peak Day Deliveries and System Capacity Note: Includes all system deliveries and all Zones. 6

Weather Location January 4, 2018 January 5, 2018 January 6, 2018 High / Low High / Low High / Low New York 29 / 19 19 / 9 13 / 6 Charlotte 34 / 18 36 / 8 34 / 12 Atlanta 35 / 20 38 / 16 39 / 20 Tampa 56 / 38 60 / 35 61 / 41 7
Peak Day Delivery Quantities by State 3,500 3,000 2,500 MMscfd 2,000 1,500 1,000 500 0 TX LA MS AL GA SC NC VA MD PA NJ NY 1/5/2018 1/8/2017 1/18/2016 8
Takeaways From Winter & Opportunities Going Forward > Transco system was stressed, but performed well. Many teams worked long hours managing equipment issues, storage changes, gas scheduling activity, etc. > Peak day occurred on a Friday which allowed the system to recover over the weekend. > OFO issuance and limitations on availability of non-primary firm transportation helped manage capacity and system suppliers performed well given the temperatures and potential production freeze off issues. > The Transco system continues to expand and has transformed into a bi-directional system, highlighting the need for additional collaboration between Pipeline Control and Operations and customer activity driving dynamic system operations, requiring frequent operating changes. > Large deliveries dependent on a fixed set of assets requiring timely and frequent communication and coordination, both internal and external. > Increase opportunities for dialogue and collaboration between Pipeline Control and customers, better understanding their needs and enhancing operating relationships. > Opportunities for additional pipeline control focus and engagement on near and longer term system outage and modernization needs. 9
Supply / Demand Forecast: 2016-2021 Anadarko, Arkoma and Appalachian Basin +15 23 38 +1 +1 +2 14 15 11 12 15 17 +1 13 14 +3 35 38 +10 +3 26 36 12 15 Regional Production change, 2016 to 2021 (Bcf/d) (1) Regional Demand change, 2016 to 2021 (Bcf/d) (1) (1) Size of bubble indicates magnitude of 2021 production or demand Source: Wood Mackenzie 1H 2017, excludes impact of net Canadian imports. Data contained in this slide is property of Wood Mackenzie. Per Williams’ agreement, data may only be used for individual customer meetings unless prior consent is received. Do not duplicate or alter information in any way. 10
Receipt or Volume (MMscf) Receipt or Receipt / Delivery / Net Supply Overview Lateral 04-01-2016 to 04-01-2017 to % Chg 03-31-2017 03-31-2018 McMullen 61 / (17) / 44 61 / (33) / 28 (36%) CTGS 204 / (96) / 108 164 / (29) / 135 25% Leidy SWLA 105 / (80) / 25 82 / (852) / (770) (3180%) Lambertville CENLA 102 / (5) / 97 121 / (9) / 112 15% Rivervale Lower Chanceford Zone 3 M/L Total 751 1,503 100% Pleasant Valley SELA 185 / (92) / 93 138 / (52) / 86 (8%) Zone 6 Sta85 Receipts 2,110 2,399 14% Nokesville Mobile Bay 559 / (1,333) / (774) 517 / (1,198) / (681) (12%) Boswells Tavern Black Warrior 25 31 23% Cascade Creek 109 125 15% Boswells Tavern 176 95 (46%) Cascade Creek Nokesville 68 66 (4%) Zone 5 Pleasant Valley/Cove 75 66 (12%) Point Lower Chanceford 828 846 2% Sta85 Receipts Lambertville 67 72 7% Peak Day Information Rivervale 213 209 (2%) Peak Day deliveries to Cheniere affect SWLA and Zone 4 Mainline interconnects in Zone 3. Leidy 2,976 / (972) / 2,004 3,107 / (983) / 2,124 6% Black Warrior Station 85 receipts at 3.3 BCF. Zone 3 Mobile Bay flow southward peaks as Florida sees Zone 2 peak conditions. Mobile Bay Large increases in numerous mid Atlantic receipts as Zone 1 gas demand rises in Zone 5. McMullen SWLA Large decrease in deliveries to Elba. SELA Cove Point Pipeline sends over 500 MMCF to CENLA CTGS Transco. Leidy receipts at over 4.0 BCF
Market Transitions Drive More Volume Southward Sta090 Northbound Flow Sta130 Sta065 Sta165 Sta030 Southbound Flow Sta195 Sta045 12
Transco Deliveries to End Users by State 2,000,000 1,800,000 1,600,000 1,400,000 1,200,000 Dth 1,000,000 2013 2014 800,000 2015 2016 600,000 2017 400,000 200,000 0 13
Growth Volumes Well Balanced Among Customers LDC / Industrial LNG Exports 19% 23% Distribution of total volume growth (7.2 Bcf/d) for 2017 to 2020 32% 26% Producer Power Generation 14
Leidy Line & Wharton Storage Update & System Maintenance Leidy Line > Transco has completed the requirements of the Corrective Action Order (CAO). > In addition to CAO compliance activities, integrity testing was also performed on other pipelines on the Leidy system. This includes over 325 miles of pipeline. > The tests included the use of various pigging technologies, hydrotests, etc. > All of Transco Leidy Lines are back to normal operations. Wharton Storage > Transco is currently undertaking a comprehensive assessment of Station 535, the storage field and the related injection and withdrawal lines to and from storage. > The target is to have the assessments and all necessary repairs complete on both the storage field and the compressor station in time to provide service for the 2018-2019 withdrawal season. > The objective of the assessment is to ensure that that all of the Wharton Storage Facilities continue to operate in a safe and reliable manner once the repairs are complete and placed back in service. > Transco intends to continue to implement measures designed to mitigate potential impacts of this event on its ability to provide Rate Schedule GSS service. > We will keep you appraised of any additional developments, including any limitations on the availability of storage services provided under Rate Schedule GSS. System Maintenance > Williams takes steps for prevention measures through a continual Operations and Maintenance Program. > Schedule found at www.1Line.Williams.com. 15
Modernization Program > Modernization Program – Evaluation – A strategic and defined program to upgrade and/or replace HP/Compression and pipeline facilities that • Require replacement based on risk profile • Require upgrades to meet new / emerging PHMSA and EPA rules • Provides reliability improvements to meet current and future flow conditions – Focuses on capital optimization that evaluates systems with a life-cycle viewpoint – An evaluation of the various cost recovery methods acceptable to FERC policy (PL15- 01-000) – Transco will continue to keep Customers updated on the progress of the modernization program 16
Priority of Service Summary > No-notice priorities of service offered by Transco: Traditional, Non-Traditional, Secondary and IT to continue providing additional flexible service – Flexible services will continue to be available when operationally feasible – Only Traditional and IT no-notice are provided by current tariff in Section 5.1 (b) of Rate Schedule FT, FTG, FDLS and IT > No-notice is related to the primary contract path – Supported in current tariff in Section 4.7 of Rate Schedule FT, FTG, and FDLS > Removal of Path for HBLV no-notice requests without a supply of gas – No-notice is received and delivered at the point of delivery and is supported by Section 5.1 (b) of Rate Schedule FT, FTG, and FDLS > Imbalances held in zone of receipt; HBLV no-notice receipt is at the SSDP – No changes to Imbalance Resolution GT&C Section 25 or Cash Out GT&C Section 37 > No additional capacity needed to use Station 95 Pool; No transportation fee or fuel between Station 85 and Station 95 transactions – Segmentation allows shipper to relocate low burn requests from OIA 1 to OIA 2 – Proposed tariff changes to GT&C Sections 28, 37, 51 and 52 to accommodate additional Station 95 pool in Zone 4 > Transportation and fuel charges assessed as provided in current tariff – No additional charges are proposed for transactions on system 17
Regulatory Update > On March 16, 2018, Transco filed to change the pooling rules in its tariff effective October 1, 2018 to begin charging commodity and fuel rates on transactions leaving the zones 5 & 6 pools rather than applying those charges to transactions going into those pools. The proposed change will make Transco’s pooling rules consistent at all of its market area pools. > On March 27, 2018, Transco filed an application with the Commission to abandon approximately 1.4 bcf of Eminence capacity effective April 1, 2018, due to the company’s decision to operate the caverns at a lowered pressure. > On March 15,2018, the Commission issued a revised Policy Statement in Docket No. PL17-1-000, which revises its policy regarding the recovery of income tax costs in rates of jurisdictional natural gas pipelines. Because the Commission found that an impermissible double recovery results from granting a Master Limited Partnership (MLP) pipeline both an income tax allowance and a return on equity pursuant to the discounted cash flow methodology, the Commission revised its policy and will no longer permit an MLP to recover an income tax allowance in its cost of service. The Commission further found that, while all partnerships seeking to recover an income tax allowance will need to address the double-recovery concern, the Commission will address the application of its revised Policy Statement to non-MLP partnership forms as those issues arise in subsequent proceedings. > The Commission also issued a contemporaneous Notice of Proposed Rulemaking in Docket No. RM18-11-000, that proposes a process that will allow it to determine which jurisdictional natural gas pipelines may be collecting unjust and unreasonable rates in light of the recent reduction in the corporate income tax rate in the Tax Cuts and Jobs Act and the FERC’s revised Policy Statement. Transco is evaluating the impact of these issuances on its business. 18
Rate Case Update > As agreed in Article VI of the Stipulation and Agreement in Docket No. RP12-993, et al., Transco will file a NGA Section 4(e) general rate case no later than August 31, 2018. > Assuming that the filing date is August 31, 2018, the base period for the rate case will be June 1, 2017 – May 31, 2018 and the test period will be June 1, 2018 – February 28, 2019. > Assuming a full five month suspension period for the new rates, the effective date of the rates will be March 1, 2019. 19
Unsubscribed Capacity FT Capacity 313,850 FT; Non-seasonal; Mobile Bay MP261 to Pooling Station 85 Z4A 37,346 FT; Non-seasonal; Southeast Louisiana Lateral Station 62-65 3,763 FT (ACQ) Available 8/1/2018; Seasonal (March 1- November 30) Telescoped Capacity Washington Storage 124,200 dt Storage Capacity; Withdrawal 1,307 dt/d; Injection 690 dt/d. available 5/1/2018. 262,678 dt Storage Capacity; Withdrawal 2,765 dt/d; Injection 1,459 dt/d. available 8/23/2018, pending the outcome of an open season. Eminence EESWS 62,201 dt; Withdrawal 7,446 dt/d; Injection: 621 dt/d. Eminence ESS Rate Schedule 2,018,705 dt; Withdrawal: 239,949 dt/d; Injection: 20,042 dt/d. 54,996 dt; Withdrawal 6,518 dt/d; Injection 544 dt/d. available 11/1/2018, pending the outcome of an open season. 47,484 dt; Withdrawal 5,684 dt/d; Injection 474 dt/d. available 3/1/2019, pending the outcome of an open season. 20
Atlantic Sunrise (ASR) Project – 1Line Changes > New “ROUTE” data element will be added to 1Line with the ASR Project in-service date – The Atlantic Sunrise (ASR) project will include the new Central Penn Line South (CPLS), giving shippers an alternate route option for some Zone 6 transactions. • A NAESB nomination element, ROUTE, will be required for affected Zone 6 transactions and will be effective with the ASR Project in-service date. • Valid Route options will be displayed in 1Line for affected nominations and secondary capacity release transactions. • EDI and Flat File formats will include the new ROUTE option. To ensure EDI files work correctly, customers must participate in testing. • Presentations with more details on the new ROUTE element, including EDI and Flat File testing information: – http://www.1line.williams.com/Transco/files/EDIASRCommunication.pdf – http://www.1line.williams.com/Transco/files/presentations/NewNominationDataFieldWebinar.pdf > River Road Transfer Point – The junction of the new Central Penn Line South (CPLS) and Transco’s mainline, north of Station 195 will be a Transfer Point • Delivery and Receipt volumes at the Transfer Point must match for each transaction. • “Lesser of” rule will apply for out of balance transactions across Transfer Point • Transport charges will apply on both deliveries to and receipts from Transfer Point 21
Atlantic Sunrise (ASR) Project – 1Line Changes > Nominations and non-ASR secondary Leidy - capacity releases with paths that cross or Dominion are within any of the red brackets require Sta. 517 Route selection. > 3 Route Options – Non-CPLS: transaction moves on the North-CPLS Mainline or Leidy Line only – South-CPLS: transaction moves DOWN CPL-South (CPLS) the CPLS to the Mainline – North-CPLS: transaction moves UP the 210 Pool South-CPLS CPLS to the Leidy Line > Valid Route options will be displayed in 1Line. > No Route option for: – Transactions with paths that do not cross into the bracketed triangle Sta. 195 River Road – Primary capacity releases Zone 6 Transfer – Secondary capacity releases of ASR contracts Zone 5 BG&E 22
Major Expansion Projects Gateway Project Mdt/d Pre-construction Atlantic Sunrise Q1 2021 Rivervale Atlantic Sunrise 1,700 Under construction Mid 2018 Q4 2019 In Service Garden State 180 Garden State Q3 2017 / Q1 2018 Gulf Connector 475 St. James Supply 162 Southeastern Trail Northeast Supply Q4 2020 Q4 2019 / Q1 2020 NESE 400 Hillabee – Phase II 207 Hillabee Phase 2 Rivervale South to Market 190 Q2 2020 Southeastern Trail 296 Gulf Connector Gateway 65 Q1 2019 Total Expansion Capacity 3.26 Current Transco Capacity* 14.98 Total Post-Expansions 18.24 St. James Supply Q2 2019 * Includes 20 MDth/d for Garden State and 400 MDth/d for Atlantic Sunrise placed in service in 2017 23

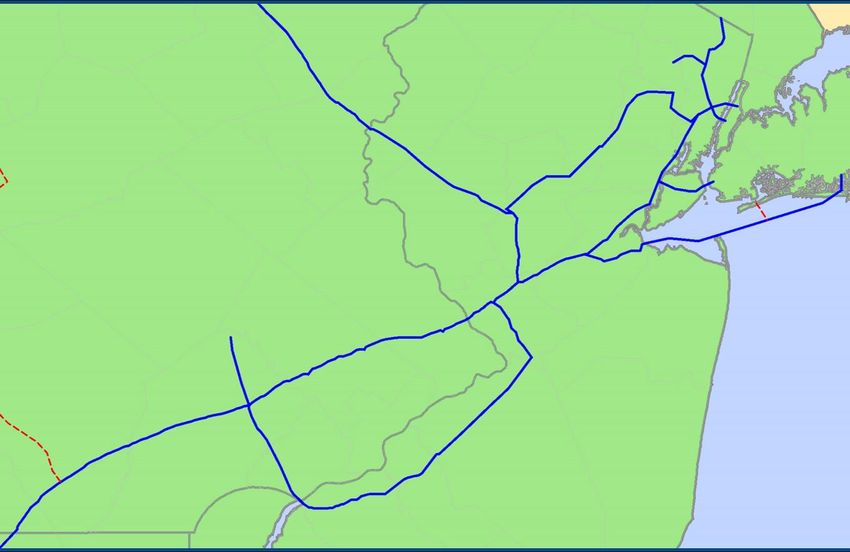

Northern Market: Continuing Strong Growth Rivervale South to Market New York Bay • 195 Mdt/d • 115 Mdt/d • Q4 2019 • October 6, 2017 Leidy Hub Gateway New York City • 65 MDth/d • Q1 - 2021 Atlantic Sunrise • 1,700 Mdt/d • Mid 2018 210 Northeast Supply Enhancement • 400 Mdt/d • Q4 2019 / Q1 2020 195 Garden State • 180 Mdt/d • March 23, 2018 VA Note: In-service dates and capacities for projects not yet in service represent expected in-service dates and capacities 24
Power Generation Fuels Southern Market Expansions Virginia Southside II • 250 Mdt/d • December 1, 2017 165 Dalton Expansion 160 • 448 Mdt/d • August 1, 2017 Hillabee Expansion Ph I • 818 Mdt/d • July 11, 2017 Southeastern Trail • 296 Mdt/d • Late 2020 Hillabee Expansion Ph II 85 • 207 Mdt/d • Q2 - 2020 Note: In-service dates and capacities for projects not yet in service represent expected in-service dates and capacities 25
Gulf Coast Area Expansions Serving LNG and Industrial Customers 65 Gulf Connector • 475 Mdt/d • 1st half 2019 50 45 St. James Supply • 161 Mdt/d • Q2 2019 30 Gulf Trace • 1,200 Mdt/d • February 1, 2017 Note: In-service dates and capacities for projects not yet in service represent expected in-service dates and capacities 26
LNG Opportunities Gas Flows to Sabine Pass in Bcf/d > Contracted with four of six 3.5 LNG facilities currently 3.0 Daily in-service or under 2.5 construction (~2 Bcf/d) 2.0 1.5 LNG – Market access to the other two 1.0 0.5 export facilities - > Contracted with Sabine Pass Liquefaction; took delivery of nearly 90 Bcf in Nov. 2017 LNG > Seven additional projects in development to LNG support LNG exports LNG LNG LNG Sabine Pass, Contracted Other Contracted Market Access 27
Eastern Interstates – Projects in Execution We are currently executing a total of 10 different expansion opportunities Constitution Q3 2019 Station 240 Modernization Q4 2019 New York Bay Expansion Rivervale South to Market Q4 2017 Q4 2019 NE Supply Enhancement Gateway Q4 2019 / Q1 2020 Q1 2021 Atlantic Sunrise Garden State Phase I Mid 2018 Q3 2017 Garden State Phase II Southeastern Trail Q1 2018 Q4 2020 Virginia Southside II Q4 2017 Gulf Trace Dalton Expansion Q1 2017 Q3 2017 Gulf Connector Q1 2019 Projects shaded in yellow are Hillabee Phase 1 starting or under construction. Q3 2017 Projects shaded in green are in service. Stars represent power St. James Supply Hillabee Phase 2 generation Q2 2019 Q2 2020 Shipper FERC Certificate FERC FERC Major Construction In-service Commitments Application Filed EIS / EA Certificate Activities REGULATORY MILESTONES FOR FULLY CONTRACTED REGULATED EXPANSIONS NE Supply Enhancement Rivervale South to Atlantic Sunrise Gulf Trace - ISD 2/17 Constitution Filed 3/17 Market Received 12/14 Began 3/17 Hillabee Ph 1 - ISD 7/17 Rivervale South to Market Received 3/18 Hillabee Ph 2 Gulf Connector Dalton - ISD 8//17 Filed 9/17 Received 2/16 Began 2/18 Garden St Ph 1 - ISD 9/17 Gateway St. James Garden St Ph 2 – ISD 3/18 Filed 11/17 Began 4/17 New York Bay - ISD 10/17 Southeastern Trail VSS II - ISD 12/17 Filed 4/18 28

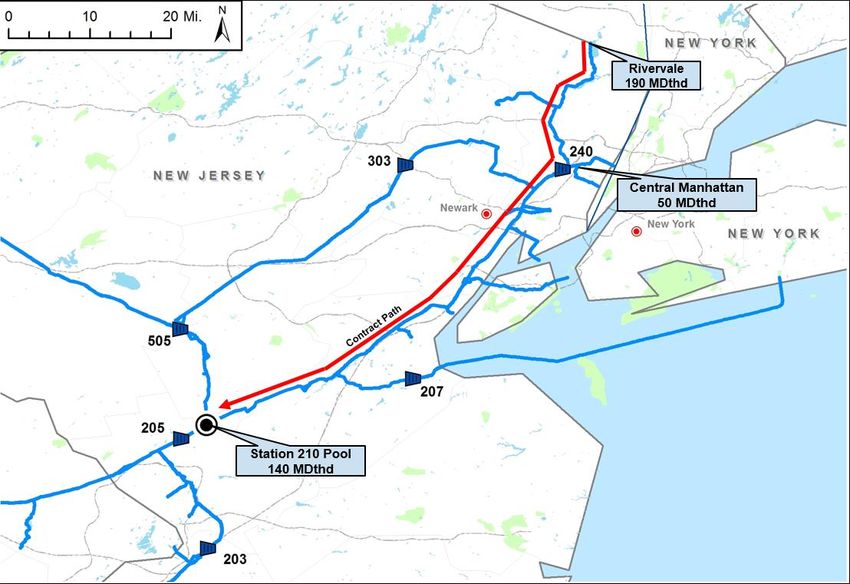

Garden State Project Status: • Phase I in service on Sept 9, 2017 (20 MDth/d); • Phase II placed in-service on March 23, 2018 (160 MDthd). 505 Zone 6 207 PA 210 Pool 205 Trenton > Expansion from Station 210 in Mercer County, NJ to a new delivery point with New Jersey Natural NJ 203 on Transco’s Trenton Woodbury Lateral in Burlington County, New Jersey New Meter and Compressor > Service will be provided under Transco’s FT Station Service. > Capacity: 180 MDth/d > Phase I – 20 MDth/d and > Phase II – 160 MDth/d > Shipper: New Jersey Natural Gas Company 29
Atlantic Sunrise Project Status: • All regulatory authorizations/ permits received with construction underway on all project facilities; • Target in-service date: Mid 2018. > Expansion of Transco’s Leidy Line to Mid- Atlantic and Southeast Markets New York City > Provides access to markets in Zones 6, 5 and 4 Zone 6 > Service will be provided under Transco’s FT 195 To River Road: Service 500 Mdt/d > Capacity: 1,700 Mdt/d To Pleasant Valley: > Shipper: Numerous 350 Mdt/d Shipper Dth/d Anadarko 44,048 Zone 5 SWN 44,048 Inflection 26,429 Zone 4 Chief 420,000 Cabot 850,000 Seneca 189,405 85 WGL Mid. 44,048 MMGS 22,024 Southern Co. 60,000 Total 1,700,002 30
Gulf Connector Project Status: • Construction commenced in February 2018; > Expansion of Transco's mainline from • Target In-Service Date: Q1 2019. Station 65 to LNG delivery points in Zone 2 MS 85 and Zone 1 LA Zone 4 > Will be provided under Transco’s FT Service Zone 3 > Capacity: 475 Mdt/d 65 Zone 2 45 TX Zone 1 30 Freeport LNG – 75 Mdt/d CCLNG - 400 Mdt/d 31
St. James Supply Project Status: • Received FERC Certificate on January 18, 2018; > Incremental transportation from Transco’s • Construction commenced in April 2018; Station 65 to a new interconnect with the • Target In-Service Date: Q2 2019. 85 proposed YCI M1 facility > Will be provided under Transco’s FT Service > Capacity: 161.5 Mdt/d > Shipper: YCI St. James Enterprises LLC Zone 4 65 Zone SELA 45 82 3 YCI St. James Enterprises 62 32

Station 240 Modernization Project Status: • Transco filed a 30-day advance notice with FERC on March 1, 2018 • Target In-Service Date: Q4 2019 Project Facts: • Replace liquefaction plant at Station 240 in Carlstadt, New Jersey to resolve safety and emissions issues, liquefaction degradation, operational/reliability issues. • Facilities: Gas Pretreatment 10 MDth/d Liquefaction Compression Control System and Transformers Background: • Station 240 is a peak-shaving LNG plant constructed in 1964. • Consists of liquefaction, vaporization, and storage. • The vaporization was replaced/upgraded in 1991. • Total Storage is approximately 2,000 MDT • Contractual Vaporization of 400 MDthd; Contractual Liquefaction of 10 MDth/d. 33
Rivervale South to Market Project Status: • FERC Application filed on August 31, 2017; • Received EA on March 16, 2018; > Expansion from the Rivervale interconnect with • Target In-Service Date: Q4 2019. Tennessee Gas Pipeline in Bergen County, NJ to the existing Central Manhattan M&R and Station 210 Pool. > Will be provided under Transco’s FT Service Rivervale > Capacity: 190 Mdt/d > Shipper(s): Direct Energy (187.5 Mdt/d), UGI Energy Services (2.5 Mdt/d) Zone 6 New York City 210 Pool 34
Northeast Supply Enhancement Project Status: • FERC Application filed on March 27, 2017; • Draft Environmental Impact Statement received on March 23, 2018; • Target In-Service Date Q4 2019 / Q1 2020. 303 > Expansion from Station 195 in York County, PA to the Rockaway Lateral in New York Bay. Narrows > Will be provided under Transco’s FT Service. > Capacity: 400 Mdt/d Rockaway > Shipper: National Grid 207 Delivery Point 205 210 Pool 200 Atlantic Sunrise Project Proposed River Transfer Point 195 35

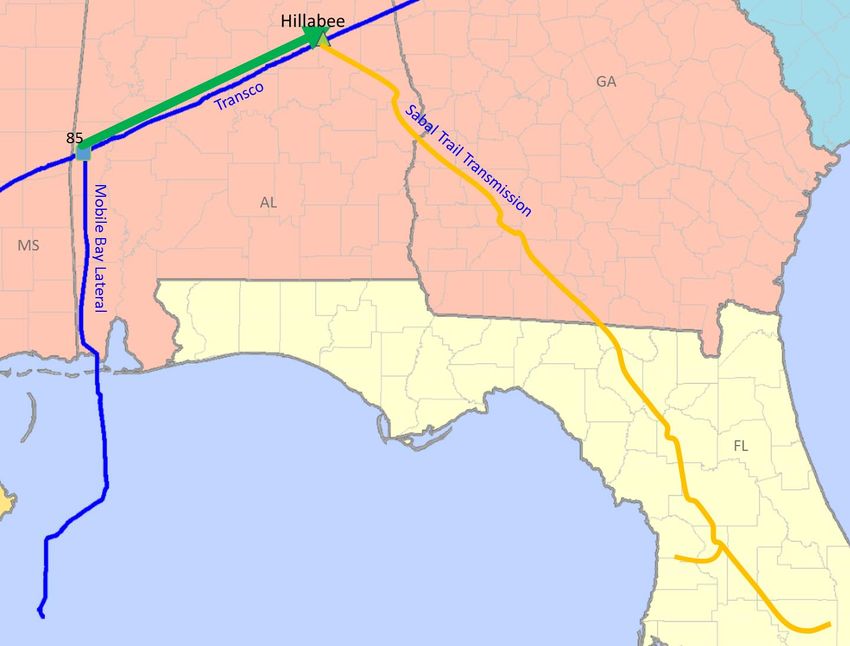

Hillabee Phase 2 Project Status: • FERC Order on Feb 2, 2016 and all other permits Zone have been received; 4 • Limited work completed to-date; • Target In-Service Date: Q2 2020. > Point-to-point lease with Sabal Trail from Station 85 to a new interconnect in Hillabee, AL > Leased capacity will be used by Sabal Trail to provide access to Station 85 for its greenfield pipeline, which will extend to central Florida to serve Florida markets > Capacity: 207 Mdt/d > Shipper: Sabal Trail Transmission 36
Gateway > Expansion from the proposed PennEast Pipeline Company interconnect in Mercer County, NJ to the existing Paterson M&R and Ridgefield M&R. > Will be provided under Transco’s FT Service > Capacity: 65 Mdt/d > Shipper(s): PSEG Power (54 Mdt/d), UGI Energy Services (11 MDt/d) 210 Pool Project Status: • FERC Application filed on Nov 15, 2017; • Target In-Service Date: Q1 2021. 37
Southeastern Trail > Firm transportation from the existing Zone 5 Pleasant Valley Interconnect with Dominion’s Cove Point Pipeline south to our existing Zone 3 Pool at Zone 6 Station 65. > Will be provided under Transco’s FT Service > Capacity: 296.375 MDt/d > Shipper(s): PSNC, SCE&G, City of Buford (Ga), City of LaGrange (Ga), Virginia Natural Gas. Zone 5 Zone 4 Project Status: • FERC Application filed on April 10, 2018; • Target In-Service Date: Q4 2020. 38
WE MAKE ENERGY HAPPEN Projects in Development 39
Adelphia Connection Expansion In Development Martins Creek Terminal From MARC1 on Leidy Lower Mud Run Project Facts: • Path from MARC 1 and a proposed interconnection with Adelphia Gateway Pipeline to markets on Transco's Marcus Hook / Trenton Woodbury Lateral. • Facilities: Potential pipeline replacement, compression addition and meter station 207 additions/ uprates. • Capacity: 250 MDth/d 210 Pool 205 • Proposed ISD: November 1, 2021 Pennsylvania 203 200 Trenton New Jersey Woodbury Lateral Contract Path Proposed Interconnect with Adelphia Gateway Pipeline 40
South Louisiana Market In Development Contract Path Project Facts: Zone • Path from Transco’s Station 65 to a new interconnect with 3 the methanol facility in St. James Parish, LA. • Facilities: 0.6 miles of 20-inch Greenfield lateral • Capacity: 202 Mdt/d • Proposed ISD: 2021 45 41

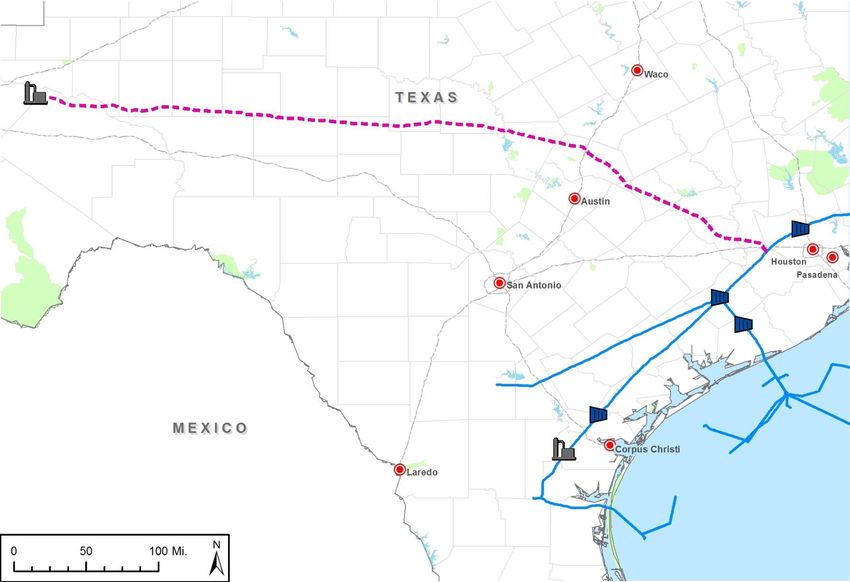

Bluebonnet Market Express In Development Waha Supply Header Contract Path Katy Delivery Header Station 30 Station 35 Station 17 Project Facts: Agua Dulce • Greenfield pipeline from the Waha Supply Hub in the Permian basin to the Katy Hub landing area on Transco. • Facilities: 476 miles of Greenfield pipeline, 5 Greenfield compressor stations totaling 224,000 hp and 12 receipt and delivery meter stations. • Capacity: 2,000 Mdt/d • Proposed ISD: Late 2020 42
