#1 Community Update - Sunshine Coast Council

Page created by Kevin Dixon

CONTINUE READING
#1 Community Update - Sunshine Coast Council
#1 Community Update
                                                                                      Project: #H0180

                                                                                    March 2018

Mayes Canal Pedestrian and
Bicycle Bridge

Stage 5 of the Mooloolaba to Minyama Separated Bikeway
Sunshine Coast Council, in conjunction with the Queensland Government’s Cycle Network
Local Government Grants Program, is constructing a new pedestrian and cycle bridge
across Mayes Canal. The bridge separates pedestrians and cyclists from vehicles
travelling along Brisbane Road and represents Stage 5 of the Mooloolaba to Minyama
Separated Bikeway project.

About the project                                     programs that improve our lifestyle, health and
                                                      sustainability”.
The separated bikeway is the first to be
constructed on the Sunshine Coast and a               The Mooloolaba to Minyama Separated
flagship project for the region                       Bikeway Project helps to achieve that vision.

The Mayes Canal Pedestrian and Bicycle                The Mayes Canal Pedestrian and Bikeway
Bridge represents Stage 5 of the project. It          Bridge improves access and safety for cyclists
forms a vital link between the recently               and pedestrians, reduces traffic congestion
completed Stage 4 works along Bindaree                and improves the streetscape including park
Crescent and River Esplanade.                         landscaping, lighting and drainage.

The bridge will feature decorative panel              This initiative is supported by the Queensland
elements and be five metres wide and 66               Government’s Cycle Network Local
metres long. It will be an entry statement into       Government Grants program.
Mooloolaba with architectural features and
landscape works along the approaches in the
adjacent parklands.

The project provides separated spaces for
pedestrians and cyclists approaching the
bridge and then minimises the interaction
between them when crossing the bridge via
visual design treatments on the bridge deck.

Council’s Sunshine Coast Active Transport
Plan 2011-2031 includes a vision for “the
Sunshine Coast to be recognised as an active
transport friendly place where people of all
ages walk and cycle for enjoyment and
transport, our community values our quality           Mayes Canal and location of new pedestrian and
active transport infrastructure and has               bicycle bridge (at right)

                                        Mayes Canal Pedestrian and Bicycle Bridge    March 2018        1
#1 Community Update - Sunshine Coast Council
Separated Bikeway Project                            About the pedestrian and
Stages                                               bicycle bridge and park
For planning, construction and funding               upgrade works
purposes, the Separated Bikeway project has
been divided into multiple stages.                   Bridge design
      Stage 1: Tuckers Creek Bridge Upgrade.
       Completed 2012.                               The architecturally designed, three-span
      Stage 2: Brisbane Road between Nicklin        bridge will be for pedestrian and cyclist use
       Way and Neerim Drive. On hold pending         only.
       Department of Transport and Main Roads
       review.                                       It will span Mayes Canal (between River
      Stage 3: Brisbane Road between Neerim         Esplanade and Bindaree Crescent), to the
       Drive and Culbara Street. Completed           east of the Brisbane Road vehicle bridge.
       2015.
      Stage 4a: Bindaree Crescent. Completed
       2015.                                         The bridge will feature decorative panel
      Stage 4b: River Esplanade. Completed          elements and be five metres wide and 66
       2016.                                         metres long. It will be a similar level to the
      Stage 5: Mayes Canal Pedestrian and           adjacent Brisbane Road vehicle bridge.
      Bicycle bridge. To be constructed 2018.
                                                     Please see the last page of this newsletter to
                                                     view the artist’s impressions of the bridge
                                                     design.
                                                     Bridge lighting
                                                     The bridge deck will feature environmentally
                                                     friendly, low-spillage lighting from two
                                                     overhead light poles.

                                                     The bridge handrails and decorative panels
                                                     will feature subtle lighting designed to add
                                                     visual interest and highlight the bridge’s
                                                     architectural features.

                                                     All lighting has been designed to ensure
                                                     safety and visibility for bridge users while
                                                     minimising visual impact on surrounding
                                                     residents, fauna and marine life.
                                                     Park upgrades
                                                     Landscaping upgrades will be undertaken in
                                                     the adjacent River Esplanade and Bindaree
                                                     Crescent parks.

                                                     Approaches to the bridge will include new
                                                     concrete pathways, new park furniture
                                                     (including shaded seating areas), and new
                                                     planting to garden areas.
   Project stages - Mooloolaba to Minyama
   Separated Bikeway

                                       Mayes Canal Pedestrian and Bicycle Bridge      March 2018      2
#1 Community Update - Sunshine Coast Council
Trees and plants                                     and storage of construction materials and
                                                     equipment.
Council has taken care to choose a location
for the bridge and bridge approaches which           Bridge construction will commence with the
minimises the need for tree loss as part of          extension of the rock revetment wall and
construction.                                        installation of bridge piles in the canal.

While some trees must be removed, 18 new             This will be followed by the installation of
trees and approximately 2,000 shrubs and             bridge piles at each approach (in the adjacent
groundcovers will be planted as part of the          parkland).
project to complement the new bridge and
upgraded park areas.                                 Once all bridge piles are installed,
                                                     construction will begin on the bridge piers and
Revetment wall                                       bridge deck.
The rock revetment wall along the North side
of Mayes Canal will be extended past the             Park landscaping works will then be
bridge to help ensure the long-term                  completed.
sustainability of Mayes Canal and to protect
against erosion.                                     Construction timeline
The revetment wall extension works form part         Construction will take place from April 2018 to
of council’s Coast and Canals program,               December 2018 (weather and site conditions
designed to protect waterways and adjacent           permitting).
parklands from erosion. It will also help to             April – July 2018. Set up of temporary
provide protection for the bridge supports.                  construction office, revetment wall
                                                             extension and installation of bridge
Environmental considerations                                 piles.
Being mindful of Mayes Canal’s location and              July – August 2018. Bridge piers and
environmental sensitivities including parkland               bridge deck installed.
and marine areas, all construction will be               August – September 2018. Bridge
performed under the relevant environmental                   balustrading and lighting installed.
conditions and under the control of an                   August – November 2018. Pathway
Environmental Management Plan.                               and bridge approach works including
                                                             landscaping.
Any parkland impacted by construction will be
reinstated after the project is complete.
                                                     What to expect during construction
Bridge construction                                  Council will make every effort to minimise
To minimise inconvenience to residents and           impacts to the local community during
visitors, standard construction hours will be        construction. Access will remain to nearby
Monday to Friday 6:30am – 6pm.                       homes and buildings.

On occasion, some out of hours work may be           Throughout the construction period there will
required. Nearby residents will be notified in       be:
advance.                                                  changed traffic conditions – reduced
                                                           speed limits, temporary lane closures,
A temporary construction office will be located            traffic and pedestrian realignments
in Bindaree Crescent. The onsite location will            some changes to on-street parking
help to minimise construction vehicle                     increased heavy vehicle movements
movements and act as a base for the delivery              construction noise

                                       Mayes Canal Pedestrian and Bicycle Bridge    March 2018       3
#1 Community Update - Sunshine Coast Council
The project team will continue to liaise with         Keeping you informed
directly affected residents and businesses to
inform them of specific construction activities,      Further information
timeframes and potential impacts.
                                                      For further information about the Mayes Canal
                                                      Pedestrian and Bicycle Bridge please visit the
                                                      website at www.sunshinecoast.qld.gov.au
 A message from your local councillor                 or contact the project team on:
 This new pedestrian and bicycle bridge
                                                      T: 5475 7272 or 1300 007 272 (excludes
 represents another important link in our
                                                      mobiles and callers outside Sunshine Coast
 existing cycle and pathway network and will
                                                      area)
 be a landmark entry statement to the
 Mooloolaba area.
                                                      E: mooloolababikeway@sunshinecoast.qld.gov.au
 The bridge provides a new level of safety
 and convenience for residents and visitors           To receive project updates via email
 by removing pedestrians and recreational             Please register your details with the project
 and commuter cyclists from the traffic               team.
 bridge on Brisbane Road.
                                                      Please email your name, address and email
 The Mooloolaba to Minyama Separated                  address to:
 Bikeway project is something our region can          mooloolababikeway@sunshinecoast.qld.gov.au
 be proud of as we all work to encourage
 more active transport and a healthier and
 happier community.

 I thank residents for your patience and
 understanding during construction.

 Cr John Connolly - Division 4

                                        Mayes Canal Pedestrian and Bicycle Bridge     March 2018      4
#1 Community Update - Sunshine Coast Council

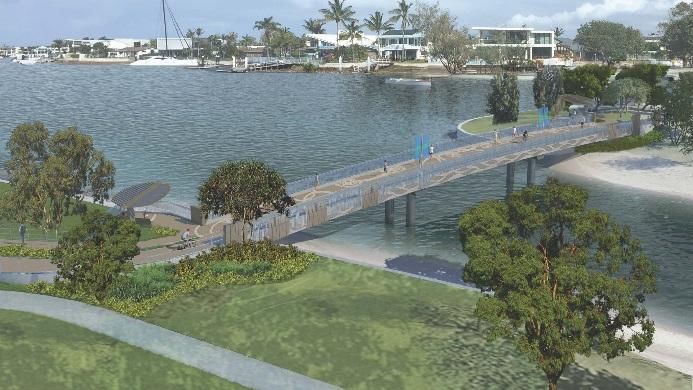

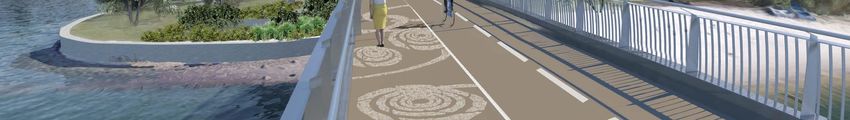

Artist impressions of new pedestrian and bicycle bridge

                                              Mayes Canal Pedestrian and Bicycle Bridge   March 2018   5
