Taipower's Practices for Offshore Wind Power - 2020 GLOBAL OFFSHORE WIND SUMMIT TAIWAN - Global Wind Energy ...
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
2020 GLOBAL OFFSHORE WIND SUMMIT TAIWAN Taipower's Practices for Offshore Wind Power Speaker : Lee, Wen-bing Deputy Director Department of Renewable Energy, TPC 2020.10.13 1
➢ To produce more Green Energy ourselves • Taiwan government carry out the Energy Transition of NULC, i.e. No Nuclear and Low Carbon. To fulfill the policy, Taipower has been taking several measures to enhance the utilization of green energy. Although currently Taipower is the the largest producer of green energy in Taiwan, • We cannot keep the championship in the future without developing offshore power. Now we have 2 projects in construction. 3

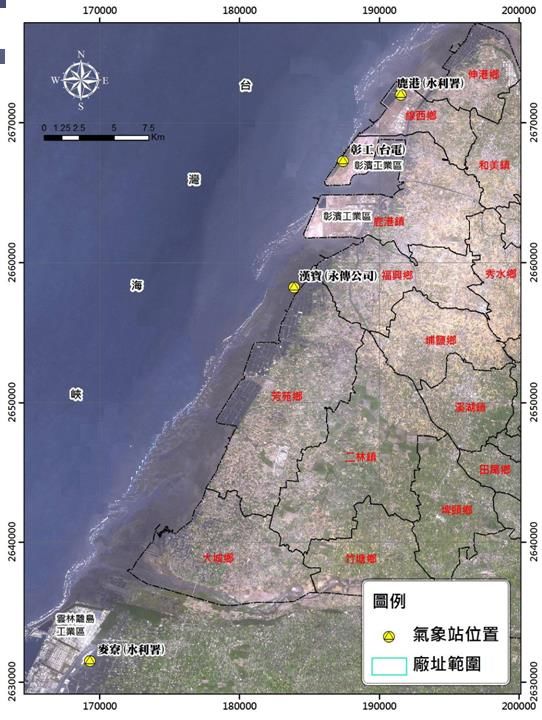

Phase I Project phase Ⅱ project 鹿港測站 彰工電廠測站 Project site 漢寶測站 Met. Mast Unit Output 9.5MW Number of Unit 31 Unit Output 5.2MW Capacity(MW) 295 Number of Unit 21 Completion Date 12/2025 Capacity(MW) 109 Completion Date 12/2021 Water Depth(m) 37~49 麥寮測站 Water Depth(m) 15~26 TAIWAN POWER COMPANY 5

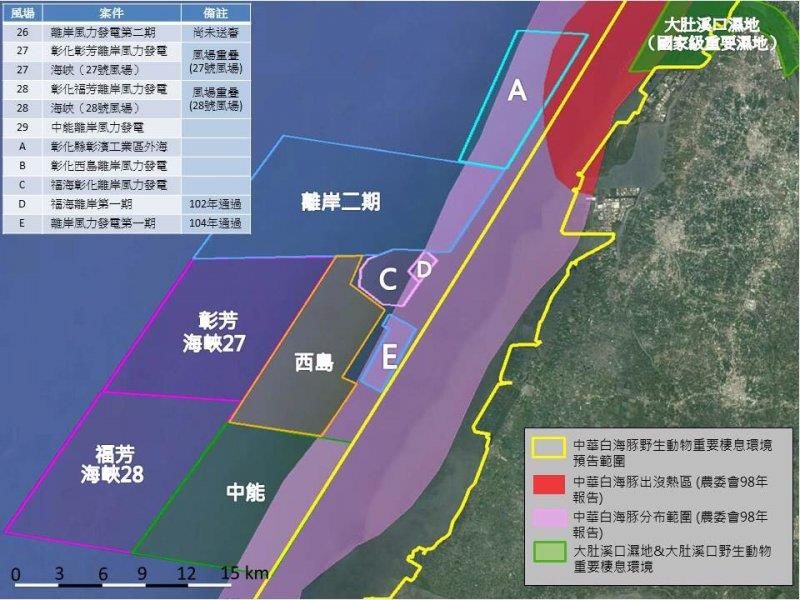

⚫ The 10-minute average wind speed of 50year return periods estimated as 57m/s, and 3-sec gust as 77m/s. ⚫ Weak bearing capacity of soil seabed without rock. ⚫ Local installation vessels are lack. ⚫ Steel is tent to rust due to high temp. & humidity. ⚫ Local supply chain capability isn’t enough. ⚫ There is no certificated port or wharf for offshore wind farm construction. ⚫ Local marine technicians are lack. ⚫ Migrating birds & ocean mammals guarded by NGO. ⚫ The negotiation between developer and fishermen group is not proceeding smoothly. 6
Challenge 1: ET-proof wind turbine to be manufactured ⚫ Considering the severe environment with typhoons and earthquakes in Taiwan strait, design level in compliance with IEC Class I at least and Class T recommended. ⚫ Although several models of offshore wind turbines available, but ET-proof wind turbine can be manufactured locally in time? 7

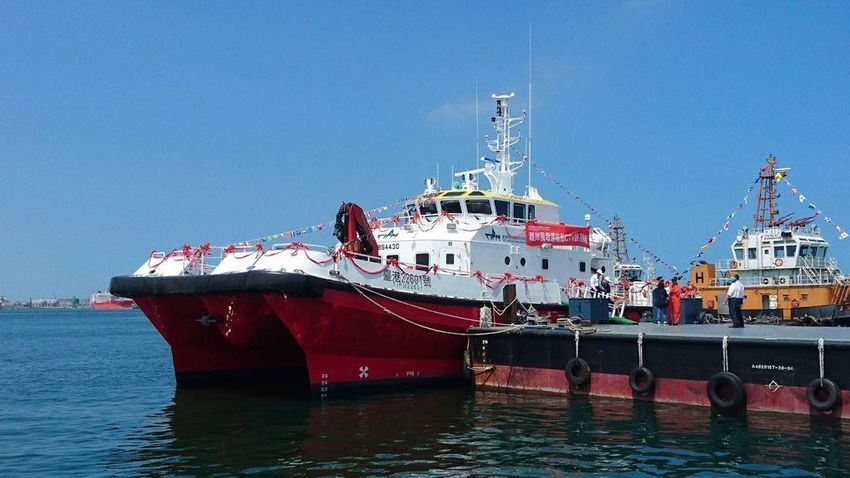

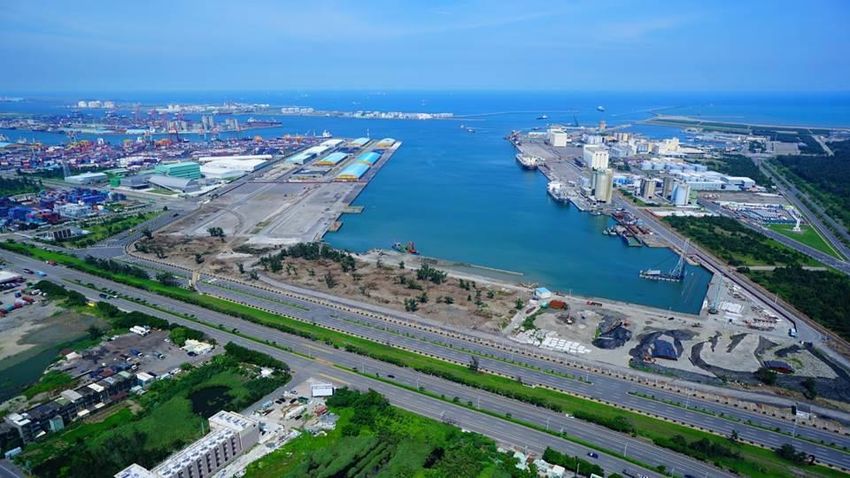

⚫ Wind turbine wharf: Taichung harbor #5A and #5B wharfs will be ready by 2020. And will be more available if needed. ⚫ Substructure wharf : Hsinta harbor far-ocean wharf will be ready by the end of 2019. 遠洋泊區碼頭 5
◼ Construction Wharf and backside in Taichung Harbor ---- Taipower rents for 20 years and share with other developers Taichung Harbor 5A Backside 5B total 12.8 ha. 4C 9 9
⚫ Local installation vessels, supply chain capability, and marine technicians are all insufficient. 10
Localization Schedule issued by IDB Industry Correlation Program showing Items should be locally-made each year Time 2021~2022 2023 2024 2025 ➢Tower ➢ Spare Parts of WT ➢ Spare Parts of ➢Marine substructure : WT: ➢Power facility: Nacelle assembly, Gear box, 1.Transformer transformer, panel, generator, UPS, nose cone, power transition 2.Switch. cable, hub casting, system, blade & 3.Panel fastener its resin, nacelle ➢ ➢Maritime engineering ➢ Submarine cable All the cover, nacelle 1. Investigation, items ➢ Maritime base casting from exploration, cable engineering ➢ Maritime Item 2021~ laying, audition 1. Construction, engineering 2024 2. Construction vessel : installation, cable includ New build or rebuild laying, audition ed 2. Construction vessel : New build or rebuild ➢ All the items ➢ 2021~2022 items from 2021~2023 included included
◼ Local Supply Chain is Developing Some active local partners shown as below : Offshor e Wind Turbine System Comp Controler/Transfo onent Tower Generator Blade Gear Box rmer/switchboard Yaw Formosa Local CSMC TECO Shihlin Electric CENTURY Tatung Atech Heavy Fortune Electric TECO Firm Industry Periphera l system Compo Foundation transmission Marine Engineering Vessel nent Local CSMC WOENJINN CSBC Firm CENTURY TAYA HUNG HUA HWA CHI WOENJINN 12
CSBC ‘S TIV M-Team (rent first) Plan ⚫ To set up a Wind power Vessel company to acquire TIV x1 and Bargex2 ⚫ Cooperate with other vessels to form a fleet O&M ship 140m Barge (building)
Third Party Certification’s division of labor in Taiwan BSMI counsel the following Corporations to sign MoU with K2 Management, DEWI–OCC, DNV GL, TÜ V SÜ D Accreditation Finance & Insurance 全國認證基金會(TAF) 台經院(TIER) (DD) (PC) Communication 金工中心(MIRDC) 電檢中心(ETC) Power quality 大電力中心(TERTEC) (MWS) 驗船中心(CR)
➢ To Strengthen the Grid and Friendly for Connection • As being the unique operator of power grid in Taiwan, Taipower is also obliged to make the grid-connection friendly. However, the challenge ahead is much more tough than ever to face the renewable energy rush-in situation. The government’s RE target is as following : ⚫ By 2025 : 27GW (PV 20GW, Wind 6.7GW and others) ⚫ By 2035 : 37GW (Offshore wind power increase 1GW every year to reach 10GW of accumulation. Taipower has to upgrade the present grid of 5GW scale of green power to that large scale still with good quality in 5 and 15 years. The smart grid plan is now in progress to fulfill this mission. 15
2nd stage (Selection and Auction) Winners of selection Winners of auction Total 5.5GW to be constructed by 2025 14 15 26 27 大彰化西北#12 19 29 582.9MW 大彰化西南#14 337.1MW 海龍三號#18 512MW 海龍二號#19 232MW
OWFs Grid Connection Review 麗威風力 372MW 桃園塘尾D/S,併網無困難 台海風力 492MW 桃園塘尾D/S,待加強電 麗威風力 300MW 力網完成 桃園榮成D/S ,待加 強電力網完成 福海風力 232MW 彰化漢寶D/S, 系統事故時須配合降載 竹風風力 450MW 新竹朝山D/S,併網無困難 台電公司 108MW 彰化大城D/S,併網無困難 海洋風力 128MW 苗栗營盤D/S,併網無困難 允能風力 360MW 雲林台西D/S, Conclusion : 系統事故時須配合降載 mostly no 允能風力 360MW 雲林四湖D/S,併網無困難 problem, but some need grid enhancement. 17
Grid Connection in Changhua area Note: more the NT$50 billion budget 2021.12 2022.12 2023.12 2024.12 2025.12 capacity 彰一甲 彰一乙 彰一乙 彰工2,000 0 (MW) 1,000 500 1,000 永興2,000 Accumulated 1,000 1,000 1,500 2,500 6,500 (MW) government also urges Taipower to enhance the Changhua grid and provide more connecting capacity for OWP. 18
➢ Smart Dispatch Facing with Renewable Energy ➢ The intermittent characteristic of Renewable Energy is the biggest challenge to system operation in period of high penetration. ➢ If the Renewable Energy generation suddenly drops, the system frequency may drop consequently to trigger UFLS relays and affect the reliability of power supply. 19
The Change Rate of Wind Power Generation in 2019 20
Smart Dispatch : Measures of System Operation Prepare all kinds of ancillary services Regulation Reserve Responsive Regulation Spinning Supplemental type Reserve Reserve Reserve Reserve Response ~ 10 min ~ 30 min time ms~seconds seconds~3 min (30 min for now) (60 min for now) Spinning Supplemental Duration 3-15 min↑ 15 min↑ 1 hr↑ 2-4 hr↑ Reserve Reserve Demand in 2025 1000~1200MW ±1300MW 1000MW 1000MW Responsive Reserve Energy Storage System (590MW) Energy Storage System Demand Response Demand Response (with UF-Relay) (with ESS) Demand Response Source Generator Generator (Primary Frequency (Automatic Generator Generator Generation Response) Control) 21
Seek for cooperation from Major Private Developers Technical Requirements for Offshore Wind New Players I. Improve RE generation forecast II. Improve the ability of voltage support III. Improve the ability of frequency support IV. Capabilities of Voltage/Frequency Ride Through V. Regulations for the ramp rate needs to be enacted However, the above-mentioned requirements will be discussed to reach a common acceptance through the reviewing of Grid Code before execution. 22
⚫ Taipower being the unique public power buyer and seller in Taiwan, to meet the green energy demand of customers is also our upmost goal of business. ⚫ Should Orsted want to sell the energy of her Changhua OWF to TSMC, Taipower will provide the wheeling service. ⚫ However, don’t forget Taipower is the largest green energy provider, our green energy is abundant, price-justified with good quality and lots of diversity. Please contact our Business Department for further information. 23
➢ Conclusion and Suggestion • Taiwan strait is appraised to possess the richest offshore wind resources in the world, but also the most severe environment with lots of difficulties. • Taipower has taken three practices for more green energy and still keep the system safe, i.e. produce own green energy in spite of low rate of return, strengthen the grid and make the connection more friendly, and finally perform a smart dispatch. • Working cooperatively with all the developers and stakeholders, Taipower is confident to cope with the 10GW more capacity of OWP by 2035, and we welcome all the partners from all over the world, coming to Taiwan to accomplish our common dream of OWP in Asia. 24
✓ Danish Horns Rev I OWF 80@2MW since 2003 ✓ Changhua OWF 4GW by 2025 25
