Nepal: Rural Connectivity Improvement Project - Asian Development ...

Page created by Patrick Sanders

CONTINUE READING
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Environmental Monitoring Report

Semi Annual Report No. 2
April 2019

Project Number: 48218-003
Loan Number: 3620- NEP

Nepal: Rural Connectivity Improvement Project

Prepared by the Rural Connectivity Improvement Project, the Government of Nepal for Asian
Development Bank.

This environmental monitoring report is a document of the borrower. The views expressed
herein do not necessarily represent those of ADB's Board of Directors, Management, or staff,
and may be preliminary in nature. In preparing any country program or strategy, financing any
project, or by making any designation of or reference to a particular territory or geographic
area in this document, the Asian Development Bank does not intend to make any judgments
as to the legal or other status of any territory or area.
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                Oct. 2018 - Mar. 2019

                                     Abbreviations
ADB          –    Asian Development Bank
AP           –    Affected People
CSC          –    Construction Supervision Consultant
DFO          –    District Forest Office/Division Forest Office
DOF          –    Department of Forest
DOLI         –    Department of Local Infrastructure
DoLIDAR      –    Department of Local Infrastructure Development and Agricultural Roads
EA           –    Executing Agency
EMP          –    Environmental Management Plan
EMoP         –    Environmental Monitoring Plan
ES           –    Environment Specialist
ESMP         –    Environmental and Social Management Plan
GESI         –    Gender Equality and Social Inclusion
GoN          –    Government of Nepal
GRM          –    Grievance Redress Mechanism
Ha           –    Hectare
IA           –    Implementing Agency
IEE          –    Initial Environmental Examination
IUCN         –    International Union for Conservation of Nature
km           –    Kilometer
kV           –    Kilovolt
m            –    Meter
masl         –    Meter above Sea Level
MOFE         –    Ministry of Forest and Environment
MoFAGA       –    Ministry of Federal Affair and General Administration
MOFALD       –    Ministry of Federal Affair and Local Development
NCB          –    National Competitive Bidding
NEA          –    Nepal Electricity Authority
NRS          –    Nepal Road Standard
PCU          –    Project Coordination Unit
PIU          –    Project Implementation Unit
RCC          –    Reinforced Cement Concrete
RCIP         –    Rural Connectivity Improvement Project

  Rural Connectivity Improvement Project                                         i
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                                                   Oct. 2018 - Mar. 2019

                                                  TABLE OF CONTENTS

1.      INTRODUCTION ........................................................................................................... 1
     1.1      Brief Project Description.......................................................................................... 1
     1.2      Contract Status ....................................................................................................... 5
2       COMPLIANCE TO NATIONAL REGULATIONS AND ADB's POLICY ........................... 5
     2.1      Environmental Protection Rules 1997 ..................................................................... 5
     2.2      ADB's Safeguard Policy Statement (2009) .............................................................. 5
3       INSTITUTIONAL ARRANGEMENT FOR SAFEGUARDS IMPLEMENTATION.............. 5
4       COMPLIANCE TO ENVIRONMENTAL COVENANTS ................................................... 6
5       COMPLIANCE TO ENVIRONMENTAL MANAGEMENT PLAN ..................................... 7
     5.1      Permits and Clearance for Major Construction Work ............................................... 7
6.      SAFEGUARD MONITORING RESULTS ....................................................................... 8
     6.1 Construction Activities ................................................................................................. 8
        6.1.1 Construction Compliance and Monitoring .............................................................. 8
        6.1.2       Compliance Monitoring .................................................................................... 9
7. IMPLEMENTATION OF GRIEVANCE REDRESS MECHANISM AND COMPLAINTS
RECEIVED FROM STAKEHOLDERS ................................................................................ 11
     7.1 Establishment of GRM ............................................................................................... 11
8. OTHERS ACTIVITIES ..................................................................................................... 12
9. CONCLUSION ................................................................................................................ 12

                                                      LIST OF FIGURE
Figure 1: Location Map of RCIP Districts, Roads and Potential Agriculture Production ......... 2

                                                      LIST OF TABLES
Table 1: List of Roads ........................................................................................................... 3
Table 2: Compliance Status with Environmental Loan Covenants ......................................... 6
Table 3: Status of Progress on Tree Clearance Permits........................................................ 8
Table 4: List of Roads with Updated IEEs/EMPs ................................................................... 8
Table 5: WHO Ambient Air Quality Guidelines ...................................................................... 9

                                                         APPENDICES
Appendix I:           District/ Package Wise Contract Details with Physical Progress
Appendix II:          Updated Environmental Management Plan
Appendix III:         Environmental Monitoring Plan
Appendix IV:          Environmental Status
Appendix V:           Status on Camps, Quarry and Services Reinstatement
Appendix VI:          Contract Progress Status of EMP/EMoP
Appendix VII:  Air and Water Quality Monitoring Locations, Instruments and Test Reports
Appendix VIII: Photographs of Progress Activities
Appendix IX: Existing Road Condition and Land Use

 Rural Connectivity Improvement Project                                                                                    ii
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                         Oct. 2018 - Mar. 2019

   1. INTRODUCTION
1.       The Rural Connectivity Improvement Project (RCIP) will construct about 380.6
kilometers of rural roads to all-weather standard covering 16 priority rural development
districts in the country. The project will also focus on improving institutional arrangements,
business processes, and associated capacity building, particularly on road asset management
and road safety. The Project aims to improve transport efficiency of the rural road network,
which will contribute to expansion of economic opportunities and poverty reduction. This will
be realized by: (i) improving the district road network, (ii) facilitating safe and appropriate road
usage, (iii) increasing efficiency of transport services, and (iv) enhancing the Department of
Local Infrastructure Development and Agricultural Roads (DOLIDAR) now Department of
Local Infrastructure (DoLI)’s capacity for road asset development and management. Project
immediate outcomes will be improved accessibility to social services and markets, increased
fuel efficiency, reduced travel time, accidents, vehicle emissions and better employment
opportunities outside agriculture, both through improved access to economic centers and
increased industrial activities in the project districts. The Project is funded by Asian
Development Bank (ADB).

       1.1     Brief Project Description
2.      Under the project there are 27 road subprojects. The total length of the road is 380.686
km and these roads are located in 16 districts. Jhapa, Ilam, Panchthar, Morang, Sunsari,
Dhankuta (Eastern Cluster 13 Roads); Dolakha, Kavre, Sindhuli, Sindhupalchowk,
Kathmandu, Bhaktapur (Central/ East Cluster: 7 Roads), Chitawan (Central/ West Clusters: 1
Road); Parbat (Central/ West Cluster: 2 Roads); Rukum (West Cluster: 2 Roads) and Rolpa
(West Cluster: 2 Roads).These roads are in 11 packages (or 11 NCB contracts). The civil
work contracts are already awarded to contractors by PCU in various dates in year 2018
except for package (NCB-6) for which the bid evaluation process is underway, and the work
is expected to be awarded by May 2019. The construction period of each of the contracts is
2 years with additional 3 years of maintenance that includes 1-year Defect Liability Period
(DLP) of the constructed road and 2 years for Performance Based Maintenance (PBM). The
Project started in April 2018.
3.      The RCIP is financed by the Asian Development Bank. Ministry of Federal Affair and
General Administration (MoFAGA) through DoLI is responsible for implementation of this
Project. DoLI is the executing agency and the Project Coordination Unit (PCU) headed by
Project Coordinator under DoLI is the central office for overall project management, contract
administration and implementation through its regional PIUs headed by the Project Managers
(PMs) established at Jhapa (PIU1), Lalitpur (PIU2), Parbat (PIU3), Rolpa (PIU4) and Rukum
(PIU5).
4.      RCIP, PCU has appointed Yooshin Engineering Corporation, Korea in association with
Environment & Resource Management Consultant (P) Ltd, Nepal & BDA, Nepal (P) Ltd, Nepal
as a Construction Supervision Consultant (CSC) for all contract packages. The target of the
Project is to improve the existing gravel/earthen rural road to asphalt paved road with gravel
shoulder on either side. The Project work mainly comprises of 30 mm of Asphalt pavement,
150 mm of crushed stone base course, 200 mm of granular sub-base course and 350 mm
gravel on either side of shoulder. The construction work also includes cross drainage, side

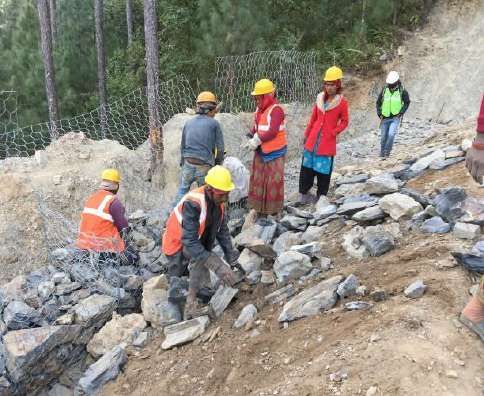

drain, masonry and gabion structure, bioengineering, traffic safety works and maintenance
work on PBM.

 Rural Connectivity Improvement Project                                                    1
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                                                             Oct. 2018 - Mar. 2019

                         Figure 1: Location Map of RCIP Districts, Roads and Potential Agriculture Production

     Source: CSC Monthly Progress Report, February 2019

 Rural Connectivity Improvement Project                                                                                 2
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                      Oct. 2018 - Mar. 2019

                                        Table 1: List of Roads
  A. Eastern Cluster (Province 1)
 Package &
                                                              Length of Road
Civil Contract                  Road Section                                          District
                                                               Section (km)
  (NCB) No.
    Under      Amaldagi - Samayaghad -Babwari - Solmari road      11.509
    PIU1:      Charpane - Chaitubari-Matigada-Sadhukuti -
                                                                  15.484
Package No. 1 Khodamara-Rajgadh
  (NCB - 01)   Kharsangwari - Jalthal -Mangalware - Baundoka                          Jhapa
                                                                  6.519
               -Adhikari Chowk Sadak
               Padajungi (Lakhanpur) -Guhawari-Laladhbandra
                                                                  10.003
               - Jharka-Baluwathan Chapramari -Khajurgachhi
                                           Total Length (Km)      43.515
    Under      Nepaltar-Shantidada - Gagrebhangyang -
    PIU1:      MangalbareDhuseni - Gajrmukhi - Ebhang -
Package No. 2 ChaturmoadAadipur - Larmwa-GhartiDobhan -           13.279               Ilam
  (NCB - 05)   Chapeti - BeldagiDamak Road (Ebhang -Chature
               road Sector)
                Mangalbare          -         Phungfung       -
                EktappaSikariBhanjyang - Phakphok - Ra.Ma.Bi.
                KhambangChowk - Thingepur - Aamchok -             9.510
                Jungetar - Phuyatappa - Rabi road
                (Surubindukhanda)
                                              Total Length (Km)   22.789
    Under       Phidim - Nagin - Sidin -Prangbung - Falot Road                       Panchthar
                                                                  24.46
    PIU1:       (Phidim -Ludintar Road)
Package No. 3   Samdin - Chokmangu - Nawamidada -
  (NCB - 02)    FaktepGhurbisepanchami Road (Samdin -             14.847
                Nawamidada Sector)
                                              Total Length (Km)   39.307
 Under PIU1:    Khorshane - Kerawari -Singhadevi Road (23 km
Package No. 4   left to be upgraded out of 38 km)                 13.615
  (NCB - 06)                                                                          Morang
                Laxmimarga - Dangihat - Banaul- Babiyabirta -
                Amahi Road (29 km left to be upgraded out of 31   28.135
                km)
                Total Length (Km)                                 41.75
 Under PIU1:    Jhumka - Shinghiya - Ramdhuni - Prakashpur -
Package No. 5   Madhuwan - Shukrabare - Paschimkushaha -          17.35
                                                                                      Sunsari
  (NCB - 03)    Laukahi - Boarder Road
                Inaruwa - Satterjhoda - Chhitaha - Purbakushaha
                                                                  12.787
                - Biratnagar Road
                Mudheshanischare - Dadagaun - Chanuwa Road
                                                                  10.342             Dhankuta
                                            Total Length (Km)     40.479

   Rural Connectivity Improvement Project                                                3
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                              Oct. 2018 - Mar. 2019

 B. Central/ East Cluster (Province 3)
                                                                    Length of Road
 Package No.                     Road Section                                                District
                                                                     Section (km)
 Under PIU2:     Nayapul – Pawati – Dadakharka Road
Package No. 6                                                           12.083               Dolakha
 (NCB – 07)      Barhabise – Maneswara – Ghumthang – Listi –
                                                                        12.377           Sindhupalchowk
                 Bhairabkunda
                 Dolalghat – Phalate – KolatiDhadkharka-
                                                                        18.629                Kavre
                 Pokharichauri - Gurase Road
                                               Total Length (Km)        43.089
 Under PIU2:     Tallo - Ranibas - Harshadi - Tadi - Dhanshari
Package No. 7                                                           12.776
  (NCB - 08)                                                                                 Sindhuli
                 Dhudhuli - Lakhima - RatmataKartha - Thakur
                                                                        13.011
                 Damar - Arunathakur
                 Badbhanjyang - Sanomasino - Thulomasino -
                                                                        6.403              Kathmandu
                 Satghumti Road
                 From Bansbari–Bageswori Purano Health Post
                                                                        4.461               Bhaktapur
                 to Municipality Building
                                          Total Length (Km)             36.651

 C. Central /West Cluster (Province 3 & 4)
                                                                    Length of Road
 Package No.                     Road Section                                                District
                                                                     Section (km)
 Under PIU2:     Phisling - Tolang - Baspur - Oralang - Mayatar -       37.566              Chitwan
Package No. 8    Tarse - Upradanggadi - Shaktikhor bazar Road
  (NCB - 09)
                 Total Length (Km)                                      37.566
                 Lunkhu - Mudikuwa Road
 Under PIU3:                                                            13.003
Package No. 9                                                                                Parbat
                 Armadi - Banau Road
  (NCB - 10)                                                            12.801
                                             Total Length (Km)          25.804

 D. Western Cluster (Province 5)
                                                                     Length of Road
 Package No.                      Road Section                                               District
                                                                      Section (km)
 Under PIU4:     Mijhing -Ruinibang -Badachaur - Ghumchaal -
                 Harjang-Syuri-Gaam Road                                 13.697
Package No. 10
  (NCB - 04)     Mijhing - Dhulewodaar - Namjaa - Sirp - Pang                                 Rolpa
                 Road                                                    5.966
                                              Total Length (Km)          19.693
 Under PIU5:     SitalPokhari - Jhulkhet-Chunwang Road
Package No. 11                                                           18.417
  (NCB -011)     Solawang - Raule - BaluwaNaigadpul -                                         Rukum
                 Jamaabagar - Simalchaur - Hukaam -
                                                                         11.626
                 Ranmamaikot Road's (Naigadpul - Jamabagar
                 Sector)
                                          Total Length (Km)              30.043

  Rural Connectivity Improvement Project                                                        4
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                   Oct. 2018 - Mar. 2019

       1.2    Contract Status
5.      The agreements of the contract packages were made in three phases. In first phase,
agreement of Contracts NCB-01, NCB-02, NCB-03 and NCB-04 and in second phase, NCB-
7, NCB-10 and NCB-11 was made. Similarly, in third phase the agreement of contracts no
NCB-05, NCB-08 and NCB-9 were done. The contract NCB-06 was retendered and the
evaluation of bid is underway. The contractors of first and second phase contracts have
started construction work. The construction survey and design-drawing work is underway for
third phase contracts. The overall average physical progress on awarded contract is around
9 percentages. The details of contract status with date of agreement, commencement amount,
physical progress and intended date of completion are provided in Appendix I.

2   COMPLIANCE TO NATIONAL REGULATIONS AND ADB's POLICY

       2.1    Environmental Protection Rules 1997
6.     An Initial Environmental Examination (IEE) Study is required for the proposed roads
as per Environmental Protection Act and Rules 1997 of Nepal. IEEs of all 27 roads sub-project
were approved by the Concerned Agency of Government of Nepal.

       2.2    ADB's Safeguard Policy Statement (2009)
7.      According the ADB Safeguard Policy Statement, the project is classified as 'Category
B' with respect to environment.

3   INSTITUTIONAL ARRANGEMENT FOR SAFEGUARDS IMPLEMENTATION
8       DOLIDAR (now DoLI) is the Executing Agency (EA) and Project Coordination
Units (PCUs) are the Implementing Agencies of the Project.
9       The implementation arrangements for environment safeguards and responsibilities of
various agencies and parties for implementing environment safeguards are provided below:
10      Project Coordination Unit: The PCU is the project management unit and responsible
for the overall compliance with ADB’s SPS and the applicable laws and rules under concerned
Ministry. The PCU have an environmental consultant (PCU-ES) to coordinate with the PIUs
and ensure project implementation complies with the PAM and EMP.
11    Project Implementation Unit (PIU): The PIUs through the Executing Engineer is
responsible for supervising implementation of the EMP and Environmental Monitoring Plan
(EMoP) by the Contractor.
12      Construction Supervision Consultant, Environment Specialist (CSC-ES): The main
responsibility of the CSC-ES is to support the PCU and PIU and ensure that the construction
works are in accordance with the environmental management plan and other environment-
related stipulations of the construction contract documents.
13      Contractor: The Contractor is the principal agent to implement the EMP and EMoP
during the pre-construction and construction stages.
14      The PCU is the key institution for the successful implementation of the project and
ensure compliance to ADB safeguards as contemplated in the environmental management
and monitoring plans. The PCU provides both technical advisory and independent audit roles
to the Project to ensure the project stays in compliance. The CSC Environmental Specialist
and the PCU Environmental Consultant monitor environmental management plans (EMP)
implemented by the contractors.

 Rural Connectivity Improvement Project                                              5
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                               Oct. 2018 - Mar. 2019

15     Currently, RCIP/PIU have Sociologist and one Individual Safeguard Consultant each
for Social and Environment, CSC has Environmental Specialists and Social Specialists.

4   COMPLIANCE TO ENVIRONMENTAL COVENANTS
16.     There are loan covenants specified for this project. Environmental safeguard related
project activities are in compliance with covenants as regular follow up actions are being taken.
The following covenants (Table 2) to the financing agreement with ADB are to be complied
during implementation of the project.

             Table 2: Compliance Status with Environmental Loan Covenants

Covenant
                                    Covenant                                    Status of Compliance
Reference
                                                                          Complied:
             The Borrower shall not award any works contracts             a) IEE of all 27 roads are
Schedule-    until MOFALD has:                                            approved by concerned ministry;
   4                                                                      and
             (a) approved the IEE, and
 Para-7                                                                   b) Relevant provisions from EMP
             (b) Incorporated the relevant provisions from the
             EMP into the Works contract.                                 are incorporated in Works
                                                                          contract documents.
             Environment
             The Borrower shall ensure, or cause DOLIDAR to
             ensure, that the preparation, design, construction,
             implementation, operation and decommissioning of
             the Project and all project facilities comply with (a) all
Schedule-5
             applicable laws and regulations of the Borrower              Complied. Being complied with.
  Para-6
             relating to environment, health and safety; (b) the
             Environmental Safeguards; and (c) all measures and
             requirements set forth in the IEE, the EMP, and any
             corrective or preventative actions set forth in a
             Safeguards Monitoring Report.

             Human and Financial Resources to Implement
             Safeguard Requirement
Schedule-5
             The Borrower shall make available, or cause                  Complied.
 Para-10
             DoLIDAR to make available, necessary budgetary
             and human resources to fully implement the EMP

             Safeguards-Related Provisions in Bidding
             Documents and Works Contracts
             The Borrower shall ensure or cause DoLIDAR to
             ensure that all bidding documents and contracts for
             Works contain provisions that require contractors to:
             (a) Comply with the measures relevant to the                 (a) Provisions are part of the
             contactor set forth in the IEE, and the EMP, and any         contract documents and the
Schedule-5                                                                measures set forth in the IEE,
Para-11      corrective or preventative actions set forth in a
             Safeguards Monitoring Report;                                the EMP and Monitoring Report
                                                                          are being complied;
             (b) Make available a budget for all such
             environmental and social measures;                           (b) It is made available for
             (c) Provide the Borrower with a written notice of any        compliance of environmental
             unanticipated environmental, resettlement or                 social measures;
             indigenous peoples risks or impacts that arise during        (c) Not applicable at present ;
             construction, implementation or operation of the

 Rural Connectivity Improvement Project                                                           6
Nepal: Rural Connectivity Improvement Project - Asian Development ...
Semi-annual Environment Safeguard Monitoring Report                          Oct. 2018 - Mar. 2019

Covenant
                                   Covenant                                Status of Compliance
Reference
             Project that were not considered in the IEE, or the
             EMP;
             (d) adequately record the condition of roads,
                                                                     (d) Features are being recorded
             agricultural land and other infrastructure prior to
                                                                     as and when required; and
             starting to transport materials and construction; and
             (e) Reinstate pathways, other local infrastructure,     (e) Will be complied as the
             and agricultural land to at least their pre-project     construction work is on going
             condition upon the completion of construction.

             Safeguards Monitoring and Reporting
             The Borrower shall do the following or cause
             DoLIDAR to do the following:
             (a) Submit semi-annual Safeguards Monitoring            a) Semi- annual Safeguards
             Reports to ADB and disclose relevant information        Monitoring Reports to ADB is
             from such reports to affected persons promptly upon     being submitted on regular
             submission;                                             basis;

              (b) If any unanticipated environmental and/or social   b) All the considerations have
Schedule-5   risks and impacts arise during construction,            been made. If arise, it shall be
 Para-12     implementation or operation of the Project that were    worked out accordingly.
             not considered in the IEE, or the EMP, promptly
             inform ADB of the occurrence of such risks or
             impacts, with detailed description of the event and
             proposed corrective action plan; and
             (c) Report any actual or potential breach of            c) Not required at present
             compliance with the measures and requirements set
             forth in the EMP promptly after becoming aware of
             the breach.

5   COMPLIANCE TO ENVIRONMENTAL MANAGEMENT PLAN
17.     The baseline features of the road and the road surface are provided in Appendix IX.
For addressing the impacts and corresponding mitigation measures Environmental
Safeguards related activities are being undertaken. Updated environmental management plan
is presented in the Appendix-II.

    5.1 Permits and Clearance for Major Construction Work
18      Forest: RCIP has been following-up with the concerned government agencies to
provide clearance before starting major construction work. Summary of progress of forest area
clearance for all 27 roads is given in (Table 3). Clearance is obtained for 1 road in Dolakha, 7
roads do not require tree felling. Verification report for approval of tree cutting and transfer of
forest land have progressed at different levels regarding approval; 3 reports are at MoFE, 12
at DoF, 4 in districts while from site verification it has been found that trees are not found
within 5m either side from road center for three roads. See Details in Appendix III & IV
19      Other Permits: permits are being taken from land owners and public land for disposal
of spoils, camp sites, and material storage sites, parking area, hotmix plants and other.

 Rural Connectivity Improvement Project                                                       7
Semi-annual Environment Safeguard Monitoring Report                            Oct. 2018 - Mar. 2019

                   Table 3: Status of Progress on Tree Clearance Permits
 Status               District, Road Name              Contract ID              Remarks

 Approved             1 road (Dolakha)                 NCB07
                      7 roads (Jhapa -3, Ilam-1,       NCB01-3, NCB05-1,
 Not required         Morang-1, Sunsari-1, and         NCB06-1, NCB03-1,
                      Bhaktapur-1)                     NCB08-1
 At MoFE              Chitwan-1, Rolpa-2               NCB09-1, NCB04-2

                      12 roads (Jhapa-1, Panchthar-    NCB01-1, NCB02-2,
                                                       NCB05-1, NCB07-1,
                      2, Ilam-1,Sindhupalchowk-1,                               •   Rukum-1-Send for
 At DoF                                                NCB09-1, NCB010-2,
                      Chitwan-1, Parbat -2, Rolpa-2,   NCB04-2, NCB011-1,           re-verification
                      Rukum-1, Morang-1)               NCB06-1

 No tree within       3 roads (Sunsari-1,              NCB03-1, NCB08-1,
                                                       NCB07-1                  •
 10m                  Kathmandu-1, Kavre-1)

                                                                                •   Rukum-verification
                                                                                    completed
 To be submitted      4 roads (Dhankuta-1, Sindhuli-   NCB03-1, NCB08-2,
                                                       NCB011-1                 •   Dhankuta, and
 to DoF               2, Rukum-1)
                                                                                    Sindhuli verification
                                                                                    yet to be done.

6.        SAFEGUARD MONITORING RESULTS

6.1 Construction Activities
20     IEEs for all 27 roads were approved at different dates by MoFE. Due to minor
discrepancies in write-ups, number of trees to be felled and area of forest land to be acquired,
IEE and EMP reports are updated for following 6 road sub-projects (Table 4);

                        Table 4: List of Roads with Updated IEEs/EMPs
     SN      District          NCB-No.      Name of Road
     1       Rolpa             NCB-04       Mijhing-Ruinibang-Syuri-Gaam Road
     2                         NCB-04       Mijhing- Dhulewodaar-Pang
     3       Parbat            NCB-10       Armadi-Banau
     4                         NCB-10       Lunkhu - Mudikuwa
     5       Jhapa             NCB-01       Charpane-Chaitubari-Sadhukuti-Khodamara-Rajgadh
     6       Chitwan           NCB-09       Phisling-Tolang-Shaktikhor bazar
21     Based on IEE and EMP of project, the environmental monitoring plan has been
developed. The detailed monitoring plan according to the EMP is given in Appendix-II. The
baseline and compliance monitoring progress noticed during the reporting period are:

6.1.1 Construction Compliance and Monitoring
22     Verification and Approval of Forest area and Tree Cutting: Out of 27 roads, 7
roads do not require tree clearance. Trees cutting of 1 road had been approved by the Ministry
of Forest and Environment. Verification of required number of trees cutting of 16 roads has
been completed by District Forest Office (DFO) and report submitted to Department of Forest
(DoF) and trees cutting for remaining 4 roads are to be verified and submitted to the DOF.
The detail is given in Table 3 above and Appendix IV.

 Rural Connectivity Improvement Project                                                        8
Semi-annual Environment Safeguard Monitoring Report                          Oct. 2018 - Mar. 2019

23      Air and Noise: Ambient air quality parameters measurements are required to be
recorded before, during and after construction work. Sampling locations are proposed at Major
Settlement/School/Health Center. The parameters like total suspended particles (TSP),
Particulate Matter (PM 10), Sulfur dioxide (SO2), Nitrogen Dioxide (NO2), Carbon monoxide
(CO) is being measured (Appendix V & VII). Results are analyzed by comparing with Nepal
standard and ADB SPS 2009 (Pollution Prevention and Abatement Para 33). The project
should comply with the more stringent standards between the country’s regulations and World
Bank Group’s Environment, Health and Safety Guidelines. The standard is given in Table 5.

                        Table 5: WHO Ambient Air Quality Guidelines
                                                                              WHO
                          Time Weighted                 Concentration
 Parameters Time                                                              Guidelines
                          Average                       max (μg/m3)
                                                                              (μg/m3)
                          Annual                        -                     -
 TSP
                          24 hours                      230                   120-230
                          Annual                        -                     -
 PM10
                          24 hours                      120                   70
                          Annual                        50                    -
 SOx
                          24 hours                      70                    125
                          Annual                        40
 NOx
                          24-hours                      80                    150
 CO                       8 -hours                      10,000                100000
Source: World Bank Group’s Environment, Health and Safety Guidelines Environmental, Health, and Safety
Guidelines (General EHS Guidelines: Environmental Air Emissions and Ambient Air Quality), 2007.

24     Water Quality: River water of the major river of the Project has been sampled for
baseline monitoring and analysis. The parameters like pH, Total Suspended Solids (TSS),
and Oil & Grease is being measured. Results is being analyzed by comparing with Nepal
standard and ADB SPS 2009 (Pollution Prevention and Abatement Para 33), the project
should comply to the more stringent standards between the country’s regulations and World
Bank Group’s Environment, Health and Safety Guidelines.
25     As per World Bank Group’s Environment, Health and Safety Guidelines Environmental,
Health, and Safety Guidelines indicative Values for Treated Sanitary Sewage Discharges: pH
6 – 9, BOD mg/l 30, COD mg/l 125, Total Nitrogen mg/l 10, Total Phosphorus mg/l 2, Oil and
Grease mg/l 10, Total Suspended Solids mg/l 50, Total Coliform Bacteria MPNb / 100 ml 400.

6.1.2   Compliance Monitoring
26        During the present reporting period, the construction works of awarded contract has
commenced. As reported any occurrences of construction-related injuries and fatalities, and
any complaint was not registered during reporting time. Safety measures like camp site
management, health and safety and issues of child labour are monitored at site. For the
compliance monitoring result, an environmental safeguard compliance matrix has been
developed and weightage for different indicators and parameters are assigned for the project
during pre-construction, construction and operation stage which is given in Appendix III. Site
visit is frequently conducted by an environment safeguard specialist. Site visit in this period
especially included matters regarding:
     • finalization of Environmental and Management Plan;
     • Submission of remaining Air quality and Water quality test report as construction
          progress;

 Rural Connectivity Improvement Project                                                      9
Semi-annual Environment Safeguard Monitoring Report                       Oct. 2018 - Mar. 2019

   •   Maintenance in written of all permits, clearance and approval required for Camp/
       labour camp, stockpile, equipment yard establishment, Quarry operation, crusher plant,
       spoil disposal sites etc.);
   •   Submission of Occupational Health and Safety Plan, Traffic management Plan;
   •   Establishment Safeguard Desk (Unit) with Focal Person; and
   •   Others.
27     Orientation Training: Besides Contractors personnel of one road each of Kathmandu
and Bhaktapur under NCB-08, awareness training regarding environmental safeguard
requirement of the ADB and the GoN in general and preparation of Site Specific EMP in road
construction were delivered to contractor personnel of all contracts (Appendix IV).
28     Environmental Focal Person: Focal person have been assigned for 15 roads out of
25. The effort towards nominating focal person is ongoing (Appendix IV).
29      Contractor Camps: Contractors have established camps at different road chainage
and location along the road alignment for 8 contract packages. These camps have been
established following permits from respective land owners. Camps are yet to be established
for contract packages NCB-05 & NCB-06 and camps establishment for NCB-08 & NCB-09
are approaching towards completion (Appendix V).
30    Quarry Sites: Approval for quarry sites have been obtained for NCB-01, NCB-02 &
NCB-03 contracts. Approval is being finalized for NCB-07, NCB-10 and NCB-11 whereas
approval has been sought for NCB-04, NCB-05, NCB-08 & NCB-09 (Appendix V).
31      Relocation/ Reinstatement of Private/Public Facilities and Amenities: Except for
NCB-02 Contract where action are being taken for relocation of electric poles, private and
Public facilities including water supply system are not disturbed yet or they are not damaged
to the extent rendering them inefficient are demanding relocation or reinstatement (Appendix
V).
32      Water Sprinkling for Dust Arrest: Regular water sprinkling in a quantity at the rate
2.4 to 2.8 liters per square meter for at least 2 times a day is provisioned in all road contracts
in order to arrest dust nuisance along the road. Water is being sprayed by a water tanker at
regular basis along settlement to arrest fugitive dust as and when required especially in the
contracts where earthworks have been undertaken significantly (Appendix VI). The
grievances of local people regarding dust pollution were not reported during the time of site
visit.
33      Air Quality Monitoring: Periodic Air Quality Monitoring at major settlement areas
along the road is provisioned. TSP, PM10, SOx, NOx, CO and other parameters are being
measured. The monitoring schedule of the parameters is agreed on 8 hours shift over the
period of 24 hours. As per the fixed length along the road as provisioned, sites and location
for the measurement of the given parameters are being finalized. The data and frequency of
air quality monitoring test conducted, and results drawn are provided in (Appendix VI)
34      Water Quality Monitoring: Periodic Water Quality Monitoring at major settlement
areas and water source along the road is provisioned. pH, Total Suspended Solids (TSS), and
Oil and others parameters are being measured. Sites and location for the measurement of the
given parameters are being finalized. The condition for water quality test is assigned for limited
contracts for the roads where major water resource and bodies occurs. The data and
frequency of water quality monitoring test conducted, and results drawn are provided in
(Appendix VI)
35     Slope Protection, Environment Protection Measure and Bioengineering: Gabion
Toe walls have been proposed as protection measures to check unstable slopes resulting due
to construction works. Unstable slope protection works has been undertaken in roads of
Rukkum, Kavre and Rolpa districts (Appendix VI). Besides, bioengineering measures has
been proposed significantly as separate items to stabilize unstable slopes, spoil disposal

 Rural Connectivity Improvement Project                                                  10
Semi-annual Environment Safeguard Monitoring Report                    Oct. 2018 - Mar. 2019

areas and others. This includes different soft structural and vegetative methods including
plantation of the containerized trees seedlings.
36      Construction Site Safety & Traffic Management; Traffic management is being
carried out and contractors are oriented about requirement of construction site safety.
37     Occupational Health and Safety Plan and Camp Site Management: Plans are
sought for OSH measures; safety and first aid. Labour camps are at place at different location
along road side (See Appendix for Photographs of Labour Camp).
38      Spoil Management: Tipping sites for excess spoils have been identified for few
contracts and has also formed part of the EMP. Permits are taken from the private land owners
at the sites and location where the tipping is finalized.
39   Establishment of Safeguard Unit: Establishment of a safeguard unit comprising
member from PIU and Contractor is being planned for each package.
40     Bioengineering: Significant bioengineering measures have been proposed in all road
sub-projects. Since the commencement of construction works is at early stage, few contracts
are awarded lately, and one contract is yet to be awarded the monitoring progress on
bioengineering is yet to realize.
41      Monthly Monitoring Report Submission: The CSC has submitted monthly progress
reports on different aspect of contract management, implementation and administration
including progress reporting on environmental safeguard monitoring and compliance. The
monthly progress report for February 2019 is already submitted by CSC. The newly recruited
individual Environment Safeguard Specialist has also submitted his monthly progress report
within stipulated deadline.

7. IMPLEMENTATION OF GRIEVANCE REDRESS MECHANISM AND COMPLAINTS
RECEIVED FROM STAKEHOLDERS

7.1 Establishment of GRM
42      The project has established a grievance redress mechanism to voice and resolve
social and environmental concerns linked to the project and ensure greater accountability of
the project authorities towards all affected persons. A Grievance Redress and Management
Guidelines 2075 BS is approved by RCIP. Based on these guidelines, Grievance Redress
and Management Committee are formed at following three levels by the project:
43     Field-Level Committee: Comprise of Ward Chairperson, PIU-engineer, RE-CSC, APs,
Contractor's representative and a Social mobilizer;
44     Project-Level (PIU) Committee Comprise of Project Manager PIU, Municipality/Rural
Municipality Representatives, Representative from CDO, DCC- Representative,
representative from DLRO, representative DSO, APs and CSC Social Development and
Gender Specialist; and
45     Central-Level (PCU) Committee Comprise of Project Coordinator-PCU, CDE-PCU,
Section Chief-Finance and Administration Section-PCU, Sociologist-PCU, Designated Road
Engineer-PCU, Environment Safeguard Specialist-PCU, Social Safeguard Specialist-PCU
and Engineer from Planning and Monitoring Section.
46      Grievance Redress Committee formation is completed at local level for 21 road sub-
projects (65 numbers of committees), at PIU level for 16 road sub-projects and one at the
center. The committee formation process is undergoing at different level for different roads
(Annex). The monitoring works has not yet reported environmental related grievances filed in
the existing committee (Appendix IV).

 Rural Connectivity Improvement Project                                               11
Semi-annual Environment Safeguard Monitoring Report                    Oct. 2018 - Mar. 2019

8. OTHER ACTIVITIES

47     Other noticeable activities that may attract significant environmental concern were not
noticed during this period.

9. CONCLUSION

48      Rural Connectivity Improvement Project has entered into the major construction phase
(third quarter of the year 2018 to the end of 2019) of the project cycle. The pre-construction
and construction phase activities undertaken till date is summarized as follows.

    •    Approval process for Use of Government Forest Land and Tree cutting is expedited
         and many are approaching towards approval;
    •    Contractor is finalizing as well as implementing Environmental and Social
         Management Plan Occupational health and Safety Plan, Traffic management Plan
         by start of the peak construction work;
    •    Baseline and few construction phase Air quality and Water quality test are
         undertaken, and report are drawn; additional test should be undertaken, and report
         should be produced for all contracts for construction phase;
    •    Permits are being maintained (eg. Camp/ labour camp, stockpile, equipment yard
         establishment, Quarry operation, crusher plant, spoil disposal sites etc.) in written
         and additional permits needs to be sought early;
    •    Environmental Focal Person is nominated for different contracts;
    •    PIU shall be established Safeguard Desk with Focal Person, Maintain the register to
         address grievances.

 Rural Connectivity Improvement Project                                               12
Semi-annual Environmental Safeguard Monitoring Report                                                                          Oct. 2018 - Mar. 2019

Appendix I:      District/ Package Wise Contract Details with Physical Progress
                                                                                                                                   Physical
                                                                                                            Original Contract                     Intended Work
 Province                                                            Length   Agreement   Commencement                             Progress
               District        Contract No.      Contractor Name                                             Amount (with                           Completion
   (PIU)                                                              (km)       Date         Date                              Till the end of
                                                                                                               VAT &PS)                                Date
                                                                                                                                Feb 2019 (%)
                                                                                                                                                    UW: 19 April,
                            DoLIDAR/RCIP/NCB-
                Jhapa                           M/S ZCGIEC –                  30 March,    20 April, 2018                                             2020,
                                                                     43.515                                  679,379,995.74         16.07
                               01/2074/075      Ashish – Prera JV               2018                                                              PBM : 19 March,
                                                                                                                                                       2023
                                                                                                                                                    UW: 19 April,
                            DoLIDAR/RCIP/NCB-   M/S Swachhanda –              30 March,    20 April, 2018                                             2020,
              Panchthar                                              39.307                                  928,335,587.20         19.65
                                02/2074/075     Kankai JV                       2018                                                               PBM : 19 April,
                                                                                                                                                       2023
    1                                                                                                                                               UW: 23 April,
                            DoLIDAR/RCIP/NCB-   M/S JJECCL – Pappu            30 March,                                                               2020,
   (1)         Sunsari                                               40.479                24 April, 2018    883,252,953.16         15.96
                                03/2074/075     JV                              2018                                                               PBM : 23April,
                                                                                                                                                       2023
                                                                                                                                                    UW: 23Dec,
                                                M/S Kalika-
                            DoLIDAR/RCIP/NCB-                                  03 Dec,                                                                2020,
                Illam                           Gagurmukhi JV,       22.789                24 Dec, 2018      598,284,443.80          2.43
                                05/2074/075                                     2018                                                               PBM : 23 Dec,
                                                Kathmandu
                                                                                                                                                       2023
                            DoLIDAR/RCIP/NCB-
               Morang                           NA                   41.750                                                                             NA
                               06/2074/075

                                                                                                                                                   UW:20 June
               Dolakha
                            DoLIDAR/RCIP/NCB-                                  31 May,     21 June, 2018                                              2020
            Sindupalchowk                       M/S AIPL – NANC JV   43.089                                 1,072,017,561.96        11.60
                                07/2074/075                                     2018                                                              PBM: 20 June
                Kavre
                                                                                                                                                      2023
                                                                                                                                                   UW: 29Dec,
               Sindhuli
    3                       DoLIDAR/RCIP/NCB-   M/S ECI-Kankai JV,             09 Dec,     30 Dec, 2018                                               2020,
              Kathmandu                                              36.651                                  786,485,820.63
   (2)                          08/2074/075     Siphal-07, Kath                 2018                                                              PBM : 29 Dec,
              Bhaktapur
                                                                                                                                                      2023
                                                                                                                                                   UW: 27Dec,
                                                M/S Shanxi-Ashish
                            DoLIDAR/RCIP/NCB-                                  07 Dec,                                                                2020,
               Chitwan                          JV, Bharatpur,       37.566                28 Dec, 2018      789,617,337.65
                                09/2074/075                                     2018                                                              PBM : 27 Dec,
                                                Chitwan
                                                                                                                                                      2023
                                                                                                                                                    UW:03 July
    4                       DoLIDAR/RCIP/NCB-   M/STundi                      13 June,     04 July, 2018                                              2020
                Parbat                                               25.804                                  616,988,089.78         14.73
   (3)                          10/2074/075     Construction                   2018                                                                PBM: 03 July
                                                                                                                                                      2023
                                                                                                                                                   UW: 19 April,
    5                       DoLIDAR/RCIP/NCB-   M/S JJECCL – Pappu            30 March,                                                               2020,
                Rolpa                                                19.693                20 April, 2018    442,304,593.28          9.10
   (4)                          04/2074/075     – Koshi&Neupane JV              2018                                                              PBM : 19 April,
                                                                                                                                                      2023

 Rural Connectivity Improvement Project                                                                                                                  13
Semi-annual Environmental Safeguard Monitoring Report                                                                              Oct. 2018 - Mar. 2019

                                                                                                                                                       UW:20 June
       5                      DoLIDAR/RCIP/NCB-                                   31 May,        21 June, 2018                                           2020
                 Rukum                              M/S PH – SMNS JV     30.043                                   898,040,323.16         4.67
      (5)                         11/2074/075                                      2018                                                               PBM: 20 June
                                                                                                                                                         2023
  Appendix II:    Updated Environmental Management Plan
Environmental           Remedial Measures / Actions               Location           Time Frame           Mitigation            Responsibility                  Status
Issues/Component                                                                                          Cost (NRs.)    Implementation Supervision
              [A] Pre-Construction Stage
                       • Obtain necessary permits for
                         commencement of road work
                         and provide a copy to the
                         Contractor.
                       • Obtain written permission from
                         landholders, Municipality,
                         DCC and Rural Municipality                                                       Subproject
                         under the Local Government                                                       preparation
                                                             Throughout road      Pre –
Permits                  Operation Act, 2017 prior to                                                     cost                                  PIU, CSC
                                                             corridor             Construction                           Contractor
                         commencement of various                                                          Construction
                         activities related to                                                            contract
                         construction work (eg. Camp
                         and stockpile, quarry and
                         borrow pit, Hotmix location,
                         spoil disposal) and provide
                         copies to the Supervising
                         Consultant.
                       • Conduct layout survey of the
                         proposed road construction
                         works.
                       • Locate, peg out and seek
Worksite survey,         approval from the
                                                             Throughout road      Pre -                   Construction
Pegging and            • Supervising Consultant for          corridor             Construction            contract
                                                                                                                         Contractor             PIU, CSC
approval                 each ancillary site prior to the
                         commencement of related
                         activities.
                       • Inspect and approve, if correct
                         all ancillary sites.
Air and Water          • River Water quality, camp           Major Settlement,    Pre -
                                                                                                          BoQ 3.2.10     Contractor             PIU,CSC
quality test             facilities drinking water quality   Major River          Construction

   Rural Connectivity Improvement Project                                                                                                                  14
Semi-annual Environmental Safeguard Monitoring Report                                                                      Oct. 2018 - Mar. 2019

                     • Major settlement/school area
[B] Construction Stage

                      • Cover fresh cuts, take
                         precaution on water pollution,
                         construction of dyke around
                         stockpiled material, spoil,
                         fresh cuts, use bioengineering                                          Included in
Earthworks /          • Plantation of containerized        Throughout road        Construction   BoQ (S. No.
                                                                                                                 Contractor          CSC, PIU
Slope Stabilization      tree & shrub seedlings.           Corridor                              3.1.8, 3.1.10
                      • Control water flow through                                               (2))
                         construction sites or disturbed
                         areas with ditches, berms,
                         check structures, live grass
                         barriers etc.
                      • Provide side drains, cross-
                        drainage as per detailed
                        design.
                      • River training works to avoid
Drainage & Water        depth and side erosion of
Management              stream beds.
                                                           Throughout road                       Construction
(Drainage, cross-     • Public shall be consulted                                 Construction                   Contractor          CSC, PIU
                                                           alignment                             contract
drainage, Gully         regarding location of drainage
protection etc.)        outfalls.
                      • Care shall be taken not to
                        disrupt or contaminate the
                        irrigation water supply or local
                        public water supplies.
                      • Locate and peg quarries and
                        seek approval from the CSC
                      • Obtain permission/license for
Operation and           extraction of materials from       Location of selected
Closure of              Stakeholders, Municipality,        quarries and borrow                   Construction
                                                                                  Construction                   Contractor          CSC, PIU
Quarries and            DCC or Rural Municipality as       pits proposed during                  contract
Borrow Pits             appropriate.                       construction
                      • Locate extraction sites
                        restricted to small areas;
                        preferably on existing quarry

   Rural Connectivity Improvement Project                                                                                                        15
Semi-annual Environmental Safeguard Monitoring Report                                                                      Oct. 2018 - Mar. 2019

                       sites and sites without any
                       tree cover; away from
                       dwellings, archeological,
                       religious or cultural sites; sites
                       which will not alter river flow
                       regime and possess water
                       logging problem in future; and
                       sites where effects will be
                       temporary.
                   •   Restrict all extraction activities
                       to approved sites with
                       operations to the hours of 7:00
                       – 18:00.
                   •   Prevent ponding of surface
                       water through adequate
                       drainage.
                   •   Restore the site maintaining
                       natural contours and
                       vegetation.
                   •   Locate disposal sites on
                       stable ground without
                       excessive slope; that avoids
                       water courses and wetlands;
                       that will not promote instability
                       and result in destruction of
                       property, vegetation and local
                       services.
                   •   Identify, peg and seek
                                                                                                  Included in
Construction           approval from CSC for                Location of selected
                                                                                   Construction   BoQ (S. No.   Contractor          CSC, PIU
Spoil Management       permissible disposal sites.          Spoil disposal sites
                                                                                                  3.1.2 (1))
                   •   Obtain permission from local
                       stakeholders, Municipality,
                       DCC, RM where required as
                       appropriate.
                   •   Restrict disposal at approved
                       locations with correct
                       placement.
                   •   Where required, apply bio-
                       engineering measures for
  Rural Connectivity Improvement Project                                                                                                        16
Semi-annual Environmental Safeguard Monitoring Report                                                                     Oct. 2018 - Mar. 2019

                         vegetative cover to prevent
                         surface erosion.
                     •   Measures shall be taken to
                         prevent earthworks and
                         gabion works from impeding
                         rivers, streams, water canals,
                         or drainage system.
                     •   Locate, peg and seek
                         approval from the CSC for the
                         use of stockpile sites.
                     •   Stockpile should not be
                         located on water courses;
                         should not be within 50m of
                         schools, hospitals or public
                         standpipes; and should not
                         affect locals and their
                         properties.
                     •   Obtain written permission from
Stockpiling of           landowners and local bodies
                                                           Location of identified                  Contractor
Construction             for stockpiling on their land.                             Construction                Contractor          CSC, PIU
                                                           stockpiling sites.                      cost
Materials            •   Stockpiles subject to erosion
                         by wind or water should be
                         covered with tarpaulins. For
                         large stockpiles, it should be
                         enclosed with side barriers
                         and also covered when not in
                         use.
                     •   Provide intervening vegetated
                         buffer to control any un-
                         expected run-off.
                     •   Clean area properly after
                         completion.
                     •    Frame appropriate traffic
                          diversion schemes (in specific
                          stretches as per progress of
Traffic management                                         Project road corridor    Construction   PS 3         Contractor          CSC, PIU
                          construction work) and
                          implemented to avoid
                          inconvenience due to

   Rural Connectivity Improvement Project                                                                                                       17
Semi-annual Environmental Safeguard Monitoring Report                                                                         Oct. 2018 - Mar. 2019

                             construction works to present
                             road users.
                        •   Provision of flag men where is
                            necessary, The traffic
                            diversion signs should be bold
                            and clearly visible particularly
                            at night.
                        •   Adequate no. of drainage
                            structures will be provided in
                            order to have minimum
                            interference on natural
                            drainage pattern.
Disruption in natural
                        •   Drain water discharge into         Along the road
water flow due to
                            farmland will be avoided           Corridor where such                   Construction
construction of                                                                       Construction                  Contractor          CSC, PIU
                        •   No diversion of water away         structures are to be                  Contract
water related
                            from natural water course          constructed
structures
                            unless absolutely necessary
                        •   Avoid any blockage or
                            diversion of natural channels
                            due to (intended or incidental)
                            disposal of spoil
                        •   Inventory of all services to be
                            reinstated.
                        •   Locate and reach agreement
                            with affected people
                        •   landowners and local people /
                            end users
                        •   (Municipality, DCC, RM)
                                                                                                     Construction
                            regarding services (i.e.
Reinstatement of                                               Throughout road                       Contract
Services                •   irrigation canal, water supply     corridor
                                                                                      Construction
                                                                                                     (BoQ item
                                                                                                                    Contractor          CSC, PIU
                            lines, standpipes,                                                       PS 2, 3.1.7)
                        •   drainage ditches and walking
                            trails, electrical poles, paved
                            crossings to be maintained,
                            temporarily cut and reinstated
                            including timing and location
                            of cuts and reinstatements.
                            Obtain written permission from

   Rural Connectivity Improvement Project                                                                                                           18
Semi-annual Environmental Safeguard Monitoring Report                                                                    Oct. 2018 - Mar. 2019

                        affected landowners / local
                        people regarding temporary
                        cessation of services.
                    •   Works shall be planned with
                        timing to avoid /minimize
                        impact to cultural festivals.
                    •   Moving of religious structures
                        shall be done based on the
                        results of public consultation.
                    •   Fuel wood shall not be used
                        for heating bitumen. Bitumen
                        shall be melted in heaters
                        using kerosene, diesel or gas
                        fuel.
                    •   Bitumen drums should be
                        stored in dedicated areas, not
                        scattered along the road and      Throughout road                       Construction
8. Use of Bitumen                                                                Construction                  Contractor          CSC, PIU
                        any small accidental spills       corridor                              contract
                        should be cleared up
                        immediately.
                    •   No bituminous material shall
                        be discharged into side drains.
                    •   Bitumen shall not be applied
                        in strong wind or rainy
                        conditions.
                    •   Locate, stake out and seek
                        approval from CSC for stone
                        crushing plant.
                    •   Locate plant site away from
9. Stone Crushing       population centers, drinking
Plant / Hot mix         water intakes, cultivated lands
                                                          Location of selected   Construction   Construction
Plant / Batching        and sensitive ecosystem                                                                Contractor          CSC, PIU
                                                          Plant sites            Stage          Contract
Plants                  preferably at least 500m from
                        settlement and habitation.
                    •   Obtain permission from local
                        stakeholders, Municipality,
                        Rural Municipality, DCC as
                        appropriate.

   Rural Connectivity Improvement Project                                                                                                      19
Semi-annual Environmental Safeguard Monitoring Report                                                                   Oct. 2018 - Mar. 2019

                    • Stone crushing equipment /
                      cement batching shall be fitted
                      with dust control devices and
                      operated as per
                      Manufacturer’s Specification.
                    • Hotmix Plant should have in-
                      built mechanisms for the
                      absorption of gases.
                    • The plant shall be operated
                      during day time.
                    • Restore the site maintaining
                      natural contours and
                      vegetation after use.
                    • Stone crushing plant / Hotmix
                      plant / Batching plant shall be
                      appropriately located at least
                      500m from settlement&
                      habitation fitted with dust
                      suppression equipment.
                    • Road construction area shall
                      be maintained damp by
                      periodical spray of water.
                    • Delivery vehicles shall be
                                                                                               Construction   Contractor
                      covered.
                                                        Project area, Crusher                  contract
                    • Mixing equipment shall be well                                                                              CSC, PIU
                                                        Plant sites                                           Through
10. Air Pollution     sealed and equipped as per                                Construction
                                                                                               Included in    approved
                      existing standards.                                                                                         CSC, PIU
                                                        Settlement areas                       BoQ            monitoring
                    • All construction vehicles                                                (3.1.10 (3))   agency
                      should comply with Motor
                    • Vehicles and Transportation
                      Management Act as amended
                      and have green sticker for
                      operation.
                    • Provide temporary hoardings
                      where required tominimize
                      dust impact on locations of
                      temples and other cultural
                      sites.

   Rural Connectivity Improvement Project                                                                                                     20
Semi-annual Environmental Safeguard Monitoring Report                                                                        Oct. 2018 - Mar. 2019

                      • Provision of speed control
                        measures in settlement and
                        working areas to limit traffic
                        speed.
                      • Air pollutant parameters (TSP,
                        PM10, SO, NOx, CO) shall be
                        monitored regularly during
                        construction.
                      • Hazardous materials shall not
                        be stored near surface waters
                        sources
                      • Used lubricants and oils shall
                        be collected and recycled or
                        disposed off site.
                      • Plastic sheeting shall be
                        placed under hazardous                                                      Construction
                        material storage area to                                                    Contract       Contractor          CSC, PIU
                        collect and retain leaks and
                                                             Project area            Construction
                        spills.                                                                                    Through
11. Water Pollution
                      • Contaminated runoff from                                                                   approved
                                                             Stream crossings
                        storage areas shall be                                                      Included in    monitoring
                        captured in ditches with an oil                                             BoQ            agency              CSC, PIU
                        trap at the outlet.                                                         (3.1.10 (4))
                      • Contaminated and worn
                        plastic sheeting shall be
                        packed into drums and
                        disposed off site.
                      • Water Quality (PH, TSS, Oil
                        and Grease) monitored
                        regularly during construction.
                      • Ensure plant and equipment
                          used for construction
                          conforms to best practices.
                                                             Project area, Crusher                  Contractor
Noise Pollution       • Vehicles and equipment used          plant site
                                                                                     Construction
                                                                                                    Cost
                                                                                                                   Contractor          CSC, PIU
                          will be fitted with silencer and
                          maintained to keep noise at
                          minimum levels.

   Rural Connectivity Improvement Project                                                                                                          21
Semi-annual Environmental Safeguard Monitoring Report                                                                            Oct. 2018 - Mar. 2019

                          •   Workers will be provided with
                              appropriate earmuffs/plugs
                              specially at crusher site
                          •   Noise barriers will be placed
                              in urban and sensitive
                              locations i.e. schools,
                              hospitals etc.
                          •   Cracks caused by vibration
                              due to construction activities
                              need to be monitored closely
                              and alternative be sought
                              where problem arises.
                          •   Work shall be restricted to
                              day hours specifically at
                              urban and sensitive
                              locations.

   C2 Biological
                          • Identify and seek approval
                            from CSC for clearance of                                                   Construction
                            trees/vegetation.                                                           Contract
1. Vegetation and                                                Throughout road
                          • Fuel wood shall be banned for                                Construction   (BoQ item      Contractor          CSC, PIU
Forest Resources                                                 alignment
                            construction works.                                                         3.1.1 (1 to
                          • Wildlife hunting and poaching                                               5))
                            shall be prohibited
Loss of forest area and   Compensatory    plantation   to   be
trees                     carried out
                                                                 Project area            PIU                           PIU/CFUG            DFO, CSC
           C3 Socioeconomic and Cultural
                     • Camp shall be barricade
                     • Locate, peg and seek
                       approval from CSC for labor
2. Labour Camp         camp sites.
                                                                 Locations of selected                  Construction
Location and         • Camps shall not be located                labour camps
                                                                                         Construction
                                                                                                        Contract
                                                                                                                       Contractor          CSC, PIU
Management             near settlements; near water
                       supply intakes; or sites that
                       affect the access by local
                       people to drinking water.

   Rural Connectivity Improvement Project                                                                                                              22
Semi-annual Environmental Safeguard Monitoring Report                                                                 Oct. 2018 - Mar. 2019

                   • Camp shall not be in the
                     vicinity of landslide and flood
                     plains.
                   • Provide and maintain proper
                     drinking water, sewerage and
                     waste disposal facilities at the
                     camps. Camp shall be
                     barricade.
                   • Ensure no wood is burnt by
                     any worker on or off site.
                   • Camps shall be provided free
                     of cost, with electricity and
                     regulator & adequate fuel
                     supplies of LPG or Kerosene.
                   • Prohibit workforce from
                     poaching wildlife and cutting
                     trees.
                   • After use, sites shall be
                     cleared and restored to
                     natural or stable conditions.
                   • Provide and maintain first aid
                     medical facilities, toilet shall
                     be male and female
                     separately.
                   • Sock pit for waste water, Pit
                     for waste collection
                   • Camp shall be established as
                     per DoLIDAR OSH guidelines
                   • Locate, peg and seek
                     approval from CSC for work
                     camp sites.
3. Work Camp
                   • Camps shall not be located         Locations selected                  Construction
Location and                                                                 Construction                  Contractor          CSC, PIU
                     near settlements and; near         for work camps                      contract
Operation
                     water supply intakes; or sites
                     that affect locals access to
                     drinking water.

  Rural Connectivity Improvement Project                                                                                                   23
Semi-annual Environmental Safeguard Monitoring Report                                                             Oct. 2018 - Mar. 2019

                    • Camp shall not be in the
                      vicinity of landslide and flood
                      plains.
                    • Provide and maintain proper
                      drinking water, sewerage,
                      waste disposal including first
                      aid unit medical facilities at the
                      camps.
                    • Used oil, lubricants shall be
                      recovered, re-used or
                      removed form site.
                    • Explosives, oil, petrol, and
                      grease shall be managed
                      according to provisions of this
                      Management plan.
                    • After use, the site shall be
                      cleared and restored to near
                      natural or stable conditions.
                    • Toilet shall be male and
                      female separately
                    • Sock pit for waste water
                    • Pit for waste collection
                    • As per DoLIDAR OSH
                      guidelines
                    • Adequate lighting and safety
                      signal devices be installed for
                      work safety.
                    • Adequate warning signs and
                      safety barriers shall be
                      provided for work safety.
4. Occupational
                    • Protective clothing including                                      Construction
Health and                                                 Project area   Construction                  Contractor          CSC, PIU
                      helmets, masks, boots,                                             Contract
Safety
                      gloves, ear plugs and goggles
                      should be provided for
                      workers safety.
                    • At every work place, a readily
                      available first aid unit including
                      an adequate supply of

   Rural Connectivity Improvement Project                                                                                               24
Semi-annual Environmental Safeguard Monitoring Report                                                                        Oct. 2018 - Mar. 2019

                         dressing materials shall be
                         provided for emergency
                         preparedness in case of
                         accidents.
                       • Maintain health care system at
                         construction camps.
                       • Strict rules and regulation be
                         maintained in the labour and
                         work camp to avoid alcoholic
                         and other bad habits.
                       • Electrical Equipment shall be
                         checked and certified
                         regularly.
                       • Provide and install all road
                         signs as per design.
                       • As per DoLIDAR OSH
                         guidelines
Post Construction Activities
1. Camp site           • Camp site to be restored to its
restoration(Change        original condition as per the
of land use due to        rehabilitation plan
setting up of          • Restoration of top soil
                                                                                                    Contractor’s
construction camp,     • Disposal at waste at              Campsite locations   Post-construction                  Contractor          CSC, PIU
                                                                                                    cost
Waste generation at       designated locations
the construction site, • Cleaning of water channels
Generation of debris   • Removal of debris and
and silt)                 disposal
                       • Quarry site/Borrow area to be
                          restored to its original
2. Quarry                 condition as per the
                                                           Designated                               Contractor’s
site/Borrow area          rehabilitation plan                                   Post-construction                  Contractor          CSC/PIU
                                                           Quarry/Borrow area                       cost
restoration            • Restoration of top soil &
                          disposal of debris/waste at
                          designated locations

  Note: COx = Oxides of Carbon, DCC = District Development Committee, PIU = Project Implementation Unit., RCIP = Rural Connectivity Improvement
  Project, NOx = Oxides of Nitrogen. ROW = Right of Way. CSC = Construction Supervision Consultant, SOx = Oxides of Sulfur, TSPM – Total Suspended
  Particulate Matter, RM= Rural Municipality

   Rural Connectivity Improvement Project                                                                                                          25
Semi-annual Environmental Safeguard Monitoring Report                                                                                  Oct. 2018 - Mar. 2019

    Appendix II:     Environmental Monitoring Plan
                                                                                                                             Additional                               Corrective
       Environmental                                                                                                         Monitoring           Compliance            action
SN                                                Mitigation Measures                                    Location
         Attributes                                                                                                          Indicator if           status           proposed in
                                                                                                                             applicable                             case of delay
                         Confirm if the Land acquisition, resettlement and rehabilitation,
                                                                                                    All through the      Confirm the status
                         poverty alleviation programs for affected people and all other related
1      Land transfer                                                                                alignment of each    of land transfer (%
                         issues are addressed in Social Impacts and Resettlement &
                                                                                                    rural road           of total)
                         Rehabilitation report.
                         All efforts shall be taken to avoid tree cutting wherever possible. •                                                   One road
                         Requisite permission from forest department shall be obtained for                                                       approval, 7
       Biological        cutting of roadside trees.                                                 Throughout the       Confirm issuance        roads, not
2      environment -     • Provision of Compensatory Afforestation shall be made on                 project section of   of Forest               required, 16
       Tree planting     1:25.ratio basis. • Permission shall be taken for diversion of any         the road             Clearance               roads verified
                         forest land if involved. Provision shall be made for additional                                                         and 4 road
                         compensatory tree plantation.                                                                                           remaining
                         The road land width shall be clearly demarcated on the ground. •                                Tree cutting
                         The utility and community structure shifting shall be planned in                                permission from
                         consultations and concurrence of the community. • Tree felling shall                            Forests                 Community
                         be limited to those, which could not be saved even by design               All through the      Department              approval for
                         measures. The tree shall be cut with a prior permission of Forest          Rural roads                                  vegetation
       Planning for                                                                                                      Concurrence from
3                        department. • The vegetable cover shall be removed and disposed            excepting in                                 removal is
       land clearing                                                                                                     community for
                         in consultation with community. • All public utilities shifting shall be   stretches of                                 included with
                                                                                                    habitations          utility, community      verification
                         planned with prior concurrence of respective agencies/authority and                             structure, and
                         to the adjacent location approved by them                                                                               report.
                                                                                                                         vegetation cover
                                                                                                                         removal
                         All efforts are made to minimize shifting of common utilities and                                                       Initiation to
       Shifting on       community structures. • The community structures/utilities, which          As determined by     Assess compliance       relocate has
       Common            cannot be saved, will be shifted to adjacent area with the                 contractor under     based on                been
4
       Properties        concurrence and in consultation with community                             approval of PIU      DOLIDAR’s               undertaken
       Resources                                                                                    and CSC              Guidelines              for one
                                                                                                                                                 contract
       Establishment     Construction camp sites shall be located away from any local human         As determined by     Location of
       of Construction   settlements (minimum 0.5 km away) and preferably located on                contractor under     construction camp
                                                                                                                                                 DoLIDAR
       Camp,             lands, which are not productive barren/waste lands presently. •            approval of          with planning of
5                                                                                                                                                Guidelines is
       temporary         Similarly temporary office and storage areas shall be located away         PIC/PIU/             requisite facilities
                                                                                                                                                 being followed
       office and        from human settlement areas (minimum 500 m). • The construction            (ref- Labelled:      and making
       storage area      camps, office and storage areas shall have provision of adequate           WASTE OIL; and       provision of such

     Rural Connectivity Improvement Project                                                                                                                       26
You can also read
