Euston Throat - Granby Terrace to Hampstead Road - Construction update 04/03/2021 - AWS
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Areas within the Euston Approaches We have divided the Euston Approaches worksites into three areas to help us communicate which works are closest 1. Vehicle Holding Area & Parkway and most relevant to you. 1. Vehicle Holding Area & Parkway 2. Camden Cutting (Parkway to Granby Terrace bridge) 2. Camden Cutting 3. Euston Throat (Granby Terrace to Hampstead Road) This construction update is for Euston Throat. To view the construction update for the Camden Cutting and Vehicle Holding Area/Parkway please visit HS2inCamden.co.uk 3. Euston Throat
Euston Approaches engagement programme 2021 Feb/Mar 2021 mid-2021 Sep/Oct 2021 late 2021/early 2022 • Newsletter • Euston Portal Headhouse • Newsletter • Euston Portal Headhouse • Euston Cavern Headhouse scheme design (seek • Euston Approaches (inform final design) events (inform final design) community feedback) construction update events / • Euston Approaches drop-ins construction update events Ongoing engagement: community notices, stakeholder and resident briefings, Commonplace updates, HS2 Helpdesk, HS2 drop-in events and webinars, HS2 newsletters Tunnel design for Euston Approaches will be available in spring 2022, when we will provide details to property owners and people living nearby. 04/03/2021 4
Contents 1. Construction programme and key dates 6 2. Piling 5 3. Hampstead Road utilities diversions 4. Site office 2 5. Granby Terrace bridge deconstruction 4 6. Rail closure 7 7. Lorry routes and haul road 3 8. Surveys 4
Construction programme – 6 month lookahead Jan - Mar Apr - Jun Jul - Sep Hampstead Road bridge • Utility diversions on Hampstead • Utility diversions on Hampstead • Utility diversions on Hampstead Road Road Road Granby Terrace bridge • Piling • Piling • Piling • Granby Terrace • Granby Terrace • Granby Terrace bridge deconstruction bridge deconstruction bridge deconstruction • 24/7 rail closure #1 • 24/7 rail closure #2 Euston Throat • Piling • Piling • Piling • Substation install • SCS main site offices install • Please note, dates are subject to change • We will provide further details ahead of key activities 04/03/2021 6
Euston Throat – key activities to September Granby Terrace deconstruction Piling 20 Feb to 19 Jul Dec 2020 to May 2024 • Granby Terrace bridge deconstruction of “Span 4” • Granby Terrace bridge – Mar to Nov 2021 • 24/7 working and weekend works during rail closures • Euston Throat – 16 Dec 2020 to Nov 2022 • Hampstead Road bridge – 18 Oct 2021 to May 2024 Main site office install Haul road by spring May to summer • New site access to/from Hampstead Road in Mar • 5-storey site office on corner of Stanhope Street and Granby Terrace in May (95 abnormal loads) • Haul road in worksite operational by spring • We will maximise use of haul road to reduce use of Stanhope Street site access • There will be periods when construction activities mean the haul road cannot be used – so we will use Stanhope Street gate Temporary site office Harrington Street sewer construction works (CSJV) until Aug Ongoing until summer 2021 • Required due to reduced capacity in existing and planned • Phased road closures on Harrington Street site offices because of social distancing measures Hampstead Road utilities diversion (phase 1 of 3) Feb to Sep Dates are subject to change. We • Diverting utilities from the footway into the road prior to will keep you updated. piling next to Cartmel

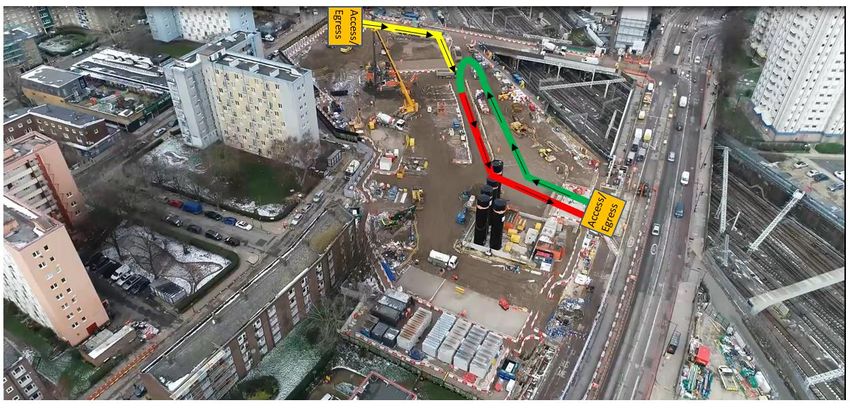

Euston Throat SCS started main works in Euston Approaches Works Planned dates* between Hampstead Road and London Zoo car Piling – Granby Terrace to Hampstead Road Dec 2020 – Nov 2022 park in April 2020. Utilities – Hampstead Road Feb – Oct 2021 Euston Throat includes piling, excavation, bridge and utilities works between Granby Terrace and Granby Terrace bridge deconstruction Feb – Aug 2021 Hampstead Road bridges. Piling – Granby Terrace Mar 2021 – Nov 2021 Key structures are Rail closure #1 including vibratory piling 2 Apr – 17 May 2021 • Granby Terrace bridge • Euston Throat Retained Cut Main site office corner Granby Terrace & Stanhope Street May 2021 • Hampstead Road bridge Rail closure #2 17 Jul – 31 Aug 2021 We will continue to provide updates to the Tower cranes Sep 2021 – May 2026 community ahead of our works at Piling – Hampstead Road Bridge Oct 2021 – May 2024 HS2inCamden.co.uk, where you can also find maps and content from our online construction updates. Utilities – Granby Terrace and Throat Jun 2022 – 2023 Granby Terrace bridge extension works Mar 2021 – Jul 2026 Hampstead Road bridge extension works at surface Jul – Aug 2023 Jan – Feb 2025 *Dates are subject to change. We will keep you updated. Utilities – Hampstead Road Nov 2024 – 2025 Hampstead Road bridge extension complete Dec 2025
Euston Approaches piling summary Area Location Piling dates No. of piles Piles are concrete and steel structures that are installed into the ground to Camden Cutting Parkway – Mornington St Jun 2021 – Aug 2021 152 provide strength, stability and support to an above-ground structure or an excavation Mornington St – Granby Terrace Nov 2020 – Jun 2022 984 The method of piling is determined by the type of pile required, the nature of the ground, the location of surrounding railway structures and Euston Throat Granby Terrace – Hampstead Road Dec 2020 – Nov 2022 360 residences, and the size of the work area. We aim to use the quietest method possible for each set of works. Granby Terrace Mar 2021 – Nov 2021 159 Auger-boring and pressed sheet piling are our preferred methods however, we will need to use vibratory Hampstead Road Bridge Oct 2021 – May 2024 472 piling during the April/May Network Rail closure TOTAL Euston Nov 2020 – May 2024 2127 For more information please see our piling factsheet at Approaches HS2inCamden.co.uk Dates are subject to change. We will keep you updated.
Hampstead Road – utilities diversion 04/03/2021 12
Hampstead Road utilities diversion – 3-phase approach Feb – Sep 2021 Phase 1 - diversion of utilities from the footway into the carriageway for piling works Phase 3 Jun 2022 – 2023 Phase 2 Phase 2 - temporary diversion around west side retaining wall and Granby Terrace Bridge Nov 2024 – 2025 Phase 1 Phase 3 - permanent reinstatement on Hampstead Road Bridge
Site offices 04/03/2021 14

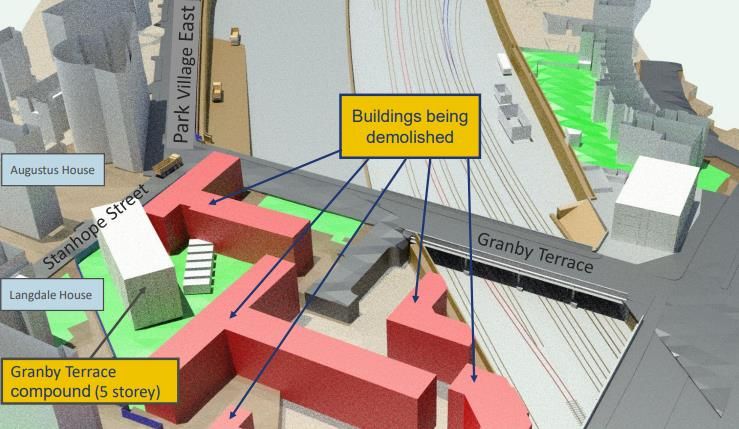

SCS site offices Main SCS site offices • 5 storey offices installed from May to summer 2021 – Eskdale block previously 8 storeys • 95 cabins lifted into site from Stanhope Former buildings Street by a crane • Footway closures and parking bay suspensions on Stanhope Street to provide a safe exclusion zone • Operational for duration of project • Increased security presence once operational Temporary site offices • Operational till Aug • Acoustic blankets around generators • Angled lighting to reduce glare
Granby Terrace bridge - deconstruction 04/03/2021 16
Granby Terrace bridge deconstruction – Mar to Jul • Deconstruction of span 4 of Granby Terrace bridge o Remove bridge surface o Cut bridge into pieces o Lift sections away using a 750-t mobile crane • 24/7 working and weekend works during Network Rail closures o Phase 1: weekend of 6-7 Mar and 13-14 Mar o Phase 2: weekend of 17-18 Apr, 24-25 Apr, 1-2 May, and 8-9 May o Phase 3: weekend of 5-6 Jun, 12-13 Jun, and 19- 20 Jun • Cranes and rigs on site • Large loads during off peak hours
Rail closure – 24/7 works 2 April to 17 May 04/03/2021 18
Rail closure – 2 April to 17 May 2021 Auger piling • 24/7 works scheduled for 5 April – 16 May • Trackside piling works in Camden Cutting south of Mornington Street bridge • This piling method is no different to that currently ongoing on site Sheet piling Sheet piling (vibration method) • To be installed along the length of the track from Mornington Street bridge to Parkway tunnels, 5 - 30 April (Monday to Friday 8am – 6pm) • Designed to stabilise the ground and prevent any horizontal ground Auger piling movement, protecting the railway • We will use a vibration sheet-piling method for this work Granby Terrace bridge – Span 4 • De-construction scheduled for the weekends of 17 April – 15 May • The end of the bridge will be removed to make way for ground excavation De-construction and bridge extension works of bridge span 4 04/03/2021 19
Rail closure – activities and consented hours Activity in Euston Approaches Date W/E Working hours Closure #1 2 Apr – 17 May Camden Cutting 2 – 4 Apr Y 24/7 Mobilisation & pile mat construction (including concrete) Piling 8am – 6pm, concreting works to 10pm most Piling – contiguous 5 Apr – 15 May weeknights Breaking out concrete works 19 Apr – 17 May Mon – Fri 8am – 6pm, Sat 8am – 1pm Capping beam construction work 19 Apr – 17 May Y 24/7 Cavern Mon – Fri 8am – 6pm Vibration sheet piling 5 – 30 Apr Euston Throat Piling 8am – 6pm, concreting works to 10pm most Piling – contiguous ongoing weeknights Granby Terrace bridge 17 –18 Apr De-construction of span 4 (NR weekend possessions) 24 – 25 Apr Y Sat 9pm – Sun 12pm 1 – 2 May 8 – 9 May 15 – 16 May Demobilisation. Return of Line E to Network Rail 14 – 17 May Y 24/7 04/03/2021 20
Vibration sheet piling Reason Method Noise and vibration mitigations Why vibration sheet piling? 1. A small hole is drilled into the ground • Vibration sheet piling will take place • Due to the proximity of the railway and to limit vibration Mondays to Fridays, 8am to 6pm underground tunnels, we must use 2. Sheet piles are positioned within the • Noise and vibration monitoring will be smaller piles than those used hole and dirt is replaced carried out on a regular basis previously in other areas onsite throughout the works 3. A machine drives piles down to the • These smaller piles must be installed desired depth using a combination of • We will investigate noise and vibration using a vibration piling method push-force and vibration alerts as quickly as possible to resolve • We will continue to use pressed sheet 4. To view a video of this method please the issue and ensure the level of noise piling (Giken method) wherever search online for ‘Movax sheet piling’ and vibration remains within the possible agreed limit
Network Rail works 04/03/2021 22
OFFICIAL Network Rail HS2 enabling work 10 & 17 April Saturday night LED Signal head installation April 2 – 17 May 2021 NO PLANNED WORKS Sunday 4 April 07:00 to 20:00 Installation of equipment to safely isolate Saturday 15 May 08:30 to Monday 17 May 04:00 overhead electrical lines for piling work Removal of isolation equipment to restore Sunday 4 April 15:00 to 23:59 working line Safety checks on electrical isolating equipment
OFFICIAL Network Rail HS2 Enabling work April 1 – 22 May Work to take out electrical supply for This electrical work plus work to A mobile elevated working period of possession, this will take monitor these electrical platform will need to be used place adjacent to railway line in connections will take place midweek from 4-April for some of Euston approaches over weekend of overnight midweek from 4-April for the time to check overhead line 3 – 4 April safety reasons. connections. This is not expected to be noisy though when mobile it will need to intermittently sound the horn for staff safety. These enabling works have been No other work is currently planned We will advise residents of any consented by Camden Council and in the Euston approaches over this change to our scheduled work are included in the Network Rail six week period. plans via the HS2inCamden website prenotification letter which covers Please note that we may work from 20 February to 20 May sometimes need to carry out Please sign up for web alerts at 2021 essential maintenance and www.HS2inCamden.co.uk emergency works on adjacent lines at short notice
Lorry routes and haul road 04/03/2021 25

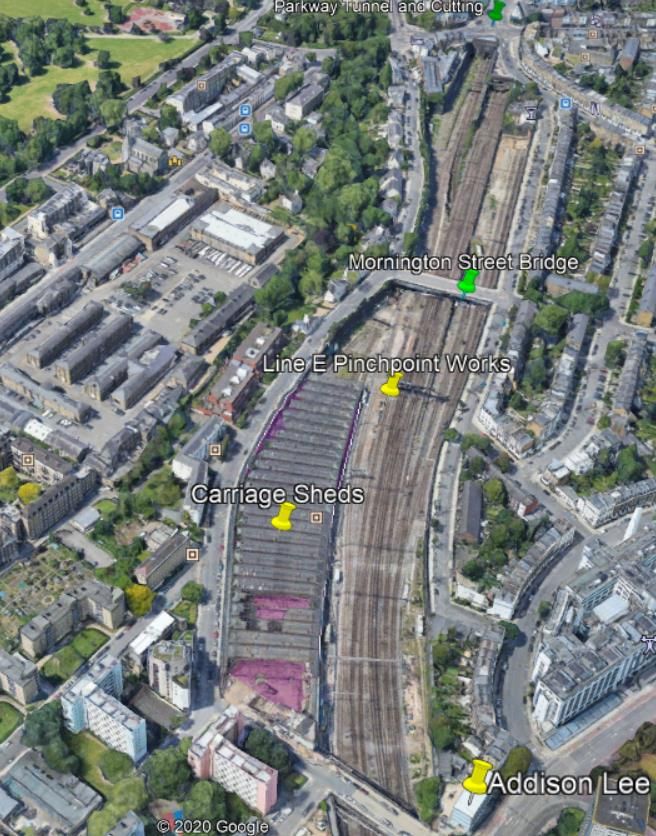

Approved lorry routes and vehicle numbers per worksite Compound Worksite HS2 Act forecast SCS forecast 2-way movements 2-way movements (avg peak busy period) (avg peak busy period) Park Village East (north) 90-136 20-30 cavern Carriage Shed & Park Village 160-250 East 300-450 Granby Terrace Overbridge 260-280 A400 Hampstead Road 30-40 Overbridge ZSL Lorry Holding Area No forecast of HGV’s 130-190 given within ES • Vehicles use permitted routes during their journey to and from sites • Vehicles prioritise main roads where possible • There are times we need to deliver large loads overnight or early morning for safety • Forecasts above are 2-way movements to and from our worksites based on calculations in the HS2 Act • We always aim to minimise the number of construction vehicles by re- using excavated materials on site, carefully planning our logistics and using best practicable methods for our works • We are continually reviewing our practices to reduce the impacts of our works 04/03/2021 26
Haul road Hampstead Road access • A haul road with access on/off Hampstead Road will help reduce HS2 construction traffic on residential streets • The haul road will change location over time to enable vehicles to continue using it whilst safely avoiding large-scale machinery and construction in our narrow worksite • We will use the haul road as often as possible, however there will be periods where there is insufficient space to keep it in use • When we cannot use the haul road, we will use approved lorry routes to access our worksite via Stanhope Street gate. • Haul road will be in use from end of Summer 2021 as a throughfare for site traffic 04/03/2021 27
Survey's update 04/03/2021 28
Pre-condition surveys • Pre-condition surveys are visual inspections by an independent accredited surveyor to capture the existing condition of a proper ty • Required for all properties along the HS2 route within the zone for predicted ground movement of more than 1mm for listed buildings and more than 10mm for non-listed buildings • These are the same as the surveys referred to in the C3 Information Paper regarding Settlement Deeds (but if completed earlier than the 3-6 months immediately before excavation works, we may need to refresh them, by agreement) • In the case of any future claims for damage, the survey will provide an independent baseline record against which to compare condition before and after our works – this will assist both parties by enabling a quicker assessment and claims process by reducing the need to prove the damage was not pre-existing • Copies of the report will be available on request and are normally issued just to property owners but will also be provided to long-term leaseholders if requested What is covered • Walls and floors o Cracks, sign of movement, vibration, deformation, damage and displacement to the property structure and fabric o Bulges, include size and location o Water damage or ingress o Internal and external finishes • Tree positions, types and diameters 04/03/2021 29
COVID - 19 We are continually reviewing the works of our surveying team in line with Government and Public Health England (PHE) advice on dealing with COVID-19. The Government’s current Covid-19 strategy makes clear that construction activity can continue as long as it complies with this guidance and those working in construction have been actively encouraged to go to work. Several measures will be in place to protect residents and members of our surveying team. These will at least include • when making contact we will confirm with you whether you are happy for us to attend and that that there are no health issues with people that live in your home. We will also confirm that there are no health issues within our team • we will keep staff numbers to a minimum within your property • before entering any property, we will sanitise our hands and any equipment and we will wear appropriate personal protective equipment • where possible, windows will be opened while our surveyors are working for better ventilation • all surveyors will receive weekly COVID-19 testing • all surveyors will carry laser thermometers and check their temperature before entering each property • we will notify residents should any of our surveyors test positive within two weeks of entering their property 04/03/2021 30
Compensation and repairs Protection The High Speed Rail (London – West Midlands) Schedule 2 Act 2017 • Allows HS2 to strengthen/support a structure in the course of carrying out works • Automatically protects home-owners in the unlikely event your property is damaged by our works • Allows HS2 to leave in place (temporary of permanently) any materials associated with the strengthening/support works • Allows for owners/occupiers to be compensated for any loss they may suffer as a result of the support/strengthening works • Any disputes or disagreements regarding compensation are determined in accordance with Part 1 of the Land Compensation Act 1961. Using Crossrail and Channel Tunnel Rail Link process – a tested mechanism for settling minor, construction related residential, business or Claims agricultural claims for which HS2 is responsible Two ways to deal with compensation and claims under Schedule 2: Overseen by independent Resident’s • dedicated compensation claims service via LPClaims@hs2.org.uk Commissioner whose job it is to make sure HS2 keeps its promises and to mediate and respond • parallel Small Claims Scheme (information Paper C10). to complaints. 04/03/2021 31
Information and enquiries • Newsletters, community notices, updates and further information available at HS2inCamden • Euston Approaches works map at HS2inCamden is updated weekly to keep you informed about current and upcoming works • For all enquiries, compliments or complaints please contact the HS2 Helpdesk • Freephone 08081 434 434 • Email HS2enquiries@hs2.org.uk 04/03/2021 32
