C-band Customer Update - Intelsat 09 June 2021
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Agenda 1. Situational summary 2. FCC update 3. Earth Station Update 4. Questions Please ensure you are on mute You can raise questions via the CHAT function © Intelsat 2020 | Confidential & Proprietary 2
Situational summary • ISED still in deliberations over Canadian process • Clearinghouse rules issued and established • Tranche 1 customer transitions complete by 31 May • Filtering of top 46 PEAs started on 01 June 2021 • Filtering to be complete by 31 August, setting stage for 05 Dec 2021 spectrum delivery • Restoration letters (guidance) issued to all Galaxy customers • Intelsat TT&C consolidation/construction activities are on-schedule © Intelsat 2020 | Confidential & Proprietary 3
FCC Update Relocation Payments Clearinghouse Updates ▪ On May 14, Intelsat submitted comments on the Relocation Payment Clearinghouse’s April 30 draft handbook of policies and procedures for the submission and processing of costs associated with the transition. Generally, Intelsat’s comments were geared toward streamlining the cost reimbursement review process by, for instance, minimizing the amount of evidentiary documentation required to be filed with each request, and reducing the amount of granular, impractical, or irrelevant detail needed to accompany reimbursement requests. ▪ Intelsat also advocated for the protection of commercially sensitive information, for the Clearinghouse to avoid unnecessarily second-guessing cost decisions made in good faith when reviewing reimbursements, and for the reimbursement of large costs to be possible on a milestone basis. ▪ In addition to its comments, Intelsat met with FCC staff regarding the issues above in a series of meetings described in a May 28 ex parte notice. ▪ The draft handbook can be found at: https://cbandrpc.com/guidance/Resources/RPC_C- band_Handbook_DRAFT_4-30-2021.pdf © Intelsat 2020 | Confidential & Proprietary 5
FCC Update, cont’d. Updates, cont’d. • Discussions with the Clearinghouse on a commercial agreement to govern its relationship with the satellite operators are ongoing. However, the satellite operators have provided an initial tranche of funding to the Clearinghouse to fund initial Clearinghouse operations • The FCC has yet to issue the 5G flexible use licenses won by the winning bidders in Auction 107, despite the fact that the pleading cycle for the FCC to receive challenges to the winning bidders’ license application forms ended in April. One pending issue is DISH’s protest of the auction wins by T-Mobile and Verizon, in which they claimed the winning bids by T-Mobile and Verizon would cause unacceptable spectrum consolidation in certain markets. Before the overlay licensees can fund Clearinghouse operations (including reimbursements), they must actually be awarded their licenses. • The satellite operators’ 2nd Quarterly Report for 2021 to provide updates on their progress with the C-band transition are due to be filed with the FCC by early July. © Intelsat 2020 | Confidential & Proprietary 6
Canada – C-band Decision ISED adopted no incentive, no compensation Key Highlights: USA vs. Canada Band Plan ▪ No incentive, No compensation 3450 3460 3470 3480 3490 3500 3510 3520 3530 3540 3550 3560 3570 3580 3590 3600 3610 3620 3630 3640 3650 3660 3670 3680 3690 3700 3710 3720 3730 3740 3750 3760 3770 3780 3790 3800 3810 3820 3830 3840 3850 3860 3870 3880 3890 3900 3910 3920 3930 3940 3950 3960 3970 3980 3990 4000 4010 4020 4030 4040 4050 4060 4070 4080 4090 4100 4110 4120 4130 4140 4150 4160 4170 4180 4190 4200 ▪ Auction in Q1 2023 → Release spectrum in March 2025 FLEXIBLE USE FLEXIBLE USE USA FEDERAL CBRS Tranche 1 (Dec 2021) Tranche 2 (Dec 2023) GB FSS ▪ Similar to FCC band plan although: – all spectrum will be available in one tranche FU FLEXIBLE USE CANADA FLEXIBLE USE (Auction in June 2021) 2027 Auction Q1 '23, Available Q2 '25 WBS GB FSS – Top 100 MHz (3900-4000 MHz) will not be auctioned – WBS will occupy 3900-3980 MHz ▪ No technical rules yet but adopted 20 MHz guard band Extended C-band C-band Conventional C-band ▪ Further consultation on technical rules will be issued but no time frame ▪ Full C-band continues in Satellite Dependent Areas (Tier 4 areas) and designated gateway locations. ▪ FSS will continue to be protected up to 31 March 2025 ▪ License-exempt earth stations will also be protected through an “interim authorization” but only if they are part of a network. © Intelsat 2020 | Confidential & Proprietary 7
Ground segment update Earth station filtering – top 46 PEAs © Intelsat 2020 | Confidential & Proprietary 8

Phase I Clearing Deadline Clearing by December 5, 2021 deadline requires filtering completion this Summer September – May 31 June - November October December 5 Lower 120 MHz August Issue Mandatory 30- day comment 5G Operations (6 transponders) Nominal filter remediation; late- period on free to deploy in cleared of traffic, installation breaking ESO Certificate of top 46 PEAs including OU window obligations; Clearing special cases Filtering in Phase I required only in and near the 46 of Top 50 Partial Economic Areas (PEAs) © Intelsat 2020 | Confidential & Proprietary 9
Filter Installation Update Scheduling for Phase I well underway; installations progressing ▪ Filters must be installed in Phase I PEAs (46 of YTD Phase I Filtering Summary (Sites) Pending WO- the top 50) to mitigate against the risk of future Vendor Total Sites Not Not Scheduled- Scheduled % Scheduled Completed % Completed Submitted interference from 5G operations. Submitted USSI 133 11 27 95 71% 5 4% ▪ Filtering began in earnest on June 1 Wesco ATCi 348 54 88 0 118 46 142 8 41% 15% 95 2 27% 4% Self-Install 58 57 1 0 0% 0 0% ▪ Optimizing approach based on some key Other 6 6 0 0 0% 0 0% learnings Total 599 162 192 245 41% 102 17% – Taking longer than expected – ~2 hours per antenna on average – Navigating overnight and narrow maintenance windows – Trying to minimize last minute cancels / reschedules – Ensuring our antenna information is accurate © Intelsat 2020 | Confidential & Proprietary 10
Intelsat Phase 1 Filtering Scope Wesco (Broadcasters, other non-MVPDs) ▪ 348 sites ▪ 34 crews assigned by State USSI Global (MVPDs, Large Teleports) ▪ 133 sites (114 shared w/ SES) ▪ 17 crews, 23 USSI Field Engineers positioned throughout CONUS ATCi (Simulsat sites) ▪ 54 sites (majority shared w/ SES) ▪ 4 crews assigned by region Self-Installs (58 sites) Other Vendors (6 sites) © Intelsat 2020 | Confidential & Proprietary 11
Appendix © Intelsat 2020 | Confidential & Proprietary 12
Phase 1 city list © Intelsat 2020 | Confidential & Proprietary 13

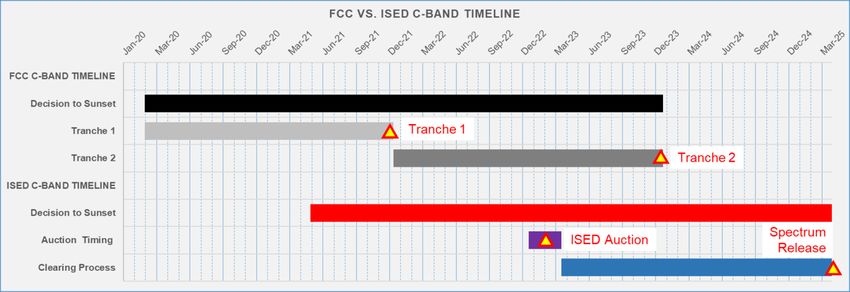

Key milestones Milestone Date Milestone action 24 March 2020 Clearinghouse search committee first convenes 29 May 2020 Satellite operators file Accelerated Relocation Election 05 June 2020 Public Notice if 80% clearing super-majority met (if so – relocation coordinator committee is formed) 12 June 2020 Satellite operators file transition plans 13 July 2020 Window for stakeholder comments closes (on transition plans) 31 July 2020 Clearinghouse & Relocation Coordinator search committees announce choice (or alternate process) 14 Aug 2020 Satellite operators submit revisions to transition plans 08 Dec 2020 Auction begins 05 Dec 2021 Accelerated phase 1 deadline: 3700-3820 to be cleared in 46 top PEAs* 05 Dec 2023 Accelerated phase 2 deadline: 3700-4000 to be clear nationally 05 Dec 2025 Sunset of all FSS protection for 3700-4000 © Intelsat 2020 | Confidential & Proprietary 14
Who’s who in the zoo – Intelsat’s vendors USSI (primarily MVPDs; most IRD shipments) Wesco (primarily non-MVPDs) ATCi (Simulsats) Harmonic (TBD) RSM (relocation coordinator) Outreach Equipment Scheduling Installation Oversight Shipments © Intelsat 2020 | Confidential & Proprietary 15
