2021 FORWARD LOOKING ATTACHMENT O
 CUSTOMER MEETING

Wednesday, October 28, 2020
2021 FORWARD LOOKING ATTACHMENT O - CUSTOMER MEETING - Wednesday, October 28, 2020 - OATi ...
AGENDA

• Meeting Purpose

• Otter Tail Power Company Profile

• Attachment O Calculation

• Capital Projects

• Budget Risks

• Question/Answer

                                     2
2021 FORWARD LOOKING ATTACHMENT O - CUSTOMER MEETING - Wednesday, October 28, 2020 - OATi ...
LEGAL DISCLOSURE

      All numeric data provided in this presentation is preliminary
                         and subject to change.

                                                                      3
2021 FORWARD LOOKING ATTACHMENT O - CUSTOMER MEETING - Wednesday, October 28, 2020 - OATi ...
MEETING PURPOSE

• To provide an information forum regarding Otter Tail’s forecasted
  Attachment O for 2021.

• The forecasted Attachment O for 2021 is calculated using the FERC Form 1
  Attachment O template under the MISO Tariff with a projected net
  revenue requirement and projected load.

• Rates will become effective on January 1, 2021 for the joint pricing zone.

                                                                               4
2021 FORWARD LOOKING ATTACHMENT O - CUSTOMER MEETING - Wednesday, October 28, 2020 - OATi ...
OTTER TAIL POWER COMPANY PROFILE

                                   5
2021 FORWARD LOOKING ATTACHMENT O - CUSTOMER MEETING - Wednesday, October 28, 2020 - OATi ...

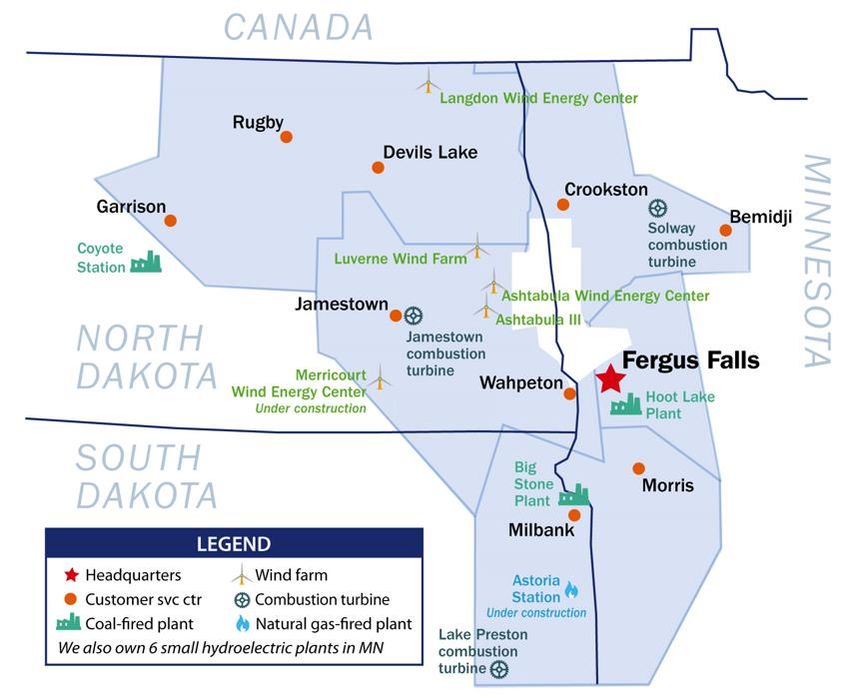

WHO WE SERVE

               6
2021 FORWARD LOOKING ATTACHMENT O - CUSTOMER MEETING - Wednesday, October 28, 2020 - OATi ...
OUR MISSION

  To produce and deliver electricity as
  reliably, economically, and environmentally
  responsibly as possible to the balanced benefit
  of customers, shareholders, and employees
  and to improve the quality of life
  in the areas in which we do business
                                            .

                                                    7
OUR VISION

  Growth and success—for our company
  and the rural communities we serve.
  We collaborate and prosper through
  responsible, resourceful action. We balance
  community, economic, and environmental
  commitments. Always.

                                                8
OUR VALUES

             INTEGRITY                             COMMUNITY
             We conduct business responsibly and   We care about the people and
             honestly.                             places we serve and improve the
                                                   quality of life in the areas
             SAFETY                                in which we do business.
             We provide safe workplaces and
             require safe work practices.          RESOURCEFULNESS
                                                   We draw on the ingenuity and
             CUSTOMER FOCUS                        expertise of various resources
             We provide reliable electricity and   to create strategic, balanced,
             timely, courteous customer service.   practical plans.

                                                                                     9
ATTACHMENT O CALCULATION

                           10
FORWARD LOOKING ATTACHMENT O

• Forward Looking Rate Requirements

• Rate Base

• Operating Expenses

• Revenue Requirement and Rate

• Network Rate Summary

                                      11
RATE REQUIREMENTS

                      Actual                                               Forward Looking

•    By June 1 of each year, Otter Tail will post on      •    By September 1 of each year, Otter Tail will
     OASIS all information regarding any                       post on OASIS its projected Net Revenue
     Attachment O True-up Adjustments for the                  Requirement, including the True-Up
     prior year.                                               Adjustment and load for the upcoming year,
•    By September 1 of each year, Otter Tail will              and associated work papers.
     hold a customer meeting to explain its Actual        •    A customer meeting will be held by October
     Year True-up Calculation.                                 31 of each year to explain its forward looking
     •   Ex. 2021 Forward Looking Attachment O will            formula rate input projections and cost detail.
         be trued-up by June 1, 2022 with a
         corresponding Customer Meeting to be held
         by September 1, 2022.

                     The MISO Transmission Owners will hold a Joint Informational Meeting on
                           Regional Cost Shared Projects by November 1 of each year.
                                                                                                                 12
RATE BASE

            13
OPERATING EXPENSES

                     14
REVENUE REQUIREMENT AND RATE

                               15
RATE SUMMARY

               16
TOTAL TRANSMISSION REVENUE REQUIREMENT BREAKDOWN

                        Total Rev. Req. =
                          $70,514,803

                          Attch. GG Rev.           Attch. MM Rev.
Net Attch. O ATRR =
  $32,739,563                 Req. =                   Req. =
                           $14,217,718              $23,557,522

                                                                    17
2019 TRANSMISSION PROJECTS

                             18
ATTACHMENT O: TRANSMISSION PROJECTS (1 OF 2)

Attachment O Project               Voltage       In-Service   2021 Projected Spend   Description of Project
                                                    Date          (w/o AFUDC)

Transmission Line Improvements   41.6 – 345 kV     Varied         $4,824,000         Upgrade, repair, replace or move existing facilities along
                                                                                     transmission lines due to age, condition or access issues.
Substation Facility              41.6 – 345 kV     Varied         $1,380,000         Upgrade, repair or replace existing substation facilities due to
Improvements                                                                         age or condition issues.
Finley – McVille Line Rebuild      41.6 kV       12/20/2021        $940,000          Rebuild existing 41.6 kV line with new framing that includes a
                                                                                     shield wire to improve reliability.
Bartlett – Doyon Line Rebuild      41.6 kV       12/20/2021        $950,000          Rebuild existing 41.6 kV line with new framing that includes a
                                                                                     shield wire to improve reliability.
Turtle Lake – Mercer Line          41.6 kV       11/30/2021        $570,000          Rebuild existing 41.6 kV line with new framing that includes a
Rebuild                                                                              shield wire to improve reliability.
Winger 230/115 kV Transformer       230 kV       11/30/2023        $350,000          Add a second 230/115 kV transformer at Winger to support
#2                                                                                   NW MN 115 kV system.
Winger Substation – Replace         115 kV       11/1/2021         $200,000          Replace breaker disconnect switches at Winger Substation on
Disconnects                                                                          the Plummer 115 kV line.
Plummer Pipeline Tap – Replace      115 kV       11/30/2021        $200,000          Replace limiting line switch at Plummer Pipeline Tap on
Switch                                                                               Winger 115 kV line.

                                                                                                                                                        19
ATTACHMENT O: TRANSMISSION PROJECTS (2 OF 2)

Attachment O Project            Voltage   Projected In-   2021 Projected Spend   Description of Project
                                          Service Date        (w/o AFUDC)

Erie Substation                 230 kV     5/1/2023             $10,000          Construct a new 230/115 kV Substation along the Audubon –
                                                                                 Hubbard 230 kV line in coordination with new Erie – Frazee
                                                                                 115 kV line.
New Effington Substation        230 kV     2/22/2021           $132,500          Construct new 230/41.6 kV Substation along Browns Valley –
                                                                                 Hankinson 230 kV line.
Grant County – Norcross Line    115 kV     8/1/2021           $1,691,680         Construct a new 115 kV line from Grant County to Norcross
with Norcross Substation                                                         with a new Norcross 115/41.6 kV Substation.
Hoot Lake Capacitors            115 kV     9/15/2021           $750,000          Install 2 x 25 MVAR capacitor banks on 115 kV system at Hoot
                                                                                 Lake.
New Jamestown                   41.6 kV   11/30/2021           $400,000          Create a new 41.6 kV interconnection with Central Power
interconnection with CPEC                                                        Electric Cooperative (CPEC) near Jamestown Pipestem.
Lake Norden Area Transmission   115 kV     6/30/2021          $7,098,204         Construct new 115 kV line from Astoria to Lake Norden with a
Project                                                                          new Toronto North 115 kV switching station.
J302/J503 Ellendale –           230 kV     1/22/2021          $1,267,903         Upgrade the Ellendale – Oakes – Forman – Hankinson 230 kV
Hankinson Line Upgrade                                                           line to a higher rating due to J302/J503 wind farm.

                                                                                                                                                20
ATTACHMENT GG / MM: TRANSMISSION PROJECTS

Attachment GG Project             Voltage   Projected In-   2021 Projected Spend   Description of Project
                                            Service Date        (w/o AFUDC)

Attachment MM Project             Voltage   Projected In-   2021 Projected Spend   Description of Project
                                            Service Date        (w/o AFUDC)
Big Stone South – Ellendale 345   345 kV     2/4/2019             $13,000          Project closeout activities.
kV Project

                                                                                                                  21
BUDGET RISKS

               Demand/
    Revenue              Regulatory Filings
               Weather

                         Timing of Capital
   Financing   Outages
                             Projects

                                              22
QUESTIONS?

                 If you have any additional questions after the meeting,
                               please submit via e-mail to:
                                MISO_rates@otpco.com
        All questions and answers will be distributed by e-mail to all attendees.
      Additionally, the questions and answers will be posted on Otter Tail’s OASIS
      website (http://www.oasis.oati.com/OTP/index.html) within two weeks from
                                   the date of inquiry.

                                                                                     23
