Agenda • Committee Introduction • Current Golf Cart Paths • History of Golf Cart Paths • What We Have Heard & Where Are We • Project Detail & Cost • Bidding Process and Contractor Selection • Funding the Project • Summary • Next Steps Executive Summary 2
Golf Cart Path Renovation Committee • Keith Aspray • Ted Barber • Ted Bartlett • George Beck • Doug Douglas (DIOA Liaison) • Bill Fox • Brian Hollingsworth • Dutchy Lewis • Noel Mears • David Muehl • Lori Murdaugh • Mike Sullivan DIC Board Chartered – First Meeting March 8, 2017 Executive Summary 3
What is the Problem? • 12 miles of asphalt golf cart paths which are an integral part of a key DIC member owned asset: – Used for managing golf cart traffic on the 2 golf courses (50% member participation) – Used for recreational purposes (sightseeing, walking, jogging, biking) during non-golfing hours • The golf cart paths are failing at an accelerating rate • Continued deterioration is detrimental to the golf courses and the community as a whole Renovate a Valuable DIC Member Asset Executive Summary 4
Goals of the Golf Cart Path Project If the golf cart paths are renovated, the project must: • Create a member friendly solution that is safe, value added and attractive • Effectively route paths to remove unnecessary curves and under utilized paths • Identify & install cost effective paths that are low maintenance • Utilize a material that is durable and cost effective with long useful life 7 Options Developed and Extensively Reviewed Executive Summary 5
History of Golf Cart Paths • Original 12 miles of asphalt paths constructed in 1985 & 1991 • Current paths are 32 & 26 years of age • Golf Course Builders Association: Asphalt path life expectancy is 15 years • 2011 & 2012 significant repairs made to paths to extend useful life during course renovations – Plan was to rebuild the paths during the golf course renovations, but loan requirements stopped the project – A 2nd effort in 2015 to renovate the paths was put on hold as the outdoor pool project was given top priority • Paths have reached their useful engineered life and must be renovated – they are beyond repair Executive Summary 10

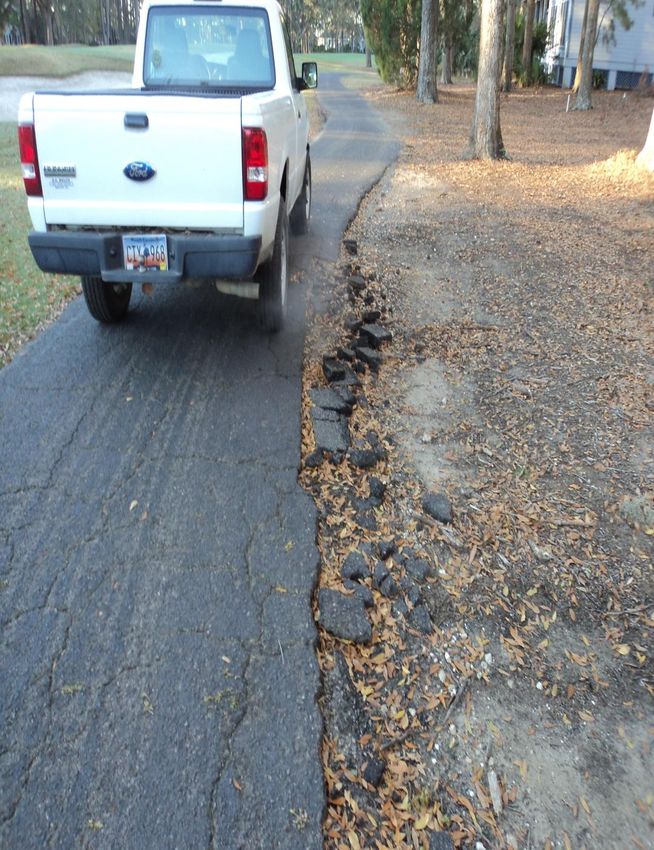

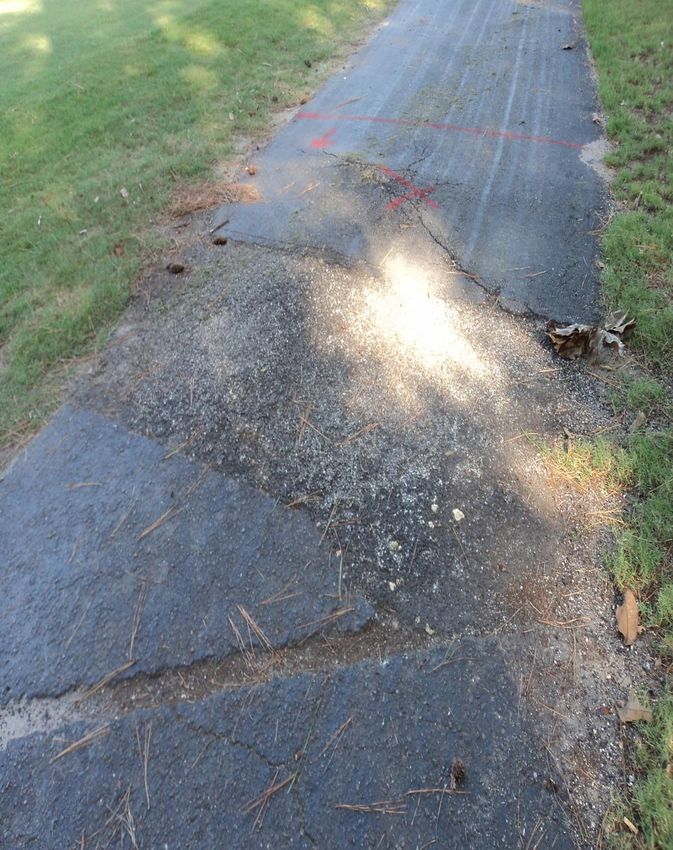

History of Golf Cart Paths • Substantial repairs made in 2011 - $246,000 • Asphalt sealant applied in 2012 to extend life 5-7 years - $48,000 • 2017 budget for patching/repairs is $10,000 and has been deferred • Issues today: Pot holes, cracking, drainage, crumbled edging, smoothness and root damage • Current repairs are a temporary solution with full renovation as the long term solution Executive Summary 11
What We Have Heard and Where We Are 12
What We Have Heard & Where We Are • 7 materials options, pros & cons, costs reviewed with 110+ Focus Group participants (May/June 2017) – Do nothing (maintenance/patch mode) – Partial concrete/asphalt with “scatter” – Crushed shell/sand mixture/stone – Partial concrete with crushed shell/sand mixture – Polypavement, Flexipave, etc. (pervious materials) – Asphalt (total replacement) – Concrete (total replacement) • Emails from Members with options to consider 32% of Focus Group Participants – Non Golfers Executive Summary 13
What We Have Heard & Where We Are Estimated Cost Summary Presented @ Focus Groups • Do nothing/patching - $300 k per year for 3- 5 years: Total $1.5 M • Partial concrete & scatter $1.7 – $1.95 M • Crushed shell/sand: $1.7 - $1.9 M • Partial concrete with shell/sand: $2.1 – $2.3 M • Polypavement, Flexipave: $2.5 - $3.3 M • Asphalt – Total Replace: $2.2 – $2.8 M • Concrete – Total Replace: $2.3 – $2.9 M Focus Groups - 81% Favored Total Concrete – 12% Asphalt Executive Summary 14
What We Have Heard & Where We Are • 3 funding options developed and presented – A: $5/month dues increase (10 years); balance from allocated reserve funds – B: One-Time $600 assessment; balance from allocated reserved funds – C: $300/year dues increase (10 years); remaining balance from reserves 65% Favored Option A 22% Favored Option B Executive Summary 15
Other Factors Considered • 30 clubs in the area were surveyed and 78% have concrete/asphalt paths • 4 clubs visited with various materials used for paths Callawassie - Asphalt Berkeley Hall - Concrete Long Cove – Overlay Asphalt Colleton River – Concrete with shell/sand mix • Superintendents were questioned regarding best material for maintenance and longevity – concrete preferred Direction Chosen – Bid Total Asphalt and Concrete Replacement Executive Summary 16
Request for Proposals and Bidding Process REQUEST FOR PROPOSAL (RFP) • Request for Proposals DATAW ISLAND CLUB CART PATH RENOVATION PROJECT (RFP’s) were developed for the formal bidding process • Concrete and asphalt DATAW ISLAND CLUB 100 CLUB DRIVE were bid DATAW ISLAND , SC 29920 • 4 National Golf Course 8/1/2017 Renovation and Cart Path TABLE OF CONTENTS companies bid the project 1. SUMMARY AND BACKGROUND ............................................................................................. 2 • Bids were submitted 2. PROPOSAL GUIDELINES......................................................................................................... 2 3. PROJECT PURPOSE AND DESCRIPTION ................................................................................... 3 October 1 4. 5. PROJECT SCOPE..................................................................................................................... 4 REQUEST FOR PROPOSAL AND PROJECT TIMELINE................................................................ 5 • Negotiated with 2 lead 6. BUDGET ................................................................................................................................ 5 7. BIDDER QUALIFICATIONS ..................................................................................................... 6 bidders – reduced project 8. PROPOSAL EVALUATION CRITERIA ....................................................................................... 6 cost Executive Summary 17
Tree Strategy • Golf Course design guidelines – tree removal within 5 feet of path • Project guidelines – remove only hazardous or encroaching – all potential trees not removed • Certified Arborist reviewed all trees for disease and hazards (stress cracks, leaning, trip hazard, utility encroachment) • Goal is to protect the future path work from long term root damage • Ongoing root pruning will be required due to limited tree removal Staff, Path Committee, County and Certified Arborist Engaged Executive in Process Summary 18

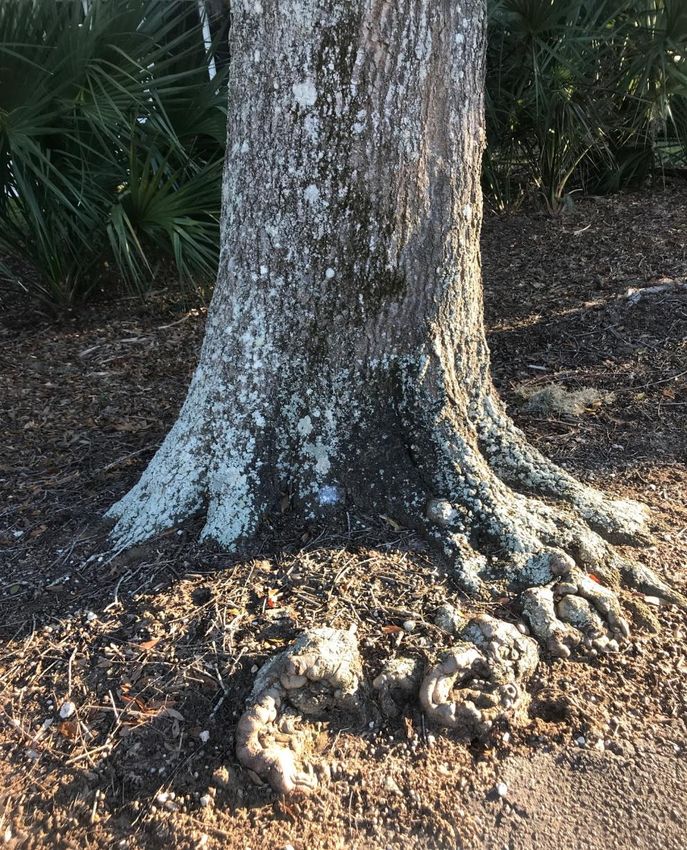

Tree Strategy • Tree Survey: 146 Trees significantly impacting cart paths: – No Live Oaks to be impacted – Pines: 95 trees causing major path issues • 44 hazardous/51 healthy – Laurel/Water Oaks: 44 causing major path issues • 38 hazardous/6 near end of life – Balance: 7 other types (Sweet Gum) – Limited tree removal – future damage is possible • Aggressive root pruning to mitigate future problems 146 Trees for Potential Removal – Review Continues Executive Summary 19
Tree Examples Executive Summary 20
Project Execution and Timeline • Project start date: August 6, 2018 • Completion date: December 31, 2018 • Process begins with old path incorporation • Grading and drainage improvements • New concrete paths formed and installed • Sod installed as each hole is complete • 3-5 holes closed to play to accommodate work • Any tree work to begin prior to construction Executive Summary 21
Bid Results and Project Cost Executive Summary 22
Bid Results Contractor Landscapes Environmental Southeastern Bennett Pricing-Items Unlimited Solutions Paving Mobilization $220,000 $10,000 $30,000 $7,875 Cart Path Work $1,689,877 $2,295,506 $2,240,554 $3,239,958 Sod $342,000 $67,162 $107,000 $335,916 Drainage $76,005 $64,176 Not included Not included Root Pruning $37,500 $15,400 Not included Not included Testing included $35,000 Not included Not included Total-Concrete $2,365,382 $2,487,244 $2,377,554 $3,556,748 Landscapes Diseased Trees Unlimited $133,415 Bid is Not$133,415 $133,415 to Exceed (NTE) $133,415 County Mitigation $41,020 $41,020 $41,020 $41,020 Fill Dirt $57,600 $57,600 $57,600 $57,600 Contingency $150,000 $150,000 $150,000 $150,000 Total-Concrete $2,747,417 $2,869,279 $2,760,589 $3,938,783 Total-Asphalt $2,823,150 $3,916,818 Not Bid $3,461,830 DIC Board Recommends Project with Landscapes Unlimited as Preferred Contractor 23
Landscapes Unlimited • Golf course construction and renovation • Lincoln, Nebraska based: 41 Years in business • Completed over 1800 golf course projects with a value of $2.5 billion • Constructed 250 new golf courses which included path systems • “The Cart Path Company” – subcontractor for concrete path system • Recent local projects: The Landings - Skidaway Island, GA; The Oaks – Osprey, FL; Quail West – Bonita Springs, FL; The Atlanta Athletic Club – Johns Creek, GA Executive Summary 24
Landscapes Unlimited Projects Fiddlesticks Country Club Fort Myers, FL TheCounty Broadmoor WalkerClub Course Clemson, Colorado SC CO Springs, The Reserve at Lake Keowee Sunset, SC Sea Dallas Pines Country Executive Summary Club Dallas, TX National Hilton Head, TX SC Sandy Lane Resort St. James, AL 25
Project Funding Executive Summary 26
Definitions Settlement funds • When Alcoa (developer) turned assets over to Dataw Island Club members, the exit settlement awarded to the DIC was close to $5 million dollars. Approx. $4 million in cash plus the sales center building. Use of Settlement Funds • When Alcoa departed, the Club was operating at an annual loss of close to $500,000. The Club uses the Alcoa settlement funds to subsidize dues and cover the operating loss. These funds are only used to offset operating shortfalls and are not used for capital projects or renovations. 27
Definitions DIC Reserve Funds • $13,500 of the $17,500 initiation fee and a portion of Base membership dues are allocated to the DIC reserve fund. These funds are used for Capital improvements and the long term renovation and renewal of DIC assets. On average we spend $750,000 per year on capital improvements to DIC assets. The 2017 year end reserve balance is projected to be $2,362,000. 28
Definitions One Island Concept • All resident members as of June 2001 are club members. • Club members own all of the assets of the Club • All sports amenity facilities and assets are owned by the members even if not participating in a sports package • DIC Bylaws state all assessments are borne equally by all club resident members. • Long term maintenance and upgrading of club facilities adds value to real estate on the island and provides a competitive advantage • Country Club members cannot be assessed since the memberships are callable and they do not own the assets 29
How Do We Fund the Project? Concept • Provide viable financing options for completion of cart path renovation/replacement project • Use a portion of current & future reserve contributions to service a loan. Reallocates what we currently put into Reserves from Base dues Minimize the financial impact to members 30
How Do We Fund the Project? Actions to date • In 2014 we began allocating a larger portion of Base dues to Reserves for future capital projects. • New membership plan & long range budget originally projected approx. $20/month of base dues allocated to Reserves, however, the allocation was increased to $34/mo in 2016 and $36/mo in 2017. 31
How Do We Fund the Project? Basic Data Assumes Cart Part Project Cost of: $2,750,000 Borrow @4-5% for 10 years $2,000,000 Use from Current Reserves $ 750,000 Total Funding $2,750,000 15 Year Amortization / 10 year estimated payoff - Loan paid off by year-end 2027 32
How Do We Fund the Project $5/month member assessment • 2018 Base Dues allocation to reserves increased to $40/month/member – $20/month to Reserves based on original projections – $20/month to loan repayment • Continue to increase Base Dues @ the Taskforce recommended rate of 5% until DIC operates at breakeven • $5/month/member additional base dues assessment ($60/year) which goes directly to loan repayment 33
How Do We Fund the Project Monthly Base Dues 2017 2018 Base Dues $317 $333 $5/mo Assessment $ 0 $ 5 Total Base Dues $317 $338 • $5/month assessment continues for 10 years • $60/year = $600 over 10 years 34
How Do We Fund the Project Bottom Line Impact • Negligible as the Base dues to Operations does not change from the original plan • Reserve Balance by year end 2027 is projected to be approx. $3.5 to $4 M when Cart Path loan is paid off • Other Capital Projects not impacted and we are still maintaining a reserve balance above the original 10 year plan 35
Summary 36
Summary • DIC Board and Committee Recommending Project Approval – Replace current paths with concrete (cost effectiveness) – Project start date of August 6, 2018 – ~5 month project completion with rolling hole closures – Investment protection: drainage improvements & limited tree removal – Budgeted cost of $2.75 M; Project is in Price Range Expected – Funding: • Bank loan of $2 M at 4-5% for 10 years • Balance of project cost from Reserves • Dues increases of $5/month/member for 10 years ($60/year) Replacement of a Valuable Asset 37
What’s Next? • Committee will work with LU to further value engineer the project (costs and benefits) • Tree canopy review continues requiring county’s feedback (balance asset protection and island’s beauty) • Final review with DIC Board in January 2018 • Ballots to be mailed to DIC Members in January 2018 – Annual DIC Meeting February 2018 – For project to proceed requires >50% approval from voting members The DIC Board supports this project and recommends that members Vote Yes Thank Executive You for Your Summary Support and Attention 38
Questions Questions: cartpathproject@islc.net 39
