CONTEXT Skills shortages across all infrastructure sectors are putting at risk the National Infrastructure Plan – cost and schedule. Skills are not an end in their own right but one of the drivers of productivity Government has announced: - a productivity plan where skills is one of the principal drivers - a target of 3m apprenticeships - a levy to help pay for this - 30,000 transport apprentices - DfT transport skills strategy - RSG leading ‘sector strategy’ (productivity) DfT, organisations and individual business all recognise and are addressing the skills shortages. A s tro n g c ollective re s p o n s e will require co-ordination and support. Not just engineering skills.
Update summary Skills forecasting underway at national and now company level What does this mean for me? Strategic workforce planning eg route • Have I got a clue about Procurement changes what my workforce looks like in 5 years? Sector deal • How can I prove I will be productive? Productivity scorecard and pilots • How do I know if I am Wider economic impact - treasury ticking the right boxes at tendering? Apprenticeship levy, service and • Am I influencing the right forecasts things/people?
Today’s Workforce (1) – Population of 219,000 Gender imbalance is decreasing, from approximately 4% in rail engineering four years ago, the figure is now closer to 10%. More needs to be done though. Operations figures contain all TOCs. There are more staff at Level C than B, indicating multiple management layers STAT Slides v2 -‐ December 2016 5

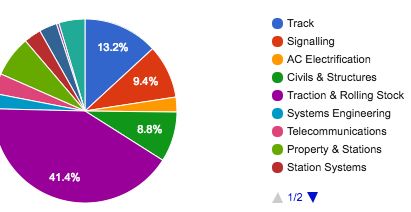

Investment Plans (2) These charts show total planned investment until end of CP8 depicted over time, then proportions of investment by organisation, work type and asset. DfT is Rolling Stock STAT Slides v2 -‐ December 2016 6
Future Workforce : Outputs (5) : 2020 = 202,770; and 2024 = 180,426 Charts showing the total predicted workforce for 2020 (b) and 2024 (c) compared to today’s workforce (a) presented proportionally by Skill level. STAT Slides v2 -‐ December 2016 7
Future Workforce (5) 10196 South West - 2020 South West - 2024 9490 Wales - 2020 4021 Wales - 2024 Midlands - 2020 3699 Midlands - 2024 23241 North of England - 2020 21677 North of England - 2024 London & South East - 2020 25776 London & South East - 2024 24511 Scotland - 2020 Scotland - 2024 111346 (blank) - 2020 96269 (blank) - 2024 12112 0 10000 11608 20000 30000 40000 50000 60000 70000 80000 90000 100000110000120000 16217 13298 A - Operative / Technician B - Advanced / Higher Technician / Supervisor C - Professional / Manager / Engineer D - Executive Graph showing the future workforce required in 2020 & 2024 shown by skill level proportions per region. Notable are the ‘(blank)’ entrants that refer to Traction & Rolling Stock workers so therefore cannot be assigned a region. STAT Slides v2 -‐ December 2016 8
Construction unlike Transport & Storage has failed to return to trend productivity suggesting over capacity Construction Transport & Storage Construction GVA (£Bn) Actual vs Extrapolation Transport & Storage GVA (£Bn) Actual vs Extrapolation 160 80 140 70 120 60 100 50 80 40 60 30 40 20 20 10 0 0 Jan 00 Jan 01 Jan 02 Jan 03 Jan 04 Jan 05 Jan 06 Jan 07 Jan 08 Jan 09 Jan 10 Jan 11 Jan 12 Jan 13 Jan 00 Jan 01 Jan 02 Jan 03 Jan 04 Jan 05 Jan 06 Jan 07 Jan 08 Jan 09 Jan 10 Jan 11 Jan 12 Jan 13
There is evidence of significant wage inflation in rail construction; a significant contrast with construction as a whole. This would be unlikely to occur if sufficient, trained resource was available. Avg Employee Cost Notes: 90.00 • In the construction sector overall the cost per 80.00 worker only went up by 5% between 2008 70.00 and 2014. 60.00 • In rail construction the average employee 50.00 cost rose by 85% over this same timeframe. 40.00 • This could be due to a lack of skills planning 30.00 (so demand exceeding supply and driving up 20.00 wages) or due to outsourcing the lowest cost 10.00 2008 roles (thereby shifting up the average). 0.00 • If it were due to outsourcing lower cost roles 2014 we would expect the margin to increase, as no organization would outsource low cost roles so that they cost more. • All things being equal, if the employee cost had stayed flat, the productivity uplift (ie the efficiency component) would only have been 15% in Rail.
The study suggests that there are opportunities to avoid significant (10-‐30%) over-‐run capital costs and deliver (10-‐40%) efficiencies £300 Billion of Infrastructure Spend 50%-‐60% Optimally Excess Efficiencies Missed Spent Costs A: Avoid the cost of conflict and the cost of poor capability and create an environment for efficiency B: Avoid the costs of skills shortages C: Stop restarting the learning curve on people, processes, products, contracts and technology D: Take the right risks and stop paying for excessive design redundancy and unrealistic risk transfer E: Use “digital / don’t build” to get the outcome without concrete F: Use our scale for robust asset data, manufacturing, R&D and asset standards 12
C: Stop restarting the learning curve on people, processes, products, contracts and technology “We actually had “negative certainty” we all 20%-‐40%+ knew [department] would cancel the project but they and the minister were refusing to Value blink … so £100m was wasted.” It was “their 10-‐20% risk” [the supply chain’s] but that money still needs to be recovered somewhere .” 5-‐10% “It is like turning up on the station every day Timeframe 0-‐18 18-‐36 36-‐48 48+ and demanding the cheapest single … when People Team Dynamics Workforce leveling, Long term career Culture change you could have just bought a season ticket Training development and saved a boatload.” Processes Explicit method Documented Continuous process ISO standards for reuse processes improvement continuous delivery “I remember building 5 terminals in Azerbaijan to exactly the same standard. It Designs Design templates Repeat building Standard Assets DfMA was hard work avoiding changes but the fifth same asset Asset Standards came in 30% under budget.” Contracts Heavy lifting to Reuse / extend Small changes Repeatable document intent same framework standard call off Technology Project tools and Automated design Whole life asset Digital replicas of templates and reporting management assets Resourcing Consultants, contractors & sub Employees, trainees and long term-‐ contracts supplier relationships and talent development 13
F: Use our scale for robust asset data, manufacturing, R&D and asset standards Picture 1 Picture 1 Picture 1 Picture 1 Typ. % Maturity Level Lever Impact 0 Level 1 – Initial 2 Level 3 -‐ Developing 4 Level 5 -‐ Mature More than 50% of asset There is a national set of standard asset The QMS is well established and the supply Standard value is procured from a components and more than 50% of asset value is chain is building compliant products that are Assets & 10%-‐30% set of regional standard spent on these items. There is a Quality designed, assembled and commissioned DfMA assets (above the base Management System and Product Management efficiently. component level) System in place. Periodic attempts to The value of asset data is defined and asset data Collection of asset data is embedded in the systematically collect is systematically collected and asset data quality organisation’s processes. The data quality is Asset Data 10%-‐20% asset data for projects. is defined. assured and the organisation is confident to act on the basis of asset data. The expected value is being delivered. Asset Standards are Asset Standards are “delayered” to provide a “Principle based” asset standards are in Asset systematically collated for single coherent reference with no inconsistency place where designers have the mandate to 5-‐10% Standards asset types for major asset types innovate to provide same outcomes with different approaches. Regional or local National sharing of R&D results or national R&D shared nationally, with portfolio of innovation focused on 1-‐3 portfolio or national integration with horizon 3 horizon 1 (1-‐3yr) and horizon 2 (3-‐5yr) R&D 5-‐10% year horizon with results (5yr+) innovation research targets. Tight integration with shared locally sources of horizon 3 (5yr+) innovation. 14
C: Policy vs Reality: The erosion of the investment time horizon A Policy certainty
Future Alignment of skills and other rsg strands into scorecard • How do we backfill after brexit? Strategic workforce planning at • How do we get 20% project level productivity gains in 5 years? Procurement changes • Is 2.5% apprenticeships in the workforce enough? Sector deal • Is it 50/50 upskilling / new right? Productivity scorecard and pilots • How can tier 1s help their supply chain? Wider economic impact - treasury • How can I use nsar connect? Social inclusion and brexit
