Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
Tampere is building
their first tram ever
Pekka Sirviö, CEO, Tampere Tramway Ltd.
October 24, 2018
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
Contents

1. Project
2. Rolling stock
3. Tramline infrastructure
4. Future plans
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
Project
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden

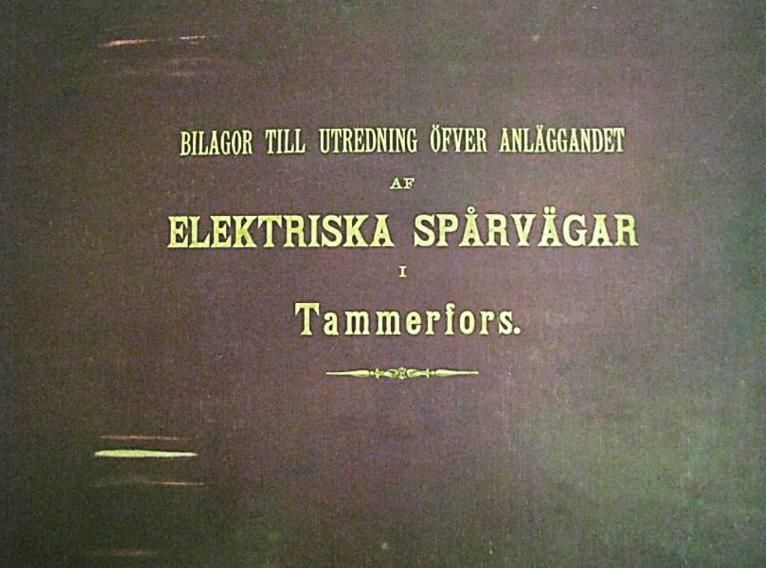

First plans already in 1907
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden

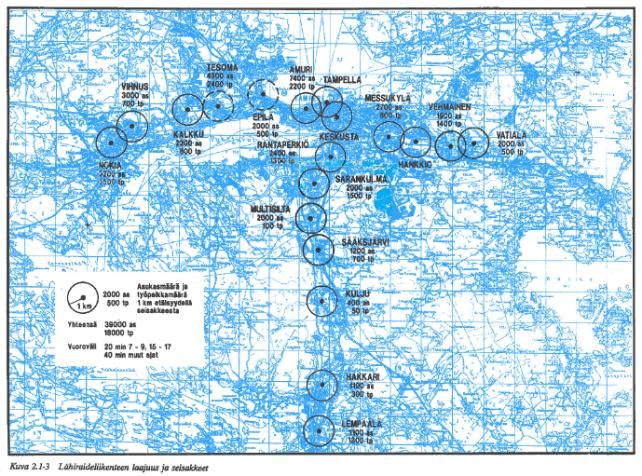

Studies and plans from the 1980’s until
the 2000’s

            The plan of commuter train network        The plan of street based tramway system
            between Tampere and neighbouring towns.   from western parts of city to the city centre
                                                      and onwards to Hervanta in the south.
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
City Council’s approval in November 2016

  41 YES

  25 NO

  1 BLANK
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
Objectives

• Smoother everyday life for          Growing city of Tampere
  everyone                            • Population in 2017: 231 900
• Supports city development and       • Population in 2025: ~249 000
  growth                              • Population in 2040: ~277 000
• Creates vitality and co-operation
• Promotes sustainable                Tramway passengers
  development                         • 2025: 55 000 passengers / day
• Economically viable investment      • 2040: 110 000 passengers / day
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
First tram in

     Project timeline                                                             Tampere, test
                                                                                   drives begin

                      The City Council               The design                                   Tramway                          Tramway
General plan          votes in favour of             of the trams                            traffic begins on                 traffic begins on
is approved             construction                   decided                                   1st phase                         2nd phase

  2014         2015          2016          2017             2018         2019         2020            2021       2022   2023         2024

                                                                   1:1 scale mock-up
           Planning on 1st          Construction on   1st              to Tampre
            phase begins              phase begins                               The City Council
                                    Supply contract for                           votes for the 2nd
                                          trams                                        phase

                                                  Busiest construction                        Construction on
                                                   year in 1st phase                          2nd phase begins
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
Alliance organisation                                          CLIENT
• City of Tampere
     •   Political decision making, development of urban
         environment, public transport

• Tampere Tramway Ltd.
     •   Funds, owns and maintains the trams, tracks and the
         depot. 100 % owned by the City of Tampere.

• VR Track Ltd.
     •   50 % of planning
     •   50 % of construction

• YIT Rakennus Ltd.
     •   50 % of construction

• Pöyry Finland Ltd.
     •   50 % of planning

                                                               Tramway
                                                               operator
Tampere is building their first tram ever - Pekka Sirviö, CEO, Tampere Tramway Ltd. October 24, 2018 - InformNorden
Rolling stock
Rolling stock
• 19 trams                                  • Deliveries in 2020-2021
• ForCity Smart Artic X34                   • Design by Idis Design Ltd.
• Manufactured by Škoda Transtech Ltd. in   • Colour decided on a public vote in
  Kajaani                                     September 2018
Main technical features

•   Length: 37,3 m    •   Operation voltage: 750 V
•   Width: 2,65 m     •   Max. speed 80 km/h
•   Height: 3,6 m     •   Max. operational speed 70 km/h
•   Weight: 56,8 t    •   Avg. speed 19-22 km/h
•   264 passengers    •   Output power 560 (8 x 70) kW
Main safety features
•   Passenger safety:
     • safety edges in doors
     • CCTV and emergency phones at exits
     • positioning of handles and stanchions (podesters)
     • emergency exits and extinguishers
     • no steps in the passenger area
     • smooth surfaces
     • non-slippery materials and heated floors
     • automatic light control

•   Driver’s safety:
     • cabin divided from the passenger area by a glass wall
     • safety push button and emergency phone
     • cabin according to DIN 5566, ergonomics defined in
         mock-up
     • crashworthiness according to EN 15227
Main safety features
•   Pedestrian safety:
     • smooth shape in the front part
     • covered windshield vipers
     • minimal gap between the rail and end buffer
     • bogie covers
     • emergency lifting considered in various areas of the
        network

•   Special user groups:
     • contrast colors on doors, floor, stanchions and seats
     • several places for wheel chairs, prams, bikes, etc. with
        fixing points
     • dedicated places for the visually impaired and guide dogs
     • minimal gap between the platform and car at stops,
        stepless access
     • delay function in doors for disabled and prams
Next steps in design

• Interior design
    • Positioning and types of handles and
      stanchions (podesters)
    • Ergonomics of the driver’s cabin and the
      passenger area
• A wooden mock-up tram in Oulu
    • Tested by different user groups
• The mock-up brought to Tampere in 2019
    • Open for public viewing
    • Possible uses in training the drivers
Tramline
infrastructure
1st phase in construction

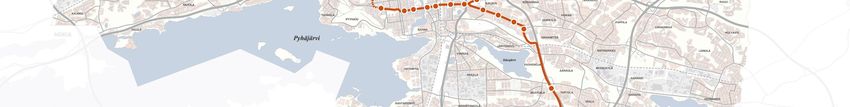

                        Two lines
                           15 km
                         23 stops
                          1 depot
          Construction 2017-2021
              Operation 2021
Two tramlines, simple network

                                                         7,5 min interval

         4 min interval

                                                                                                  Depot

  Stop      Transfer stop   Stop reserves   Mixed-traffic lane   Rail switch
                                                                               7,5 min interval

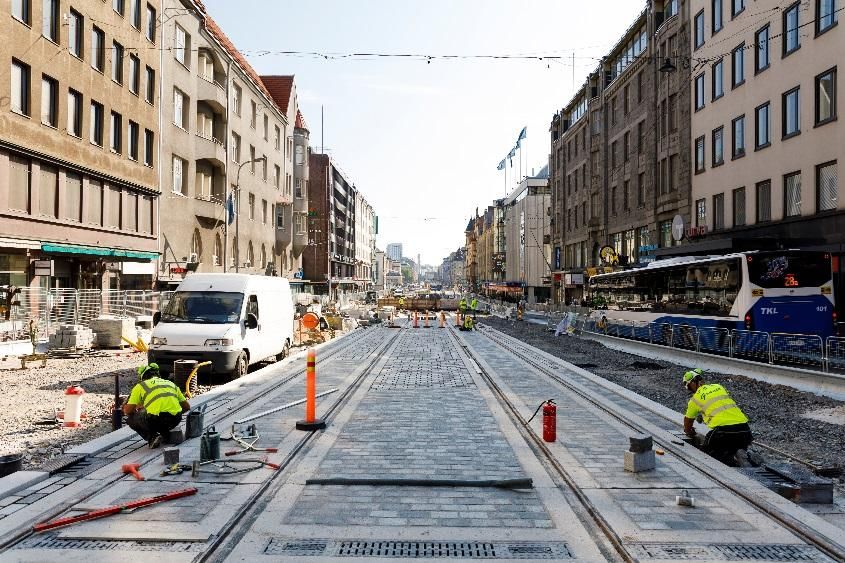

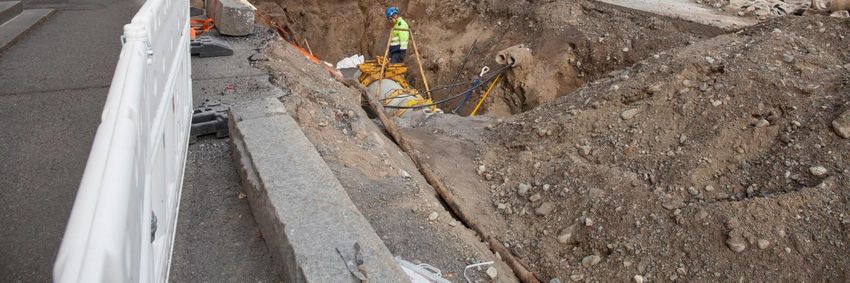

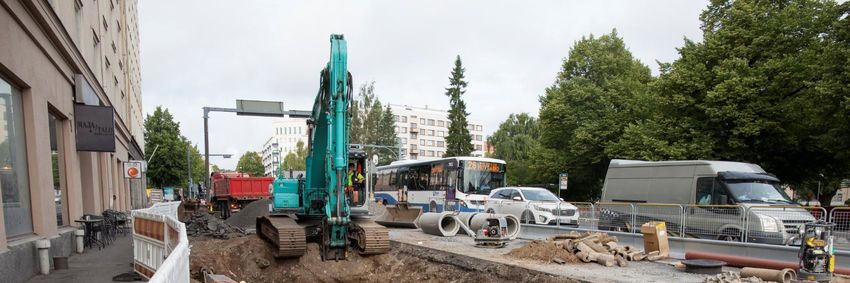

1st phase in construction
• Major construction work is
  done in the heart of the city
    • Plumbing and cable transfers
    • Earthworks and roadwork
      required by the tramline
    • Construction of the tramline and
      the tramline stops
    • Construction of the depot area
      and the power supply stations
    • Construction and alteration work
      of bridges and supporting wall
      structures
    • Technical systems
Depot in Hervanta
• Land area 6,7 hectares
• Three buildings
    • Maintenance hall, including office space
    • Storage hall for 30 cars
    • Power supply station
• Total track length 1 620 m
Future plans
2nd phase in planning

One line extension
~7 km
~10 stops
City Council vote in 2020
Construction 2021-2024
Operation 2024
Long term plans               YLÖJÄRVI
                              2034

• Tampere City Region is                         LENTÄVÄNNIEMI    LINE 1
  the second fastest                             2024             LINE 2
                              TEIVO
  growing region in Finland   2034                                LINE 3

    • Population in 2018:
                                                                       HOSPITAL
      385 000                                                          2021
    • Annual growth                                                                            LAMMINRAHKA
      +4 100 inhabitants                                                                       2040

• First plans to expand the
                                                                                  KOILLISKESKUS
  tramway network along
                                                                                  2030
  the main development
  corridors
                                      PIRKKALA          PARTOLA
                                      2030              2027

                                                                                    HERVANTA
                                                                                    2021
www.tampereenratikka.fi/en
