Region 7 Flood Plan Upper Brazos Regional Flood Planning Group December 3, 2021 - FREESE AND NICHOLS
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Region 7 Flood Plan Upper Brazos Regional Flood Planning Group December 3, 2021 F R E E S E A N D N I C H O L S
December 3rd Meeting Topics 1 S C H E D U L E U P D AT E 2 TA S K 4 : F M E , F M S , F M P P R O C E S S A P P R O VA L 3 TA S K 4 C : I N T E R I M T E C H N I C A L MEMORANDUM 4 TA S K 2 : F L O O D R I S K A N A LY S E S F R E E S E A N D N I C H O L S
Schedule Meeting Proposed Milestone Goals Location December 3 Hybrid Presentation/Discussion: Task 4 FMP, FMS, FME Identification & Process Approval; Task 4C Technical Memo (Approval); Task 2 Future Conditions Process Backup material for review: Task 4A Process Memo; Tech Memo December 16* Hybrid Presentation/Discussion: Task 4C Technical Memo Approval only if needed Backup material for review: Tech Memo January TBD January 7, 2022 Tech Memo to TWDB Task 5 Recommendation process - Need notice to proceed Presentation/Discussion: Task 2 Flood Hazard & Exposure, Task 1 Deliverables Backup Material for review: Task 1 Deliverables February TBD Presentation/Discussion: Task 4C Technical Memo Supplemental Data; Task 4 Needs Analysis and Refined FME, FMP, FMS List Backup Material for review: Task 2 GIS & Maps F R E E S E A N D N I C H O L S
FME – Flood Management Evaluation • Study of a specific, flood-prone area needed to assess flood risk and/or determine whether there are potentially feasible FMSs or FMPs. FMP – Flood Management Project • Project, either structural or non-structural, that has non-zero capital costs or other non- recurring cost and will reduce flood risk, mitigate flood hazards to life or property. FMS – Flood Management Strategy • Plan to reduce flood risk or mitigate flood hazards to life or property. Actions the group would like to identify, evaluate, and recommend that do not qualify as FME or FMP. F R E E S E A N D N I C H O L S
Task 4B: Identify FMEs, FMSs, & FMPs Task 1 (Data) Task 2 (Flood Risk) Task 5 (Recommendations) Task 4 (Identify & Assess) Task 3 (Goals) F R E E S E A N D N I C H O L S
Process for Identifying FME, FMS, FMP Defined Sufficient Needs Program Information Comprised of Yes to Yes FMS Inventory Multiple Implement? Projects? No No Need Evaluated No FME or Studied? Yes No Current Model w/ Yes FMP Details? 7
Recommending FMEs, FMSs, & FMPs Potential Reasons to Not Recommend: • No flood risk reduction Recommend as many • No local sponsor evaluations, strategies, • Misalignment with goal(s) and/or guidance principles and projects as possible • Inappropriate scale that meet the technical • Duplicate projects requirements • Lack of concurrence from impacted entities • Impractical benefit-cost ratio or other metric • Public input • Lack of RFPG consensus F R E E S E A N D N I C H O L S
Task 4A Needs Analysis Most prone to Locations, extent, Prone to flooding flooding that & performance of with inadequate threatens life & policies & inundation maps property infrastructure Existing models, analysis, & flood No H&H models Emergency need risk mitigation plans Already Already identified Historic flooding implemented flood mitigation events flood mitigation projects projects Other relevant factors F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • "HUCs" are standard USGS watershed boundaries • HUC 12 is the local sub-watershed level that captures tributary systems • Each HUC 12 receives a score out of 5 or 3 for each criteria F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • Buildings in the 100-year floodplain Most prone to flooding that threatens life & property F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • Critical facilities in the 100-year floodplain F R E E S E A N D N I C H O L S
City of Lubbock Critical Facility Impacts Case Study: Critical Facilities • 9% of region-wide critical facilities potentially at risk **100-year existing analysis conducted with draft data F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • Agricultural and energy areas in the floodplain F R E E S E A N D N I C H O L S
Hale County Agriculture Impacts Case Study: Agriculture • Only 4% of region’s area exposed to preliminary flood hazard is urban development **100-year existing analysis conducted with draft data F R E E S E A N D N I C H O L S
Hockley County Well Impacts Case Study: Energy • 8% of active oil wells in 100-yr floodplain • Using 2021 RRC Production estimates, one day lost production in Hockley County: ~$162K. **100-year existing analysis conducted with draft data F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • Miles of road in the floodplain F R E E S E A N D N I C H O L S
City of Abilene Roadway Impacts Case Study: Roadways • 8% of region-wide roadways potentially at risk **100-year existing analysis conducted with draft data F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • Low water crossings in the floodplain F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • NFIP participation F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • Areas lacking H&H models F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • Number of flood prone areas marked on comment map F R E E S E A N D N I C H O L S
Task 4A Needs Analysis • # of Presidential Disaster Declarations (flooding) F R E E S E A N D N I C H O L S

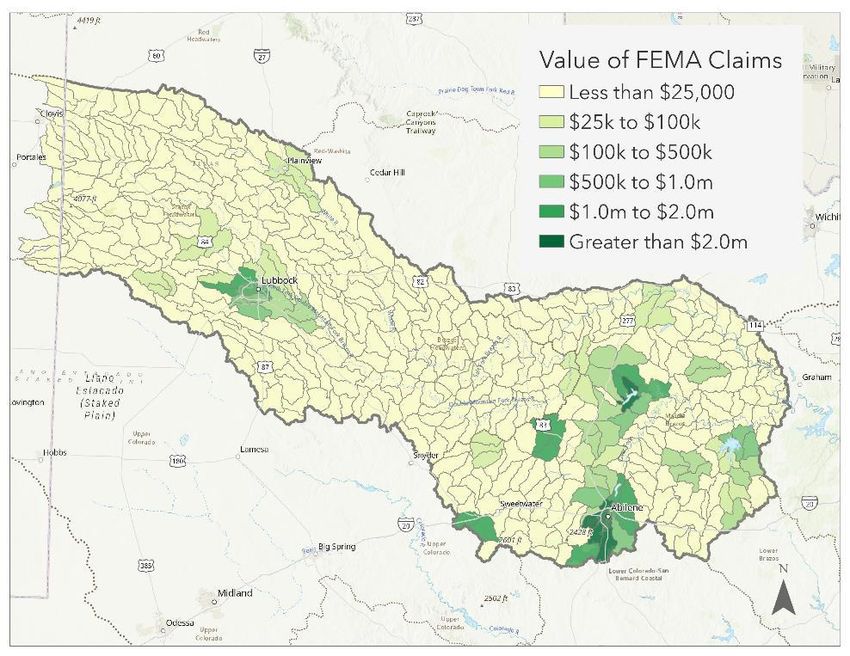

Task 4A Needs Analysis • Value of reported FEMA claims w/in 2.5 miles of HUC12 boundary F R E E S E A N D N I C H O L S
FME – Flood Management Evaluation • Study of a specific, flood-prone area needed to assess flood risk and/or determine whether there are potentially feasible FMSs or FMPs. FMP – Flood Management Project • Project, either structural or non-structural, that has non-zero capital costs or other non- recurring cost and will reduce flood risk, mitigate flood hazards to life or property. FMS – Flood Management Strategy • Plan to reduce flood risk or mitigate flood hazards to life or property. Actions the group would like to identify, evaluate, and recommend that do not qualify as FME or FMP. F R E E S E A N D N I C H O L S
FME Identification Project Sources • Hazard Mitigation Action Plans • County & City Drainage Master Plan to identify specific projects from HMAP actions • Survey responses for flood prone areas • Projects from Drainage Master Plans that need further study • Results of Flood Risk Evaluation (Task 2) • Structures • Low Water Crossings • Results of Needs Analysis • FEMA Mapping – Initial or Updated • City Drainage Master Plan for Cities with high priority HUC12s F R E E S E A N D N I C H O L S
FME Identification Project Types • Watershed Planning • H&H Modeling • Flood Mapping Updates • Regional Watershed Studies • Engineering Project Planning • Feasibility Assessments • Preliminary Engineering (alternative analysis and up to 30% design) • Studies on Flood Preparedness F R E E S E A N D N I C H O L S
FME – Flood Management Evaluation • Study of a specific, flood-prone area needed to assess flood risk and/or determine whether there are potentially feasible FMSs or FMPs. FMP – Flood Management Project • Project, either structural or non-structural, that has non-zero capital costs or other non-recurring cost and will reduce flood risk, mitigate flood hazards to life or property. FMS – Flood Management Strategy • Plan to reduce flood risk or mitigate flood hazards to life or property. Actions the group would like to identify, evaluate, and recommend that do not qualify as FME or FMP. F R E E S E A N D N I C H O L S
FMP Identification Project Sources • Hazard Mitigation Action Plans • Projects from Drainage Master Plans • City of Abilene • City of Lubbock • Results of Needs Analysis Requirements • Detailed H&H modeling results • Quantified reduction of impact from floods • Associated benefits and costs F R E E S E A N D N I C H O L S
FMP Identification Project Types – Structural • Low Water Crossings or Bridges • Infrastructure • channels, ditches, ponds, stormwater pipes, etc. • Regional Detention • Regional Channel Improvements • Reservoirs • Dam Improvements, Maintenance, and Repair • Flood Walls/Levees • Nature Based Projects (Playas) • Comprehensive Regional Projects F R E E S E A N D N I C H O L S
FMP Identification Project Types – Non-Structural • Property or Easement Acquisition • Elevation of Individual Structures • Flood Readiness and Resilience • Flood Early Warning Systems, including stream gauges and monitoring stations • Floodproofing • Regulatory Requirements for Reduction of Flood Risk F R E E S E A N D N I C H O L S
FME – Flood Management Evaluation • Study of a specific, flood-prone area needed to assess flood risk and/or determine whether there are potentially feasible FMSs or FMPs. FMP – Flood Management Project • Project, either structural or non-structural, that has non-zero capital costs or other non- recurring cost and will reduce flood risk, mitigate flood hazards to life or property. FMS – Flood Management Strategy • Plan to reduce flood risk or mitigate flood hazards to life or property. Actions the group would like to identify, evaluate, and recommend that do not qualify as FME or FMP. F R E E S E A N D N I C H O L S
FMS Identification Project Sources • Hazard Mitigation Action Plans • Survey responses • Proposed plans to reduce flood risk or mitigate flood hazards to life or property • May or may not require associated FMPs to be implemented • Actions group would like to recommend that don’t fall into FMEs or FMPs – Task 3 Goals F R E E S E A N D N I C H O L S
FMS Identification Project Types • Public Awareness about Flood Safety • Assessments of Low Water Crossings in several areas to evaluate design and construction possibilities • Dam Inventory and Assessment • Agriculture Flood Losses Inventory and Assessment F R E E S E A N D N I C H O L S
Project List as of 11/19/2021 Summary Table 123 FME 27 FMP 172 FMS 85 Watershed Planning 10 Infrastructure Projects 9 Education and Outreach 3 Project Planning 12 Storage Projects 105 Regulatory and Guidance 0 Flood Preparedness 4 Preparedness 43 Hazard Reduction Programs 32 Other 1 Acquisition/Elevation 8 Other F R E E S E A N D N I C H O L S
2 TA S K 4 : F M E , F M S , F M P P R O C E S S – A P P R O VA L F R E E S E A N D N I C H O L S
3 TA S K 4 C : I N T E R I M TECHNICAL MEMORANDUM F R E E S E A N D N I C H O L S
Task 4C Interim Technical Memorandum A. List of Existing Political Subdivisions With Flood-Related Authorities or Responsibilities B. List of Previous Flood Studies to be Considered by the RFPG for Development of the RFP C. Existing Flood Hazard Geodatabase and Associated Maps Deadline Extended to D. Flood Mapping Gaps Geodatabase and Associated Maps March 7, 2022 E. Hydrologic And Hydraulic Models Needed Geodatabase and Associated Maps F. List of Available Flood-Related Models to be Considered for Developing the RFPG G. Flood Mitigation and Floodplain Management Goals Adopted by the RFPG H. Documented Process Used by the RFPG To Identify Potentially Feasible FMSs And FMPs. I. List of Potential FMEs and Potentially Feasible FMSs And FMPs J. List of FMSs and FMPs Identified but Determined to be Infeasible K. Spatial Data Inventory – GIS Deliverables F R E E S E A N D N I C H O L S
Spatial Data Inventory – GIS Deliverables – Dashboard File # Item Name Feature Class Name Submittal Date 1 Entities Entities January 7, 2022 2 Watersheds Watersheds January 7, 2022 3 ExFldInfraPol 4 Existing Infrastructure ExFldInfraLn January 7, 2022 5 ExFldInfraPt 6 Proposed or Ongoing Flood Mitigation Projects ExFldProjs January 7, 2022 7 Existing Flood Hazard ExFldHazard March 7, 2022 8 Flood Mapping Gaps Fld_Map_Gaps March 7, 2022 9 ExFldExpPol 10 ExFldExpLn 11 Existing Exposure ExFldExpPt March 7, 2022 12 ExFldExpAll 13 Future Flood Hazard FutFldHazard March 7, 2022 14 FutFldExpPol 15 FutFldExpLn 16 Future Exposure FutFldExpPt March 7, 2022 17 FutFldExpAll 18 Existing Floodplain Management Practices ExFpMP January 7, 2022 19 Goals Goals January 7, 2022 20 Streams Streams January 7, 2022 21 Flood Management Evaluations FME January 7, 2022 – Limited Fields 22 Flood Mitigation Projects FMP January 7, 2022 – Limited Fields 23 Post Project Hazard FMP_HazPost August 1, 2022 – Draft Plan 24 Project Details FMP_Details August 1, 2022 – Draft Plan 25 Flood Management Strategies FMS January 7, 2022 – Limited Fields F R E E S E A N D N I C H O L S
3 TA S K 4 C : I N T E R I M TECHNICAL MEMORANDUM - O P T I O N F O R A P P R O VA L When reviewing and considering whether to approve drafts of the ITM, the RFPG members should do so with the understanding that the TWDB has established the purpose of the ITM “to be a draft, mid-point, work-in-progress deliverable…to demonstrate that [the RFPG] are making appropriate progress towards the development of their regional flood plan and in meeting contract requirements.” F R E E S E A N D N I C H O L S
4 TA S K 2 : F L O O D R I S K U P D AT E F R E E S E A N D N I C H O L S
Fathom Data • Available October 29, 2021 • Depth filtered out < 6 inches o Fluvial ▪ Statistical analysis ▪ Sub-grid hydrodynamic modeling o Pluvial o Atlas 14 rainfall o Rain on grid methodology F R E E S E A N D N I C H O L S
100-Year Fathom • Replacing FAFDS • Areas of limited or no flood risk information F R E E S E A N D N I C H O L S
Summary of Existing Conditions • 100-Year • 500-Year • Maintain Flood Risk Mapping • Maintain Local Studies, NFHL o Local Studies Detailed Studies, Base Level o NFHL Detailed, Approximate Engineering and Preliminary Studies • Fathom to supplement existing o Base Level Engineering approximate studies for 500- • Utilize Fathom year o Replace FAFDS o Gaps/Lack of Flood Risk Data F R E E S E A N D N I C H O L S
Future Conditions • “No Action” Scenario for ~30 years o Anticipated Climate Change o Continued Population Growth o Anticipated Land Changes o Continued Development o Completion of Flood Mitigation Increase Projects by 2050 o Current Floodplain Management Regulations/Policy F R E E S E A N D N I C H O L S
Future Conditions • Assumptions and Estimation Options (per TWDB Guidance) o Increase based on population/development growth ▪ Freeboard: Water surface elevation increase ▪ Floodplain Buffer: Floodplain width increase o Utilize existing conditions 0.2% annual chance event (500-yr) floodplain o Combination of above assumptions F R E E S E A N D N I C H O L S
Future Conditions Approach • On the Caprock vs. Off the Caprock • Significantly varied topography • Conveyance and storage • Playas vs. Riverine • Anticipated Population Growth • Recommendation: • Two Separate Approaches to Future Conditions F R E E S E A N D N I C H O L S
Future Conditions Approach On the Caprock • Lubbock – Hold FFD Studies for 100-year and 500-year • Plainview – Use Fathom to supplement existing 100-year studies; Fathom 500-year for Future 100-year • Recommend holding 100-year and 500-year existing conditions for future conditions • Lack of projected population growth • Climate change impacts considered negligible in areas of limited projected growth (Nielson-Gammon) • Atlas 14 rainfall changes considered minimal • Sedimentation of playas • Studies having considered 20+ years of data state “negligible effects” • Playa maintenance occurring in urbanized areas recommended to continue to provide storage capacity • Evaluation of impacts needed to assess impacts to water table, infiltration rates, etc. due to disturbing compacted playa soils F R E E S E A N D N I C H O L S
Future Conditions Approach Off the Caprock • Areas of Existing Studies • Fisher, Nolan, Taylor, Jones, Shackleford, Young • Supplement with Fathom where gaps in existing conditions detailed studies and Zone A approximate studies • Existing 500-year to become future 100-year • Future 500-year area of potential flood risk • Buffer by % difference in area between existing 100-year to 500-year • Buffer Future 100-year flood extents to establish 500-year area of potential flood risk F R E E S E A N D N I C H O L S
Future Conditions • Playas • Riverine • Review of Lubbock Playa Models • BLE Studies • 2009 MDP Data • FIS Studies • Current MDP Studies • FIS Studies Upper Brazos Average WSEL Change Average WSEL Change Average WSEL Change Average 100yr WSEL Change Data Source Regions Existing Vs Future 100yr (ft) Existing 100yr vs 500yr (ft) Future 100yr vs 500yr (ft) with 12% Increase Riverine (Detailed) -1 1.4 -1 -1 On-Caprock Overflow 0.5 0.4 0.3 2 0.1 2 Playas Non-Overflow 0.6 1.1 0.9 2 0.4 2 Riverine (Detailed) -1 1.3 -1 -1 Off-Caprock Riverine (BLE) -1 0.9 -1 -1 1 Region lacking riverine future comparisons. Refer to other regional studies for consideration. Recommend using 500yr for Future 100yr approximation. 2 Differences are based on MDP FFD studies. F R E E S E A N D N I C H O L S
