PORTFOLIO COMMITTEE ON BASIC EDUCATION - Presentation on: Provincial Infrastructure Programme ASIDI & SAFE
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
PORTFOLIO COMMITTEE ON BASIC EDUCATION Presentation on: Provincial Infrastructure Programme ASIDI & SAFE 1
PRESENTATION OUTLINE • Purpose • National Development Plan • Background • Provincial Infrastructure Programme • ASIDI • SAFE 2
PURPOSE To present a progress report on Infrastructure planning and delivery as well as SAFE to the Portfolio Committee on Basic Education. 3
NATIONAL DEVELOPMENT PLAN “Ensure that all schools meet minimum standards for infrastructure and commit to progressively upgrading each school’s infrastructure to meet optimum standards.” National Planning Commission: National Development Plan, November 2011) 4
NATIONAL DEVELOPMENT PLAN… “School infrastructure backlogs have been considerably reduced over the past 10 years. But many school environments are still not conducive to learning. The Department of Basic Education has committed itself to eradicating 496 inappropriate structures, providing basic water to 1 257 schools, providing basic sanitation to 868 schools and providing electricity to 878 schools in the 2012/13 financial year. To meet these commitments, the department will have to: • Find ways to deliver infrastructure and services more efficiently and cost-effectively • Improve the quality of information used for planning.” National Planning Commission: National Development Plan, November 2011) 5
NATIONAL DEVELOPMENT PLAN… “Take learner safety into account when planning infrastructure.” National Planning Commission: National Development Plan, November 2011) 6
BACKGROUND • The sector provides infrastructure through three programmes; viz, the provincial programme, the Accelerated School infrastructure Delivery Initiative (ASIDI) as well as the Sanitation Appropriate for Education initiative (SAFE) • The Provincial Schools Build Programme is implemented by provinces and it targets the provision of basic services, new schools, additions to existing schools, new and upgrading of services and maintenance. It is funded through the Education Infrastructure Grant and the Provincial contribution through the equitable share. • The Accelerated School Infrastructure Delivery Initiative is a programme driven by the DBE to address school's infrastructure backlog on schools that do not meet the basic safety norms and standards. It is funded through the Schools Infrastructure Backlogs Grant. The purpose of the programme is for the eradication of schools made entirely of inappropriate structures and the provision of basic level of water, sanitation and electricity to schools. • The Sanitation Appropriate for Education initiative (SAFE) is a programme driven by the DBE to eradicate all pit latrines and other forms of unacceptable sanitation, provide safe and appropriate ablution facilities as well as address insufficient or inadequate sanitation facilities and maintenance of all ablution facilities 7
KEY AREAS • Construction, maintenance, upgrading and rehabilitation of new and existing infrastructure in education including district and circuit accommodation; • Provide infrastructure to match curriculum requirements; • Replace inappropriate schools; • Provision of basic services; • Address damage to infrastructure caused by natural disasters; • Extend existing schools with additional classrooms/facilities; • Address achievement of the targets set out in the minimum norms and standards for school infrastructure; and • Enhance capacity to deliver infrastructure in education. 8
TOTAL INFRASTRUCTURE BUDGET – 2019/20 FY SIBG, SIBG R 2.027 bn 14.2% ES, ES R 1.713 bn 12% EIG, R 10.514 bn EIG 73.8% Total Budget = R 14. 255bn EIG = Education Infrastructure Grant ES = Equitable Share SIBG = Schools Infrastructure Backlog Grant 9
2019 EIG MTEF ALLOCATIONS Provinces Allocation MTEF Estimates 2019/20 2020/21 2021/22 R'000 R'000 R'000 Eastern Cape 1 585 532 1 564 208 1 685 128 Free State 833 485 722 425 778 272 Gauteng 1 474 715 1 440 169 1 551 501 KwaZulu-Natal 2 187 162 2 013 405 2 169 050 Limpopo 1 050 160 1 175 467 1 266 336 Mpumalanga 731 792 819 111 882 432 Northern Cape 639 817 505 649 544 738 North West 902 484 1 010 169 1 088 260 Western Cape 1 109 331 1 031 186 1 110 902 Unallocated - 1 184 844 1 250 010 Total 10 514 478 11 466 632 12 326 629 11
INFRASTRUCTURE ALLOCATIONS 2019/20 % of equitable share Provinces EIG Equitable Share Total to total budget Eastern Cape 1,585,532 0 1,585,532 0% Free State 833,485 16,378 849,863 1.9% Gauteng 1,474,715 474,821 1,949,536 24.4% KwaZulu-Natal 2,187,162 359,210 2,546,372 14.1% Limpopo 1,050,160 1,826 1,051,986 0.2% Mpumalanga 731,792 202,727 934,519 21.7% North West 902,484 2,228 904,712 0.2% Northern Cape 639,817 7,720 647,537 1.2% Western Cape 1,109,331 648,843 1,758,174 36.9% 10,514,478 1,713,753 12,228,231 12
TARGETS FOR THE 2019/20 FY Target 2019/20 No. PROGRAMME EC FS GP KZN LP MP NC NW WC 1 Full Service Schools 0 0 0 1 1 0 0 5 0 2 Provision/replacement of Sanitation 178 73 13 150 13 85 14 12 14 3 Provision/upgrade of Water 178 10 13 150 22 3 9 10 14 4 Provision/upgrade of Electricity 5 10 13 100 1 1 11 0 14 5 Maintenance Projects 20 27 40 370 34 29 36 48 173 6 Libraries Project 5 1 13 12 2 3 4 7 0 7 Laboratories Projects 5 4 13 12 0 1 8 7 0 8 School Halls 0 1 13 0 2 0 5 7 0 9 Technical Workshops 0 0 0 0 0 0 2 0 0 10 Nutrition Centres 5 7 13 10 9 3 5 5 15 11 Additional Classrooms 285 39 350 210 22 104 43 26 68 12 Grade R Classrooms 13 18 200 50 23 3 8 10 73 13 Administration Blocks 5 4 13 10 3 5 4 7 15 14 Provision/upgrade of fence 302 9 13 40 0 1 15 5 15 15 Provision/upgrade of sport field 0 0 13 9 1 3 5 8 15 16 Special Schools 0 0 1 2 0 1 0 0 0 17 Boarding Schools 0 0 0 2 19 0 0 0 0 18 Guard House 0 0 13 9 4 1 0 7 0 19 Natural Disasters Projects 2 0 0 150 0 0 0 0 0 13
NEW & REPLACEMENT SCHOOLS – 5 YEAR PERIOD FINANCIAL YEARS PROVINCE 2019/20 2020/21 2021/22 2022/23 2023/24 TOTAL Eastern Cape 0 1 5 3 0 9 Free State 6 3 2 4 2 17 Gauteng 7 8 7 6 6 34 KwaZulu-Natal 7 5 1 0 0 13 Limpopo 12 4 14 9 11 50 Mpumalanga 2 6 7 5 2 22 Northern Cape 3 2 11 3 5 24 North West 14 3 11 12 1 41 Western Cape 13 7 10 10 10 50 ASIDI 40 31 29 0 0 100 TOTAL 104 70 97 52 37 376 14
OVERALL INFRASTRUCTURE EXPENDITURE – SEPTEMBER 2019 Total Infrastructure Spending as at end September 2019 Allocated Budget Total Spent as at % Spent of PROVINCE 2019/20 end September Allocated Budget ('000) 2019 ('000) Eastern Cape 1,585,532 876,882 55% Free State 849,863 337,569 40% Gauteng 1,949,536 476,773 24% KwaZulu-Natal 2,546,372 1,281,619 50% Limpopo 1,051,986 254,945 24% Mpumalanga 934,519 545,389 58% North West 904,712 183,984 20% Northern Cape 647,537 263,316 41% Western Cape 1,758,174 781,989 44% TOTAL 12 228 231 5 002 466 41% 15
EDUCATION INFRASTRUCTURE GRANT SEPTEMBER 2019 Education Infrastructure Grant Expenditure as at end September 2019 % Spent of Allocated Budget EIG Transfers to Total Spent as at % Spent of the PROVINCE 2019/20 PEDs end September Allocated transferred ('000) ('000) 2019 ('000) Budget Amount Eastern Cape 1,585,532 990,958 876,668 88% 55% Free State 833,485 520,928 330,546 63% 40% Gauteng 1,474,715 921,697 428,981 47% 29% KwaZulu-Natal 2,187,162 1,367,157 1,164,205 85% 53% Limpopo 1,050,160 656,350 254,937 39% 24% Mpumalanga 731,792 457,370 504,643 110% 69% North West 902,484 564,052 183,139 32% 20% Northern Cape 639,817 399,886 260,064 65% 41% Western Cape 1,109,331 693,332 453,018 65% 41% TOTAL 10 514 478 6 571 730 4 456 201 68% 42% 16
MAINTENANCE – SEPTEMBER 2019 Prov No. of Overall Maint’nce %ge Total %ge Maint’nce Adjusted Budget Maint’nce Expenditure as Expenditure Projects in Infrastructure ('000) Budget to at end on Maint’nce 2019/20 FY Budget Total September Relative to ('000) 2019 Maint’nce ('000) Budget Eastern Cape 454 R 1,585,532 R 255,716 16% R 130,786 51% Free State 27 R 849,863 R 158,668 19% R 39,540 25% Gauteng 144 R 1,949,536 R 1,083,137 56% R 240,909 22% KwaZulu-Natal 445 R 2,546,372 R 944,228 37% R 304,308 32% Limpopo 119 R 1,051,986 R 360,106 34% R 27,249 8% Mpumalanga 118 R 934,519 R 131,468 14% R 94,759 72% North West 62 R 904,712 R 114,097 13% R 33,575 29% Northern Cape 113 R 647,537 R 181,294 28% R 79,729 44% Western Cape 173 R 1,758,174 R 646,215 37% R 287,283 44% TOTAL 1 655 12 228 231 3 874 929 32% 1 238 138 32% 17
PROGRESS – NEW AND REPLACEMENT SCHOOLS SUMMARY OF PROJECTS COMPLTED FOR THE 2019/20 FINANCIAL YEAR TOTAL COMPLETED NEW SCHOOLS REPLACEMENT SCHOOLS TOTAL SCHOOLS TARGET 2018/19 TARGET 2018/19 FOURTH QUARTER FOURTH QUARTER PROGRESS THIRD QUARTER THIRD QUARTER TARGETED SECOND SECOND Province TOTAL TOTAL FIRST FIRST QUARTER QUARTER QUARTER QUARTER Number of Schools Eastern Cape 1 0 0 0 4 0 0 0 5 0 0% Free State 7 2 1 3 3 0 0 0 10 3 30% Gauteng 4 1 1 2 1 0 0 0 5 2 40% Kwazulu Natal 5 0 1 1 2 0 1 1 7 2 29% Limpopo 4 1 5 6 4 1 6 7 8 13 163% Mpumalanga 3 3 0 3 1 1 0 1 4 4 100% Northern Cape 2 0 0 0 2 0 0 0 4 0 0% North West 2 0 0 0 5 0 0 0 7 0 0% Western Cape 4 2 0 2 9 0 1 1 13 3 23% 32 9 8 0 0 17 31 2 8 0 0 10 63 27 43% Total Number of schools 18
IDMS REPORT 2nd QUARTER OF 2019/20 PER PROVINCE Total Targets for Programme Q2 2019/20 EC FS GP KZN LP MP NC NW WC Total Number of New Schools 32 0 1 1 1 5 0 0 0 0 8 Replacement schools 31 0 0 0 1 6 0 0 0 1 8 Full Service Schools 13 0 0 0 0 0 0 2 0 0 2 Provision/replacement of 776 0 2 2 19 46 23 11 0 0 103 Sanitation Provision/upgrade of Water 515 0 2 2 64 17 5 1 0 0 91 Provision/upgrade of 133 0 0 2 2 0 0 1 0 0 5 Electricity Maintenance Projects 727 0 0 2 25 4 14 9 0 15 69 Libraries Project 45 0 0 2 4 7 1 0 0 14 Laboratories Projects 51 0 0 2 3 2 0 0 0 9 16 School Halls 30 0 0 0 0 8 0 1 0 2 11 Technical Workshops 8 0 0 0 0 0 0 0 0 5 5 Nutrition Centres 51 0 0 0 4 0 1 0 0 0 5 Additional Classrooms 1020 0 12 0 69 34 21 7 0 15 158 Grade R Classrooms 266 0 3 4 4 5 4 4 0 2 26 Administration Blocks 52 0 0 1 6 55 1 2 0 65 Provision/upgrade of fence 387 0 1 1 30 16 2 3 0 0 53 Provision/upgrade of sport 28 0 0 0 0 0 0 0 0 0 0 field Special Schools 3 0 0 0 0 0 0 0 0 0 0 Boarding Schools 31 0 0 0 1 0 0 0 0 0 1 Guard House 30 0 0 0 2 0 1 0 0 0 3 Natural Disasters Projects 185 0 0 0 17 0 4 0 0 0 21 19
PROJECT DISTRIBUTION Prov No. of Projects PROGRESS Budgeted for Planning Construction Close-out EC 2,916 1,197 445 1274 FS 152 40 112 0 GT 290 216 61 13 KZ 1,311 520 420 371 LP 682 174 387 121 MP 624 409 140 75 NC 405 235 140 30 NW 265 93 64 108 WC 98 69 26 3 2,953 1,795 1,995 TOTAL 6,743 37% 35% 28% 20
HUMAN RESOURCES No of Approved Provnce Posts Filled Not Filled Progress % Eastern Cape 63 42 21 67% Free State 78 50 28 64% Gauteng 101 83 18 82% KwaZulu-Natal 74 71 3 96% Limpopo 65 49 16 75% Mpumalanga 113 97 16 86% North West 54 30 24 56% Northern Cape 81 43 38 53% Western Cape 54 45 9 83% Total Weight 683 510 173 75% 21
CAPACITATION PLANS – REQUIRED SKILLS SET Quantity Surveyors Finance and 11% Architects administration 9% 27% Elec.Engineers 2% Civil Engineers 3% GIS Specialists 1% Town & Regional Planners 5% Works Ed. Facility Inspectors Planners 33% 9% 22
MONITORING OF THE PROVINCIAL PROGRAMME Reports Submission Date Compliance Final U-AMP for 2019/20 Due 30 March 2019 This is the final plan for all programmes to be implemented over the period of at least 10 years. Monthly IRM reports 22 Day of each month This report captures all infrastructure projects being implemented in the financial year and seeks to present the financial and non financial progress of projects End of Year Reports for 2018/19 Due 31 May 2019 The main purpose of the end-of-year report is to measure progress made by the programme against the objectives and outcomes set, focusing mainly on the previous financial year Draft U-AMP 2020/21 Due 28 June 2019 This is a draft plan for all infrastructure programmes to be implemented over the period of at least 10 years. Infrastructure Programme Management Due 30 August 2019 The IPMP & CPS is an infrastructure programme management plan Plan (IPMP) & CPS which includes the construction procurement strategy for infrastructure programmes or projects envisaged to commence within the period for the medium term expenditure framework (MTEF period). The plan specifies how the infrastructure programme will be executed, monitored and controlled. Human Resource Reports 22 Days after end of each Quarter This report seeks to measure progress of the implementation of the DoRA Human Resource Strategy. It report provides progress on the filling of posts on the approved establishment for the infrastructure unit of the affected provincial department Non-Financial Performace Reports Due 30 days after end of each Quarter The purpose of this report is to measure quarterly progress made by the programme against the objectives and outcomes set for the specific financial year. 23
PBS 2019/20 ASSESSMENT PROCESS Weighting for the 2019/20 assessment process (R1.185 billion) Focus Area Documents / Reports Weight End of the year evaluation report 20% Performance Human Resource Capacitation 5% Infrastructure Reporting Model 40% User-Asset Management Plans 15% Infrastructure Programme Management Plans Planning and; 20% Construction Procurement Strategy TOTAL WEIGHT 100% 24

PROJECT COMPLETIONS | STORMS RIVER PRIMARY Implementing Agent: Department of Public Works Allocated budget: R 51.1 million Construction Period: 33 months Project completed: January 2019 25
PROJECT COMPLETIONS | SIVE SPECIAL SCHOOL Implementing Agent: Independent Development Trust Allocated budget: R124 million Construction Period: 54 months Project completed: June 2018 26

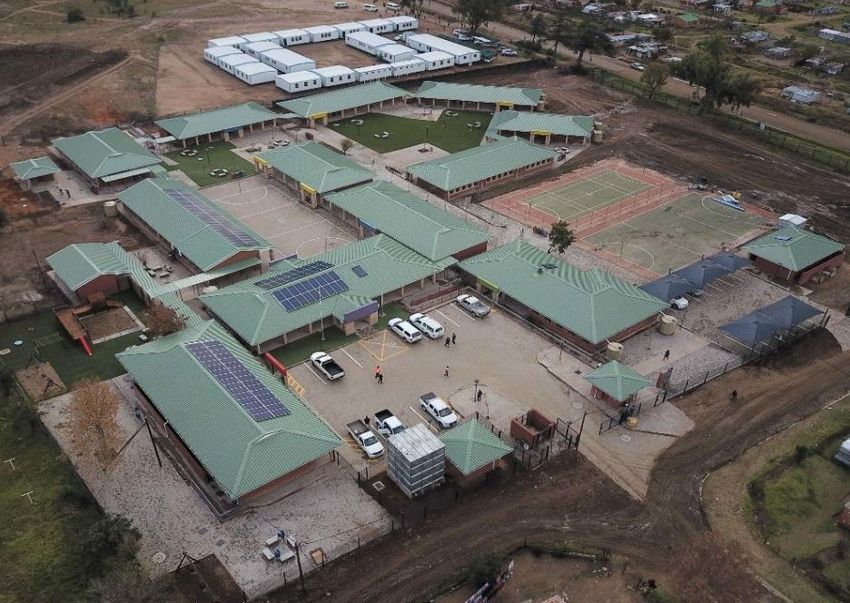

NOKUTHULA LSEN SCHOOL 27
OLIVENHOUTBOSCH SECONDARY SCHOOL 28
MANDLA MTHETHWA SCHOOL OF EXCELLENCE 29
COMMUNITY DISRUPTIONS Thembisa Special School • Project experiencing intermittent stoppages 30
31
MTEF BUDGET ALLOCATIONS 2019/20 2020/21 2021/22 R'000 R'000 R'000 ASIDI 1 327 048 996 036 1 038 937 SAFE 700 000 800 000 1 300 000 TOTAL 2 027 048 1 796 036 2 338 937 32
OVERALL PERFORMANCE Past Performance Current Financial Year 2019/20 Complete Sub- d since Programme Inception 2011/12 2012/13 2013/14 2014/15 2015/16 2016/17 2017/18 2018/19 TargetedCompleted Q1 Q2 Q3 Q4 Deviation Inapp - 17 36 59 52 16 14 21 229 40 14 8 6 -26 Structures Sanitation 41 89 161 152 38 41 32 207 834 311 73 46 27 -238 Water 16 64 135 317 90 35 42 205 957 432 53 39 14 -379 Electricity 148 101 39 18 0 66 0 372 Electricity Scope Completed 33

DU NOON PRIMARY 34
PHOTOS : CLARKSON/AMAMFENGU 35
CONSTRUCTION PROGRESS – ASIDI 15 Sihlahleni JSS Mbekweni HS Siyavuya JPS Sifonondile JPS 3 | 6
CONSTRUCTION PROGRESS – ASIDI FREE STATE EBENHAUSER HERMANA PS INTERMEDIATE TWEESPRUIT PS BHEKIZULU JSS 3 | 7
2019/20 APP : PROGRAMME 4 Strategic Objective Programme Performance Medium-term targets Indicator 2019/20 2020/21 2021/22 4.2 Provide basic 4.2.1 Number of new schools built and infrastructure services completed through ASIDI 40 31 29 (water, sanitation, 4.2.2 Number of schools provided with electricity) and replace sanitation facilities through ASIDI. 717 691 995 schools built using 4.2.3 Number of schools provided with inappropriate materials water through ASIDI. 225 125 0 on an annual basis in order to improve the conditions under which learners are taught 38
2019/20 APP : PROGRAMME 4 QUARTERLY TARGETS Quarterly Targets Annual Target Programme Performance Indicator 1st 2nd 3rd 4th 2019/20 Number of new schools built and completed through ASIDI 40 8 5 12 15 Number of schools provided with sanitation facilities through 717 120 147 210 240 ASIDI Number of school provided with water through ASIDI 225 147 25 35 18 39
INAPPROPRIATE STRUCTURES Projects Design No of Construction Progress Provinces Implementing being & Projects in Projects Agents (IA) Implement Procur Construction Complete ed ement 75% d DBSA 114 3 4 5 2 2 13 98 IDT 31 3 0 0 5 3 8 20 CDC 31 0 2 2 1 2 7 24 EC DRPW 16 0 0 0 0 0 0 16 NDPW 20 1 3 2 2 7 14 5 DBE# 29 29 29 Tender Cancelled. Projects to be Re-Tendered DBE# 57 57 27 5 8 4 8 25 5 Sub-Total - 298 63 14 17 14 22 67 168 IDT 6 - - - - 2 2 4 FS DBSA 19 - - - 1 1 18 FSDoE 5 - 0 2 3 - 5 0 Sub-Total - 30 0 0 2 3 3 8 22 KZN Adopt-A-School 3 - - - - - - 3 WC WCED 25 - - - - - - 25 MP DBSA 5 - - - - - - 5 NW DBSA 2 - - - - - - 2 NC DBSA 1 - - - - - - 1 LP DBSA 3 - - - - - - 3 40 Total 367 63 14 19 17 25 75 229
SANITATION PROGRESS Projects Planning, Construction Progress No of Projects in PROVINCES being Design & Projects Construction Implemented Procurement 75% Completed 437 - - 2 18 37 57 380 LP 298 17 6 1 14 17 38 243 EC 39 27 - - - - - 12 FS 116 - 3 3 4 - 11 105 KZN 13 - - - - - - 13 NC 18 8 - - - - - 10 NW 14 - - - - - - 14 GP 38 - - - - - - 38 MP 19 - - - - - - 19 WC TOTALS 992 52 9 6 36 54 106 834 41
WATER PROGRESS Planning, No of Projects being Construction Progress Projects in PROVINCES Design & Projects implemented Construction Procurement 75% Completed 520 21 1 - 7 150 158 341 EC 36 - - - - - - 36 MP 67 14 - - - - - 53 FS 0 - - - - - - - GP 224 6 3 1 - - 4 214 KZN 364 - 2 14 12 35 62 302 LP 5 - - - - - 5 NC 3 - - - - - - 3 NW 3 - - - - - 3 WC TOTALS 1 222 41 6 15 19 185 224 957 42
MONITORING • Effective monitoring of the provision of infrastructure Professional Service Providers (PSP’s) and Implementing Agents (IA’s) that the Department of Basic Education and provinces are utilizing for the implementation of the infrastructure programme. • Monitoring addresses planning, budgeting, expenditure, procurement and project management. These are interrogated and a sample of projects are visited. Based on the findings from these visits, remedial actions are devised with the province and monitored by the DBE. • Monitoring deals with both programme and project matters; • Programme matters include: - The pattern of overall expenditure being achieved; - Comparisons of expenditure to projected cash flows; - Progress being made with key groups of projects [eg. Water, sanitation, libraries, laboratories, Grade R] - Management of the portfolio of projects [ie evidence that the programme of projects is being managed effectively through the project cycle]; 43
MONITORING (CONT.…) • At the Project level the focus is on ensuring: - that PSP appointments are being made; - that planning and design processes are progressing; - that the tender process for the appointment of contractors is progressing, that construction is progressing satisfactorily, [i.e. on programme, on budget, at acceptable quality…]; and - that projects are being handed over and closed out and that final accounts are being wrapped up. 44
CHALLENGES & REMEDIAL ACTIONS CHALLENGE NATURE OF REMEDIAL ACTION CHALLENGE • Declining/ no allocation of the Equitable Budget/ Finance • PEDs are to allocate Equitable Share. Share toward Infrastructure Delivery poses • Delay projects on pre-construction stage to 1. pressure on the Education Infrastructure commence to construction, whilst awaiting for Grant. adjustments. • Delay payment to contractors resulting in • Monitor the submission of the invoices of the sites been abandon. work done by the IA to ensure that work on ground is equivalent to the expenditure. • PEDs and the IA to reconcile figures on monthly bases. • Lack of Programme Management System IT • Deployment and the implementation of a with reliable data information to enhance transversal system (EFMS) by all the PEDs to 2. the planning and delivery of the required manage the data. Infrastructure timeously • PEDs to increase the IT capacity to house the system. • Excessive number of schools requiring Planning • Re-alignment and reprioritisation of all the maintenance projects earmarked for maintenance to comply 3. with the DoRA condition of the 30% allocation towards the programme. • PEDs to ensure that projects are assessed to avoid duplications or over emphasis on the same schools. • Non- compliance with SCM processes Procurement • PEDs to conduct quarterly audits to ensure resulting in irregular expenditure by the compliance on all the process. 4. 45 Implementing Agent
CHALLENGES & REMEDIAL ACTION (….CONTINUE) CHALLENGE NATURE OF REMEDIAL ACTION CHALLENGE • Late appointment of service providers Programme/ Project • Approval of projects for implementation by the (contractors) by the Implementing Agent Management PED’s prior to the commencement of 5. for projects that were already planned and implementation. designed in previous financial years. • The internal capacity through works inspectors • IA’s lack of capacity resulting in extension closely monitors the projects under of times, variations orders and delayed implementation. occupation of the asset, • Monthly progress meeting with IA’s to improve on • Inaccurate reporting and poor project and reporting and to mitigate any challenges. programme management. • Stricter enforcement of timeframes as proposed • Contractors lack of capacity resulting in by FIPDM schedule and the projects reassigned to poor quality of infrastructure. IA’s that have the capacity to delivery. • The IAs not meeting the milestone and • Amendment of the SLA’s to ensure that all expenditure targets as per IPIPs engagements are regulated in order to be able to • The contractual obligations not carried out enforce of penalties on non-performing. as per the signed SLA with the • Withdrawing and re-allocation of projects to implementing agents other performing Implementing Agents. • Project disruptions by Business Forums Programme/ Project • Continuous engagement with Local Community and Local Communities Management and Political Leadership to address the identified • Volatility of the construction industry challenges. leading to many companies going under • Effective and close project monitoring and and others filing for Business Rescue forecasting of trends 46
BACKGROUND • The audit revealed that 3898 (desktop study) schools still have inappropriate sanitation facilities. • An allocation of R2.8 billion has been allocated for the SAFE Initiative over the MTEF as follows: – 2019/20 : R700 000 000.00 – 2010/21 : R800 000 000.00 – 2021/22 : R1 300 000 000.00 • The SAFE Initiative will be implemented through: – Provincial EIG allocation – Partnerships/Donations – SAFE Initiative Allocation 48
AUDIT (PIT LATRINES) 49
AUDIT: KWAZULU-NATAL
AUDIT: EASTERN CAPE
FINANCIAL REPORT – SAFE ALLOCATION IA No. of Estimated Total Paid Invoice at hand Comments Projects Budget to date DBSA 240 R 256, 197,789.95 R0 R 126 410 728.11 Awaiting supporting documents from the IA. (Tranche payment) DEA 58 R 63 729 187.69 R0 R0 DEA is awaiting for National Treasury to approve deviation from normal procurement process before any invoice can be generated. The Mvula 187 R 268 531 197.17 R0 R 11 847 646.58 Awaiting supporting documents Trust from the IA. (Assessment reports - Planning) NECT 121 R 100 685 316.15 R0 R 40 274 126 .46 Awaiting National Treasury approval to extend the scope of work for NECT. (Tranche payment) TOTAL 606 R 689 143 490.96 R0 R 178 532 501.15 26%52of invoice at hand
PROGRESS ON VERIFICATION Province No. of Verification Balance Comments Schools Verified PIT Proper Sanitation EC 1598 359 305 54 1239 Further verification to commence mid October. FS 156 0 - - 156* No verification will be carried-out as the province is implementing all the projects. KZN 1365 335 255 80 668 362 Schools will not be verified, the province (1030) has allocated the projects to be implemented with EIG allocation. LP 507 259 217 42 248 All the schools will be verified by the end of October MP 127 88 - - 39* 39 Schools will not be verified, the province is implementing all the projects with EIG allocation. NW 145 137 66 71 8 Verification to be completed by 8 October. TOTAL 3898 1205 843 247 2136 • FS & MP all the schools will be implemented with the EIG. • 606 of the 843 schools are currently under implementation. 53
PROJECTS UNDER IMPLEMENTATION SAFE ALLOCATION & EIG Province No. of Projects Planning Construction EC 262 262 0 FS 148 80 68 KZN 402 372 30 LP 162 162 0 MP 33 4 29 Total 1007 880 127 • 880 Projects are currently under planning and design phase. • 127 Projects are currently under construction. 54
COMPLETED PROJECTS Province No. of Projects Donor EIG & ASIDI EC 11 4 7 FS 29 29 KZN 93 2 91 LP 35 3 32 MP 20 9 11 TOTAL 188 18 170 • To date 188 Schools have been provided with adequate sanitation. 55
CHALLENGES / REMEDIAL ACTIONS CHALLENGES REMEDIAL ACTION • Planning and implementing within • All the projects for the next financial the same year is the major cause of year will be allocated to the IAs at delay. the beginning of the fourth quarter, for planning to commence within the current financial year. • The procurement process is delaying the commencement of construction. • To ensure that implementation commences at the beginning of the financial year. • Project monitoring to ensure that all • Increase the capacity to monitor projects are completed in time and project implementation. the quality is up to standard.
PROJECT PHOTOS SEKANEKAMOYI PRIMARY SCHOOL 57
PROJECT PHOTOS MAMAILA PRIMARY SCHOOL 58
PROJECT PHOTOS PAAPA PRIMARY SCHOOL 59
PROJECT PHOTOS TSHINANGE PRIMARY SCHOOL 60
PROJECT PHOTOS RAMOTLHATSWANE PRIMARY SCHOOL 61
PROJECT PHOTOS SEKANEKAMOYI PRIMARY SCHOOL 62
DEDENI JSS - SANITATION 63
ASSUPOL DONATION Maaphoko LPS Govani Ntlhodumela PS Govani PS 64
PLANS TO IMPROVE INFRASTRUCTURE PLANNING AND DELIVERY PLANNING, DELIVERY AND MAINTANANCE ▪ Integrated National School Infrastructure Sector Plan: All schools in the country profiled in terms of their infrastructure needs in line with Norms and Standards; ▪ Revise Education Infrastructure Delivery Model: This delivery model will address: ▪ Expediting delivery of infrastructure projects, ▪ Controlling the cost of providing education infrastructure and; ▪ Improve Contracts Management Processes; • Standard Floor Layout Plans and Technical Specifications : Develop standardised plans and specifications for all Education Facilities (Primary Schools, Secondary Schools, Learner Boarding Facilities, District and Circuit Offices); • Establishment of an Education Infrastructure Planning & Management Agency / Bureau: Infra Bureau/Agency to be set up at national level to centrally facilitate and co-ordinate all the macro and micro planning processes, implementation, monitoring and evaluation of all 65 infrastructure projects in the Basic Education Sector.
PLANNING, DELIVERY AND MAINTANANCE • Revise project prioritization model to use condition assessment as a determinant for Project Priority List. • Utilization of data from STATS SA , like population trends at a local level, to ensure that size of schools built addresses the current and future population dynamics; • Review of SLA’s/MOA’s with IA’s to impose penalties for non-compliance with progress delivery, deduct management fees for non compliance or withdraw projects as a result of poor performance. • Strengthen Contract Management and Monitoring processes on infrastructure delivery. 66
PLANNING, DELIVERY AND MAINTANANCE • Strengthen internal Technical Capacity to implement projects, ensuring: - Qualified and Professionally Registered key personnel; - Accredited Project Managers; • Employee retention strategies for attracting and retention of built environment professionals: – Revise remuneration scales for professionals; – Improve working conditions and provision of tools of trade; • Increase the use of alternative building technologies for quicker construction; • Benchmark with other role players like independent schools to reduce the cost of building schools; 67
FUNDING AND PARTNERSHIPS • Provinces to ensure that sufficient funding is allocated to the Equitable Share and ring fence such funding for infrastructure; • Condition Grant allocations (EIG) to be ring-fenced and used solely for the intended purpose, as a condition of the grant; • EIG Funding allocations to be per project on the basis of an approved Business Case and progress on projects implemented; • Diversified funding modalities for school infrastructure: • Public-Private Partnerships (Build, Operate & Transfer – BOT); • Donor and Grant funding; • Rand-for-Rand Public-Private Partnerships; • Partnerships with Institutions of Higher Learning and Non-governmental Organizations. 68
RECOMMENDATION It is recommended that the Portfolio Committee discusses the progress report on Infrastructure planning and delivery as well as SAFE. 69
