Purpose & Purpose: Provide an overview of MTEP20 Key reliability projects recommended for BOD Takeaways approval Key Takeaways: • 513 new projects, at a cost of $4.01 billion, will be recommended for MTEP20 Appendix A • 46 new projects are proposed in the South region, at a cost of $0.53 billion • Zero Expedited Project Review (EPR) requests received in the South region • In December, MISO staff will present the recommended MTEP20 Appendix A projects, as well as the report, for BOD approval 2 Project information as of August 3, 2020
Historical MTEP investment (millions) shows slight growth $3,996 $4,008 $3,469 $2,695 $2,683 $2,589 A in MTEP15 A in MTEP16 A in MTEP17 A in MTEP18 A in MTEP19 A in MTEP20 3 Project information as of August 3, 2020 Statistics do not reflect all economic projects, GIPs, or TDSPs currently under evaluation in separate planning processes
MTEP20 Top 10 Projects1 (by cost) 2. New LaSalle Area 138kV Statcom 6. Upgrade Greentown 765kV Substation 3. New Robinson 138kV Statcom 1. New Massac Substation 4. Rebuild Grand Tower - Carbondale 5. Rebuild Albion South - Norris City 9. New Jordan Substation - Convert 8. Choudrant 230kV Station West Frankfort 230kV to 345kV 7. Millbend 138kV Station 10. Castle 230kV Station 4 1. Blanket Asset Renewal Projects excluded from ranking Project information as of August 3, 2020
Majority of MTEP20 projects go into service within four years and are primarily transmission line and substation work Transmission 26.3% Line New 25.3% 11% 24.0% Substation 45% Transmission Line Upgrade 37% 9.2% 9.0% 4.3% 1.2% 0.4% 0.2% 0.2% Transformer Voltage Device 4% 2% 2019 2020 2021 2022 2023 2024 2025 2026 2027 2029 Facility type 5 Project information as of August 3, 2020 Statistics do not reflect all economic projects, GIPs, or TDSPs currently under evaluation in separate planning processes
In MTEP 2020 – 513 new projects will be recommended for approval BRP 8 Other BRP 33 GIP 38 Other Local Needs 49 9 West Other 90 GIP 15 Load Growth East 53 MISO Total BRP 25 GIP 14 Central Age and BRP Condition 137 75 Other 195 Other GIP BRP 9 Other 345 93 22 GIP South 15 Local Reliability 146 6 Project information as of August 3, 2020 Statistics do not reflect all economic projects, GIPs, or TDSPs currently under evaluation in separate planning processes
In MTEP 2020 – An estimated cost of $4.01 billion will be recommended for approval BRP $42M Other BRP GIP $193M $198M Other Local Needs $230M $45 M GIP Other West $126M $665M Load Growth East $480 M MISO Total BRP Age and BRP Central $372M GIP Condition $87M $1,079 M $684M Other BRP $1,562M GIP $72M $538M GIP $96M Other Other South $2,786M $367M Reliability $1,185 M 7 Project information as of August 3, 2020 Statistics do not reflect all economic projects, GIPs, or TDSPs currently under evaluation in separate planning processes
Proposed investment for the South Region for MTEP20 is less than that of MTEP19 MTEP19 MTEP20 Approved Appendix A Proposed Appendix A Project Count - 71 Project Count - 46 BRP Other GIP 8 Project information as of August 3, 2020 Statistics do not reflect all economic projects, GIPs, or TDSPs currently under evaluation in separate planning processes
Questions?
Appendix
MTEP20 Top 10 Projects1 Details Submitting Estimated Rank PrjId Project Name Type Company Cost ($M) Local Ameren Services 1 11925 New Massac Substation - Convert Joppa 230 kV substation to 345 kV substation 112.4 Reliability Company Ameren Services 2 18249 New LaSalle Area 138 kV Statcom (100 MVAR) BRP 91.4 Company Ameren Services 3 18250 New Robinson 138 kV Statcom (70 Mvar) BRP 78 Company Age and Ameren Services 4 17910 Rebuild Grand Tower-Carbondale NW 138 kV line 75.6 Condition Company Age and Ameren Services 5 13797 Rebuild Albion South-Norris City North 138 kV to double circuit 74 Condition Company Age and American Electric 6 17684 Upgrade Greentown 765 kV substation 70 Condition Power 7 18248 Millbend 138 kV: New Distribution Station Load Growth Entergy Texas 65.4 8 13925 Choudrant: New distribution substation Load Growth Entergy Louisiana 56.2 New Jordan Substation - Convert West Frankfort 230 kV substation to 345 kV Local Ameren Services 9 11926 56.1 substation Reliability Company 10 15648 Castle 230 kV: New Distribution Station Load Growth Entergy Texas 50.51 1. Blanket Asset Renewal Projects excluded from ranking 11 Project information as of August 3, 2020
MTEP20 Utilizing ShareFile • MISO’s secure FTP is under transition to MISO ShareFile service to post non-public information for MTEP studies https://misoenergy.sharefile.com/Authentication/Login • New users can request access through MISO website https://www.misoenergy.org/access-request/access-request-form/ • Similar folder structure with FTP and subfolders named in a commonly way • MTEP20/Input_Files • MTEP20/Dynamics • MTEP20/Steady_State_Analysis • …Results • …Models • Many other resources used in analysis 12 MTEP20 folder in MISO ShareFile view

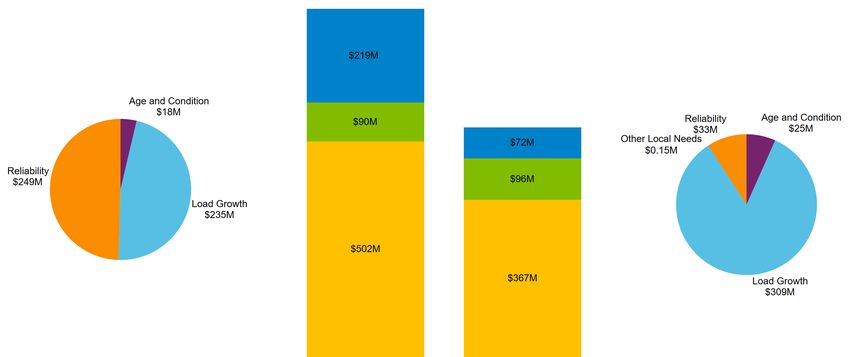

MISO South top 10 Targeted Appendix A projects represents 66% of the total MTEP20 cost of $534 million for the region 13
Overview of MTEP Types • Transmission projects required to meet reliability standards Baseline Reliability Projects (BRP) of NERC or applicable Regional Reliability Organizations in the Transmission Provider Region. Transmission Delivery Service Projects (TDSP) • Required to satisfy a Transmission Service request. Generation Interconnection • Upgrades that ensure the reliability of the system when new Projects (GIP) generators interconnect. • Provide reductions in market congestion. Market Efficiency Project (MEP) • Developed to produce a benefit-to-cost ratio of 1.25 or greater. • Provide regional public policy economic and/or reliability Multi-Value Project (MVP) benefits. Market Participant • Network upgrades fully funded by one or more market Funded Projects participants but owned and operated by an incumbent (MPFP) Transmission Owner. 1. Reliability 2. Age and Condition • A project not meeting any of these classifications is 3. Load Growth Other Projects designated as ‘Other’. 4. Other Local Needs 14 More detailed is in Appendix 14
Overview of Tariff-defined project types • “Baseline Reliability Projects are Network Upgrades identified in the base case as required to ensure that the Transmission System is in compliance with applicable national Electric Reliability Organization (“ERO”) reliability standards and reliability standards adopted by Regional Reliability Organizations and applicable within the Transmission Provider Region.” • “Generation Interconnection Projects are New Transmission Access Projects that are associated with interconnection of new, or increase in generating capacity of existing, generation.” • “Market Participant funded projects (MPFPs) are defined as Network Upgrades fully funded by one or more market participants but owned and operated by an incumbent Transmission Owner.” • Other projects do not meet the criteria to be considered as Baseline Reliability Projects, New Transmission Access Projects, Market Efficiency Projects, or Multi-Value Projects. Other projects may include projects to satisfy Transmission Owner and/or state and local planning criteria other than NERC or regional reliability standards, interconnect new Loads, relocate transmission facilities, address aging transmission infrastructure, replace problematic transmission plant, improve operational performance or address other operational issues, address service reliability issues with end-use consumers, improve aesthetics including but not limited to undergrounding overhead transmission facilities, address localized economic issues, and address other miscellaneous localized needs. • Market Efficiency Projects (MEPs) meet Attachment FF requirements for reduction in market congestion and are eligible for regional cost allocation. Projects qualify as MEPs based on cost and voltage thresholds and are developed to produce a benefit-to- cost ratio of 1.25 or greater • Multi-Value Projects (MVPs) meet Attachment FF requirements to provide regional public policy, economic and/or reliability benefits. Costs are shared with loads and export transactions in proportion to metered MWh consumption or export schedules • Transmission Delivery Service Project (TDSP) projects are required to satisfy a transmission service request. The costs are generally assigned to the requestor. 15
MTEP20 Reliability Planning Stakeholder Meeting Schedules 2020 Jan Feb Mar Apr May Jun Jul Aug Sept Oct Nov Dec 2nd SPM, 3rd SPM, 1st SPM Michigan TSTF Michigan TSTF MTEP20 Present TO/MP BOD Present results of Recommendation submitted Approvals MISO independent of MTEP20 Projects TPL assessment Projects Dec Jan May/Jun Aug Meeting Locations SPMs MCPS TSTF Michigan TSTFs* Other TSTFs Central: SPM1: MISO-Carmel, SPM2 & 3: TBD WebEx Only Two TSTFs: Occur two weeks prior Based on proximity to study needs East: SPM1: Regional TOs Offices, SPM2 & 3: TBD to SPM2 and SPM3 South: SPM1: MISO-Little Rock, SPM2 & 3: TBD TSTF1: WebEx; West: SPM1: MISO-Eagan, SPM2 & 3: TBD TSTF2: TBD 16 * Michigan TSTFs will address only reliability issues
MTEP20 Reliability Planning Processes are closely coordinated on issues and solutions 2019 2020 Jun Jul Aug Sept Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sept Oct Nov Dec TO/MP Exchange of MISO Independent TPL Information Exchange proposed TO planning assessment to identify issues MISO reviews TO models and Planning project information alternatives and Criteria submittals between TO Review TO projects and identify completes gap for and gaps Stakeholder Comments analysis MTEP20 Stakeholders Stakeholders provide alternatives Jun – Sept Jun - July Sept 15th Sept - Dec Jan - May Project Recommendation for BOD Approval Sept - Dec Issues and Solution Development Coordination 17
