An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Greenlink Electricity Interconnector Determination Determination Paper Reference: CRU/18/216 Date Published: 18/10/2018 Closing Date: N/A www.cru.ie
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Executive Summary The Greenlink Interconnector is a proposed 500 MW HVDC electricity interconnector, which is being developed by Element Power, linking the power grid in Ireland and GB. It is anticipated that the link will provide a new grid connection between the Great Island transmission substation in Wexford and Pembroke transmission substation in South Wales. Figure 0: Graphical Illustration of Greenlink (Image source: Element Power) In December 2017, Element Power submitted an interconnector application under Section 2A of the Electricity Regulation Act 1999. In its application Element Power requested the CRU to: 1. determine if the construction of the Greenlink interconnector is in the public interest for the project to be considered to be part of the transmission system for the purposes of calculating and imposing charges for the use of the transmission system; and 2. approve the proposed charging methodology for Greenlink pursuant to section 35 of the Act which is based on a 25 year Cap and Floor regime. In June 2018, the CRU published Element Power’s application and a CRU consultation paper (CRU18119) requesting views on the initial assessment of Greenlink by the CRU. The CRU noted in the consultation paper that the assessment of Greenlink involves two stages: 1. testing the public interest case of the proposed interconnector by reviewing a Cost Benefit Analysis (CBA) of the project; and 2. determine the best approach on a Cap and Floor mechanism. This determination paper focuses on the first stage, i.e. the public interest test. The precise details of any cap and floor regime would need to be consulted upon and determined at a later stage. The CRU has reviewed the consultation responses and considered the points raised by respondents. In addition, the CRU has conducted its own CBA of Greenlink to test the boundaries of Element Power’s CBA and the key inputs and assumptions which may drive better or worse outcomes for Irish consumers and other stakeholders. The CRU has 1
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities modelled ENTSO-E TYNDP scenarios and compared the CBA results to those of Element Power.1 The consultation paper noted that if the CRU CBA revealed that Greenlink would generate overall (net) benefits to Irish consumers then the CRU would go on to consider the appropriate regulatory regime that is justified by public interest. The focus of this paper is to set out CRU’s determination that the Greenlink application meets the public interest. The results of the CRU CBA2 of Greenlink are summarised below: • Although there are differences between CBA modelling scenarios and assumptions adopted by the CRU and Element Power, overall the CRU CBA results are consistent with the findings of Element Power. They show that Greenlink has the potential to deliver benefits for Irish consumers where significant decarbonisation of electricity generation occurs. • The CRU modelling indicates that in relatively conservative scenarios of decarbonisation of electricity generation in Europe, Greenlink does not drive benefits for Irish consumers. • In a scenario where another new interconnector is added alongside Greenlink, e.g. another interconnector to France, consumer benefits from Greenlink appear to be significantly reduced. • There are potential security of supply benefits for the Single Electricity Market (SEM) with the introduction of Greenlink. • The CRU Brexit sensitivity3 assumes that there would be trading frictions4 between GB and the countries it is connected to via an interconnector. Trading frictions between countries would result in less efficient trading, less efficient interconnector usage, greater price divergence, and hence potentially higher cost for consumers. As a consequence of these frictions, the overall net benefits in SEM are lower under the Brexit sensitivity than under a no Brexit scenario. Because of the underlying inefficiencies, introducing a new interconnector may unlock more benefits to Irish consumers compared to a no Brexit scenario where no trading frictions are present. • The addition of Greenlink would have a small negative impact on annual power sector gas demand and an even smaller corresponding impact on total annual gas demand. • Both CRU’s CBA and Element Power’s CBA show that Greenlink reduces RES curtailment and improves captured electricity prices for Irish consumers, i.e. average annual electricity prices are expected to be lower in the SEM when Greenlink is in service compared to prices that would be captured without Greenlink. 1 The CRU has been supported by independent economic and technical advisors. 2 CRU modelled Vision 1 from the ENTSO-E TYNDP 2016 scenarios and Sustainable Transition and Global Climate Action from the ENTSO-E TYNDP 2018 scenarios. At the time of conducting the CBA study, the TYNDP 2018 scenarios were still in draft form. 3 See Section 3.5 for a description of the Brexit sensitivity. 4 Trading frictions were modelled as a transmission cost on all GB electricity interconnectors. 2
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities The CRU CBA of Greenlink indicates that, at the time of assessing the Greenlink application, Greenlink has the potential to provide a net benefit to Irish consumers and Ireland as a whole. As such, the CRU is minded to determine, at this early stage, the Greenlink interconnector application passes the public interest test. The CRU notes that this paper outlines the CRU determination if the Greenlink interconnector is in the public interest. The CRU does not require any further comments on this determination paper. The precise details of any Cap and Floor regime will be consulted upon and determined at the next stage, after sufficiently detailed financial and technical submissions provided by the Greenlink developers to the CRU for a detailed assessment. The CRU notes that in the next stage the CRU will engage with the Ofgem to explore the potential for a Final Project Assessment process that takes both the Irish and GB regulatory separate decision-making processes into account. Notwithstanding this determination on the public interest test, if any subsequent information is given to the CRU before making its final decision would lead the CRU to consider that the basis of its public interest test decision has materially changed, then the CRU may revisit this determination. In this case, the CRU may re-run its analysis in order to confirm whether or not the project continues to be in the public interest. Greenlink developers are required to regularly update the CRU on progress against their key development milestones. Furthermore, the CRU expects the Greenlink developers to give formal written notice of any material change to the project design. 3
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Public Impact Statement Electricity interconnectors are physical links which allow the transfer of electricity across borders. New interconnectors should be built only to the extent that they benefit the public at large. That is, as long as the benefits of adding interconnection capacity outweigh or equal the costs. Therefore, the CRU’s assessment of each electricity interconnection application will balance potential benefits of a new interconnector to the Irish consumers against its costs. Generally, new electricity interconnectors can offer multiple potential benefits: • lowering costs for consumers if power can be generated abroad and imported to Ireland at a lower price (lower prices); • reducing emissions by facilitating the integration of renewable power into the energy system (renewable energy integration); and • providing an additional layer of security (security of supply). In relation to lower prices, interconnectors can transport power in both directions, i.e. import and export. This allows them to utilise differences in the power systems, and electricity prices, between countries. Electricity between interconnected markets flows from the lower- priced market to the higher-priced one. For instance, at times of high electricity price in Ireland, interconnectors can allow cheaper electricity from another country to be imported into Ireland, thereby raising the supply of electricity and lowering its price. Conversely, if Ireland was the lower-priced market, export of its (cheaper) electricity to a higher-priced market would increase the price in Ireland and bring the price down for the consumers abroad. In summary, a new interconnector tends to increase prices in the lower-priced market and decrease prices in the higher-priced market. As prices converge, consumers in the higher- priced market will benefit from lower prices, while the lower-priced market consumers will have to pay a higher price. Therefore, whether a new interconnector lowers electricity prices for Irish consumers would depend on whether it connects to a country where electricity prices are typically lower than in Ireland. Regarding renewable energy, on very windy or sunny days there can be more renewable power available than the electricity system can accept. When this happens, renewable generators are dispatched down or “curtailed off”, that is, blocked from supply, and a large volume of renewable energy goes unused. This is because, at present, renewable energy cannot displace conventional power plants below the minimum level needed for certain grid stability services. Additional interconnection could reduce this effect and allow more renewable energy onto the electricity system (as it can safely be exported). Finally, regarding security of supply, interconnectors allow physical imports of electricity to meet domestic demand. As such, a new interconnector would give Ireland yet another potential import route for electricity, diversifying Ireland’s energy supply. This diversification can have various dimensions. First, a new interconnector can provide geographic diversification if it links Ireland with a new country or supplies power to a new (different) point on the Irish electricity system. A new interconnector can also provide economic 4
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities diversification, as it supplies electricity according to the price dynamics between the two interconnected countries. Finally, a new interconnector also provides technological diversification in that it links markets with different technology choices or having different natural resources determining their energy mix. Each of these dimensions enables security of supply risks to be spread and reduced. Building a new interconnector can be costly for the Irish consumers, depending on the way it is regulated and funded. Interconnectors derive their revenues from sales of interconnection capacity to users who wish to move electricity between markets with different prices (congestion revenues). There are various approaches to regulate interconnectors and determine who bears the risk of the interconnector being able to earn congestion revenues. In a merchant model, which is exceptional in Europe, the interconnector is fully reliant on its congestion revenues and bears all the risks of not being able to recover its investment. In a fully regulated model, which is most common in Europe, investment costs are recovered through network tariffs. In this model, it is the end consumer that pays the investment costs in full and receives all the revenues from sales of interconnection capacity. Interconnectors can also be partly regulated, and therefore partly funded by the tariffs. For instance, in a so-called cap and floor model, an interconnector’s sales revenues that are below the floor are topped up by network tariffs and its sales revenues above the cap are returned to the end consumer. Hence, regulated and partially regulated interconnectors can have a positive or negative impact on network tariffs, and ultimately on end consumers, depending on their performance. If interconnectors underperform financially, then this can translate into a cost to electricity consumers by increasing network tariffs. In contrast, if electricity interconnectors over- perform financially they can reduce electricity network tariffs. Therefore, the risk of underperformance and its potential cost to Irish consumers must be balanced against the potential benefits that a new interconnector may bring in the medium to long term. 5
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Table of Contents Table of Contents ...................................................................................................... 6 1. Introduction ...................................................................................................... 10 1.1. Commission for Regulation of Utilities ...........................................................................10 1.2. Background ........................................................................................................................ 10 1.3. Greenlink Project – PCI 1.9.1............................................................................................ 11 1.4. Purpose of this Paper .......................................................................................................11 1.5. Legal and Policy Context..................................................................................................11 1.5.1. Electricity Regulation Act 1999, Section 2A ................................................................ 12 1.5.2. Electricity Regulation Act 1999, Section 9 ..................................................................12 1.5.3. Electricity Regulation Act 1999, Section 16A .............................................................. 12 1.5.4. ENTSO-E’s TYNDP .........................................................................................................13 1.5.5. ENTSO-E’s CBA Guideline ............................................................................................ 13 1.5.6. CRU’s policy to date ......................................................................................................14 1.5.7. Government’s Policy on Electricity Interconnection .................................................15 1.6. Structure of this Paper ......................................................................................................15 2. Summary of Responses Received.................................................................. 16 2.1. Are there any other specific factors that the CRU should consider in assessing the Greenlink CBA? ........................................................................................................................ 16 2.2. Is there any additional information the CRU should consider when determining whether the Greenlink interconnector is in the public interest or not? ............................. 18 2.3. Are there any other specific factors that the CRU should consider in assessing the Greenlink technical overview report? ....................................................................................19 2.4. Are there other specific factors that the CRU should consider in selecting the appropriate regulatory approach? ......................................................................................... 20 2.5. Other comments ................................................................................................................21 3. CRU CBA of Greenlink ..................................................................................... 23 3.1. Methodology and Modelling Approach ...........................................................................23 3.2. CRU CBA Results of Greenlink ........................................................................................ 26 3.3. CRU CBA Results Across all Scenarios .........................................................................27 3.3.1. TYNDP 2018 ST vs Element Power Reference Case ..................................................28 3.3.2. TYNDP 2016 V1 vs Element Power Low Case ............................................................. 30 3.3.3. TYNDP 2018 GCA vs Element Power High Case ........................................................ 31 3.4. RES Integration..................................................................................................................32 3.5. Impact of Greenlink on Security of Supply ....................................................................32 6
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities 3.6. Impact of Brexit on Greenlink .......................................................................................... 34 3.7. Impact of Greenlink on Gas Transmission Tariffs ......................................................... 38 4. CRU CBA Summary ......................................................................................... 40 5. CRU’s Determination ....................................................................................... 42 6. Next Steps ........................................................................................................ 43 7
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Glossary of Terms and Abbreviations Abbreviation or Definition or Meaning Term ACER Agency for the Cooperation of Energy Regulators CBA Cost Benefit Analysis CBCA Cross-border cost allocation CEF Connecting Europe Facility CRU Commission for Regulation of Utilities DCCAE Department of Communications, Climate Action and the Environment EENS Expected Energy Not Served ENSTO-E European Network of Transmission System Operators for Electricity ESB Electricity Supply Board GB Great Britain UK United Kingdom FFR Fast Frequency Response FPA Final Project Assessment HVAC High Voltage Alternating Current HVDC High Voltage Direct Current Interconnexion France-Angleterre (Interconnector between France and IFA GB) IPA Initial Project Assessment SEM Single Electricity Market I-SEM Integrated Single Electricity Market LOLE Loss of Load Expectation NPV Net Present Value 8
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Abbreviation or Definition or Meaning Term NRA National Regulatory Agency O&M Operations and Management Ofgem Office of Gas and Electricity Markets (GB Energy Regulatory Authority) PCI Project of Common Interest Réseau de transport d'électricité (French Transmission System RTÉ Operator) TEN-E Trans-European Energy Infrastructure Regulation (EU Regulation (EC) Regulation No 347/2013) TSO Transmission System Operator KPI Key Performance Indicator CRE French Regulator SNSP System Non-Synchronous Penetration V1 Vision 1 ST Sustainable Transition GCA Global Climate Action RES Renewable energy sources CO2 Carbon dioxide TYNDP Network development plan for the next ten years DfD Contracts for Differences VoLL Value of Lost Load EENS Expected energy not served PPA Power Purchase Agreements 9
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities 1. Introduction 1.1. Commission for Regulation of Utilities The Commission for Regulation of Utilities (“CRU”) is Ireland’s independent energy and water regulator. The CRU’s mission is to regulate water, energy and energy safety in the public interest. Further information on the CRU’s role and relevant legislation can be found on the CRU’s website at www.cru.ie. 1.2. Background In December 2017, Element Power submitted an application for an interconnector between GB and the Republic of Ireland, i.e. the Greenlink interconnector under Irish Legislation (Electricity Regulation Act 1999 (the Act)). The application consisted of a cost-benefit analysis of Greenlink, a technical description of the project, project financial information as well as a description of the charging methodology and regulatory regime Greenlink is seeking to be regulated under. In its application Element Power requested the CRU to: 1. determine if the construction of the Greenlink Interconnector (a Project of Common Interest (PCI) connecting Great Britain (GB) and Ireland) is in the public interest for the project to be considered to be part of the transmission system for the purposes of calculating and imposing charges for the use of the transmission system; and 2. approve the proposed charging methodology for Greenlink pursuant to section 35 of the Act which is based on a 25-year Cap and Floor regime.5 This determination pertains to the first stage outlined above. The CRU assessed the “public interest” stage by conducting its own CBA and comparing the results to those provided by Element Power. The CRU considered the application and issued a public consultation seeking comments from stakeholders on the CRU’s initial assessment of Greenlink’s electricity interconnector application. In June 2018, the CRU published Element Power’s application and a CRU consultation paper (CRU18119) requesting views on the initial assessment of the Greenlink’s electricity interconnector application by the CRU. In the consultation paper the CRU indicated that it would conduct its own CBA of Greenlink to test the boundaries of Element Power’s CBA and the key inputs and assumptions which may drive better or worse outcomes for Irish consumers and other stakeholders. The CRU also noted that if the CRU CBA revealed that Greenlink would generate overall (net) benefits to Irish consumers, the CRU would then consider the appropriate regulatory regime that is in the public interest. 5 Greenlink requested from the CRU a Cap and Floor regime in respect of 50% of Greenlink’s revenues. Greenlink is seeking a regime that is symmetrical with Ofgem’s 25-year Cap and Floor regime that would apply to Greenlink in GB, i.e. the Greenlink Interconnector would be, in principle, half underwritten by GB consumers and the other half underwritten by Irish consumers. 10
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities 1.3. Greenlink Project – PCI 1.9.1 The Greenlink Interconnector is a proposed 500 MW HVDC electricity interconnector, which is being developed by Element Power, linking the power grid in Ireland and GB. It is anticipated that the link will provide a new grid connection between the Great Island transmission substation in Wexford and Pembroke transmission substation in South Wales. Figure 2: Graphical Illustration of Greenlink (Image source: Element Power) Greenlink has been designated as a PCI by the European Commission and has been granted, by Ofgem, a Cap and Floor regulatory regime 6. The interconnector is focused on increasing the ability of the all-island SEM and GB markets to integrate low carbon electricity generation, particularly through renewable generation, as the penetration of renewable electricity generation increases. Element Power considers the interconnector can also help wind and solar energy avoid curtailment by allowing surplus output to be exported during periods where supply outstrips demand. 1.4. Purpose of this Paper The purpose of this paper is to outline the CRU determination following an assessment on the Greenlink interconnector application seeking to understand whether the interconnector would be in the public interest. 1.5. Legal and Policy Context The CRU has several competences in relation to assessing electricity interconnection projects and deciding on their regulatory treatment. An overview of those competencies under the Irish and the European law is provided in a CRU information paper (CRU18056). When assessing electricity interconnection applications, the CRU is mindful of the Government’s policy on electricity interconnection. Moreover, the CRU takes into consideration the European guidance and best practices for such assessments. 6 Regulatory framework that sets the maximum (cap) and a minimum (floor) on the level of revenues that can be gained/lost by interconnector project promoters. 11
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities The CRU notes that Element Power has submitted the Greenlink Interconnector application and requested from the CRU to make a determination pursuant to Section 2A of the Electricity Regulation Act 1999 (as amended) (the Act) that it is in the public interest for Greenlink to be considered to be part of the transmission system for the purposes of calculating charges and imposing charges for use of the transmission system, and approve the proposed charging methodology for Greenlink pursuant to section 35 of the Act which is based on a 25 year Cap and Floor regime. 1.5.1. Electricity Regulation Act 1999, Section 2A Under the Act interconnector developers may apply directly to the CRU for a determination on their application. Section 2A of the Act states that an interconnector owned by a person other than the Board (i.e. ESB) may, where the CRU determines that it is in the public interest, be considered to be part of the transmission system for the purposes of calculating and imposing charges for the use of the transmission system (as set out in Section 35 - Charges for connection to and use of transmission or distribution system). 1.5.2. Electricity Regulation Act 1999, Section 9 Pursuant to Section 9 of the Act, the CRU has responsibilities which include: • protect the interests of final customers; • promote competition, efficiency and the use of renewable and sustainable energy; • not discriminate unfairly between relevant stakeholders; • contribute to the development of the internal market and to the development of compatible regulatory frameworks between regions of the European Union, by engaging, co-operating and consulting with other national regulatory authorities, the Agency and with the European Commission in regard to cross-border issues; • cooperate with other regulatory authorities at a regional level to foster operational arrangements to enable an adequate level of interconnection capacity within the region and between regions to allow the development of effective competition and improvement of Security of Supply; and • cooperate with other regulatory authorities at a regional level to develop rules on access to cross border infrastructure including allocation of capacity and congestion management. 1.5.3. Electricity Regulation Act 1999, Section 16A Section 16A of the Act provides that, with the consent of the Minister, the CRU may secure the construction of an interconnector by: • a competitive tender; 12
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities • an authorisation granted to a person without a prior competitive tender where the person demonstrates, to the satisfaction of the CRU, that the granting of an authorisation, subject to such conditions as the CRU deems necessary and appropriate, is in the long term interests of final customers; or • requesting the transmission system operator to provide for the construction of an interconnector in its development plan. 1.5.4. ENTSO-E’s TYNDP The European Commission selects PCI projects from a list of projects included in ENTSO- E’s pan-European network development plan for the next ten years (TYNDP). The principal aim of the plan is to provide a consistent view of the pan-European electricity infrastructure, signal potential gaps in future investment and capture the wider dynamics of the European electricity market. ENTSO-E use several scenarios to represent future developments of the power system. ACER recommends that project promoters use TYNDP scenarios in their CBAs submitted to NRAs, while noting that additional robust scenarios can also be provided. ENTSO-E update their plan every two years.7 The previous edition, the TYNDP 2016, was published in December 2016. The 2018 edition is currently under preparation.8 1.5.5. ENTSO-E’s CBA Guideline The ENTSO-E has developed guidelines for the CBA of grid development projects, including interconnectors9. According to these guidelines, the scenarios considered in the economic assessment should: • be coherent, comprehensive and internally consistent; • consider interaction of economic key parameters such as economic growth, fuel prices, CO2 prices, etc. as well as the impact of any significant risk affecting the results of the CBA over the investment horizon; and • be characterised by: • a generation portfolio, including a forecast of power plant installations and retirements, type of generation, etc.; • a demand forecast, e.g. impact of efficiency measures, rate of growth, shape of demand curve, etc.; and • exchange patterns with the systems outside the studied region. The ENTSO-E Guideline also provides an economic assessment framework that considers a project’s benefits, cost and impact on society, as summarised in the figure below. 7 See TYNDP website for updates. 8 As such, CRU CBA modelling is based on draft TYNDP 2018 scenarios. 9 ENTSO-E Guideline for Cost Benefit Analysis of Grid Development Projects, 29th July 2016 13
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Figure 3: ENTSO-E economic assessment framework ACER recommends that project-specific CBAs are consistent with the ENTSO-E’s economic assessment framework. 1.5.6. CRU’s policy to date Since late 2015, the CRU has published six documents which outline the CRU process in the development of a regulatory framework for assessing electricity interconnectors, in particular those with a PCI status. These documents are listed below: • CER/15/269: Information on PCI Incentive Methodology in accordance with Article 13(6) of EU Regulation 347/2013; • CER/15/284: Consultation on Review of Connection and Grid Access Policy: Initial Thinking & Proposed Transitional Arrangements; • CER/16/239: Information on Policy for Electricity Interconnectors – Consultation Process and Call for Initial Comments; • CRU17300: Direction on Grid Connections for Electricity Interconnectors with PCI status; • CRU18056: Information on Electricity Interconnectors; • CRU18119: Consultation on Greenlink Electricity Interconnector; • CRU18131: Consultation on Assessment Criteria for Electricity Interconnection Applications. • CRU18221: Decision on Assessment Criteria for Electricity Interconnection Applications. 14
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities 1.5.7. Government’s Policy on Electricity Interconnection When assessing electricity interconnectors, the CRU is mindful of the Government’s policy on electricity interconnection. Relevant Government’s policy documents: • Government Policy Statement on the Strategic Importance of Transmission and Other Energy Infrastructure; • Ireland’s Transition to a Low Carbon Energy Future 2015-2030; • Draft National Policy on Electricity Interconnection in Ireland: Public Consultation; • National Policy Statement on Electricity Interconnection. 1.6. Structure of this Paper This paper is structured as follows: • Section 1, provides an introduction to the CRU and provides background information to this paper. • Section 2, provides a summary of the responses received and the CRU’s position. • Section 3, provides an overview of the CRU CBA of Greenlink. • Section 4, summarises the key findings of the CRU assessment. • Section 5, outlines the CRU’s determination on the application “Public Interest Test”. • Section 6, provides the next steps with regards to the Greenlink Interconnector application. 15
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities 2. Summary of Responses Received On 18 June 2018 the CRU published a consultation on the Greenlink electricity interconnector application. The CRU requested comments on the questions raised in the consultation paper. There were: • Are there any other specific factors that the CRU should consider in assessing the Greenlink CBA? • Is there any additional information the CRU should consider when determining whether the Greenlink interconnector is in the public interest or not? • Are there any other specific factors that the CRU should consider in assessing the Greenlink technical overview report? • Are there other specific factors that the CRU should consider in selecting the appropriate regulatory approach? The CRU received 18 responses to the consultation paper, of which none were confidential. The main points made by respondents are summarised below. The submissions are published on the CRU’s website alongside this paper. 2.1. Are there any other specific factors that the CRU should consider in assessing the Greenlink CBA? In the consultation paper (CRU18119) the CRU requested respondents’ views on the factors that the CRU should consider in its CBA of Greenlink. The majority of respondents stated that Security of Supply and de-rating factors should be considered. Several respondents noted that it is necessary to examine whether Greenlink would lead to any increase in costs elsewhere in the energy system, that the energy user would be required to cover. A number of respondents highlighted that the impact on existing gas-fired power plants should be considered, in particular where additional interconnection results in lower Load Factors. Some respondents noted that the CRU should consider if investment in alternative infrastructure be more beneficial to Irish consumers. With respect to Brexit impacts, a few respondents noted that related impacts on efficiency of interconnector flows and costs between the two countries need to be taken into account. One respondent noted that the CRU should consider if the I-SEM would still be a single market. A number of respondents suggested that the level of reliability of Greenlink needs to be taken into account. The majority of respondents stated that the CRU CBA needs to look at whole-system costs including deep reinforcement costs, any knock-on effect on the wider market and any ramifications for energy policy goals such as decarbonisation, sustainability and competition. 16
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities CRU Response The CRU has considered the points submitted regarding the Greenlink CBA assessment. The CRU notes that while interconnectors may provide security of supply benefits, as some respondents acknowledge, those benefits are difficult to quantify. An interconnector provides security of supply benefits if it improves the power system's ability to ensure adequate supplies to meet demand. Security of supply events (i.e. instances when supply falls short of demand) tend to be relatively rare, and therefore the analysis of security of supply benefits requires a probabilistic assessment of many system conditions (including temperature, wind speed, generator outage patterns, correlation with other markets, etc.). Such data was not readily available, and therefore the CRU CBA did not quantify security of supply benefits in this manner. Instead, a simpler security of supply analysis was conducted with the available data, which is described below in section 3 of this paper. Some stakeholders have raised the issue of de-rating factors for interconnectors in the context of security of supply. These de-rating factors determine the amount of capacity that interconnectors can offer into the Capacity Market. If the interconnectors clear in the Capacity Market but fail to provide that amount of de-rated capacity during stress events, it may have security of supply implications. The CRU has modelled a sensitivity on the Greenlink interconnector availability. In the sensitivity the CRU has assumed an availability rate of 70% for Greenlink instead of 97%. This sensitivity shows that when Greenlink availability is lower, there are more flows on other interconnectors to Ireland, e.g. EWIC or Moyle. The sensitivity also shows that although net benefits are lower compared to the case where Greenlink availability is assumed to be 97%, the interconnector still generates positive net benefits to Irish consumers and other stakeholders. In relation to additional costs in the energy system, the CRU has monetised Social Economic Welfare (i.e. consumer surplus, producer surplus, congestion rents, etc.) and security of supply.10 In its CBA the CRU has sought to estimate the potential impact of the interconnector on gas tariffs through its impact on power sector gas demand (i.e. interconnector imports displacing some domestic gas-fired generation). This is discussed further in section 3 of this paper. The CRU notes the respondents’ comments in relation to investment in alternative technology solutions. Regarding investments, the CRU notes that in a free market economy, a vast majority of investment decisions should be driven by market forces. The Government may seek to incentivise investments in particular technologies to achieve its national and EU policy objectives. The CRU’s role is to ensure a well-functioning and efficient energy market for the benefit of Irish consumers, rather than determining or promoting certain investment decisions. The CRU has considered the potential impact of Brexit on the Greenlink interconnector. CRU’s Brexit sensitivity assumes that GB is no longer part of the EU’s Internal Energy 10 Any benefits associated with the integration of renewable generation and CO2 emissions were already monetised under Social Economic Welfare. 17
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Market but that the Republic of Ireland (ROI) and Northern Ireland (NI) remain coupled. This is discussed further in section 3 of this paper. The CRU is aware that availability of EWIC and Moyle has been relatively low in recent years. In its CBA the CRU has assumed the same (relatively high) level of availability of all new and existing interconnectors. The higher availability of existing interconnectors results in more conservative CBA results for Greenlink, since existing interconnectors would compete with Greenlink. In relation to other costs, the CRU CBA of Greenlink has considered whole-system costs. These include: • shallow connection costs; • ongoing maintenance costs; • network reinforcement costs; and • Greenlink capital and operational expenditure. The CRU notes that EirGrid assessed the need for any additional transmission network needs that are driven by the connection of Greenlink to the Irish system. EirGrid’s analysis shows that the solutions required are relatively minor in relation to the scale of Greenlink’s application and consist of a number of 110kV network solutions. 2.2. Is there any additional information the CRU should consider when determining whether the Greenlink interconnector is in the public interest or not? Element Power submitted the Greenlink interconnector application under Section 2A of the Act and required the CRU to consider whether Greenlink is “in the public interest”. The CRU requested respondents’ opinions on the public interest assessment. The majority of responses received agreed with the CRU’s approach to conduct its own CBA of Greenlink and identify the potential benefits and costs to Irish consumers. Several respondents highlighted that the CRU should consider EU and National renewable targets and policy objectives. The respondents highlighted that Greenlink could help to integrate renewables and reduce wind curtailment. A number of respondents stated that the CRU needs to consider the interaction with the gas market. The respondents noted that additional interconnection could have an impact on the gas network and could ultimately increase the price of gas and electricity. A few respondents noted that the CRU should consider the potential impact of Brexit when determining whether the Greenlink Interconnector is in the public interest or not and consideration should also be given to the potential impact on other European energy projects. 18
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities The majority of respondents noted that the Security of Supply should be taken into consideration. One respondent noted that Greenlink can make a positive contribution to Security of Supply and system reliability. Some respondents noted that the most efficient solution for meeting national and EU targets may be delivered by alternative technology solutions. The respondents noted that alternative options should be considered. CRU Response The CRU has considered the points made by all respondents regarding the public interest. The CRU has conducted its own CBA of Greenlink to test the boundaries of Element Power’s own CBA of the Greenlink interconnector and the key inputs and assumptions which may drive better or worse outcomes for Irish consumers and other stakeholders, i.e. whether the Greenlink interconnector is likely to be in the public interest. This is discussed further in section 3 of this paper. In its CBA the CRU has also undertaken a high-level assessment of other Greenlink impacts, including on Irish gas transmission tariffs, Security of Supply, Renewable energy sources integration (RES), and the Greenlink interconnector impacts under a Brexit scenario. In addition, the CRU examined how other potential interconnectors connecting Ireland to other countries (e.g. another interconnector to France) would impact the incremental benefits driven by Greenlink. With regards to Security of Supply benefits, the CRU notes that the analysis of Security of Supply benefits requires a probabilistic assessment of many system conditions (including temperature, wind speed, generator outage patterns, correlation with other markets, etc.). The CRU notes that Element Power did not conduct a probabilistic assessment of Security of Supply benefits. Instead, Element Power used the de-rating factor of the Greenlink interconnector multiplied by the Capacity Market clearing price.11 The CRU considered the Security of Supply benefits driven by Greenlink in one of its scenarios using a simplified approach that is based on ten different climatic years.12 Further information on the Security of Supply benefits can be found in section 3 of this paper. In relation to alternative technology solutions to meet national and EU targets. As noted above, Government may seek to incentivise investments in particular technologies to achieve its national and EU policy objectives. 2.3. Are there any other specific factors that the CRU should consider in assessing the Greenlink technical overview report? In the consultation paper (CRU18119) the CRU requested respondents’ views on the Greenlink technical overview report and other specific factors that the CRU should consider. 11 See section 3.4. 12 See section 3.5. 19
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities Several respondents believe that the proposed technology for Greenlink is now quite extensively established and a high level of performance and reliability in service can be expected. However, some respondents noted that the CRU should seek further information regarding the technical details. Some of the respondents advised that before any final decision is made on the Greenlink interconnector, a detailed technical assessment should be carried out. One respondent raised concerns regarding the risks posed to the project from shipping traffic in the area, particularly given past events relating to interconnectors/pipelines and anchors from ships. Another respondent suggested the consideration of interconnector ancillary services, sub- synchronous response and ramp rates in the CRU assessment. One respondent noted that the CRU should ensure that the Greenlink interconnector complies with all of the EirGrid system requirements and satisfies Grid Code conditions and will support system security requirements as necessary including ancillary services and DS3 provisions. CRU Response The CRU notes the views and comments submitted regarding the Greenlink technical requirements. The CRU notes that this paper is focused on the public interest test. The CRU accepts that further detail and clarity need to be provided by Greenlink developers to the CRU for a detailed technical assessment of the Greenlink interconnector before any final project assessment decision is made. In the next stage of the assessment, the CRU will require Greenlink developers to submit details on the seabed surveys and additional technical & cost details. With reference to the EirGrid system requirements and Grid Code conditions, the CRU notes that the interconnector operator licence requires the interconnector owner to comply with the provisions of the Grid Code, Distribution Code, Metering Code and the SEM Trading and Settlement Code. 2.4. Are there other specific factors that the CRU should consider in selecting the appropriate regulatory approach? Ofgem has provisionally granted a Cap and Floor for Element Power, which would apply to 50% of the project costs and revenues.13 Element Power proposed a symmetrical Cap and Floor regulatory approach to the one provisionally granted by Ofgem, which would apply to the remaining 50% of the project costs and revenues.14 In the consultation paper 13 Ofgem, Decision on the Initial Project Assessment of the Greenlink interconnector, 30th September 2015 14 p9, Greenlink interconnector application 20
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities (CRU18119) the CRU requested views from respondents regarding the proposed regulatory approach for Greenlink. There was a broad support for further CRU consultation on the appropriate regulatory regime. The respondents in general recognised the need for a careful consideration on a Cap and Floor regulatory regime. One respondent noted that the duration of the Cap and Floor regime needs to be defined. The same respondent requested a clarification of whether the regulatory regime would remain fixed for the duration of the regime. A number of respondents were concerned that variability in the operation of the interconnector could have an impact on network tariffs for Irish electricity consumers, which could have broader economic impacts. Another respondent advised to take into account possible Brexit scenarios and a recent decision by the French Regulator (CRE) in their deliberation 2017-25315. One respondent noted that the CRU should set out a clear set of Key Performance Indicators (KPI) to ensure that the interconnector is operated as efficiently as possible. CRU Response The CRU considered the views and recommendations submitted regarding the regulatory approach for the Greenlink interconnector. The CRU notes that this paper is focused on the CBA of Greenlink and the public interest question. The CRU also noted that if the CRU CBA revealed that Greenlink would generate overall (net) benefits to Irish consumers, then the CRU would consider and consult upon the appropriate regulatory regime that is justified by public interest, e.g. a Cap and Floor regime for Greenlink. The CRU notes that in the next stage the CRU will engage with the Ofgem to explore the potential for a Final Project Assessment process that takes both the Irish and GB regulatory separate decision-making processes into account. 2.5. Other comments A few respondents noted that the Greenlink interconnector application should be assessed against the criteria set out in (CRU18131). One respondent noted that Greenlink’s Brexit scenarios modelling should be shared publicly. 15 The CRE delayed a decision on a proposed interconnector to the UK pending Brexit negotiations - https://www.google.ie/url?sa=t&rct=j&q=&esrc=s&source=web&cd=1&cad=rja&uact=8&ved=2ahUKEwibkMfgk- rcAhUQM8AKHXM_DHcQFjAAegQIABAC&url=https%3A%2F%2Fwww.cre.fr%2Fen%2Fcontent%2Fdownload%2F16726%2F2 06259&usg=AOvVaw03tuj9Bf-UmmBlx6MVCu96 21
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities CRU Response The CRU notes that the assessment criteria for electricity interconnector applications (CRU18131) is developed for the assessment of applications the CRU has received, or will receive, from the developers of the electricity interconnection projects. The CRU assessed the Greenlink interconnector application considering the CRU criteria.16 In addition, the CRU CBA modelling approach of Greenlink is based on ENTSO-E Guideline. The CRU highlights that following Greenlink’s project submission in December 2017, it submitted additional analysis on: • The potential Security of Supply benefits associated with Greenlink; and • The impact of Greenlink on Social Economic Welfare in a Brexit world. 16 The CRU carries out a holistic assessment against all of the criteria and its decision will depend on the specific case. In other words, the application will be viewed in the round against the criteria, and failure to provide certain information or meet certain criteria will not necessarily mean that the application will be rejected or negatively assessed. 22
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities 3. CRU CBA of Greenlink The CRU reviewed the CBA of Greenlink interconnector submitted by Element Power and considered that further analysis was needed to understand the boundaries of impacts on consumers and other stakeholders before a determination can be reached on whether the Greenlink interconnector is in the public interest. The CRU has conducted its own CBA of Greenlink supported by independent economic and technical advisors. The results of the CRU CBA of Greenlink are summarised below. 3.1. Methodology and Modelling Approach To assess the potential costs and benefits of Greenlink, the CRU has modelled three scenarios and two sensitivities of the European electricity market to assess the impact of Greenlink on Social Economic Welfare. The CRU’s CBA modelling approach is based on ENTSO-E CBA Guideline.17 The CRU has modelled scenarios based on the TYNDP 2016 and 2018 scenarios produced by ENTSO-E. For TYNDP 2016, ENTSO-E developed four ‘visions’ out to 2030 along two main dimensions: • The x-axis represents the degree of European cooperation to reduce greenhouse gas emissions by 80-95% on 1990 levels by 2050; and • The y-axis relates to the relative speed of green transition. Both axes provide a spectrum of progress. Vision 1 projects the slowest progress in decarbonising electricity generation (see figure 4 below). Figure 4: TYNDP 2016 Visions 17 See section1.5.5 for details. 23

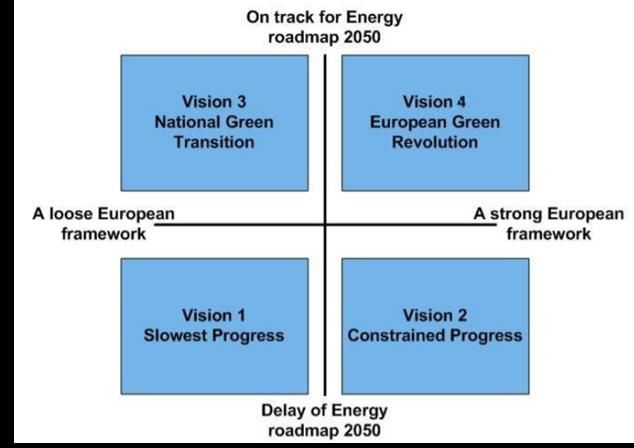

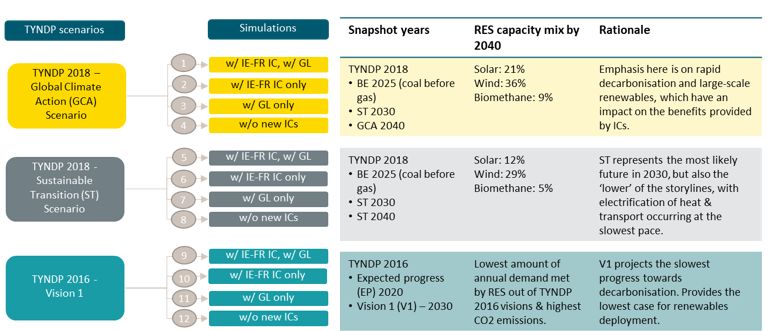

An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities For TYNDP 2018, ENTSO-E considered three storylines for 2030 and 2040. The CRU has modelled the two storylines highlighted in light blue below: • Sustainable Transition; and • Global Climate Action. Figure 5: TYNDP 2018 Scenarios The scenarios modelled (highlighted in light blue in Figures 4 and 5 above) were: • TYNDP 2016 Vision 1 (V1)18 – Out of the TYNDP 2016 Visions, Vision 1 projects the slowest progress towards decarbonisation, and therefore provides the lowest case for renewables deployment. This scenario resulted in the lowest benefits compared to other scenarios (snapshots years 2020 and 2030); • TYNDP 2018 Sustainable Transition (ST) 19 – Out of the three possible storylines, ST represents the most likely future in 2030, but also the ‘lower’ of the storylines, with electrification of heat and transport occurring at the slowest pace. ST 2030 was selected over DG 2030, as the latter presents a future that departs significantly from current projections (snapshot years 2025, 2030 and 2040); and • TYNDP 2018 Global Climate Action (GCA) – Beyond 2030, the CRU has also modelled GCA in 2040 (in addition to ST), as the emphasis in this storyline is on rapid 18 The CRU notes that the TYNDP 2016 V1 scenario was modelled for 10 climatic years reflective of a variety of system conditions including temperature, wind speed, generator outage patterns, correlation with other markets, etc. The potential Security of Supply impacts of Greenlink (discussed below) were also considered for this scenario. 19 The TYNDP 2018 ST and GCA scenarios are based on one climatic year that represents average conditions with respect to weather, demand, and plant availability (i.e. 2007). Additionally, we note that the TYNDP 2018 scenarios used for this analysis are still in draft form. 24
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities decarbonisation and large-scale renewables, which both have an impact on the benefits provided by interconnectors20 (snapshot year 204021). The CRU has considered these scenarios with and without an additional interconnector project to France (referred to as ‘IE-FR interconnector’ in figures and tables). A summary for the adopted scenarios is set out in the figure below. Figure 6: Scenarios and Simulations To quantify the costs and benefits of Greenlink, the simulations with and without Greenlink were compared, as shown in the figure below: Figure 7: Quantifying the change in costs and benefits due to Greenlink In addition to the scenarios, the CRU has modelled two sensitivities on the ST scenarios. These sensitivities are: • Brexit sensitivity – to model the potential impact of Brexit on Greenlink; and 20 Although the TYNDP 2018 Distributed Generation (DG) pathway is also an interesting scenario for the EU electricity system, the CRU has not modelled this pathway for the assessment of the Greenlink CBA. The DG pathway is driven by prosumers, decentralised development, with focus on end-user technology, high penetration of electric vehicles, the assumption that PV and batteries are widespread and that high levels of demand side response are available. 21 This scenario is not active until 2040 and offers an alternative future to the ST scenario post-2030, whereby sudden action is taken, and rapid decarbonisation occurs after 2040, above that projected in the ST scenario. 25
An Coimisiún um Rialáil Fóntas Commission for Regulation of Utilities • System Non-Synchronous Penetration (SNSP) – the SNSP limit of 75% of non- synchronous generation22 was added to the ST scenario. The SNSP includes the non-synchronous generation and net interconnector imports as a percentage of the demand and net interconnector exports. This was done for SEM only as CRU assumes that only the day-ahead markets are coupled, and the SNSP limit applies in other trading timeframes, i.e. the intraday and balancing markets. A summary for the adopted sensitivities is set out in the figure 8 and figure 9. Figure 8: Brexit Sensitivities Figure 9: SNSP Sensitivity The CRU has also undertaken a high-level assessment of other Greenlink impacts, including on Security of Supply and on Irish gas transmission tariffs as a result of changes in gas fired generation in the SEM. 3.2. CRU CBA Results of Greenlink In this section, the CRU presents the results of its CBA for the modelled scenarios and sensitivities. The CRU has monetised the benefits and costs of: • Improved security of supply (€); • Social Economic Welfare (€); • Total interconnector project expenditures (€). The CRU has also quantified: • RES integration (MWh); • CO2 emissions (tonnes). 22 Non-synchronous generation, i.e. wind, solar, interconnection 26
