Davenport Diamond Public Open House For more info go to: metrolinx.com/davenport For further feedback: Davenport@metrolinx.com NOVEMBER 20, 2019
PROJECT OVERVIEW What is the project? The Davenport Diamond refers to the intersection where the Barrie GO corridor meets the CP rail tracks near Dupont Street. The Davenport Diamond Grade Separation Project will prepare and complete the construction of an elevated twin-track guideway between approximately Bloor Street and Davenport Road west of Lansdowne Avenue, eliminating at-grade crossings including the busy CP Rail intersection near Dupont Street. Why is it happening? The Davenport Diamond is one of the busiest train intersections in North America. As Metrolinx connects our region with two-way all-day GO service, it means more trains will be passing through and we need a solution to this congestion problem. Who is the builder? Graham Commuter Rail Solutions was selected by Metrolinx and Infrastructure Ontario to construct the Davenport Diamond Elevated Guideway. DAVENPORT DIAMOND
CONSTRUCTION TIMELINE: BY MILESTONE Contract Award July 2019 Detailed Design Diversion Track July 2019 – March 2020 Diversion Track Construction March – September 2020 Detailed Design Mainline Track July 2019 – September 2020 New West Mainline Construction September 2020 – May 2022 New East Mainline Construction May 2022 – March 2023 Final Completion May 2023 Public Realm Construction Summer 2023 Did you know? Davenport Diamond gets its name from the diamond-shaped crossing with CP rail line. DAVENPORT DIAMOND
PUBLIC AMENITIES IN THE GUIDEWAY • Guideway Cladding – The Guideway has been specially designed with a continuous ribbon of lightly “bright” anodized aluminum panels to gently reflect light, blend in with its surroundings, and visually lighten the structure. • Skylight – A continuous “skylight” element designed to bring light and rainwater to the area under the bridge. This fosters plant growth in the landscaped areas beside the multi-use path by allowing natural irrigation of the plantings from rainfall. • Lighting – An enhanced lighting aims to increase safety and bring a sense of delight to the Greenway while minimizing the light pollution to nearby residences. • Noise and Vibration Mitigation – For sound mitigation, acoustic treatment includes sound absorptive treatment on the inside of the 2-meter sound barrier. Taller barriers at-grade will be examined during detailed design, as well as vibration Bridge Rendering at Dupont illustrating the mitigation through bridge bearing pads and track fixation. Guideway Cladding • Vandalism Prevention – Several strategies will be used to address vandalism including employing Crime Prevention Through Design (CPTED) principles. Generally, the Guideway cladding is difficult to reach where it is raised, and as a surface it is easier to clean than concrete. DAVENPORT DIAMOND
UPDATE ON THE PUBLIC REALM Benefits of separating the Public Realm from the Guideway project • A Design-Bid-Build (DBB) procurement model provides greater control over the design process. • Allows Metrolinx to engage the community more effectively and this procurement model gives us greater control over what is built. • Ensures that considerations around the long-term operations and maintenance are built into the design of the public realm. The design will be developed with a focus on durability and ease of maintenance for both the park elements and the rail infrastructure. Schedule • Public realm schedule has not changed: construction will start in 2023 after the Guideway is complete and finish in about 2024. • The Greenway is built after the Guideway project is completed so that we can properly restore and improve the landscape without risking damage from Guideway construction. Continuity of Community Engagement • Metrolinx will work with the Community Advisory Committee (CAC) to ensure continuity in the design process for the public realm. Continuity in the design of the public realm • The original design scope and intent will be the building blocks for the public realm project moving forward. • Metrolinx will ensure that considerations around the long-term operations and maintenance are built into the design of the project. DAVENPORT DIAMOND
GUIDEWAY: LOCAL NEIGHBORHOOD BENEFITS • Some of the key features of the public realm project will include sustainably designed green spaces, new east-west connections, a new multi-use trail, pedestrian bridges, pedestrian underpasses, and enhanced connections to transit. • The Davenport Diamond Public Realm Project can act a catalyst for social and economic development – parks attract the talent, which attracts the companies, which drive economic growth. • Opening up the rail corridor to public uses (multi-use trail, parkland) will create new primary frontages for the commercial and industrial buildings adjacent to the corridor. • The Davenport Diamond Public Realm Project is intended to provide enhanced connectivity to the communities on both sides of the rail corridor and to pedestrian and bicycle paths linking to other parts of the city. DAVENPORT DIAMOND

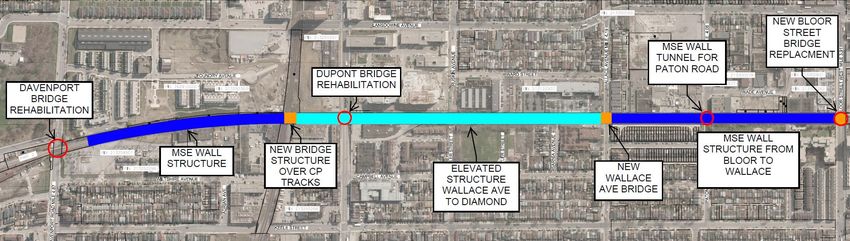

PROJECT OVERVIEW The Davenport Diamond Grade Separation Project will prepare and complete the construction of an elevated twin-track guideway between Bloor Street and Davenport Road west of Lansdowne Avenue, eliminating at-grade crossings including the busy CP Rail intersection near Dupont Street. N DAVENPORT DIAMOND
BLOOR STREET WEST BRIDGE Replacement of existing bridge over Bloor Street west of Lansdowne Avenue N Details: • Maintain existing track on east side of existing bridge and removal of existing rail alignment • Removal and replacement of west half of bridge • Construction of new west mainline track on west portion of bridge • Removal of existing track on east side of existing bridge • Removal and replacement of east half of bridge DAVENPORT DIAMOND
MECHANICALLY STABILIZED EARTH (MSE) WALLS AND PATON ROAD UNDERPASS Construction of MSE walls to raise tracks to match grade of elevated guideway and new pedestrian underpass to provide new pedestrian connectivity at Paton Road N Details: • New diversion track installation on east side of rail corridor and removal of existing rail alignment • Installation of underpass structure at Paton Road • Construction of new MSE walls adjacent to and above underpass structure • Installation of new west mainline track on top of MSE walls and removal of diversion track • Installation of pedestrian pathway through underpass DAVENPORT DIAMOND
WALLACE AVENUE BRIDGE Construction of new bridge over Wallace Avenue to remove existing rail crossing N Details: • New diversion track road crossing installation on east side of rail corridor, removal of existing rail alignment • Construction of elevated guideway piers – concrete piles, cast-in-place concrete columns • Construction of bridge south abutment – concrete piles, cast-in-place concrete abutment wall • Tie in of south MSE wall to south abutment wall • Installation of steel girders and concrete bridge deck • Installation of new west mainline track on top of bridge structure & removal of diversion track road crossing DAVENPORT DIAMOND
DUPONT STREET BRIDGE REHABILITATION Rehabilitation of existing bridge over Dupont Street to retain pedestrian connectivity between north and south side of Dupont Street below new elevated guideway N Details: • New diversion track installation on east side of bridge deck and removal of existing rail alignment • Construction of elevated guideway – concrete piles, cast-in-place concrete columns, precast concrete girder segments • Installation of new west mainline track on top of elevated guideway and removal of diversion track on existing bridge deck • Partial demolition and reconstruction of existing bridge structure DAVENPORT DIAMOND
ELEVATED GUIDEWAY Construction of elevated guideway to remove at grade rail from existing corridor and tie into CP Bridge and remove existing Davenport Diamond rail crossing N Details: • New diversion track installation on east side of rail corridor, removal of existing rail alignment • Construction of elevated guideway – concrete piles, cast-in-place concrete columns, precast concrete girder segments • Tie in of elevated guideway to new Wallace and CP bridges and MSE walls to the north and south of elevated structure • Installation of new west mainline track on top of elevated guideway and removal of diversion track in existing rail corridor DAVENPORT DIAMOND
CP RAIL BRIDGE Construction of new bridge over CP rails to eliminate existing diamond rail crossing N Details: • New temporary Davenport Diamond installation (TDDI) on east side of existing rail and removal of existing diamond rail crossing • Construction of elevated guideway piers – concrete piles, cast-in-place concrete columns • Construction of bridge north abutment – concrete piles, cast-in-place concrete abutment wall • Tie in of north MSE wall to north abutment wall • Installation of steel girders and concrete bridge deck • Installation of new west mainline track on top of bridge structure and removal of TDDI rail crossing DAVENPORT DIAMOND
DAVENPORT ROAD BRIDGE REHABILITATION Rehabilitation of existing bridge over Davenport Road N Details: • Partial bridge rehabilitation • Installation of new west mainline track on bridge structure • Remaining partial bridge rehabilitation DAVENPORT DIAMOND
SAFETY: DURING CONSTRUCTION During construction, necessary traffic accommodations and signage will be set at major intersections to eliminate public interaction with construction and to inform pedestrians of upcoming construction areas and detours. SAFETY: AFTER CONSTRUCTION The Davenport Diamond is one of the busiest train intersections in North America. As Metrolinx connects the region with two-way all-day GO service, more trains will be passing through this intersection. The construction of the elevated guideway for GO trains above the CP rail tracks will resolve rail congestion issues, while also removing the risk of collision between GO trains and CP at the existing intersection. DAVENPORT DIAMOND 15
NOISE AND VIBRATION: DURING CONSTRUCTION Work will be designed to meet the City of Toronto bylaws for noise and vibration. Efforts to reduce noise include: no blasting or pile driving, using saws wherever possible rather than jackhammers, using mufflers or sound enclosures around generators, and scheduling most noisy activities during the day. Routine and continuous monitoring will be conducted during construction work to assess any potential noise and vibration impacts to nearby properties and ensure they are within guidelines. DAVENPORT DIAMOND
NOISE AND VIBRATION: AFTER CONSTRUCTION Noise barriers will be present along the elevated guideway rail lines. Compliance monitoring of noise and vibration will be completed during commissioning of the new rail lines to ensure that all design levels for noise and vibration are achieved. The new elevated railway will be provided with acoustically absorptive noise barrier walls. The new elevated guideway structure is anticipated to reduce the vibration transmitted to surrounding properties, minimizing the acoustic environment, and noise and vibration impacts. Noise walls and sound absorbing pads on elevated guideway DAVENPORT DIAMOND
NIGHT WORK Why is there work at night within the rail corridor? Certain construction activities and equipment are limited to the window of time when CN/GO trains don’t run (typically from the final train around 12:00AM until 6:00AM). Night work will be required throughout the duration of the project where necessary to limit interaction with active trains and ensure the safety of crews working within the rail corridor. The community will be notified in advance of any anticipated overnight work. What sort of work activities will be happening? Borehole drilling throughout the rail corridor occurred during September/October 2019 in order to collect geotechnical soil characteristics necessary for design engineering. Hydrovac equipment is anticipated to be present in the corridor in order to expose utilities and collect design information through November 2019. This equipment will be mounted to the rails to attain access necessary through the full corridor. DAVENPORT DIAMOND
ACCESS AND STAGING Construction Stage Access Points HONI Diversion Track Installation All Access Points Caledonia Park Road Bloor Street Bridge Bloor, Wade Foundry Ave Replacement South MSE Wall Construction Wade, Paton, Wallace Wiltshire Avenue Elevated Guideway Piling and Wallace, Antler, Campbell Powerhouse Street Columns Campbell Avenue Elevated Guideway Girder Wallace, Antler Erection Wallace Bridge Wallace Antler Street Dupont Bridge Antler North MSE Wall Construction Caledonia, Foundry, Wiltshire, Wallace Avenue Lansdowne Yard Powerhouse Paton Road Davenport Bridge Rehabilitation Caledonia, Foundry Wade Avenue West Mainline Track Install Bloor, Caledonia, Powerhouse, Foundry Bloor Street Potential Access Point Diversion Track Removal, Final Bloor, Wade, Wallace, Foundry, Project Laydown Area Grading and Landscaping Caledonia DAVENPORT DIAMOND
ROAD CLOSURES Bloor Street Staged closures for removal and reconstruction of new Bloor Street bridge • Removal of existing girders • Removal and replacement of north and south abutments • Installation of new girders Closures will be in place for both the west and east demolition and construction DAVENPORT DIAMOND
ROAD CLOSURES Wallace Avenue Partial and full closures for: • Installation of diversion track and at grade crossing • Construction of new Wallace Avenue Bridge • Removal of at grade crossing and diversion track Access point for construction traffic into rail corridor Antler Street Closure of dead end at Antler Street as access point to the rail corridor for construction Dupont and Davenport Staged closures at each location for bridge rehabilitation DAVENPORT DIAMOND
TREES AND VEGETATION • Our contractor will have to remove some vegetation within Metrolinx’s right-of-way in order to facilitate Guideway construction. But we’re also protecting many trees along the corridor, particularly the Siberian Elm trees in our corridor that border on Campbell Park. • A Vegetation Compensation Protocol is being developed for all our construction projects. Compensation for trees within private lands, including those on the boundary between Metrolinx and public or private lands, will follow the requirements of applicable bylaws and regulations. • The species will include native, drought and salt tolerant trees which can also provide seasonal aesthetic benefits. These trees include honey, locust, eastern redbud, oak, maple and tulip trees. Tree protection will be followed for the Siberian Elms in Campbell Park DAVENPORT DIAMOND
MAINTAINING CONNECTIVITY DURING CONSTRUCTION Pedestrian and cyclist traffic will be affected during certain stages of construction to ensure public safety. Work will be staged to reduce closures as much as possible and will provide detour routes at all times. Bloor Street West • One sidewalk will remain open through different phases of the Bloor Street bridge construction where possible. • Sidewalk and cyclist routes will be closed during full road closures with detours. Wallace Avenue • Full weekend road and sidewalk closures will be required for rail installation and removal and bridge girder erection. • Local access to Campbell Avenue, Rankin Crescent and Ward Street will continue to be maintained. Dupont Street and Davenport Road • Intermittent closures will be required at Dupont and Davenport during bridge rehabilitation, pedestrian traffic will be maintained. • Full weekend road closures at Dupont Street will be required for the elevated guideway girder installation over the roadway. Pedestrian traffic will be rerouted during closures. DAVENPORT DIAMOND
CONNECTIVITY AFTER CONSTRUCTION Following completion of construction, pedestrian connectivity will be vastly improved. Paton Road Underpass • Introduction of underpass structure at Paton Road to provide connectivity between east and west sides of existing corridor and access to new park space. Wallace Avenue • Elevated guideway over Wallace Avenue will eliminate existing rail crossing in increasingly busy road corridor. Dupont Street • Elevated guideway over the existing Dupont Street bridge will provide pedestrian connectivity between the north and south sides of Dupont Street and create access to new park space. Elevated Guideway • Introduction of elevated guideway provides access to existing rail corridor for pedestrian access and park space. Multi-Use Trail • The new multi-use trail will become an integral part of a comprehensive pedestrian and bicycle network across the City of Toronto. DAVENPORT DIAMOND
IMPROVED MOBILITY The upgrades to the Davenport Diamond will allow for increased GO rail service on the Barrie GO corridor and will help support two-way, all-day GO rail service. By transforming GO Rail from a 9-to-5 commuter service to a two-way, all-day transit service, Ontario will benefit from the following: • More incentive for travellers to use the train as a travel mode • Faster travel times for transit riders and road users • Enhanced rail service with trains at least every 15 minutes, all day, in both directions over core portions of the network • Greater access to GO Transit and seamless rail travel throughout the GTHA DAVENPORT DIAMOND
HOW TO STAY INFORMED Communication Methods: Engagement Tools: • Email Messages to • Public Meetings Davenport Diamond • Technical Tours mailing list • Pop Ups • Construction Notices • School Visits • Sharing through elected • Working or Advisory officials (e-newsletter) Group meetings • Wayfinding and Signage • Business Liaison • Project Website Updates • Special Events • Frequently Asked Questions Stay Informed: metrolinx.com/davenport Questions or Comments: Davenport@metrolinx.com Claire Yang, Community Relations and Issues Specialist Tel: 416-202-7301 / E-mail: Claire.Yang@metrolinx.com DAVENPORT DIAMOND
COMMENTS AND QUESTIONS Please add a sticky note here with any comments or questions you have DAVENPORT DIAMOND
