Cape Town International Airport Runway Re-alignment and Associated Infrastructure Environmental Impact Assessment Report Report Prepared for Airports Company South Africa SRK Report Number 445354/04 NEAS Reference Number: DEA/EIA/0001606/2012 DEA Reference Number: 14/12/16/3/3/2/446 DEA&DP Reference Number: 16/3/1/6/6/A8/29/1142/12 Report Prepared by March 2015
SRK Consulting: 445354 Cape Town International Airport Runway Re-alignment EIA Report Page i Cape Town International Airport Runway Re-alignment and Associated Infrastructure Environmental Impact Assessment Report Airports Company South Africa NEAS Reference Number: DEA/EIA/0001606/2012 DEA Reference Number: 14/12/16/3/3/2/446 DEA&DP Reference Number: 16/3/1/6/6/A8/29/1142/12 SRK Consulting (South Africa) (Pty) Ltd The Administrative Building Albion Spring 183 Main Rd Rondebosch 7700 Cape Town South Africa website: www.srk.co.za Tel: +27 (0) 21 659 3060 Fax:+27 (0) 21 685 7105 SRK Project Number 445354 Compiled by: Peer Reviewed by: Sharon Jones Chris Dalgliesh Principal Environmental Consultant Partner and Principal Environmental Consultant Email: sjones@srk.co.za Authors: Sharon Jones, Scott Masson JONS/MASS/dalc 445354_CTIA Runway Realignment EIA Report_for public comment March 2015.docx March 2015
SRK Consulting: 445354 Cape Town International Airport Runway Re-alignment EIA Report Page iii Profile and Expertise of EAPs SRK Consulting (South Africa) (Pty) Ltd (SRK) has been appointed by Airports Company South Africa as the independent consultants to undertake the Environmental Impact Assessment (EIA) process required in terms of the National Environmental Management Act 107 of 1998 (NEMA). SRK Consulting comprises over 1 600 professional staff worldwide, offering expertise in a wide range of environmental and engineering disciplines. SRK’s Cape Town environmental department has a distinguished track record of managing large environmental and engineering projects and has been practising in the Western Cape since 1979. SRK has rigorous quality assurance standards and is ISO 9001 accredited. As required by NEMA, the qualifications and experience of the key individual practitioners responsible for this project are detailed below. Project Director and Reviewer: Christopher Dalgliesh, BBusSc (Hons); MPhil (EnvSci) Certified with the Interim Board for Environmental Assessment Practitioners South Africa (CEAPSA) Chris Dalgliesh is a Partner at SRK and the Head of the Environmental Department in Cape Town. He has over 19 years of experience as an environmental consultant working on a broad range of EIA, auditing, environmental planning and management, stakeholder engagement and environmental management system projects. Chris’s experience includes managing and co-ordinating major EIAs throughout Southern Africa and South America in the mining, energy, land-use planning and development, water and waste management, and industrial sectors. Project Manager: Sharon Jones, BSc Hons (Env. Sci); MPhil (EnviroMan) Certified with the Interim Board for Environmental Assessment Practitioners South Africa (CEAPSA) Sharon Jones is a Principal Environmental Consultant with over 17 years of experience, primarily in South Africa, Southern Africa (Mozambique, Angola and Namibia) and South America (Suriname). Sharon has managed EIAs across a number of sectors, provided input into due diligence studies, compiled numerous construction and Operations Phase EMPs for a range of projects, and has audited compliance with EMPs on a number of sites. She is also involved with the development of Environmental Management Frameworks. Sharon is a registered Professional Natural Scientist (Environmental Science) with SACNASP and a Certified Environmental Practitioner of South Africa (CEAPSA). Statement of SRK Independence Neither SRK nor any of the authors of this Report have any material present or contingent interest in the outcome of this Report, nor do they have any pecuniary or other interest that could be reasonably regarded as being capable of affecting their independence or that of SRK. SRK has no beneficial interest in the outcome of the assessment which is capable of affecting its independence. Disclaimer The opinions expressed in this report have been based on the information supplied to SRK by Airports Company South Africa and specialists appointed by SRK. SRK has exercised all due care in reviewing the supplied information, but conclusions from the review are reliant on the accuracy and completeness of the supplied data. SRK does not accept responsibility for any errors or omissions in the supplied information and does not accept any consequential liability arising from commercial decisions or actions resulting from them. Opinions presented in this report apply to the site conditions and features as they existed at the time of SRK’s investigations, and those reasonably foreseeable. These opinions do not necessarily apply to conditions and features that may arise after the date of this Report, about which SRK had no prior knowledge nor had the opportunity to evaluate. JONS/MASS/dalc 445354_CTIA Runway Realignment EIA Report_for public comment March 2015.docx March 2015
EXECUTIVE SUMMARY: DRAFT ENVIRONMENTAL IMPACT REPORT CAPE TOWN INTERNATIONAL AIRPORT RUNWAY RE-ALIGNMENT AND ASSOCIATED INFRASTRUCTURE NEAS Reference Number: DEA/EIA/0001606/2012 DEA Reference Number: 14/12/16/3/3/2/446 SRK Consulting (South Africa) (Pty) Ltd (SRK) has been 1 INTRODUCTION appointed by Airports Company South Africa to undertake the Scoping and Environmental Impact Reporting (S&EIR, Cape Town International Airport, one of three international also referred to as Environmental Impact Assessment airports in South Africa, currently comprises two active [EIA]) process required in terms of the National runways: the primary runway (Runway 01-19) and a Environmental Management Act 107 of 1998, as amended secondary runway (Runway 16-34) bisecting it (Figure 1). (NEMA). SRK has appointed a qualified team of Airports Company South Africa proposes to re-align the Environmental Assessment Practitioners (EAPs) to manage primary runway and construct parallel and rapid exit this process. taxiways. The re-aligned primary runway (Runway 18-36) The Scope of Work assessed in the EIA process includes: will be 3 500 m in length and will be built to international x Re-alignment of the primary runway; specifications, allowing larger (Code F) aircraft to land at Cape Town International Airport, enabling airport expansion x Construction of associated airport infrastructure (e.g. and increased airport capacity. Re-aligning the runway will taxiways); alleviate current development constraints, and will allow for x Bulk earthworks proposed to the east of the airport; more efficient future expansion of the airport. x Increased capacity potential provided for by the development in terms of number and/or frequency of flights and new flight paths facilitated by the development; and x Associated increase in (external) public road traffic to service increased passenger numbers. See page 8 for details on how you can participate in the process. 2 GOVERNANCE AND PLANNING FRAMEWORK Sections 24 and 44 of NEMA make provision for the identification of activities which may not commence without an Environmental Authorisation (EA), and stipulate the requirements for the assessment of such activities. The EIA Regulations, 2010, are contained in four Government Notices (GN) issued in terms of NEMA. GN R543 sets out two alternative procedures for authorisation processes: depending on the type of activity that is proposed, either a Basic Assessment (BA) process or a S&EIR process is required to apply for EA from the competent authority – in this case the National Figure 1: Locality Plan Department of Environmental Affairs (DEA). SRK has determined that the proposed runway re-alignment and associated infrastructure trigger activities listed in terms of Listing Notices 1-3 of the EIA Regulations, 2010 (Table 1). ‘n Afrikaanse weergawe van hierdie dokument is beskikbaar – kontak asseblief vir SRK. Uhlelo lwesiNgesi lolu xwebhu luyafumaneka –qhagamshela i-SRK.
Table 1: Listed activities triggered by the Project the revision, the feasibility of a number of layout and land No Description use planning options was analysed. The Airport Master Listing Notice 1 (requiring BA) Plan makes provision for the optimised utilisation of the 9 The construction of infrastructure longer than 1 000 m for airport site, ultimately assuming two (re-aligned) primary the bulk transportation of stormwater. runways. The proposed Project is considered the first key 11 The construction of channels, bulk stormwater outlet step to alleviate current development constraints, allowing 2 structures or 50 m of infrastructure or structures within a for optimal use of the airport as per the Airport Master watercourse or within 32 m of a watercourse. 3 18 The infilling or depositing of more than 5 m of any material Plan. into a watercourse. 2 24 Transformation of land bigger than 1 000 m to residential, 3 ENVIRONMENTAL PROCESS retail, commercial, industrial or institutional use, where land was zoned open space, conservation or had an The EIA Regulations, 2010, define the detailed approach to equivalent zoning. the S&EIR process, which consists of two phases: the 28 The expansion of or changes to existing facilities for any Scoping Phase (completed in July 2014) and the Impact process or activity where such expansion or changes to will result in the need for a permit or license in terms of Assessment Phase (current phase) (see Figure 2). national or provincial legislation governing the release of emissions or pollution. 39 The expansion of channels or bulk stormwater outlet Submit Application Form(s) structures, within a watercourse or within 32 metres of a watercourse. 50 The expansion of airports where the development footprint will be increased. Authority Listing Notice 2 (requiring S&EIR) Acceptance 5 The construction of facilities or infrastructure for any process or activity which requires a permit or license in terms of national or provincial legislation governing the Scoping Report generation or release of emissions, pollution or effluent. 7 The construction of runways or aircraft landing strips longer Public Comment than 1.4 km. Period The physical alternation of undeveloped, vacant or derelict 15 land where the total area to be transformed is 20 hectares Final Scoping Report or more. Listing Notice 3 (requiring BA in the sensitive areas) nd 2 Comment Period The clearance of an area of 1 ha or more of vegetation 13 where 75% or more constitutes indigenous vegetation Authority within a Critical Biodiversity Area (CBA). Acceptance 2 The construction of infrastructure covering 10 m or more, 16 where such construction occurs within a watercourse or within 32 m of a watercourse, within a CBA. * EIA Report and EMP Consequently, the proponent is obliged to apply for EA for Public Comment the Project. Since activities listed under Listing Notice 2 Period apply to the Project, an S&EIR process is required. Final EIA Report and EMP A Water Use Licence in terms of section 21 of the National nd 2 Comment Period Water Act 36 of 1998 (NWA) is required from the Department of Water and Sanitation. Water use activities Authority applicable to the Project are listed in Table 2. Decision Table 2: NWA water use activities for the Project No Description Appeal lodged c Impeding or diverting the flow of water in a watercourse. Opportunity for Appeal Altering the bed, banks, course or characteristics of a i No appeal lodged watercourse. A number of regional plans and frameworks are applicable Project may commence Appeal Process to the project area and the Project is largely aligned with the objectives of these plans. Figure 2: S&EIR Process Note: EMP = Environmental Management Programme The Airport Master Plan for Cape Town International Airport was prepared in 2001 and revised in 2006. During JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015
The Scoping Phase was completed in July 2014 and the Communities adjacent to the airport are highly Final Scoping Report was accepted by DEA on 30 marginalised with relatively low levels of income. September 2014. The EIA has been undertaken in accordance with the Plan of Study for EIA which was included in the Scoping Report accepted by DEA. The key objectives of the EIA are to: x Inform Interested and Affected Parties (IAPs) about the proposed Project and the EIA process followed; x Obtain comments from IAPs (including the relevant authorities and the public) and ensure that all issues, concerns and queries raised are fully documented and addressed in the EIA Report; x Identify and assess potential significant impacts associated with the proposed development; x Formulate mitigation measures to avoid and/or Figure 3: Wetland on land east of the airport minimise impacts and enhance benefits of the Project; and 5 EXISTING AIR TRAFFIC x Produce a Final EIA Report which will provide all the necessary information for DEA to decide whether (and Passenger aircraft arrivals and departures at Cape Town under what conditions) to authorise the proposed International Airport currently occur between 05h45 and Project. 23h25 in winter and 05h45 and 00h15 in summer. Three The EIA Regulations, 2014 do not govern the EIA process. cargo flights operate at 02h00, 03h15 and 04h00. All aircraft approaching and departing the airport do so either 4 DESCRIPTION OF THE SITE AND ENVIRONMENT by following designated instrument flight paths or by visual approach, depending on weather conditions and visibility. Cape Town International Airport is located in the sandy The existing runway is able to accommodate up to 30 Cape Flats region, immediately north of the N2, aircraft landing or departing (Air Traffic Movements [ATM]) approximately 20 km east of Cape Town’s Central Business per hour, but processes around 25 ATM per hour. District. The current airport property (see Figure 1) is approximately 975 ha in extent, incorporating the existing primary and secondary runways, passenger terminal 6 PROJECT DESCRIPTION buildings to the west of the runways, cargo facilities to the north and a small portion of undeveloped land to the east 6.1 Project Infrastructure of the runways. Airports Company South Africa proposes to construct a In the north-eastern portion of the existing airport new runway, rotated counter-clockwise by 11.5 degrees, property, Airports Company South Africa is in the process to replace the existing primary runway (Runway 01-19). of developing a commercial and industrial node (referred The northern end of the new runway (Runway 18-36) will to as Precinct 3). be positioned 220 m to the east of the current Runway 01- Further east of the airport property, adjacent to the 19. It will comply with international specifications for Code existing airport boundary, is a large (~400 ha) portion of F aircraft, increase runway capacity and enable future derelict land, heavily infested with alien vegetation and airport expansion. used for illegal activities such as dumping. Small sand In addition to the re-alignment of the primary runway, the dunes with isolated patches of indigenous vegetation on current Project will also include: the dune ridges and some small wetlands also occur in this x A taxiway system; area. Although largely transformed, some wetlands and x Infrastructure such as an aircraft isolation pad (AIP), a patches of indigenous vegetation are identified as CBAs or compass calibration pad and an aircraft run-up area; associated support areas. This property is owned by the x Security facilities including a perimeter fence; State, Provincial Government and SANRAL. Airports Company South Africa proposes to acquire this land to x Service roads; accommodate the Project and future expansion of the x Buildings and service infrastructure; airport. x Upgrading of the stormwater management system; and The area surrounding the airport consists of mixed land x Bulk earthworks for the sourcing and on site use of use including residential, industrial and commercial use. cut/fill material. JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015

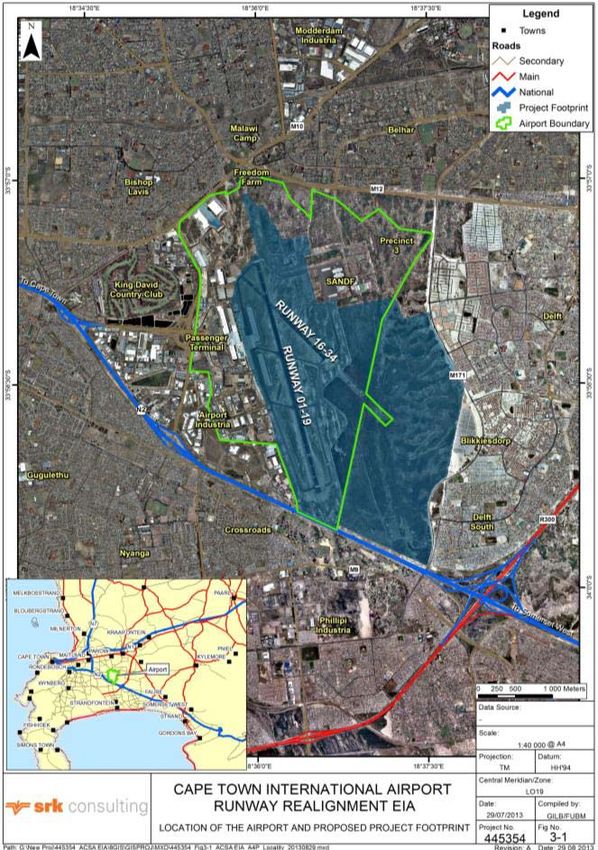

The proposed Project footprint is approximately 700 ha in extent (Figure 1). Construction is expected to take 24 to 30 months to complete. Construction activities that disrupt No Go alternative: this entails no change to the operation of the existing runway will take place at night existing runway, which will remain in its current (for approximately 4 months). position. However, the No Go alternative is not It is estimated that up to 200 direct temporary jobs will be synonymous with the baseline or status quo, since created during construction and that between 900 and a number of developments are permitted and/or 3 200 people will be newly and directly employed by may occur whether the runway is re-aligned or Airports Company South Africa in the long term. not. The number of ATM on the existing runway may also increase until the runway reaches 6.2 Airport Operations maximum capacity. Once the runway is re-aligned, flight paths for aircraft approaching and departing the airport will change. Runway 18-36 will allow capacity at the airport to increase to 40-44 8 STAKEHOLDER ENGAGEMENT ATM per hour although aircraft arrival and departure times Stakeholder engagement is a key component of the S&EIR are not expected to be extended in the foreseeable future, process and is being undertaken in accordance with the due inter alia, to the absence of demand for slots during requirements of the EIA Regulations, 2010. The key other (less convenient, passenger-friendly) times. stakeholder engagement activities during the Impact Instrument flight paths for Runway 18-36 are illustrated in Assessment Phase are summarised in Table 3 below. Figure 4. Table 3: Stakeholder Engagement during Impact Assessment Phase Activity Date Advertisements announcing availability March 2015 of EIA Report for public comment Public comment period 31 March to 25 May 2015 Focus Group Meetings and Public Open April and May Days 2015 Second public comment period (if August 2015 required) Finalise the EIA Report and submit to September 2015 DEA Key comments and concerns raised by stakeholders Figure 4: Flight paths for arrival from the south (left) and predominantly related to: from the north (right) on Runway 18-36 x The changes in noise levels associated with increased flight frequency and changes in flight 7 ALTERNATIVES paths; The EIA Regulations, 2010, require that all S&EIR processes x Implications of changes in noise levels on identify and describe feasible and reasonable alternatives. suitable land use surrounding the airport, Numerous alternatives were identified and considered implications for property owners and long during airport master planning, which informed the early term spatial planning; feasibility and design phases of the Project. x Loss of natural habitats, specifically wetlands; Re-alignment of the existing runway through counter- x Identification of alternatives for assessment in clockwise rotation is the only operationally feasible the EIA; alternative to the existing runway alignment and will allow x Impacts on current airport operations; for the future development of a parallel second runway. x The need and desirability of the Project; and It is not considered financially feasible nor within Airports Company South Africa’s mandate to develop a new airport x Potential impacts on the hydrological system at an alternative when the current site has not been around the airport. optimised. Considering the No Go alternative is a requirement of the EIA Regulations, 2010. JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015
vegetation clearance, bulk earthworks and increased Relevant local, provincial and national authorities, sealed surfaces. conservation bodies, local forums and surrounding landowners and occupants have been directly notified of x The predicted impacts on freshwater ecology are the S&EIR process and the release of the EIA Report for generally rated as low to insignificant, apart from the comment. loss of endangered Western Strandveld wetland habitat which is rated as medium and will require a wetland offset. 9 ASSESSMENT OF POTENTIAL IMPACTS x The predicted impacts on terrestrial ecology are rated Specialist studies undertaken to investigate key potential as low to very low, largely due to the disturbed nature direct, indirect and cumulative impacts are as follows: of the site and limited fauna present in the area. x Air Quality Specialist Study; x The predicted social impacts are largely linked to x Noise Specialist Study (and independent review); increased noise levels in communities around the airport, escalating as the re-aligned runway x Hydrogeology Specialist Study; approaches maximum capacity. With predicted x Freshwater Ecology Specialist Study; exceedances of noise level guidelines in residential x Terrestrial Ecology Specialist Study; areas up to 15 km from the airport, a significant x Socio-economic Specialist Study (including analysis of number of people may experience impacts on their the impacts on land use in areas affected by noise); quality of life. Conversely, many others (though fewer) and will experience reduced noise levels, which may improve quality of life. The resultant negative and x Transport Specialist Study. positive impacts on different communities are both For all potentially significant impacts, the significance of rated as high, though the net adverse impact remains the anticipated impact was rated without and with rated as high. The impact on housing provision by the recommended mitigation measures. These impacts are City of Cape Town (CoCT) is rated as medium. presented in Table 4. x The predicted direct economic benefits of the Project are rated as low during construction and medium The significance of potential impacts of the proposed during operations, however the indirect benefits of Project was determined in order to assist decision-makers. Relevant observations with regard to the overall impact investment in and stimulation of the regional ratings, assuming mitigation measures are effectively economy are more substantial, and are rated as high implemented, are: during operation. x The predicted heritage impacts are rated as x The predicted visual impacts are rated as low, as the insignificant, given significant previous disturbance to area is already dominated by existing infrastructure and the very low heritage sensitivity of the site, and operations at the airport. although it is plausible that material of archaeological x The predicted transport impacts are rated as very low, or palaeontological value may be uncovered during since airport-related road traffic is considered earthworks. negligible in terms of total traffic volumes. Although x The predicted air quality impact during construction is many of the intersections adjacent to the airport are rated as insignificant. However, during operations, the currently operating at poor Levels of Service, required predicted impact of increased emissions on air quality upgrades to alleviate congestion have been identified is rated as medium. The predicted impact of the for implementation by the relevant roads authorities, associated risk (incidence) of increased health effects irrespective of the proposed Project. is rated as low. Given its location in an urban setting, the airport is one of x The predicted noise and vibration impacts during many contributors to cumulative impacts, and as such, the construction are rated as insignificant if construction contribution of the Project is expected to be relatively activities closest to surrounding communities are limited at a regional scale with respect to most cumulative mitigated. At maximum capacity, the predicted noise impacts. As one of the main contributors to noise in the impact during operations is rated as high due to the area, the project is however expected to affect cumulative extent of the area, and communities exposed to, noise levels quite substantially as the runway approaches exceedances of ambient noise guideline levels. full operational capacity. x The predicted hydrogeology impacts are rated as very low, with the primary concern being slightly elevated local groundwater levels as a consequence of alien JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015
Table 4 below summarises: Impact Significance Ratings Legend: Rating +ve -ve x The impacts assessed in the EIA; Insignificant I I x Their significance before and following the Very Low VL VL implementation of essential mitigation measures; and Low L L x The key mitigation measures on which the significance Medium M M rating is based (where applicable). High H H Very High VH VH Table 4: Summary of Impacts Impact Before After Key mitigation/optimisation measures Mitigation Construction Phase Impacts x Adequately record and obtain a permit to destroy historic structures. Destruction and Loss of Heritage I I x Implement a chance finds procedure for heritage material uncovered Resources during construction. x Apply dust suppression methods on all disturbed /exposed areas. Impact of Construction Activities on x Minimise material handling and travel distances on site. VL I Air Quality x Implement a speed limit of 30km/hr on all unpaved roads on site. x Avoid controlled burning during periods of strong wind. x Maintain construction equipment in good working order. Nuisance to Surrounding Receptors x Limit the night time construction activities to the essential. VL I caused by Noise during Construction x Limit construction activities to at least 100m from residential areas during the day and 350m at night. Alternatively install temporary noise barriers. Nuisance to Surrounding Receptors I I x No mitigation caused by Vibration Impact on Groundwater Levels due M M x No mitigation to construction Impact on Groundwater Quality due x Prevent spills of hydrocarbons or other contaminants. I I to construction x Take immediate corrective action should spills occur. Loss of wetland Habitat and x Identify and implement a suitable wetland offset. H M Ecological Structure x Obtain approval from DWS for any activities within wetland areas. Loss of Ecosystem Services L L x Implement general good housekeeping measures. x Implement adequate erosion management. Impacts on Hydrological Function and L L x Curtail sheet runoff from cleared areas and access roads. Sediment Balance x Revegetate cleared areas as soon as possible. Impacts on Freshwater Features x Implement adequate erosion management. located outside of the Project L VL x Discharge runoff into freshwater systems beyond the site in such a way as Footprint Area to prevent erosion. x Revegetate disturbed areas with grass species indigenous to the region if Loss of Terrestrial Habitat L L possible. Loss of Floral Diversity, Floral SCC and x Rescue and relocate indigenous or protected species and floral SCC. L VL Protected Floral Species x Obtain a permit from CapeNature to remove any protected species. x Rescue and relocate faunal species to a suitable habitat. Loss of Faunal Diversity, Faunal RDL L VL x Obtain a permit from CapeNature to remove any protected species. Species and Protected Faunal Species x Strictly prohibit hunting and trapping of fauna. Impacts Associated with Bathyergus x Install mole proof fencing around the airport. L L Suillus (Cape Dune Mole Rat) x Rescue and relocate moles to surrounding open veld areas. Loss of Access to Resources on Land x Offer communities the opportunity to remove combustible material L L East of Existing Airport (firewood), prior to earthworks Nuisance Effects of Construction x Notify residents and schools close to the site of construction schedule. VL VL Related Noise x Develop and implement a grievance mechanism. Generation of Employment, Income x Include in tender documents the need for employment of local labour as VL VL and Skills Training far as possible and provision of job-specific training for construction staff. Increased Revenue to Government I I x No mitigation required. Increased Investment in and x Maintain ongoing communication with appropriate business forums to Stimulation of the Western Cape M M optimise opportunities for local. Economy JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015
Impact Before After Key mitigation/optimisation measures Mitigation Altered Sense of Place and visual x Limit removal of vegetation and rehabilitate disturbed areas incrementally. Quality caused by Construction L VL x Minimise the footprint of the construction camp. Activities x Maintain the natural topography along the eastern boundary of the site. Impact of Construction Traffic on the VL VL x No mitigation required. Existing Road Network Operations Phase Impacts Altered Air Quality from Increased x Initiate a program for the conversion of vehicles and equipment to M M “cleaner” technology, and use of alternative, less polluting fuels. Emissions due to Increased ATM x Encourage policies to reduce high levels of car dependency by staff. Risk of Health Effects from Air x Investigate and implement mitigation measures aimed at reducing aircraft L L Pollution fuel consumption and related emissions. x Maintain effective communication with affected public regarding noise. x Integrate grievance mechanism with noise monitoring system to correlate complaints with noise events and report to authorities. x Where possible design and implement noise preferential routes. x Implement take-off, departure and approach procedures aimed at Noise Impacts of the Re-aligned reducing noise (e.g. flying at higher altitudes, reduced engine thrust). Runway and Increased Operational VH H x Restrict the use of reverse thrust, intersection take-offs and engine ground Capacity run-ups between 22h00 and 06h00 unless required for safety reasons. x Formally engage with the City of Cape Town to encourage airport compatible land use planning. x Establish a noise monitoring committee to monitor the effects of noise mitigation. Nuisance to Surrounding Receptors I I x No mitigation caused by Vibration Impact on Groundwater Levels due x Provide sub-surface drainage and stormwater systems at edges of VL VL to Operations impermeable surfaces. Impact on Groundwater Quality due VL VL x No mitigation required. to Operations Loss of Wetland Habitat and I I Ecological Structure x Implement general good housekeeping measures. Loss of Ecosystem Services I I x Drain stormwater from operational areas. Impacts on Hydrological Function and I I x Curtail sheet runoff from paved surfaces and access roads. Sediment Balance x Attenuate stormwater in order to prevent erosion. Impacts on Freshwater Features x Minimise paved and sealed surfaces in order to reduce runoff. located outside of the Project M L x Discharge runoff into freshwater systems off-site in such a way as to Footprint Area prevent erosion. x Rescue and relocate faunal species to a suitable habitat. Loss of Faunal Diversity, Faunal RDL L VL x Obtain a permit from CapeNature to remove any protected species. Species and Protected Faunal Species x Fence the airport to prevent the movement of fauna onto the site. Impacts Associated with Bathyergus x Maintain mole proof fencing around the airport. L VL Suillus (Cape Dune Mole Rat) x Rescue and relocate moles to surrounding open veld areas. Impacts of Changes in Aircraft Flight L L x Implement the airport’s Wildlife Management Plan Paths on Avifaunal Flight Paths x Assess the risk of bat strikes and if necessary implement measures to avoid Impacts Associated with Bat Strikes VL VL the creation of habitats or conditions which attract bats or insects on which bats feed. x Re-model the noise contours every 5 years to account for changed policies, improved technologies, altered flight paths and schedules, etc. x Submit revised noise contours to the CoCT. Impacts on Quality of Life in Areas x Keep stakeholder informed of changes to predicted noise levels. VH H with Increased Noise Levels x Continually identify new noise abatement measures, considering international trends and best practice for managing noise impacts. x Develop and implement a grievance mechanism, integrated with the noise monitoring system to correlate complaints and responses. Improved Quality of Life in Areas H H x No optimisation required. with Decreased Noise Levels x Re-model the noise contours every 5 years to account for changed policies, Impacts on Future Housing improved technologies, altered flight paths and schedules, etc. HIGH HIGH Developments by CoCT x Submit revised noise contours and encourage the CoCT to consider the implications of predicted noise (contours) in future land use planning. JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015
Impact Before After Key mitigation/optimisation measures Mitigation Generation of Employment, Income M M x Prioritise the employment of local people with appropriate skills. and Skills Training Increased Revenue to Government M M x No optimisation required. Increased Investment and Stimulation of the Western Cape H H x No optimisation required. Economy Altered Sense of Place and Visual L L x Limit lighting to essential activities and facilities and minimise light spillage. Quality Impact of Airport-related Road Traffic VL VL x No mitigation required. on the Existing Road Network benefits. The EIA has also assisted in the identification of mitigation measures that will mitigate the impacts 10 CONCLUSION AND WAY FORWARD associated with these components to within tolerable limits (aside from noise). It is anticipated that noise This Draft EIA Report has identified and assessed the mitigation measures can and will be explored prior to potential biophysical and socio-economic impacts commissioning of the re-aligned runway (if authorised), associated with the proposed re-alignment of the primary and implemented. However, in accordance with the runway and development of associated infrastructure at precautionary principle, the implementation and efficacy Cape Town International Airport. of these measures is not presumed in the Draft EIA Report. The runway re-alignment will generate a number of Ultimately, DEA will need to consider whether the Project significant impacts, but most of these can be reduced to benefits outweigh the potential impacts. compliant levels assuming that the recommended mitigation measures will be effectively implemented. Indirect economic benefits are also expected to be relatively significant. HOW YOU CAN YOU PARTICIPATE IN THE EIA PROCESS High (net) noise impacts and associated implications for land use planning are very difficult to mitigate and current The Draft EIA Report is not a final report and can be practice suggests communities will continue to demand, amended based on comments received from stakeholders. and the CoCT continue to provide, housing in areas where Stakeholders’ comments on the EIA Report will assist DEA existing noise is and is predicted to exceed guidelines. in making a decision regarding the application. The public Airports Company South Africa is committed to ensuring is therefore urged to submit comment. If you require that the airport is operated to the highest standards, assistance in compiling and submitting comments, please achieved through implementation of the recommended contact us and we will ensure that you receive appropriate mitigation measures and ongoing monitoring of support. Once stakeholders have commented on the performance. A “Joint Statement of Intent” regarding the information presented in the EIA Report, the Final EIA mitigation of noise impacts in the short, medium and long Report will be prepared and released for a second public term was adopted by Airports Company South Africa, comment period before being submitted to DEA for industry stakeholders and the City of Cape Town. approval. Once a decision is taken by authorities, this With the exception of noise, the EAPs believe and the EIA decision will be communicated to registered IAPs. Report demonstrates that, through effective implementation of the stipulated mitigation measures, the adverse impacts can be reduced to levels compliant with guidelines. SRK believes that sufficient information is available for DEA to take a decision. The fundamental decision is whether to authorise the Project, which brings major economic benefits and is generally consistent with development and planning policies for the area, but which will generate noise which exceeds guideline levels in residential communities, especially once operating at maximum capacity. SRK believes that the specialist studies have shown that the development of the Project is generally acceptable, but that noise impacts and implications for land use planning will have to be weighed against the indirect economic JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015
REVIEW THE REPORT ATTEND A MEETING Copies of the complete report are available for A number of Public Open Days will be held public review at the following locations: where the Project will be discussed and x Cape Town Central Library; additional concerns or issues can be raised: x Plumstead Library; Public Open Day 1: x Bellville Library; Venue: Ground Floor, Southern Office Block, x Somerset West Library; Cape Town International Airport x Delft Library; Date: 16 April 2015 x Delft South Library; Public Open Day 2: x Belhar Library; Venue: Bishop Lavis Civic Centre, Adriaanse x Bishop Lavis Library; Avenue, Bishop Lavis x Crossroads Library; Date: 07 May 2015 x Manenberg Library; Public Open Day 3: x Nyanga Library; Venue: Solomon Tshuku Hall, Solomon Tshuku Ave, Site C x Philippi East Library; Date: 11 May 2015 x Elsies River Library; x Valhalla Park Library; Public Open Day 4: x Khayelitsha Library; Venue: Bothasig Hall, Link Road, Bothasig x Edgemead Library; Date: 13 May 2015 Public Open Day 5: x Cape Town International Airport Southern Office Block Reception; Venue: Delft Civic Centre, corner Delft Main Road and Voorbrug Street x SRK’s Cape Town office; and Date: 14 May 2014 x SRK’s website: http://www.srk.co.za/en/za- cape-town-international-airport-runway-re- The public is invited to attend the Public Open alignment-eia Days at any time between 15h00 and 19h00. The noise specialist will be available between 16h00 and 18h00. REGISTER OR PROVIDE YOUR OPINION Please confirm your intention to attend a Public Register or send written comment to: Open Day with the contact person. Scott Masson SRK Consulting Postnet Suite #206, Private Bag X18, Rondebosch, 7701 Tel: + 27 21 659 3060 Fax: +27 21 685 7105 Email: smasson@srk.co.za IAPs are invited to comment, and/or to register on the project database. IAPs should refer to the DEA reference number, and must provide their comments together with their name, contact details (preferred method of notification, e.g. email), and an indication of any direct business, financial, personal or other interest which they have in the application, to the contact person below, by 25 May 2015. JONS/dalc 445354_CTIA Runway re-alignment_EIA Report_Executive Summary_March 2015 March 2015
SRK Consulting: 445354 Cape Town International Airport Runway Re-alignment EIA Report Page iv Table of Contents 1 Background and Introduction ..................................................................................... 1 1.1 Background ......................................................................................................................................... 1 1.2 Introduction ......................................................................................................................................... 1 1.3 Purpose of the Report ......................................................................................................................... 3 1.4 Scope of Work..................................................................................................................................... 3 1.5 Structure of this Report ....................................................................................................................... 4 1.6 Content of Report ................................................................................................................................ 5 1.7 Assumptions and Limitations .............................................................................................................. 6 2 Governance Framework and Environmental Process............................................... 7 2.1 Legal Requirements ............................................................................................................................ 7 2.1.1 Airports Company Act 44 of 1993 ........................................................................................... 7 2.1.2 Civil Aviation Act 13 of 2009.................................................................................................... 8 2.1.3 White Paper on National Policy on Airports and Airspace Management, 1998 ...................... 8 2.1.4 National Policy on Aircraft Noise and Engine Emissions, 1999 .............................................. 8 2.1.5 National Environmental Management Act 107 of 1998, as Amended .................................... 9 2.1.6 EIA Regulations, 2010 ........................................................................................................... 10 2.1.7 EIA Regulations, 2014 ........................................................................................................... 11 2.1.8 National Water Act 36 of 1998 .............................................................................................. 12 2.1.9 The National Heritage Resources Act 25 of 1999 ................................................................. 13 2.1.10 National Environmental Management: Biodiversity Act 10 of 2004 ...................................... 14 2.1.11 Conservation of Agricultural Resources Act 43 of 1983 ....................................................... 14 2.1.12 Western Cape Nature Conservation Laws Amendment Act 3 of 2000 ................................. 14 2.1.13 National Environmental Management: Air Quality Act 39 of 2004 and the South African National Air Quality Standards .............................................................................................. 14 2.1.14 Environmental Conservation Act 73 of 1989: Noise Control Regulations and SANS Codes of Practice ............................................................................................................................. 15 2.1.15 White Paper on National Civil Aviation Policy, 2014 ............................................................. 16 2.1.16 Occupational Health and Safety Act 85 of 1993 ................................................................... 16 2.2 Planning Policy Framework .............................................................................................................. 17 2.2.1 National Development Plan: Vision for 2030......................................................................... 17 2.2.2 Western Cape Spatial Development Framework .................................................................. 17 2.2.3 Western Cape Provincial Land Transport Framework (2013)............................................... 18 2.2.4 Cape Town Spatial Development Framework ...................................................................... 18 2.2.5 Tygerberg District Plan: Spatial Development Plan and Environmental Management Framework ............................................................................................................................ 20 2.2.6 Khayelitsha Mitchells Plain District Plan: Spatial Development Plan and Environmental Management Framework ...................................................................................................... 22 2.2.7 Cape Town Integrated Development Plan ............................................................................ 23 2.2.8 Cape Town Zoning Scheme .................................................................................................. 24 JONS/MASS/dalc 445354_CTIA Runway Realignment EIA Report_for public comment March 2015.docx March 2015

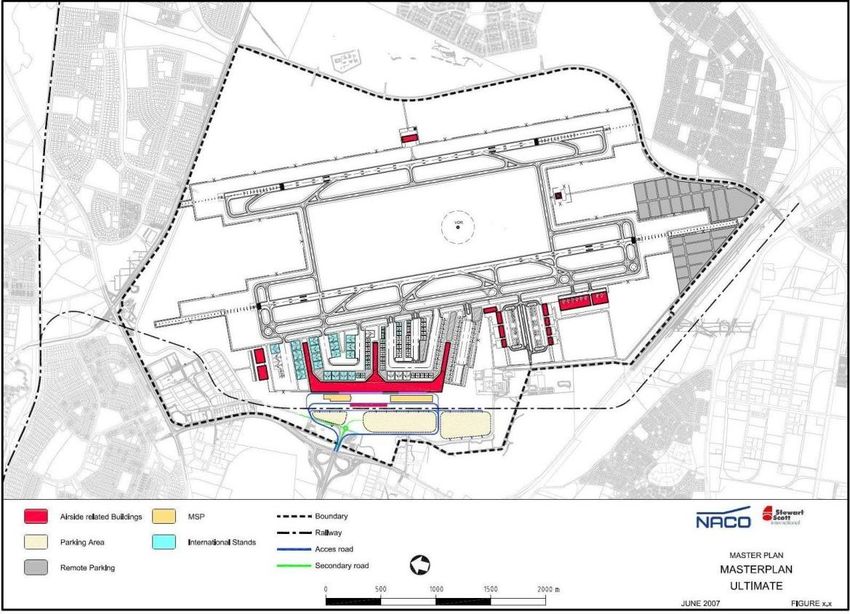

SRK Consulting: 445354 Cape Town International Airport Runway Re-alignment EIA Report Page v 2.3 Cape Town International Airport Master Plan ................................................................................... 24 2.4 Environmental Assessment Process ................................................................................................ 26 2.4.1 Submission of Applications ................................................................................................... 28 2.4.2 S&EIR Process and Phasing................................................................................................. 28 2.4.3 Appeals.................................................................................................................................. 30 3 Project Description..................................................................................................... 31 3.1 Cape Town International Airport ....................................................................................................... 31 3.2 Introduction to the Project ................................................................................................................. 32 3.3 Description of the Project Area ......................................................................................................... 36 3.3.1 Site Description ..................................................................................................................... 36 3.3.2 Surrounding Land Use .......................................................................................................... 39 3.4 Proponent’s Project Motivation ......................................................................................................... 41 3.5 Project Alternatives ........................................................................................................................... 41 3.5.1 Location Alternatives ............................................................................................................. 42 3.5.2 Airport Master Plan Options .................................................................................................. 43 3.5.3 The No Go Alternative ........................................................................................................... 48 3.6 Project Construction and Infrastructure ............................................................................................ 48 3.6.1 Runway.................................................................................................................................. 49 3.6.2 Taxiways................................................................................................................................ 51 3.6.3 Aircraft Isolation Pad ............................................................................................................. 51 3.6.4 Compass Calibration Pad...................................................................................................... 51 3.6.5 Aircraft Run-up Area.............................................................................................................. 52 3.6.6 Perimeter Fence and Security ............................................................................................... 52 3.6.7 Service Roads ....................................................................................................................... 52 3.6.8 Buildings and Service Infrastructure ..................................................................................... 52 3.6.9 Stormwater Management System ......................................................................................... 52 3.6.10 Bulk Earthworks .................................................................................................................... 55 3.6.11 Construction Traffic ............................................................................................................... 57 3.6.12 Water Supply ......................................................................................................................... 57 3.6.13 Waste Management .............................................................................................................. 58 3.6.14 Air Quality Management ........................................................................................................ 58 3.6.15 Noise and Vibration Management ......................................................................................... 58 3.6.16 Workforce .............................................................................................................................. 58 3.6.17 Investment ............................................................................................................................. 58 3.6.18 Construction Schedule .......................................................................................................... 58 3.6.19 Construction Hours ................................................................................................................ 63 3.7 Project Operations ............................................................................................................................ 63 3.7.1 Air Traffic ............................................................................................................................... 63 3.7.2 Workforce .............................................................................................................................. 65 3.7.3 Operational Lifecycle ............................................................................................................. 65 3.7.4 Utilities and Services ............................................................................................................. 65 JONS/MASS/dalc 445354_CTIA Runway Realignment EIA Report_for public comment March 2015.docx March 2015
SRK Consulting: 445354 Cape Town International Airport Runway Re-alignment EIA Report Page vi 3.7.5 Operational Procedures for Pollution Management .............................................................. 65 3.7.6 Waste Management .............................................................................................................. 66 3.7.7 Air Quality Management ........................................................................................................ 66 3.7.8 Noise Management ............................................................................................................... 66 3.7.9 Wildlife Management ............................................................................................................. 67 3.7.10 Emergency Response ........................................................................................................... 67 3.8 Environmental Factors Influencing Project Design ........................................................................... 67 3.9 Analysis of Need and Desirability of the Project ............................................................................... 68 4 Description of the Affected Environment ................................................................. 72 4.1 Biophysical Environment ................................................................................................................... 72 4.1.1 Topography ........................................................................................................................... 72 4.1.2 Geology ................................................................................................................................. 72 4.1.3 Climate .................................................................................................................................. 73 4.1.4 Air Quality .............................................................................................................................. 76 4.1.5 Noise ..................................................................................................................................... 80 4.1.6 Hydrology .............................................................................................................................. 88 4.1.7 Hydrogeology ........................................................................................................................ 90 4.1.8 Freshwater Ecosystems ........................................................................................................ 92 4.1.9 Terrestrial Vegetation ............................................................................................................ 99 4.1.10 Avifauna............................................................................................................................... 103 4.1.11 Fauna .................................................................................................................................. 105 4.2 Socio-Economic Environment ......................................................................................................... 109 4.2.1 Potentially Indirectly Affected Areas: Western Cape and CoCT ......................................... 110 4.2.2 Potentially Directly Affected Areas ...................................................................................... 115 4.2.3 Land Claims ........................................................................................................................ 129 4.3 Heritage Resources and Visual Environment ................................................................................. 130 4.3.1 Heritage Resources ............................................................................................................. 130 4.3.2 Visual and Aesthetic Environment ...................................................................................... 131 4.4 Transport Network........................................................................................................................... 133 4.4.1 External Road Network ....................................................................................................... 133 4.4.2 Long Term Transport Requirements ................................................................................... 136 4.4.3 Traffic Levels around the Airport ......................................................................................... 137 5 Stakeholder Engagement ........................................................................................ 141 5.1 Objectives and Approach to Stakeholder Engagement .................................................................. 141 5.2 Stakeholder Engagement during the Scoping Phase ..................................................................... 141 5.2.1 Identification of Key Stakeholders ....................................................................................... 142 5.2.2 Notification of Start of EIA Process ..................................................................................... 143 5.2.3 Release of Scoping Report for Public Comment ................................................................ 144 5.2.4 Focus Group Meetings and Public Open Days ................................................................... 145 5.2.5 Notification and Acceptance of Final Scoping Report ......................................................... 148 5.2.6 Issues and Concerns Raised by IAPs during Scoping ........................................................ 148 JONS/MASS/dalc 445354_CTIA Runway Realignment EIA Report_for public comment March 2015.docx March 2015
