Washington State Ferries S R 1 6 0 / F a u n t l e r o y F e r r y Te r m i n a l Tr e s t l e & Tr a n s f e r S p a n R e p l a c e m e n t P r o j e c t Te c h n i c a l A d v i s o r y G r o u p M e e t i n g # 2 July 27, 2021
Zoom interface and controls Check your Zoom name Technical difficulties? Call or text tech support at 402.972.7203 2
Agenda • Welcome and introductions • Planning & Environmental Linkages (PEL) study context • TAG charter and workplan • Preliminary Purpose and Need Statement • Discussion • Closing and next steps 3
Planning and Environmental Linkages (PEL) Study Context • Background on PEL • Alternatives development and screening process • Relationship to environmental review process • Questions? 5
New approach to project development • Developing a Planning and Environmental Linkages (PEL) study in partnership with the Who’s involved? Federal Highway Administration as part of planning phase Local, • Study helps WSF identify transportation State & issues, environmental concerns, community Public Federal values and economic goals early in project Agencies planning PEL • Resource links: Tribes, Resource • https://wsdot.wa.gov/environment/technical/ Agencies environmental-planning • https://www.environment.fhwa.dot.gov/env_i nitiatives/PEL.aspx 6

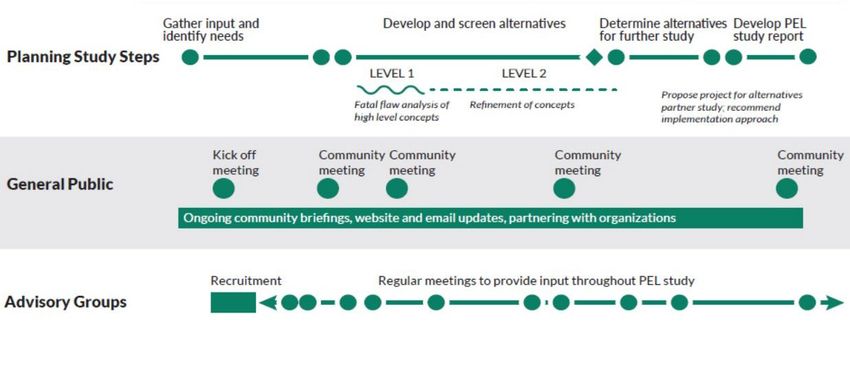

Early scoping Preliminary Purpose and Need statement Range of alternatives to include in PEL study Screening criteria to evaluate potential alternatives Preliminary information about existing conditions Expected timeline: Summer – Fall 2021 8
Level 1 Screening Results of Level 1 Screening Proposed Level 2 Process, including which alternatives will be evaluated Additional information about existing conditions Expected timeline: Late 2021 – Spring/mid- 2022 9
Level 2 Screening Results of Level 2 Screening Feedback on path forward and/or additional analysis given Level 2 screening results Expected timeline: Spring/Summer 2022 – early Spring 2023 10
PEL Study Report Recommended path forward, including which alternative (s) should advance into environmental review Expected timeline: Early to Mid-2023 11
Technical Advisory Group (TAG) charter highlights • Serve in an advisory role in collaboration with WSF through sharing technical input, ideas and information throughout PEL study process • Participate in regular (and most likely virtual) meetings between now and mid-2023 • Meetings will be recorded for sharing with TAG members and WSF will provide meeting summaries • TAG meeting presentations will be published on project website 12
Advisory group workplan will be iterative throughout PEL 13
Preliminary Purpose and Need Statement
Preliminary Purpose and Need Maintain safe, reliable and efficient service on SR 160 between West Seattle and Vashon Island, Southworth, and communities on the Kitsap Peninsula and beyond, consistent with travel and ridership needs. 15

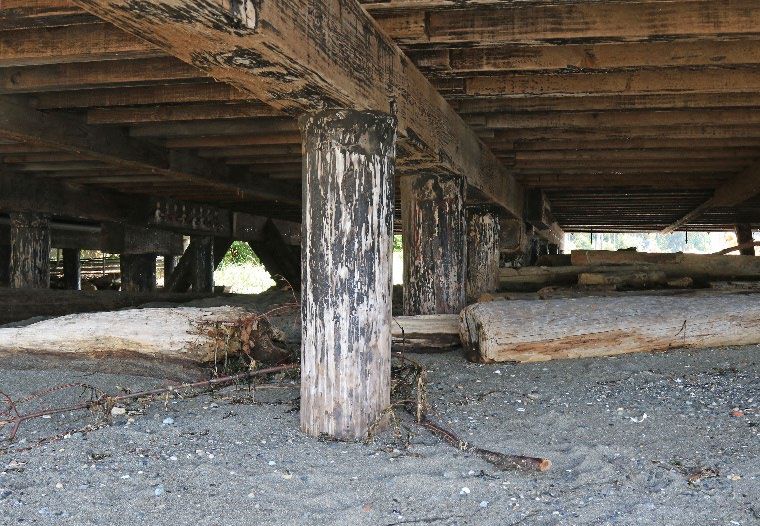

Preliminary Purpose and Need Replace aging terminal structures to meet current seismic, storm and tsunami design standards Parts of terminal are aging, seismically vulnerable and due for replacement Bridge Seat Trestle Bulkhead Towers Transfer Span Terminal Building 16
Preliminary Purpose and Need Raise the elevation of the terminal to accommodate future sea level rise • Rising sea levels and increasing frequency and intensity of storms in the future increase damage to dock from debris during high tides 17
Preliminary Purpose and Need Provide operational efficiencies that maintain or improve on-time performance while maintaining service levels defined for the route in the 2040 WSF Long Range Plan • Today traffic regularly exceeds the to terminal holding capacity and requires use of shoulder holding on Fauntleroy Way SW 18
Preliminary Purpose and Need Improve safety and Americans with Disabilities Act (ADA) accessibility for pedestrians, vehicles, and bicycles • The existing terminal configuration creates a risk of collision with all modes of traffic sharing the same space for loading • All modes of traffic also share space at the intersection of the terminal and Fauntleroy Way SW 19
Preliminary Purpose and Need Accommodate ridership forecasted in the 2040 WSF Long Range Plan 2017 Total 2017 Passengers 2040 Total % Increase 2040 % Increase Route Segment (vehicles (walk-on Passengers (walk-on and (vehicles (vehicles (walk-on and vehicle) and and drivers) and drivers) and vehicle) drivers) vehicle) Fauntleroy/Vashon 890,800 1,112,000 25% 1,094,400 1,241,600 13% Fauntleroy/Southworth 356,200 588,900 65% 556,600 663,800 19% 20
Project goals • Meet the 95 percent on-time performance goal for the route • Accommodate future electrification at the terminal to charge hybrid electric ferries • Promote sustainable modes of travel, such as walk-on and bike-on passengers, and enhance multimodal connections at the terminal • Foster social equity and community values • Minimize impacts to the built and natural environment • Be technically and economically feasible for WSF to construct, operate, and maintain 21
Discussion: preliminary Purpose and Need statement • Do you have input about the core purpose and need for the project? Is there anything missing? • What are your thoughts about the project goals for the project? 22
Closing and next steps • Opportunity for a project site tour • Next TAG meeting expected in early fall focused on follow up on purpose and need statement input and discussion of screening process and criteria • Broad community engagement later this fall Questions or comments? FauntleroyTermProj@wsdot.wa.gov Project website: wsdot.wa.gov/projects/sr160/fauntleroy-terminal 23
Adjourn Thank you! 24
