11 Report to: Waimarino-Waiouru Community Baord Meeting Date: 4 June 2020 Subject: Ohakune to Raetihi Walk and Cycle Way Proposal Purpose of Report 1.1 The purpose of this report is seek the Waimarino-Waiouru Community Board’s endorsement of the Ohakune 2000 proposed Walk & Cycle Way Ohakune-Raetihi, to enable it to be submitted to Council as a part of the Ruapehu District Long Term Plan 2021- 2031. Significance and Engagement, Social Impact 2.1 This report does not trigger the Significance and Engagement Policy. 2.2 This report does not trigger the Social Policy. Background 3.1 For many years, Ohakune 2000 have embarked upon many community-based projects and have a track record of delivering projects such as the Junction Après Ski Zone, Ohakune Old Coach Road walk/cycle trail and Hāpuawhenua Viaduct restoration and more recently, working as partners with Council, Iwi and Department of Conservation on the proposed Te Ara Mangawhero Cycle trail and Carrot Park development. 3.2 This new initiative follows on these successes and looks towards connection of Raetihi and Ohakune by a new recreational walking and cycling route. Discussion 4.1 The Detailed Concept Walk & Cycle Way from Ohakune to Raetihi is attached to and forms a part of this report. Members of Ohakune 2000 will attend to present the plan and will seek inclusion of $506,000 to support the implementation of the project in Council’s draft LTP for public consultation. Suggested Resolution(s) 1 That the report on Ohakune to Raetihi Walk and Cycle Way Proposal be received. 2 That the Waimarino-Waiouru Community Board recommends/does not recommend the inclusion of the plan in the draft LTP 2021-2031. Warren Furner RUAPEHU TOURISM DEVELOPMENT MANAGER Email address for point of contact: warren.furner@ruapehudc.govt.nz Attachments: Ohakune 2000 - Detailed Concept Walk & Cycle Way from Ohakune to Raetihi
Attachment 12 DETAIL CONCEPT Walk & Cycle Way from Ohakune to Raetihi Date 05.05.2020 / V1.8 Introduction With this new Walk & Cycle Way from Ohakune to Raetihi, the existing Walk & Cycle Way in Ohakune gets con- nected. The visitors are then able to walk from the Mangawhero River Walk & Cycle Way and from the Jubilee Walk & Cycle Way into the extension towards Raetihi with some viewpoints and points of interest on the way. Our idea is to split the project into phases to make at least a part of it available as soon as possible and add on the next stages in steps. DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 1 of 31 06/05/2020
Attachment 13 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Detail Concept as part of the Masterplan Bike Ohakune – Region This detail concept is part of the Masterplan Bike Ohakune – Region. In there you find the big picture of our idea and our goals for biking in the Region of Ohakune. Management Summary We propose to subdivide the project Walk & Cycle Way Ohakune-Raetihi into different subprojects. Some sections will be implemented relatively quickly, others may be more challenging. Alternatively, the main road can be used as a temporary alternative route virtually throughout the route (for sections of the project not yet completed). Project Stage 1: Mangawhero River Walk & Cycle Way extension to connect to Jubilee Walk & Cycle Way Project Stage 2: Extension of the Ohakune Walk & Cycle Ways to end of Burn street to connect to picnic area Project Stage 3: Creating a picnic area with view to the mountain in beautiful surrounding in the river bend Project Stage 4: Mangawhero River Road reopening with a single lane bridge for bikers, walkers and people who life at the Mangawhero River Road Project Stage 5: Using the existing Mangawhero River Road as connector to Raetihi Tourist aspect for this project From our point of view, the connection between Ohakune and Raetihi for cyclists has a particular sense for the lo- cal population. Students and cyclists can cycle to school more safely. However, there is also a tourist component. Because on the way we will have some stops for which it is worth stopping and enjoying: DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 2 of 31 06.05.2020
Attachment 14 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Table of contents of the detail concept 1 Project Stage 1: Mangawhero River - and Jubilee Walk & Cycle Way Connector ... 4 2 Project Stage 2: Along the Burn Street to picnic area .............................................. 6 3 Project Stage 3: Mangawhero peninsula with rest- and viewpoint .......................... 8 4 Project Stage 4: Mangawhero River Bridge & Mangawhero River Road ............... 10 4.1 Mangawhero River Bridge ............................................................................................11 4.2 Mangawhero River Road ............................................................................................. 14 5 Project Stage 5: Connection from Mangawhero River Road to Raetihi ................. 15 5.1 Details to consider on the way from Ohakune to Raetihi .............................................. 16 5.1.1 Accurate fence line: ..................................................................................................... 16 5.2 Challenges along the road to Raetihi ........................................................................... 16 6 The Financing ............................................................................................................ 30 7 The Schedule ............................................................................................................. 31 DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 3 of 31 06.05.2020
Attachment 15 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 1 Project Stage 1: Mangawhero River - and Jubilee Walk & Cycle Way Connector Starting at the parking where the Mangawhero River Walk now ends. In a first step, the walkway should underpass the main street (HW 49) and then continue along the river, where he meets later on the Jubilee Park Walk & Cycle Way back to town. Where the two streams come together, it is planned to build a view point. We can explain here about the history of this rivers and Maori history in this region. Challenges: • Path under the bridge must be leveled with a digger and protected from flooding with heavy stones. • A little wooden bridge is needed over a ditch • Further along the river, landowners own land right to the river. Will they support our idea? Specials in this phase: • Old carrot cleaning place could be “restored” and showed to the public • Junction from Mangateitei-Stream and Mangawhero River could be a viewpoint (one way) • When this Connection to Jubilee Park Walk & Cycle Way is finished, there is a nice Walk- & Cycle Way around half of Ohakune Involved persons/authorities: • Landowners along Burn Street must be asked for permission (Mr. Nash and Mr. Sue) • NZ Transport and/or Ministry of Justice are in charge of the street • Council is in charge of some crownland along the river • Horizons Regional Council (River Access) Building costs for: • Leveling the way under the bridge (State Highway 49, Bridge Nr. 000) • Wooden Bridge over a little stream (bridge 6m wide) • Building the path (in total 650m) • maintaining in subsequent years (yearly costs) DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 4 of 31 06.05.2020
Attachment 16 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Involved persons: John King / joking_ohakune@windowslive.com / 021 117 3903 Robert Milne / ed@ruapehubulletin.co.nz / 027 231 1844 Daniel Schlumpf / daniel.schlumpf@outlook.com / 021 292 2883 Current works to be carried out: Who What Till when Status John King Talk to Joe Sue & Garry Nash (land owners) 31. Nov. 2018 In progress Robert Milne Talk to Warren Furner (Council) 31. Nov. 2018 In progress Daniel Schlumpf Update project plan and send it to involved people 18. Nov. 2018 Done DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 5 of 31 06.05.2020
Attachment 17 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 2 Project Stage 2: Along the Burn Street to picnic area Because the land was transferred to the landlords along the river, it makes no sense in our view to ask them all to plan the Walk & Cycle Way along the river. After all, if only one homeowner of the idea does not want our Walk & Cycle Way, this section cannot be implemented. Our recommendation is therefore is, to follow Burn street and create a clearly marked bike path next to the car lane (maybe even color-coded). The street could be marked as Walk & Cycle Way and with a color at the road everyone would know, that this is not for cars. Please note that we are applying for this road marking for a section that is currently used exclusively for residents. Although it is public, it is practically unused. Challenges: • Negotiations with the owner of the street (Council, Government?) • Several rules and regulations may apply for this section along the Burn street • Which side of the street Is better to use? • A bit boring to walk for pedestrians Specials in this phase: • Easy cycling along the street with no traffic Involved persons/authorities: • Landowners along Burn street (just to inform) • NZ Transport ‘?? (Road owner) • Council Building costs for: • Building a cycling stripe along the main street • Building the path in the section with gravel road (in total 500m) • maintaining in subsequent years (yearly costs) DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 6 of 31 06.05.2020
Attachment 18 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Involved persons: Daniel Schlumpf / daniel.schlumpf@outlook.com / 021 292 2883 Dave Scott / davescott@xtra.co.nz / 027 485 76 93 Current works to be carried out: Who What Till when Status Neville & Dani Walk along the river to find possible obstacles 12. April 2018 Done David Scott Talk to council about restrictions footpath along main 31. Nov. 2018 In progress street Daniel Schlumpf Update project plan and send it to involved people 18. Nov. 2018 Done DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 7 of 31 06.05.2020
Attachment 19 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 3 Project Stage 3: Mangawhero peninsula with rest- and viewpoint From the asphalt surface it goes back to gravel road. Currently we are not sure if it needs an additional track for the Walk & Cycle Way, or if the gravel road itself can be used as the Walk & Cycle Way. At the far end, we would like to design the Mangawhero Peninsula as a picnic area (as the landowner allows). The place has a great view to the mountain and is beautifully situated between trees and the river. The access to the river allows the people to swim or at least play at the water. Challenges: • Negotiations with the owner of the land piece and Horizon Regional Council • Creating a nice picnic area with all the necessary things that people visit it and enjoy the place Specials in this phase: • Great place at the river with stunning view to the mountain. Ideal to rest at the river and enjoy water and view Involved persons/authorities: • Landowner from this little peninsula (G. A. Whale, M. E. Christensen) • Council is probably the gravel road owner Building costs for: • Picnic installations • Signs • maintaining in subsequent years (yearly costs) for rubbish removal, landscaping and damaged goods Involved persons: Neville Partridge / neville@partridgepools.co.nz / 021 728 150 Daniel Schlumpf / daniel.schlumpf@outlook.com / 021 292 2883 Dave Scott / davescott@xtra.co.nz / 027 485 76 93 DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 8 of 31 06.05.2020
Attachment 20 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Current works to be carried out: Who What Till when Status Neville & Dani Walk along the river to find possible obstacles 12. April 2018 Done David Scott Talk to Mr. Whale 31. Nov. 2018 In progress Daniel Schlumpf Update project plan and send it to involved people 18. Nov. 2018 Done DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 9 of 31 06.05.2020
Attachment 21 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 4 Project Stage 4: Mangawhero River Bridge & Mangawhero River Road At this point has been a fort, but the farmer has closed it because of flooding in the past. We would like to build a bridge which is wide enough that cars can drive over it (locals, delivery, guests and emergency only!!). So, the bridge should be strong enough to hold cars, but most of the use will be walkers and bikers. We recommend a wooden bridge which match the nature in the area. Challenges: • Negotiations with the owner of the street (Government or council?) • Several rules and regulations may apply for this section along the Burn street • How can we make sure, that only the aloud people use the bridge? Specials in this phase: Challenges: • Building a bridge (costs) and sort out who is allowed to drive over the bridge • Safe of Water flooding for the future, so build high enough to be safe Specials in this phase: • Already existing gravel road (Mangawhero River Road) can be used. Needs only another 600m more main- taining Involved persons/authorities: • Council is probably the gravel road owner Building costs for: • Bridge (wooden or concrete prefabricated). Base could be built from local builders or volunteers • maintaining in subsequent years (yearly costs) DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 10 of 31 06.05.2020
Attachment 22 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 4.1 Mangawhero River Bridge In the early days, the Mangawhero River Road was the main street from Ohakune to Raetihi. But it was never sealed and it never had a bridge over the Mangawhero River at that place. Here was a fort before. But some years ago, the river floated the farmland. To avoid that for the future, the local farmer closed the fort and builded a bridge to his own costs. So far, we can see on the maps, the bridge is NOT on private land, but it’s definitely paid by a local farmer. The idea is now, to build a proper bridge which is high enough above the river, so that the farmer must not worry about floating river. Purpose/size of the new bridge: The bridge should be strong enough, that cars and light trucks can drive over it (2.5m wide) too, but restricted to 5t max. weight at the bridge. Length of the bridge needs to be approx. 15m. It probably makes sense to build up bases for the bridge on both sides out of concrete to be strong enough, when the river gets high. Access from direction Raetihi and from Ohakune: Overview from the existing bridge: DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 11 of 31 06.05.2020
Attachment 23 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Bridge Building and delivery Information: At this stage of the project (05. May 2020), we are waiting for quotes for a bridge. We have asked for a 15m long wood or concrete bridge which gets prebuilt and delivered to the place. A big truck and a heavy crane can access to the place and can also turn around in grassland (as long as the ground is hard and dry, we recommend winter delivery). At the picture in green. Bridge Styles: Emmets Bridges: Humes Bridges: Bridge it NZ: DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 12 of 31 06.05.2020
Attachment 24 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Restriction of use: If it is possible somehow, we would like to restrict the access of the bridge to locals, guests and delivery partners and of course bikers and hikers. We have to avoid, that the Mangawhero Road becomes a highly used shortcut or speed junkie’s road. This for safety-, maintenance- and noise/dust rea- sons. In Europe, we use signs like this: Maybe with 1m2 Blocks we can slow down traffic. DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 13 of 31 06.05.2020
Attachment 25 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 4.2 Mangawhero River Road The Mangawhero River Road is gravel road at the moment and we recommend to leave it this way. Alt- hough we have big dust problems! Maybe there is a solution between loosen gravel and fully paved road to reduce the costs. The two main corners (see circles), are a problem, if we have a higher speed at this street. We highly recommend to reduce the speed at the Mangawhero River Road to 50km/h! 700m of the Mangawhero Road is actually not in a good condition and needs to be updated. Involved persons: Neville Partridge / neville@partridgepools.co.nz / 021 728 150 Daniel Schlumpf / daniel.schlumpf@outlook.com / 021 292 2883 Dave Scott / davescott@xtra.co.nz / 027 485 76 93 Current works to be carried out: Who What Till when Status Neville & Dani Walk along the river to find possible obstacles 12. April 2018 Done Dave Scott Quotes for landscaping 15. April 2020 In progress Dani Schlumpf Quotes for a bridge are out to this companies: 01. May 2020 In progress Emmetts Bridges, Humes Bridges, Palmerston North, Bridge it NZ, Tauranga Daniel Schlumpf Talk to Murray Fredricksen 18. Nov. 2018 tbd DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 14 of 31 06.05.2020
Attachment 26 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 5 Project Stage 5: Connection from Mangawhero River Road to Raetihi The land ownership towards Raetihi is complicated and the area of the former railway is no longer in public hands. We therefore recommend a direct connection to Raetihi along the main road. This would then also been used by cyclist who go to work. They now ride on the main street. We suggest that the north side of the road be expanded so that the road does not have to be crossed from Man- gawhero River Road. Additionally, after consultation, we recommend to use this side of the road also because we expect less earth works. A hiking and biking trail should be more or less 1.5-2 m wide and one meter from the main street. On this meter we imagine using bushes and other plants to have a "pretty" street and a clear separation from traffic. Sample how this could look like (filled with scoria metal): DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 15 of 31 06.05.2020

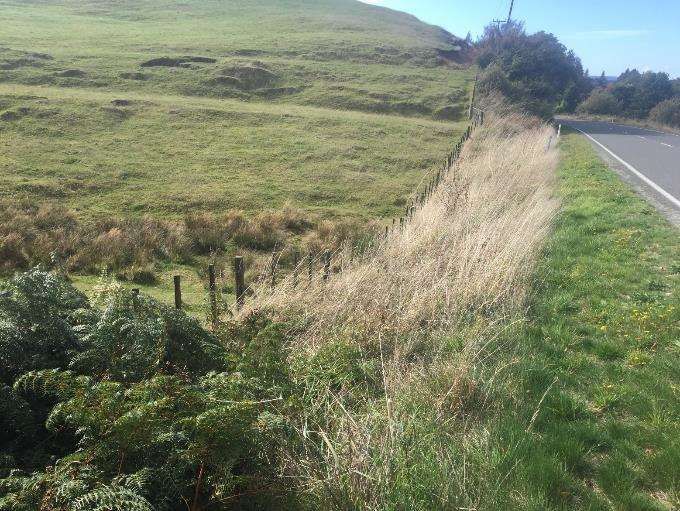

Attachment 27 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 5.1 Details to consider on the way from Ohakune to Raetihi 5.1.1 Accurate fence line: During our investigations we found out, that not all fences are at the original border of the land. Checking the available maps online made the picture even more unclear. The Council need to check for us the accuracy of the fence line. Here an example of an area where the boundaries do not match the road layout: 5.2 Challenges along the road to Raetihi We walked all along the Street (exact 5’100m) and checked of the challenges which may cause some problems or would make our project maybe almost impossible. Lucky wise, we have not seen big problems which cannot be solved. But following, we will point some sections, which cause additional effort to the normal (see below) and will take more effort than only clearing, flattening and building the cycle path: Normal roadside with entrances some hundred meters from landowners. We measured 4’500m (decisive for quotes) Road to ditch mostly 1m to 1.5m (grass) Ditch mostly 0.5 m to 1.5m (dirt, swamp, grass) Grass area for cycle path 1 - 1.5m (grass, rocks) Fence all along over the 5.1km All other areas/sections we have named and measured, which should give a base for quotes to build this cycle path. DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 16 of 31 06.05.2020

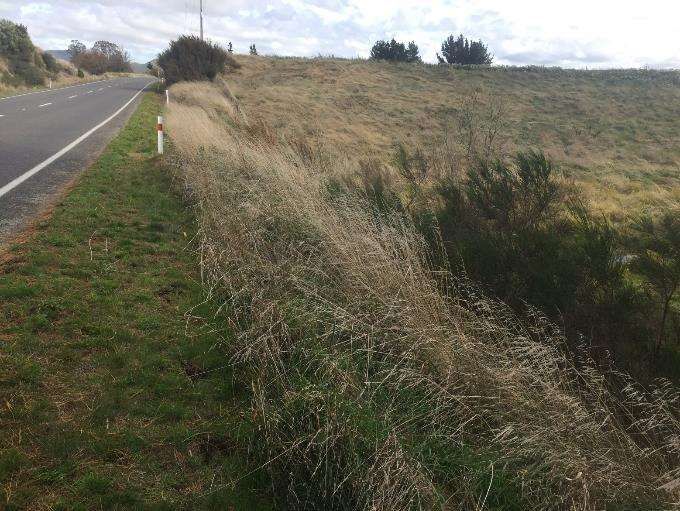

Attachment 28 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 1 (at house 505): This ditch goes 2m lower than street level and has an overgrown culvert with probably a of max. 1m. Additional soil needed. Length: 25m / Height difference: 2m Additional costs for: maybe a new culvert, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 17 of 31 06.05.2020

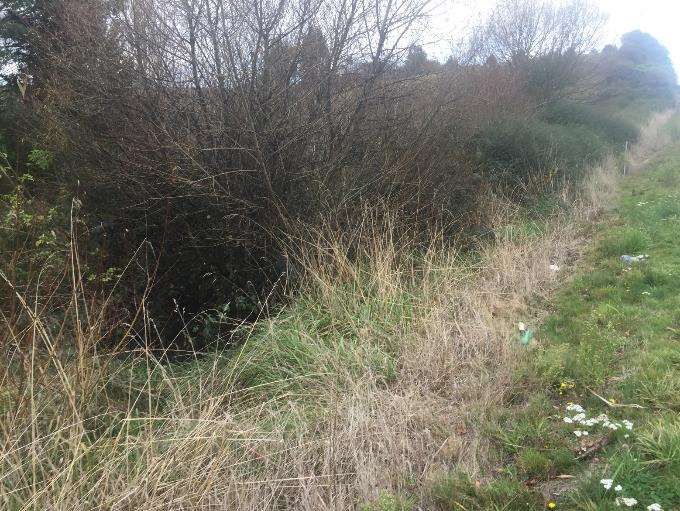

Attachment 29 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 2 (at Banjo’s place, after house 501): Bank which probably cannot be removed, because of not wide enough. We recommend to find a way with the land- owner to use the already existing cow path. Length: 200m / Height difference: 15m Additional costs for: cutting trees/bushes, additional digging, additional soil, new fence line DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 18 of 31 06.05.2020

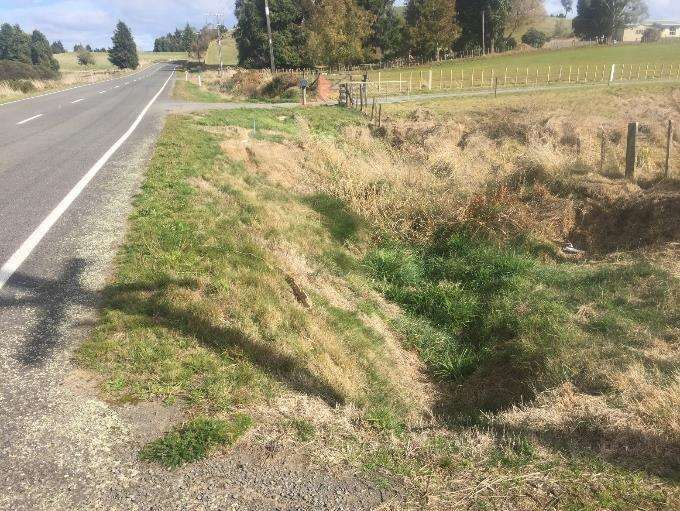

Attachment 30 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 3 (after the bank near house 469): After the bank (obstacle 2), it goes down lower than the street level. Actually, there is no culvert, so the rainwater goes into the soil. Here we definitely need additional soil to flatten the path. Length: 30m / Height difference: 4m Additional costs for: additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 19 of 31 06.05.2020

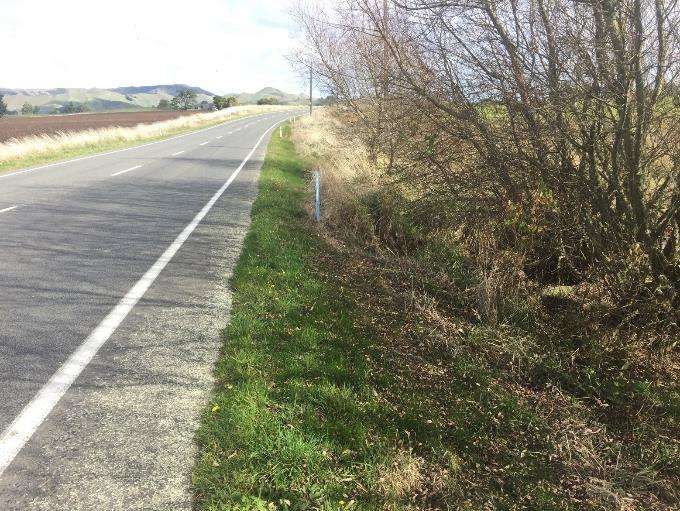

Attachment 31 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 4 (before house 391): Culvert needed because floating water Length: 30m Height difference: 4m Additional costs for: new culvert, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 20 of 31 06.05.2020

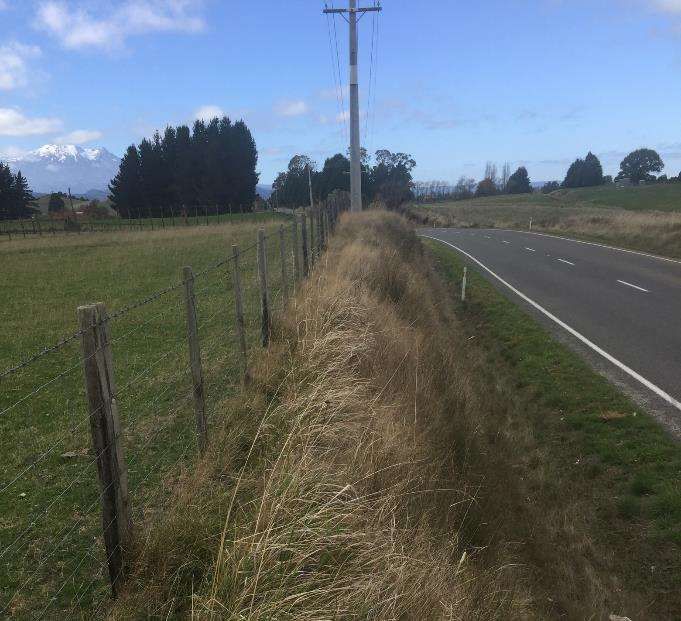

Attachment 32 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 5 (after house 391): Power pole is very close to the street. Is the fence line right? Can the power pole be moved two meters? Length: 30m / Height difference: 3m Additional costs for: additional digging, additional soil, maybe for moving power pole DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 21 of 31 06.05.2020

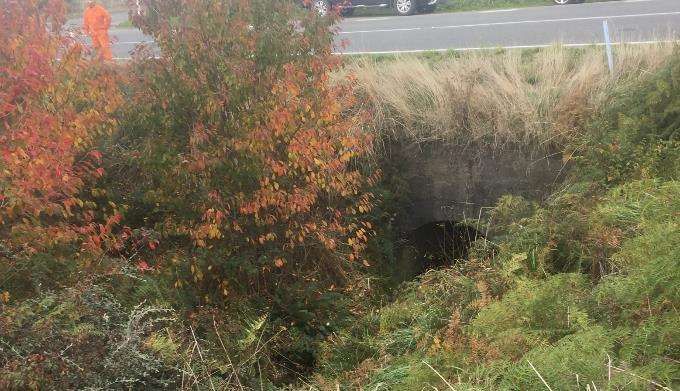

Attachment 33 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 6 (cross section to Pakihi Road): Here we have a tunnel which needs a bridge or tunnel extension. Length: 10m Height difference: 2m Additional costs for: cutting trees/bushes, extension of tunnel or for building a bridge, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 22 of 31 06.05.2020
Attachment 34 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 7 (after the Old Vegetable Road junction): Colvert 1m needed and additional soil Length: 20m / Height difference: 2m Additional costs for: cutting trees/bushes, new culvert, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 23 of 31 06.05.2020
Attachment 35 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 8 (at Dr. Cobitts old house/house 231): Colvert 1m needed Length: 20m / Height difference: 4m Additional costs for: cutting trees/bushes, new culvert, additional digging, additional soil Obstacle 9 (at Dr. Cobitts old house/house 231): Remove of bank needed. We recommend to dig down the bank to a level of two meters above street level and have the cycle path then up there. Length: 40m / Height difference: 8-10m Additional costs for: cutting trees/bushes, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 24 of 31 06.05.2020
Attachment 36 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 10 (before house 207): Colvert 1m needed Length: 30m / Height difference: 3m Additional costs for: cutting trees/bushes, new culvert, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 25 of 31 06.05.2020
Attachment 37 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 11 (at Ngapahiri road junction): Trees under the power lines Length: 150m / Height difference: 3m Additional costs for: cutting trees/bushes, additional digging, additional soil Obstacle 12 (at opposite house no. 154): Colvert 1m needed Length: 50m / Height difference: 2m Additional costs for: cutting trees/bushes, new culvert, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 26 of 31 06.05.2020
Attachment 38 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 13 (at opposite house no. 82): Colvert 1m needed Length: 10m / Height difference: 3m Additional costs for: new culvert, additional digging, additional soil Obstacle 14 (at Raetihi town sign): Bank needs to be lowered and flattened Length: 10m / Height difference: 5m Additional costs for: additional digging, additional soil, maybe move the power pole DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 27 of 31 06.05.2020
Attachment 39 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 15 (at Raetihi town/speed50 sign): Culvert 1m needed Length: 15m / Height difference 1m Additional costs for: new culvert, additional digging, additional soil DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 28 of 31 06.05.2020
Attachment 40 Detail Concept Walk & Cycle Way from Ohakune to Raetihi Obstacle 12 (at Maori Marae entry, after town sign Raetihi/speed sign): Where the entry is to the Maori place, we plan to cross the street and connect to the already existing concrete foot path coming from Raetihi. We have chosen this place, because from here, the cyclist/hiker can overlook the road in both directions many hundred meters. So, a crossing of the road should be safe. Maybe additional signs warn the cars to be careful and watch out for cyclists. Construction: only street paint and maybe signs to warn cars Additional costs for: street signs, road painting DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 29 of 31 06.05.2020
Attachment 41 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 6 The Financing FINANCE PLANNING Bike - Walkway annual Construction maintenance actualized:16.04.2020 Ohakune-Raetihi Costs costs Total Costs NZ $ 506'000 NZ $ 20'000 Administration, Planning, Coordination, various (Initialization costs) NZ $ 20'000 NZ $ 5'000 Costs for map development and map printing (Cheal Ohakune) NZ $ 5'000 NZ $ 0 Costs for concept planning (Cheal Ohakune) NZ $ 10'000 NZ $ 0 base work and clarifications (Daniel Schlumpf) NZ $ 5'000 NZ $ 0 yearly fees for websites & other marketing costs NZ $ 0 NZ $ 5'000 Project Stage 1: Connection from Mangawhero River Road to Burn Street NZ $ 225'000 NZ $ 2'000 Project Costs, Permits and Planning Costs (Cheal, Council, NZTA and like) NZ $ 5'000 NZ $ 0 Bridge (HW 49) underpass (Digging, Concrete blocks, gravel, labour) NZ $ 10'000 NZ $ 0 Footbridge over little stream near Clyde Street/HW49 NZ $ 0 NZ $ 0 Building of the pad ca 1000m $ 200 per m2 950 NZ $ 190'000 NZ $ 0 Signposting of the route section NZ $ 5'000 NZ $ 0 Viewpoint where the two rivers meet NZ $ 15'000 NZ $ 0 maintaining in the next years (yearly costs) NZ $ 0 NZ $ 2'000 Project Stage 2: Along the Burn Street to Pick nic Area NZ $ 23'000 NZ $ 2'000 Project Costs, Permits and Planning Costs (Cheal, Council, NZTA and like) NZ $ 5'000 NZ $ 0 red scoria gravel for along the mainstreet & paint $ 10 per m2 800 NZ $ 8'000 NZ $ 0 Earth works (Labour and Hiring machinery) NZ $ 5'000 NZ $ 0 Signposting of the route section NZ $ 5'000 NZ $ 0 maintaining in the next years (yearly costs) NZ $ 0 NZ $ 2'000 Project Stage 3: Pick nic Area at the Mangawhero River Bend NZ $ 32'000 NZ $ 4'000 Project Costs, Permits and Planning Costs (Cheal, Council, NZTA and like) NZ $ 5'000 NZ $ 0 red scoria gravel for along the mainstreet & paint $ 10 per m2 200 NZ $ 2'000 NZ $ 0 Earth works (Labour and Hiring machinery) for prep of the pick nic place NZ $ 10'000 NZ $ 0 Metal, wood and other building material for the pick nic place NZ $ 10'000 NZ $ 0 Signposting of the route section NZ $ 5'000 NZ $ 0 maintaining in the next years (yearly costs) NZ $ 0 NZ $ 4'000 Project Stage 4: Mangawhero River Bridge & Mangawhero River Road NZ $ 83'000 NZ $ 2'000 Project Costs, Permits and Planning Costs (Cheal, Council, NZTA and like) NZ $ 5'000 NZ $ 0 planing, building and installing of the wooden bridge NZ $ 50'000 NZ $ 0 Earth works (Labour and Hiring machinery) for prep of the riverbed for bridge NZ $ 20'000 NZ $ 0 Signposting of the route section (incl. Signage for who uses the bridge) NZ $ 8'000 NZ $ 0 maintaining in the next years (yearly costs) NZ $ 0 NZ $ 2'000 Project Stage 5: Connection along the Main street to Raetihi NZ $ 123'000 NZ $ 5'000 Project Costs, Permits and Planning Costs (Cheal, Council, NZTA and like) NZ $ 5'000 NZ $ 0 red scoria gravel for along the mainstreet & paint $ 10 per m2 10'000 NZ $ 100'000 NZ $ 0 Earth works (Labour and Hiring machinery) NZ $ 10'000 NZ $ 0 Signposting of the route section (incl. Signage for who uses the bridge) NZ $ 8'000 NZ $ 0 maintaining in the next years (yearly costs) NZ $ 0 NZ $ 5'000 DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 30 of 31 06.05.2020
Attachment 42 Detail Concept Walk & Cycle Way from Ohakune to Raetihi 7 The Schedule Not up to date, sorry 2020 2021 Project Bike- & Walkway Ohakune to Raetihi Done AUG AUG MRZ MRZ NOV NOV OKT OKT APR APR DEZ DEZ JUN JAN FEB JUN JAN FEB SEP SEP MAI MAI JUL JUL Estimated time in days / and costs in NZ $ 0 / 0 Idea & Concept 0 NZ $ 0 Creation of the concept NZ $ 0 X …. NZ $ 0 X Stage 1: Mangawhero River- & Jubilee Walkway Connector 0 NZ $ 0 Planning the size and interior of the building NZ $ 0 X X Final drawing of the building and submitting the NZ $ 0 X X Resource consent documents Building of fundament and plumbing NZ $ 0 X Building of the chalet NZ $ 0 X X Installalation of electrical work and final plumbing NZ $ 0 X Final inspection and approval NZ $ 0 X Open for guests NZ $ 0 X X X Stage 2: Along the Burn Street to Pick nick area 0 NZ $ 0 Planning the expansion and first talks to builder NZ $ 0 X X Final drawing of the building and submitting the NZ $ 0 X Resource consent documents Start physical work of builder NZ $ 0 X work completed NZ $ 0 X Installalation of electrical work and final plumbing NZ $ 0 X Final inspection and approval NZ $ 0 X Open for guests NZ $ 0 X X X X -> Stage 3: Pick nic Area at the Mangawhero River Bend 0 NZ $ 0 Quote from a plumber NZ $ 0 Decision what can be done by me and what the plumber NZ $ 0 Plumber work done NZ $ 0 Stage 4: Mangawhero River Bridge & Walkway 0 NZ $ 0 Quote from a plumber NZ $ 0 Decision what can be done by me and what the plumber NZ $ 0 Plumber work done NZ $ 0 Stage 5: Connection to Raetihi 0 NZ $ 0 Quote from a plumber NZ $ 0 Decision what can be done by me and what the plumber NZ $ 0 Plumber work done NZ $ 0 Status of the data: 16.04.2020 DETAIL CONCEPT Bike Way Ohakune to Raetihi V1.8 DSC 20200506 Page 31 of 31 06.05.2020
