Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...

Page created by Joel Greene

CONTINUE READING
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
Re-emerging from the rubble: What is
delaying regeneration of Christchurch
CBD?
O. Filippova, K. Elwood
University of Auckland.

T. Collins
University of Canterbury.

ABSTRACT
Nearly ten years since the February 2011 earthquakes devastated Christchurch CBD, partially
demolished, derelict buildings and poorly maintained vacant sites remain in the post-earthquake
landscape. While Christchurch City Council has made significant progress in recent years to reduce
the level of vacant and derelict land across the city, several property owners remain reluctant to
improve their buildings. This project documents the current inventory of derelict properties and
investigates issues that are delaying progress on these sites (e.g. insurance disputes, supply and
demand of commercial and residential space in the CBD, delays in consenting, absentee owners,
lack of funds etc). Furthermore, we explore regulatory levers that can be used to influence action on
these buildings/sites (e.g. provisions in the Building Act, compulsory acquisition etc). As we
approach the 10-year anniversary of the earthquakes, this project offers a timely reminder of the
mammoth struggles that the city has overcome evident in the numerous modern buildings, yet a few
‘battle sites’ slow the much-needed regeneration towards a resilient city centre.

1   INTRODUCTION
The February 2011 earthquake caused widespread damage across Christchurch, especially in the central city
and eastern suburbs. In the aftermath of the disaster, the city was faced with a challenge of filling in empty
sites that appeared in place of the 70% of the central city buildings that came down in demolitions. The
central city lost half of its workforce and 2/3 of inner-city residents were forced to move out. The rebuild was
focused on attracting people back into the city. The government set plans for major anchor projects as a
catalyst to boost commercial and recreational activities in the CBD, while private developers got on with the
redevelopment of commercial buildings as insurance money began to flow and more land became available
as edges of the cordon moved back.

                                                  Paper 187
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
Most recent economic and residential statistics show positive signs of recovery, yet after a decade since the
2011 earthquake central city is still peppered with vacant sites and derelict buildings which are impacting re-
investment in local infrastructure and are considered as barriers to successful regeneration. In this paper, we
present analysis of the Christchurch City Council’s programme targeted at progressing action on buildings
neglected because of the earthquakes.

2    BARRIER SITES
Naturally, city centre revitalisation was among highest priorities for the Council. In 2016 the Council began
focusing their attention on sites and buildings where owners have made no effort to remediate damage (CCC,
2017). The council believed that by that time, sufficient period has passed to resolve even complex insurance
disputes and/or to investigate and commence reconstruction/refurbishment. At a meeting in May 2017, the
Council considered a report that outlined framework and strategies for progressing action on problematic
central city sites and was presented with an initial list of 30 derelict buildings and vacant sites (Ccc.govt.nz,
n.d.). The list was made publicly available (Newsline.ccc.govt.nz, 2017)., quickly dubbed ‘Dirty 30’ and
receiving wide coverage in the media. The combination of soft and hard measures developed by the Council
were applied progressively/gradually on property owners to result in repair, restoration, or redevelopment of
their sites (Figure 1).

Figure 1: Barrier sites framework (Source Christchurch City Council).

To encourage compliance, the Council adopted a VADE model – Voluntary, Assisted, Directed,
Enforcement. The intention of the programme was to operate within the Voluntary and Assisted part of
VADE spectrum. Once the soft options are exhausted, the Council would then resort to directing property
owners to act by issuing notices to fix or abatement notices, with the final step being enforcement action
which would fall in the realm of council bylaws and various pieces of legislation such as the Building Act,
Local Government Act and Health Act. From the outset the enforcement route was not favoured within the
Council and was perceived to be costly and legalistic. Since the launch of the programme, the Council was
able to achieve action on majority of the barrier sites operating within voluntary and assisted spectrum.
Given that a significant number of heritage buildings succumbed to the earthquakes, several buildings in the
programme received generous heritage grants to assist with restoration ranging from $170,000 to $1.9
million.

2.1 Evolution of the ‘Dirty 30’
The publication of the original list of neglected properties was meant to be a living document, with sites
coming off the list as plans for redevelopment were being finalised while new problem sites would be added
to the list. The first list featured 31 sites and by the end of 2018 a further 14 sites were added. As evident on
the map below (Figure 2), the largest cluster of sites is in the core of the city centre as most likely those

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
buildings were inaccessible longer due to cordon. In fact, the post-earthquake office market has shifted its
prime centre from the core with a new precinct emerging in the west end of the CBD along Cambridge
Terrace. As one local property developer explained, development along the edges of the cordon resulted in
‘unloved streets’ in the core of the city with rows of vacancies and abandoned buildings.

Figure 2: Map of the central city barrier sites.

Table 1 provides the full list of the central city barrier sites. Twenty four of the 45 sites have been
permanently removed from the list with the owners either completing or being in the process of
redevelopment, including three sites that have been cleared, tidied and now held in vacant possession. Most
of the buildings on these sites have been repaired/restored. A cluster of heritage buildings in High Street –
also known as Duncan’s building - had their facades restored and new structures going behind. With the
numerous heritage buildings destroyed in the earthquakes, preservation of these buildings is an important
reminder of the city’s rich history for future generations.
The Council is actively pursuing the remaining owners to take action on the sites. Thirteen owners indicated
to the Council their plans for the buildings. Some of the owners have applied or already received building
consents and work on those sites is eminent. These plans include the development of a new Catholic precinct
in Armagh Street on the sites of the former PWC building and the adjacent cleared site of the former
Copthorne hotel. The development will include a replacement for the damaged Cathedral of the Blessed
Sacrament. Awaiting redevelopment, the PWC site famously became home to a colony of the endangered

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
black-billed gulls (Figure 3(a)). Restoration of the Old Municipal Chambers, another prominent historic
building, is about to commence as the Council entered into an agreement with a private developer to develop
and lease the building (Figure 3(b)).

    a) PWC site                                             b) Old Municipal Chambers
Figure 3: Sites with confirmed plans for redevelopment.

Most recently, plans for redevelopment of two notorious buildings featured on the list have been signalled.

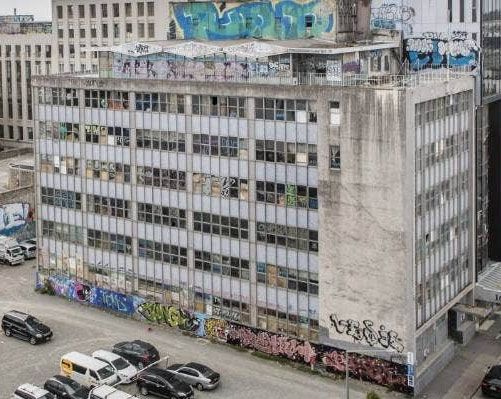

The first is the Malvern House – arguably the poster child of the barrier sites programme – the most tagged
building in the city and a magnet for squatters (Figure 4 (a)). The other is the former IRD premisses – built in
2007, it sat damaged and vacant since the quakes (Figure 4 (b)). While redevelopment of barrier sites is a
signal of recovery and confidence in the city, the Council understands a commitment to action does not
always equate to completed projects. Several of the sites featured on the list have exchanged owners (some
of them multiple times) since the earthquakes, with each new owner announcing plans for development only
to then abandon them.

    a) Malvern House                                        b) Former IRD building
Figure 4: Sites likely to be redeveloped.

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
Table 1: List of barrier sites and progress indicators.

     Street address              AKA                      Status      Scope of work           Use
                           Former Trinity
 124 Worcester St          Church/Shands          work completed     repair             commercial
                           Bldg
 152 Oxford Ter            Public Trust Office    work completed     repair             commercial

 81 Lichfield St           Lincoln House          work completed     repair             commercial

 167-169 Hereford St       Hereford Chambers      work completed     repair             commercial

                                                                     original
 201-203 High St           Victoria Black         work completed                        commercial
                                                                     façade/new build
                           Former Work &
 231 High St                                      work completed     repair             commercial
                           Income

 12 Latimer Square         Park Tower             work completed     repair             residential

 135 High St               High Street            work completed     new build          commercial
                                                                     original
 143-157 High St           High Street            work completed                        commercial
                                                                     façade/new build
                                                                     original
 163 High St               High Street            work completed                        commercial
                                                                     façade/new build
                                                                     original
 165 High St               High Street            work completed                        commercial
                                                                     façade/new build
 673 Colombo St            Pagoda Court           work completed     new build          commercial
                                                  removed from the                      Catholic
 143-145 Armagh St                                                   cleared site
                                                  list                                  precinct
                           Former PSIS            removed from the
 128 Armagh St                                    list               cleared site       tbd
                           building
                                                  removed from the
 167 High St               High Street                               cleared site       tbd
                                                  list
                           Former Scorpio         under
 79 Hereford St                                                      repair             hotel
                           Books                  redevelopment
                                                  under
 31 Cathedral Square       Old Post Office                           repair             commercial
                                                  redevelopment
                                                  under
 96 Lichfield St           Living Space                              repair             residential
                                                  redevelopment
                                                  under                                 sport and
 216 Madras St                                                       cleared site
                                                  redevelopment                         recreation
                           Spagalimis / 28        under
 155 Victoria St                                                     new build          residential
                           Dorset                 redevelopment
                                                  under
 100 Cathedral Square      Anglican Cathedral                        repair             religious
                                                  redevelopment
                                                  under
 129-133 High St           High Street                               repair             commercial
                                                  redevelopment

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
under
 165 Hereford St        Broadlands House                            repair             commercial
                                              redevelopment
                        Nuttal Bradley        under
 79 Cambridge Ter                                                   repair             hotel
                        Building              redevelopment
                        235 - Brick, 237 -
 235 - 237 High St                            plans confirmed       repair             commercial
                        vacant site
 92 Lichfield St        Sol Square (part)     plans confirmed       repair             tbd
 159 Oxford Ter         Our City              plans confirmed       repair             office

                        Old CCC Offices
 210-214 Tuam St                              plans confirmed       repair             commercial
                        and Odeon Theatre

                        Kaplan/State
 116 Worcester St                             plans confirmed       repair             residential
                        Insurance
                        Former PWC                                  exposed            Catholic
 119 Armagh St                                plans confirmed
                        Building                                    foundations        precinct
                        Stonehurst
 249 Gloucester St                            plans confirmed       cleared site       residential
                        Hotel/Motel
                        Former IRD
 226-234 Cashel St                            plans confirmed       repair             medical
                        Premises
 179 Tuam St            Sol Square (part)     plans confirmed       repair             tbd

                        Victoria Mansions,
 91 Victoria St                               plans confirmed       repair             residential
                        368 Montreal

 141 High St            High Street           plans confirmed       repair             tbd
 170 Oxford Ter         Old Rydges Hotel      plans confirmed       vacant building    hotel
 159 Hereford St        Malvern House         plans confirmed       vacant building    tbd
                                                                    cleared site w/
 158 High St            Cotters               intentions unknown                       tbd
                                                                    original façade

                        Peterborough
 25 Peterborough St                           intentions unknown    repair             tbd
                        Apartments

                                                                    exposed
 170 Cashel St          Former Holiday Inn    intentions unknown                       tbd
                                                                    foundations

 137 Cambridge Ter      Harley Building       intentions unknown    vacant building    tbd

 112-114 Manchester
                        2 Fat Indians         intentions unknown    vacant building    tbd
 St
 66 Oxford Ter                                intentions unknown    vacant building    tbd
 161 Hereford St        Hereford Suites       intentions unknown    vacant building    tbd

 205 Manchester St      Blue Jean Cuisine     intentions unknown    vacant building    tbd

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
2.2 Enforcement tools
A number of property owner seem resistant to engage in a dialogue with the council and so far have not
shared any proposals for redevelopment. For the eight sites that are still unresolved, the Council is
considering the use or enforcement tools. As mentioned earlier, this is not the favoured approach as the
council would want to maintain the role of a facilitator rather than enforcer of change. Any legal action is
likely to be strongly opposed by owners, and would amount to significant burden on the resources and
finances of an already overstretched council. Nevertheless, the council has commissioned a review of
enforcement tools which include a range of acts and council bylaws (Table 2).
Table 2: Statutory tools favoured by the council.

Legislation/bylaw    Relevant section/clause                                      Nuisance

                  - Clause 7: Requires permits for obstructions in public
Christchurch City places
Council Public    - Allows for fees to be charged for permits                     Public realm
Places Bylaw 2008 - To be read in conjunction with Council ‘s Policy on           encroachment
                  Structures on Roads 2010

                    - Clause 20: Permits required for use of legal road
                    - Enables charging for use of public roads and footpaths
                    when containers/skips/fences and hoardings need to
                    occupy public roads and footpaths
                    - Requires TMP to be submitted with application for
Christchurch City
                    permit
Council Traffic and
Parking Bylaw       - s357 of LGA: Offence to put something on the road or Public realm
2008                allow it to remain without Council authorisation. Offence encroachment
                    to allow water for mud to flow from land on to a road. In a
                    successful prosecution, defendant may be ordered to pay
                    Council’s costs in removing materials. To be read in
                    conjunction with Council‘s Policy on Structures on Roads
                    2010

                 s.459; Power to require work be done on private land for
Local Government storm water drainage. Power to complete work, if not             Temporary gravel
Act 1974         done, and costs recoverable                                      carparks
                 .

                     s.123: Building can be insanitary if; hazard to health, in   Derelict buildings;
Building Act 2004                                                                 partial building/site
                     state of disrepair, lacks moisture penetration protection.
                                                                                  clearance

                    Transport - Rule: 7.4.2.3: RD6: (Restricted Discretionary):
                    Temporary car parking activity – resource consent
Christchurch City required, expires 30 April 2018.
                                                                                Temporary gravel
Council (Operative) Transport - Rule: 7.4.2.3: RD8 (Restricted Discretionary):
                                                                                carparks
District Plan       Commercial car parking lots.
                    Transport - Rule: 7.4.2.5 (Non complying if activity
                    doesn’t comply with 7.4.3.1.d)

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
Transport: Rule: 7.4.3.10 - High traffic generator
                      Transport: Rule: 7.4.4.8 - Illumination of parking areas
                      Transport: Rule: 7.4.4.9 - Surface of parking areass.17:
                      Duty to landowners to avoid, remedy or mitigate adverse
                      effects arising from activity. High threshold/test.

                      s.29: Nuisance – accumulation or deposit which is offence
                      or injurious to health, and/or harbours rats or other vermin,
                      and premises which are offensive (health related)             Derelict buildings;
Health Act 1956       s.33: Council may issue proceedings in the District Court Temporary gravel
                      for nuisance to be abated. Court may allow Council to         carparks
                      recover costs of doing work if owner/occupier fails to
                      abate nuisance and Court orders Council to carry out work.
Source: Christchurch City Council

3    FACTORS CONTRIBUTING TO SLOW REGENERATION
The scale of destruction and loss experienced in the Canterbury earthquakes was unprecedented for New
Zealand. Amidst fatalities and decimation of the CBD, emerged an opportunity to rebuild a city that is
resilient. The city’s Blueprint made the CBD more compact through rezoning and strategic land acquisition.
The CBD got a head start with a handful of government-led anchor projects aimed at revitalising the city. A
decade after the quakes, regeneration of Christchurch remains a tale of two sides: for some progress has been
too slow and other would say that a lot has happened. Numerous statistics indicate that central city is
bouncing back – workers and residents are returning – but still well below the pre-earthquake levels
requiring more government and private investment towards full regeneration.

3.1 Inner-city living
The council has an ambitious goal of increasing inner-city population to 20,000 by 2028. Project 8011 is the
Council’s initiative to creating a CBD that is compelling to ‘live, work and play’ for thousands of people.
Central city is on the back foot when it comes to competing against the attraction of the suburbs just outside
the CBD. The CBD is relatively small in comparison with other main urban areas, which means that within a
short commute of the CBD, potential buyers are spoilt
for choice with houses priced about 20% less offering
better parking and access to popular schools. According
to a recent REINZ report (REINZ, 2019), buyers
attracted to inner-city living are making a lifestyle
choice more than anything else and the location is more
popular among singles and young couples with
preferences for one- or two-bedroom units. In addition
to higher land values, developers are factoring in more
strict building requirements pertaining to central city
developments into the cost of construction making
housing more expensive.
Using Statistics NZ definitions, we collected
population summary for the last three Censuses. The
central area is made up of five statistical areas (SA2),    Figure 5: Boundaries of central city’s Statistical
                                                            Areas 2 (SA2) (Source: Statistics NZ)

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Re-emerging from the rubble: What is delaying regeneration of Christchurch - CBD? - NZSEE ...
namely Christchurch Central, Central-West, Central-East, Central-North and Central-South. Their outlines
are depicted in Figure 5.
During the 2006 Census, 12,960 people resided in the
central city. As the city began to rebuild, the size of
the population fell below 6000. In the latest Census,
this number sits at around 8000 falling short of the
critical mass necessary to support residential
developments planned for the city. The biggest loss
of population was from Christchurch Central SA2,
the epicentre of destruction (Figure 6).
Breaking down the population statistics into specific
age groups (Figure 7), we can see that central city is
popular among working age population. School-age
children is the least represented group within the
CBD, echoing the lack of education and recreation           Figure 6: Inner-city population counts.
facilities sought after by families. Across all age
groups, there are signs that population is returning to
the city centre but sitting below pre-earthquake levels.
Council commissioned research into the attraction of
inner city living (Research First, 2020), points to the
unrealistic targets set by the Council. Developers
operating in the market were concerned that the 2028
timeframe was too compressed for the current level of
demand. Some suggestions included greater effort in
the delivery of major economic initiatives aimed at
attracting businesses and people, for example delivery
of the Multi-Use Arena and Metro Sports Facility, both
would increase hospitality offerings and provide
                                                             Figure 7: Inner-city population by age group.
convenient recreation options for residents. In addition,
the Council should consider placing restraints on the
residential developments outside of the city centre and
offering greater incentives for inner-city building.

3.2 Working in the CBD
The impact of the 2008-09 global financial crisis combined with the 2011 earthquake significantly altered the
landscape of the central city’s economy. Just before the earthquake, employment in the CBD lost all of the
additional workers it gained in the previous decade contracting to pre-2000 level (Figure 8). As the CBD
began to re-open, the size of the labour market in the city centre was hovering above 22,000. After the
earthquakes, central city businesses dispersed into the suburbs. This pattern of dispersion is evident in the
latest 2018 Census, that shows a new trend of falling proportion of employed people commuting into
Christchurch CBD from outlying suburbs and districts. For example, nearly half of working population from
the neighbouring districts of Selwyn and Waimakariri worked in the CBD in 2013, this proportion fell to
38% and 32% respectively (Statistics NZ, 2020). In other words, like housing, commercial property market
in the CBD is forced to compete with suburbs in a post-earthquake environment.

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
Figure 8: Central city workers by SA 2, 2000 – 2020. (Source: Statistics NZ – Business Demography)

Employment in the CBD has been growing steadily. Early in the rebuild, property developers re-entered the
CBD helped by insurance settlements from damaged buildings, starting on the fringes of the centre as
cordons progressively moved back. First developments went up along the riverfront and Victoria Street.
Building in these areas are now experiencing the highest level of demand. Replacement of the commercial
building stock seemed like an impossible task, with the city centre being a blank canvas, reduced to rubble.
The pace of reconstruction was unprecedented (Table 3). With developments completed over the last 10
years, the stock is now at 85% of the 2010 level (Figure 9). One of the factors that contributed to the fast
recovery of the building stock is the historical ownership of commercial property within the CBD being
heavily skewed towards locally based high net worth investors which collectively owned over 80% of
buildings and 2/3 of the total stock (EYTAS, 2012). Earlier research suggests that these investors had strong
place attachment to the city and wanted to help it rebuild. Another interesting observation is that the west end
of the CBD is experiencing high tenant demand with employment size in the Central-West SA2 similar to
Central SA2.
Table 3: CBD office construction.

Year        Stock added (m2)

2014        106,901

2015        142,507

2016        94,485

2017        32,637

2018        9,542

2019        1,452

2020        0                                Figure 9: Inventory of Christchurch CBD office stock.
Source: Colliers NZ (2020)                   (Source: Colliers NZ (2020)

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
It is important to keep in mind that any recovery
in the commercial market is not going to be fast.
To give some prospective, the market
experienced only moderate growth from the
1990’s leading up to the earthquakes. In the early

90’s, vacancy rates reached 30% (Figure 10).
The only significant building to enter the market
was a building at 250 Oxford Terrace in 2007.
By then vacancies reduced but this has been
helped by the removal of older office stock
converting to hotels. Office rents achieved in
1989 for premium grade buildings were at $225
per sqm, by 2010 net rents only increased to
$270 per sqm, which equates to an annual growth
rate of less than 1%. New structural design              Figure 10: Survey of office vacancies in Christchurch CBD
requirements introduced after the earthquakes and        (Source: Colliers NZ)
the added risk margin of the uncertain outlook for
the central city rebuild, meant that financial viability
of new developments required rental income at $460
per sqm, on par with premium rents achieved in
Auckland at that time. While businesses expressed
their desire to return to the CBD, the pre- and post-
earthquake rent gap was unachievable for vast
majority. The CBD, however, is beginning to look
more attractive to tenants currently leasing in the
suburbs. Rental rates have reduced since the post-
earthquake high of $450 per sqm and appear to have
stabilised at $320 per sqm (Figure 11). As leases         Figure 11: Comparison of suburban and CBD office rents
terminate, tenants in suburban locations would be         (Source: Colliers NZ)
looking to shift into the CBD, since those tenants
would have signed up in the suburbs in 2012/13 at
rent levels not too dissimilar to the rents charged in
central office precincts presently.
While the current available space is absorbed, plentiful stock of suburban office space will continue to
moderate the CBD rents, meaning that rents are unlikely to increase. As discussed earlier, construction costs
demand rents higher than what is currently achieved in the market. Therefore, no significant new supply is
expected to hit the market. In addition, the Reserve Bank’s quantitative easing aimed at stimulating the
economy during COVID, resulted in low property holding costs for owners (i.e. low interest rates) providing
little incentive to redevelop vacant buildings/sites and take a wait-and-see approach for the property market
to turn.

3.3 Anchor projects
The much anticipated rebuild blueprint for the quake-damaged Christchurch city centre was revealed to
public in July 2012. The plan included 12 major anchor projects to be delivered by 2017, some have been
scaled back (e.g. South Frame) while some are still waiting to break the ground (e.g. Canterbury multi-use
arena). Their intention was to attract new residents, visitors, businesses, and private market-led
redevelopment. Concerns around prolonged delays in turn are putting breaks on the ability of the city centre

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
to attract private investments in residential and commercial construction. Timely delivery of the anchor
projects is crucial in the full regeneration of the CBD as this sends a signal of commitment of the local and
central governments, providing much needed certainty and confidence to the public. Having a complete
picture of what the CBD would look like post-rebuild, helps define plans for developments to go around the
anchor projects. Evidently, barrier sites where no active work is currently being done (i.e. plans confirmed
but no work started and intentions unknown) are clustered around anchor projects that are yet to be fully
completed, specifically around the East Frame, CMUA and South Frame (Figure 12).

                                                                      CMUA

                                                                      (Multi‐
                                                                       use
                                                                      Arena)

Figure 12: Location of anchor projects and barrier sites around the CBD.

4   CONCLUSION
While the Council might be resorting to applying pressure on the sites lingering on the barrier sites
programme, including enforcement actions ranging from a set of legally prescribed orders under the council
bylaws and Acts, it is more likely that the redevelopment would be organic, market-led rather than strictly
dictated by the council. Any regulatory tool can only reach so far into the strongly guarded private property
rights. The Council plays an important role in addressing uncertainties of the central city redevelopment in
terms of the development of the key assets for the city. Important interdependencies exist in the rebuild in the
sense that developers are waiting for these key projects so that they can get underway. Their delivery will
determine the speed at which the city is fully regenerated. Distraction that is barrier sites, undoubtedly, takes
away council’s focus and resources from these key projects. At the same time, it is important that the
negative impacts of the neglected buildings and unkempt vacant sites are contained. As the city charges
towards full recovery, abandoned buildings stick out as a sign of reversing fortunes. Research links
abandoned properties with increased crime, risk to public and a burden for local governments. Moreover,

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
barrier sites have negative spillover effects that can spread to neighbouring properties, threatening to become
the latest additions to the ‘Dirty 30’.

REFERENCES
Ccc.govt.nz. (n.d.). Barrier sites. [online] Available at: https://ccc.govt.nz/the-council/future-projects/barrier-
sites.
Christchurch City Council [CCC]. (2017). “27 May 2017 Christchurch City Council Meeting Agenda– Item
16 Central City Regeneration: Tackling Barrier Sites”. Available at:
https://christchurch.infocouncil.biz/Open/2017/05/CNCL_20170525_AGN_1288_AT_WEB.htm
Colliers NZ. (2020). “Property Council NZ Christchurch Market Summit Presentation 2020”. [online]
Available at: https://www.colliers.co.nz/en-nz/research/colliers-pcnz-christchurch-market-summit-
presentation-2020
Ernest & Young Transaction Advisory Services [EYTAS]. (2012). “CERA Christchurch central city
commercial property market study – Part 2”. Available at: https://ceraarchive.dpmc.govt.nz/documents/cera-
christchurch-central-city-commercial-property-market-study
Newsline.ccc.govt.nz. (2017). Council releases list of central city barrier sites. 27 May 2017. [online]
Available at: https://newsline.ccc.govt.nz/news/story/council-releases-list-of-central-city-barrier-sites
Real Estate Institute of New Zealand [REINZ]. (2019). “Christchurch City Council research report”. [online]
Available at: https://ccc.govt.nz/assets/Documents/Culture-Community/Central-City/REINZ-Real-estate-
market-Christchurch-Central-City.-December-2019.pdf
Research First. (2020). “Central city report” [online] Available at: https://ccc.govt.nz/assets/Documents/The-
Council/Plans-Strategies-Policies-Bylaws/Plans/central-city/Research-First.-Central-City-dnd-research.-
June-2020-report.PDF

Paper 187 – Re-emerging from the rubble: What is delaying regeneration of Christchurch CBD?
NZSEE 2021 Annual Conference
You can also read
