RANDWICK CAMPUS REDEVELOPMENT - CONSTRUCTION MANAGEMENT PLAN INTEGRATED ASB ADDITION - Major Projects
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION CONSTRUCTION MANAGEMENT PLAN INTEGRATED ASB ADDITION TABLE OF CONTENTS 1.0 INTRODUCTION 2.0 STAGING AND BUSINESS CONTINUITY 2.1 Randwick campus business continuity 3.0 RISK AND HAZARD MANAGEMENT 3.1 Identification and management of key project risks 3.2 Managing risks within an operational hospital environment 3.3 Key Randwick construction interface overview 3.4 Hazardous material 4.0 DESIGN FINALISATION AND SUBCONTRACTOR ENGAGEMENT 4.1 Subcontractor procurement and engagement 4.2 Inductions 4.3 Design development finalisation 5.0 OPERATIONS AND SITE MANAGEMENT 5.1 Overview 5.2 Description of the works 5.3 Dilapidation surveys and monitoring 5.4 Site establishment 5.5 Cranes and materials handling 6.0 CONSTRUCTION PROGRAM METHODOLOGY 6.1 Summary program of works 6.2 Construction staging 2 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 7.0 COMBINED TRAFFIC AND PEDESTRIAN MANAGEMENT 7.1 Traffic management and control 7.2 Construction pedestrian access and circulation routes 7.3 Existing parking provision 7.4 Virtual Superintendent 8.0 CONSTRUCTION WORKER TRANSPORTATION STRATEGY 8.1 Introduction 8.2 Traffic management and control 8.3 Construction workforce 8.4 Existing parking supply and utilisation 8.5 Management of worker parking and transport 8.6 Worker transportation and parking 8.7 Dedicated parking facility – ‘Park and Ride’ initiative 8.8 On-site facilities 9.0 STAKEHOLDER MANAGEMENT 9.1 Consulting and communicating 10.0 AUTHORITIES 10.1 Legislative requirements 10.2 Planning approval and construction certificate 10.3 Utility provider and associated external approvals 11.0 HOSPITAL INTERACTIONS AND MANAGEMENT 11.1 Cranage and helicopter management plan 11.2 Working in an operational hospital environment 11.3 Construction interface group (CIG) 11.4 Disruptive works notice process 11.5 Coordination of services shutdowns and reconnections 11.6 Infection prevention and control management 12.0 PROJECT COMPLETION 12.1 Overview 12.2 Quality management 13.0 APPENDICES 13.1 Site establishment staging plans 13.2 Project organisation chart Lendlease / August 2019 3
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION The CMP also defines the impacts of the proposed 1.0 INTRODUCTION construction activities on areas within the RCR site The Randwick Campus Redevelopment Acute Service and hospital campus the Prince of Wales (POW) Building (RCR-ASB) is a highly complex project with Hospitals Campus (Campus). This plan will outline the critical early milestone components that must be proposed mitigation strategies to be implemented delivered on time. The objective of this Construction during the relevant construction activities and Management Plan (CMP) is to ensure that the IASB outlines contingency measures that will be enacted Addition (the Project) is safely delivered using a to minimise any potential risk to HI, SESLHD, its robust set of methodologies and zero unplanned community partners and stakeholders. disruption to hospital services. Our proactive and collaborative approach to our The IASB Addition includes the lowering of Hospital client NSW Health Infrastructure is underpinned Road, and construction of the UNSW Eastern by the following overriding and non-negotiable Extension (Base Building only) and associated Link objectives: bridges. These works will occur concurrently to the • Maintain business continuity of the campus and ASB construction. adjoining facilities and properties; The Lendlease construction management processes • To deliver a world class facility for our client on will provide: time to the highest safety and quality standards; • Seamless performance and accountability from a • Safe and timely delivery of the Integrated ASB single responsible entity; Addition, enabling construction of the RCR; • The works will be managed by a single proven • Communicate in a timely fashion with all relevant responsible entity; and stakeholders what, when and how we are planning • a mechanism to reduce risks during project delivery. to undertake interface works; Lendlease has produced this CMP as the contractor • Present a positive public perception of the project responsible for the delivery of the project. It is during the construction works; envisaged that this CMP will evolve during the • Use experienced and qualified subcontractors with course of the Project as the design develops in appropriate resources to deliver their works in the conjunction with the design consultant team, project manner we prescribe; and stakeholders, Health Infrastructure (HI) South East Sydney Local Health District (SESLHD) and • Hands on control of subcontractors from Pricewaterhouse Coopers (PWC). experienced Lendlease site supervision. In the following sections, we have set out how HI will have four key outcomes from the Lendlease we intend on managing the Project and activities CMP: associated with the RCR. CERTAINTY PARTNERSHIP CAPABILITY COMPLIANCE • Robust management • Transparency of • Extensive industry • Processes that meet processes across all areas management processes experience of the project Health Infrastructure, of the business • Shared responsibilities leadership in delivery industry and company • Demonstrated and strong applied to the project certification requirements delivery experience team • Superior QA performance • Collaboration with Client and contractor market 4 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 2.0 STAGING AND BUSINESS CONTINUITY 2.1 RANDWICK HOSPITALS’ CAMPUS HEALTH SERVICE CONTINUITY Proposed methodology for working within an operational hospital environment and maintaining pedestrian traffic and vehicular traffic to entries; 2.1.1 Working within the operational hospital Along with significant works interfaces noted environment above there will also be planned investigative works, access to plant rooms, minor temporary The Lendlease project team understands the works and installation of protective measures challenging nature of the RCR and the constraints which will require process and controls to ensure of managing major construction works adjacent full visibility of all subcontractors for these types and within an operational hospital environment and of activities. Lendlease will impose a strict regime the non-negotiable requirement of no disruptions of consultation on all works outside the site to hospital ‘business continuity’. perimeters, regardless of the nature of the Works areas intended works. The first strategic approach from the site The Disruption Works Notice process will be team in addressing live environment works is followed here. This includes all workers to firstly elimination. This means isolating work areas from complete the required hospital worker induction operational hospital areas prior to any works being and secondly, Lendlease will institute a ‘Permit to commenced and eliminating a works/hospital Work’ process for all works outside of the secured operations interface. site areas. This will be the case for the major works to the The permit system puts hold-points in place, following areas: which have to be signed-off prior to permit issue. If • The identified demolition area will be enclosed workers are found to be working without permits, by A Class hoardings and will be secured to they will be removed from the Project. The hold ensure no unauthorised access. The A Class points for the ‘Permit to Work in the Hospital Area’ hoarding will be maintained for the construction will be the same as those for the Disruption Works of the new ASB; and Notice, to ensure a consistent level of compliance from the subcontractors. • During the Project works to ensure overhead protection for pedestrians is maintained a class Lendlease have identified a 4 step process that “B” hoarding will be installed along sections of we will undertake to ensure that the design Hospital Road. and construction methodology mitigates the construction risks inherent in conducting site When elimination is not feasible, the second works within a live Health Campus (refer Figure 1). approach is to fully isolate the work area through The planning for health service continuity and secure hoardings prior to commencing any works risk management 4 step process will underpin all and to provide controlled work access through the stages of the RCR-ASB project and will be used as operational environment. This will be applicable to: the guiding principle for how construction will be • Services connections to existing infrastructure undertaken around the campus. that are required. Lendlease / August 2019 5
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION STEP 1 STEP 2 STEP 3 STEP 4 Identify Critical Validate Extent of Endorsement of Ongoing Interface Health Service Impacts to Health Updated Design & During Construction Continuity Service Continuity Construct (D&C) Components Methodology Desktop Review Site Construction Investigation Presentation Interface Group Figure 1: Four step business continuity process Step 1 has been undertaken during the planning • Separation of the construction workers from phase by Lendlease and will heavily influence initial staff, public and patients by providing discrete construction methodology planning. Examples site accommodation and amenities within the include but not limited to the following: construction boundaries; and Program and staging: • Using low impact construction methods to ensure noise and vibration doesn’t impact the • Analysis of disruptive works staging in the most daily operations of the Hospital and nearby efficient manner to minimise disruption to the residential properties. Campus stakeholders; and Lendlease will follow steps 2 and 3 to validate these • Sequencing construction to ensure handover of assumptions and further develop them ready for completed spaces to the RCR at the best and the construction phase. earliest opportunity. Step 4 implements ongoing risk assessment, Site establishment: mitigations and controls that have been established • Efficient use of existing redundant facilities through Steps 1-3 and the continual monitoring of and space available for site establishment to changing conditions that may affect our design and minimise space taken by the construction site; construction methodology. Strategies to support • Off Campus solutions to construction car parking Randwick business continuity include but not to ensure no disruption to car parking within the limited to: precinct; and • Regular construction risk assessment using the • Planning for construction access in controlled Interface Strategy principles to identify areas of zones. and manage potential interface risks that may affect the Campus business continuity; Construction interfaces: • Utilising the Disruptive Works Notification • Strictly controlling where construction will (LiveOps) process to identify, manage, interface with the Hospital nearby residential communicate and collaborate on works that dwellings or public; affect the existing Hospital facility in a clear and • Implementing airtight, acoustically treated transparent way; hoardings for all existing building connections • Undertake a holistic integrated system testing to minimise Infection Control risks and reduce and commissioning process; construction noise impacts to nearby existing buildings; • Undertaking an efficient, transparent Completion and Validation processes in collaboration with • Ensuring sight lines from the construction site the SESLHD and principal representatives to are managed so that patient and residential ensure that the completed product is seamlessly privacy in adjacent buildings are maintained; transitioned into a live hospital environment; and • Developing a web based Disruptive Works • Community notices / updates. Notice (LiveOps) system to identify, document and communicate disruptions to stakeholders in a timely, interactive and transparent manner; 6 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 3.0 RISK AND HAZARD MANAGEMENT 3.1 IDENTIFICATION AND MANAGEMENT OF KEY PROJECT RISKS Identify the key issues and risks for the Project and provide your proposed approach to management and mitigation of these issues and risks The RCR presents a number of challenges that need To achieve this objective Lendlease propose using to be delivered through a planned and structured a risk identification strategy built around the key approach. interface points between the construction and the operational Health Precinct. This Interface Prior to commencing construction activities an Strategy will be critical in risk identification and will extensive analysis of the project documents will be used to influence design decisions and dictate be undertaken including multiple site inspections construction methodology. to thoroughly understand and plan the Project based on our awareness of the key risks. Within The following provides an initial assessment of the this section an initial assessment of such risks key interface risks and mitigations associated with and the proven construction delivery techniques the Lowering of Hospital Road and UNSW Eastern adopted for the project are outlined/ described/ Extension (Base Building only) associated with the documented. RCR. These will be developed in meticulous detail during the planning phase to inform the design The key objective is to cause “zero unplanned and construction methodology, eliminate or disruptions” during delivery of the works. manage risks appropriately and to ensure a smooth interface with the existing Campus. Approach to Risk Management Risk, major issues Details Mitigation Benefit and interface type Maintain the public’s Understand the implications Review the construction staging Minimise impacts of perception of of construction staging on with the hospital to ensure the full disruption to the hospital’s ‘business as usual’ the hospital’s operational understanding and acceptance of the daily activities wherever for the Randwick drivers and the potential proposals: timing/duration, construction possible. Hospitals’ Campus impacts. impacts, power tools, noise, temporary Separation of construction partitions and access routes etc. and Hospital/public. All workers will be made aware of their Workers to be constantly responsibilities towards understanding reminded of the consider what constitutes disruptive works rephrasing -eg special and to understand the time frames considerations of patients associated with preparing to carry out and other hospital users. any such works. Lendlease / August 2019 7
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION Approach to Risk Management Risk, major issues Details Mitigation Benefit and interface type Working adjacent Construction works will take Privacy screens will be erected to Increased patient privacy to Royal Hospital for place adjacent to existing remove direct sightlines from the RHW improve wellbeing. Women (RHW) RHW facilities with potential into the site. Separation of staff and disruption to services. Workers will be made aware of patient patients from construction. privacy within the RHW bedrooms. Workers are cognisant of No unauthorised removal of privacy patient/user privacy and screens erected on scaffold to prevent safety. direct sightline within wards from the site. Where there are potential disruptions, extensive planning and consultation will be undertaken prior to commencement of disruptive works. Construction Workers Construction works should Access to and from site will be defined Reduced congestion of access and egress cause the least amount of and out of bounds areas clarified for public areas through affecting daily disruption possible for staff workers. The induction will focus on separate access routes and Hospital operations and patients. the amenities planned for within the social areas. construction site boundary which Workers are cognisant of include lunch facilities with a selection patient/user privacy and of food outlets designed to offer safety. choices to workers to limit their need to exit site at meal times. Working around With construction in close All workers will be made aware of Children, their carers, and children proximity to the existing their responsibilities towards working the staff in the Sydney Children’s Hospital, workers adjacent to facilities with children. Any Children’s Hospital will need to be aware of workers involved with direct works are reassured that the working around children. inside identified areas will be required increased activity will not to undergo a ‘working with children have negative impacts on check’. young patients, and that workers are sensitive to their responsibilities around children. Separation of staff and patients from construction. Workers are cognisant of patient/user privacy and safety. Disruption to critical Disruption to critical life Clear identification of critical building Zero unplanned disruptions life services services for tie-in’s between services. Any construction works to existing facility and new and existing. which could impact these services critical services. only to proceed once full work plans and contingency plans are in place and signed off by all parties. Disruption to Light Work in close proximity Clear communication and planing Nil disruption to Light Rail Rail Operations to energised wires and protocols to be set-up and managed to external operations and the adjacent work zones. ensure a successful project outcome. demolition phase can stay on program. 8 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION Approach to Risk Management Risk, major issues Details Mitigation Benefit and interface type Disruption of the Lendlease will provide a The Project works will be Pedestrian safety with existing hospital controlled intersection programmed with a full temporary logical wayfinding routes pedestrian and vehicle with mechanical traffic traffic management system to be Controlled traffic access lights at the top and base established and coordinated with management of delivery drive. Lendlease the hospital stakeholders prior to the Minimises interface between will have attendance on site commencement of construction. construction and the Health to ensure that the delivery Traffic controller management of the precinct. drive is kept open and safe. entry and exit to existing Hospital When the delivery drive is Loading Dock. Traffic flow will closed to perform high risk be assisted and priority given to works the Lendlease site ambulance services and key hospital attendance will ensure the deliveries. delivery drive is safe. In consultation with the Principal and Randwick City Council, identify proposed construction vehicular traffic movements and routes. Prepare and agree a detailed traffic management plan that will be implemented on the Project. Vehicle parking The commencement of We will actively encourage the Minimises interface between the construction works for construction workers to use public construction and the Health the early and main works transport to commute to and from the precinct. contracts will see an influx site, we do expect that some additional Maintains existing carpark of subcontractor workforce vehicles will be attempting to park near numbers for staff, patients to the Precinct. site. and public We will review opportunity for supplementary offsite parking to alleviate existing parking pressures onsite. Impact on hospital Minimising loss of amenity Throughout the interface works we Continuation of regular operations for patients and staff during expect there will be a need for impact hospital activities with construction, in particular drilling for structural connections minimal disruption to staff the interface works at and the like. Lendlease will plan and and patients. the existing facades and sequence these works to occur at Minimises noise, dust and refurbishment works specific agreed times to allow as much vibration effect on the adjacent to occupied areas. respite time as possible, in addition operational Hospital. the utilisation of low frequency low impact tools and equipment will be implemented where possible. Core drilling will be utilised as an alternative where practical. Disruption to nearby Minimising loss of amenity Noise, dust and vibration monitoring Minimise noise, dust and residential and for nearby residential and proactive notification of disruptive vibration impacts on nearby business properties business properties during works selection of low impact dwellings. construction, in particular equipment where possible maintenance the interface works at of public safety. the existing facades and refurbishment works adjacent to occupied areas. Lendlease / August 2019 9
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION Approach to Risk Management Risk, major issues Details Mitigation Benefit and interface type Infection control A major issue whilst Provision of acoustic and dust proof Elimination of negative undertaking construction hoardings providing construction impacts on staff and work on an operational containment, the provision of localised patients’ health and campus. dust monitoring, maintenance of wellbeing. negative pressure areas plus the use Preventing dust from of air pressure sampling to ensure our entering a clean Hospital construction containment regimes are environment with ongoing working. monitoring to ensure The project specific Infection Control adherence to this policy. Plan is developed prior to commencing Minimises noise and the construction works. In preparing vibration effect on the this plan Lendlease will make reference operational Hospital to the ‘Infection Control Principles for the Management of Construction, Renovation, Repairs and Maintenance within Healthcare Facilities. The plan will identify the different types and locations of works planned on the RCR and specify the level of infection control required for each type of activity. Identification of existing hospital air intakes and review to determine if additional filtration is required. Environmental The site area will require Early Works Perimeter protections to Minimises negative Conditions careful management of site be investigated during the ECI Planning impact of construction to run-off. period. surrounding precinct and green zones. Removal of potentially Removal and disposal of Clearly communicate our Containment of potentially hazardous materials potentially hazardous or methodologies to the hospital and liaise hazardous materials in a contaminated materials and with all stakeholders to ensure visibility controlled manner. substances. and understanding of the processes. Continued compliance Fire zones and egress paths Maintain all required egress paths in Clear communication of of existing fire zones are to be maintained. coordination with the authorities. emergency egress for public Maintain smoke extraction and relief air and Hospital users. supply through the main entry doors. Undertake works in consultation with the Fire Engineer, Principal Certifying Authority and HI NSW. Unauthorised access Prevent unauthorised A solid 2.4m “A” class hoarding wall to Provision of a safe site to the Construction access. be installed. environment Site Where applicable a Class “B” hoarding will need to be installed. A detailed risk analysis and refinement of the associated mitigation strategies will be further progressed during the design phase. 10 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 3.2 MANAGING RISKS WITHIN AN OPERATIONAL HOSPITAL ENVIRONMENT Proposed methodology for managing risks within a live hospital environment Lendlease is aware of the challenging nature of Plans to develop clear and concise communication the Project works being located in close proximity channels for each area of interface works and to the existing Campus. The project has critical support the ongoing operation of the hospital: construction and services interfaces and non- • Stakeholder Management Plan; negotiable stakeholder requirements to ensure operational continuity is maintained. • Risk Management Plan; During the design stage Lendlease will work in • Helicopter Management Plan; a collaborative manner with PWC to develop • Disruptive Works Notification Procedure; and our stakeholder communication structure and to address all stakeholder requirements and concerns. • Environmental, Health and Safety (EH&S) Management Plan. Through this open partnership collaboration process we will develop solutions that have Our integrated Environmental, Health and Safety stakeholder buy-in and document an agreed plan Management Plan will identify all EH&S risks to manage construction delivery through to the associated with stakeholders including and not completion of the works. limited to members of the public, Campus staff, patients, and workers on site. The sub plans below The activities below have the potential to will be developed in collaboration with the relevant significantly impact on the operation of the stakeholders during the pre-construction phase: hospital, the wider Precinct and adjoining business and residences, if not managed effectively and • Traffic and Pedestrian Management Plan; communicated proactively with stakeholders: • Noise and Vibration Management Plan; • Access and traffic management; • Dust Management Plan; • Planning and management of any major • Stormwater Management Plan; shutdowns; • Waste Management Plan; • Minimising and controlling disruptions; • Incident Management Plan; • Protection of existing hospital assets; • Emergency Response Plan; • Maintenance of existing patient and staff privacy and security; • Crisis Management Plan; • Emergency after-hours call-out; • Hazardous Materials Management Plan; and • Hazardous material identification and removal; • Workplace Relations Management Plan. • Noise, dust and vibration control; and • Out of hours work. Lendlease will prepare the following Management Lendlease / August 2019 11
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 3.3 KEY RANDWICK CAMPUS • Review and revision of the Asbestos REDEVELOPMENT CONSTRUCTION Management Plan and Register, the Remedial Work Plan (RWP) and continual validation of the INTERFACE OVERVIEW material data that has been captured to date; Lendlease has reviewed the construction interfaces • Ensure the Asbestos Remediation Contractor is and have identified several requiring a detailed appropriately licensed and the chain of custody construction methodology to ensure Randwick is documented with the landfill facility to ensure Hospital business continuity is maintained at all the asbestos is appropriately and lawfully times during the construction of the below areas: disposed of; 3.3.1 Hazardous material • Review all site occupational and environmental Proposed methodology for removal of hazardous management and monitoring programmes; materials (if encountered) • Review and revision of communications and Industrial Relations strategies; and When developing a general approach to managing hazardous and unexpected finds, the starting • RAP Validation process to be implemented point for Lendlease will be the existing Report on throughout the works. Detailed Site Contamination (Douglas Partners – Of major importance in managing the removal of February 2019). hazardous materials is communicating the works Ongoing investigations will inform Lendlease’s activity to the stakeholders. executive safety team and the Remediation Action This is compounded for projects located adjacent Plan (RAP) (Douglas Partners) will be implemented public health facilities due to perceived potential throughout construction/delivery of the RCR. public health risks. To this end appropriate and The primary areas and types of hazardous responsive communication protocols will be materials likely to be encountered include but addressed in the Stakeholder Communication Plan are not limited to: which will be activated immediately upon any unexpected finds are encountered. • ACM (Asbestos Containing Material) material encountered in the demolition of the existing Lendlease has allowed additional provisions to road and in-ground services (insulation); provide transparency to stakeholders and additional assurance for the successful • Contaminated fill material within early and implementation of the methodology above during enabling works foot print; the process of removing contaminated waste. • Lead paint that may have been used on some of Remediation progress, health and environmental the residential buildings which previously existed monitoring results are components of the on the site residential buildings; and stakeholder manager’s communication updates to site workers and stakeholders. • Potential biological hazards to the sewers and drainage of the existing buildings which have housed clinical service departments presently or historically (e.g pathology). Lendlease is well equipped to co-ordinate and manage the safe removal of hazardous materials and understand how to appropriately manage risk associated with transporting hazardous materials within a live operational hospital campus and adjacent residential properties. Accordingly, Lendlease has developed a site-specific methodology for removal of hazardous waste to ensure that waste is disposed of correctly and efficiently including: 12 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 4.0 DESIGN FINALISATION AND SUBCONTRACTOR ENGAGEMENT 4.1 SUBCONTRACTOR PROCUREMENT • Delivery certainty; AND ENGAGEMENT • Subcontractor executive required involvement; Proposed methodology for the staged engagement • Infection control; of subcontractors. • Site access and delivery requirements; The technical complexity, construction challenges • Aboriginal participation and training targets: and quality requirements of the RCR project dictate • Trade specific interface and coordination issues that the selection of the appropriate subcontractors from day one; and will be critical in meeting the demands of the Project. Lendlease will ensure that there is a • Worker car parking, site access and flexibility and redundancy in the supply chain induction detail. procurement in the way in which the work activity packages are established from an overarching 4.2 INDUCTIONS scope of works and risk management perspective. The Lendlease induction will be specifically tailored Lendlease will recommend subcontractors and to inform workers of their obligations working supply chain partners that have a proven track within a live health environment for the RCR. The record on complex healthcare projects and highly content of the induction will be reviewed with HI, complex interface projects. SESLHD and PWC teams to ensure the strategies Our procurement strategy and associated program imposed by Lendlease are aligned with the is derived from lead times determined from the requirements of the Campus. overall construction program. The project induction will train new workers on 4.1.1 Subcontractor inductions and project specific safety and emergency procedures, pre-commencement meetings however, the key focus will include interface controls, including: Lendlease will hold multiple meetings and briefings with the supply chain for both consultants and • Working in a live environment: The construction subcontractors. This will aid in the selection of the methodology has been designed around most appropriate preferred tenderers to carry out maintaining business continuity for the Campus. the works. The nature of the meetings is to ensure This is key to a successful project and will be the that each contractor understands the environment underlying theme of the induction procedure for in which the construction works will be carried every worker on site; out and the responsibilities that comes with • Infection control: Content within the induction undertaking such works. will focus on the importance of infection Following award, we will carry out formal pre- control and the risk to the existing Hospital commencement meetings prior to executing from construction works. It will also focus on subcontracts. These meetings will finalise work methodologies and quality procedures to discussions on: ensure the end product delivered to the client has been constructed in accordance with the • Working within the live Randwick health documentation and without risk of infection to precinct; end users; • Working adjacent to residential and business properties; Lendlease / August 2019 13
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION • Access within Existing Hospital: We will provide 4.3 CONTRACTORS DOCUMENTS clarity regarding no access into existing Hospital Proposed methodology for managing the future areas. There will be clear ‘no-go’ zones identified design interface and build ability through the including the travel path for all emergency design process; vehicles to and from the Hospital; • Separation of Construction Works from Hospital Operations: Access to and from site 4.3.1 Approvals and design changes will be defined and out of bounds areas clarified The design will be submitted to the principal at for workers. The induction will focus on the the 80% and 100% Contractor Documentation amenities planned for within the construction milestones. A Design Change register will also site boundary which include lunch facilities with accompany any further Contractor Documentation a selection of food outlets designed to offer submissions to the Principal during the delivery choices to workers to limit their need to exit site phase. These are envisaged to occur in monthly at meal times; intervals or as required. • Disruptive Works Procedure: All workers will Any changes that constitute a deviation from be made aware of their responsibilities towards the project Brief must go through an approval understanding what constitutes disruptive works process with Lendlease and the Principal. and understand the time frames associated with Proposed changes will be submitted to the preparing to carry out any such works; and Principal prior to implementation and will • Working around Children: All workers will be identify the following: made aware of their responsibilities towards • The item; working adjacent facilities with children particularly the interface with the Sydney • Area/location; Children’s Hospital. • Reference of all documents affected by We will also focus on the unique requirements the change; of each stakeholder within the campus to • The nature of the change; ensure that the information in the induction is • The reason for the change (which includes pre- up to date and relevant to the specific work areas obtained approval by Lendlease and the Principal on site. An example of the specific requirements for all items affecting the project Brief); and and locations are: • The implications, which are to be assessed as a • Working Adjacent to the Existing Clinical minimum for impact on: spaces: All workers will be made aware of the need to ensure patient privacy within the facility. 1. Site health and safety management; No unauthorised removal of privacy screens 2. Cost and construction time; erected on scaffold to prevent direct sightline 3. Durability, functionality, aesthetics, into wards will be permitted; and maintenance; and • Working Adjacent to Local Residential and 4. Impact on other elements of the works. Business Properties: All workers will be made Lendlease will add to the register any details of aware of the need to enure positive contractor when proposals/implemented changes have been behavior at the approach and on site, including submitted to the Principal, when a response has minimising disruptions to local parking and been received and status of design documentation access. updates and/ or other implications. The key streams of documentation approval required during this phase are detailed in the below sections. 14 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 5.0 OPERATIONS AND SITE MANAGEMENT 5.1 OVERVIEW Considering the above, we carry out the following works: The RCR project will require precise site establishment, staging and operation, to ensure • Lendlease has allowed to engage an acoustic safety, appropriate security, interface management consultant during the course of the construction and productivity are achieved. Lendlease’s works to provide detailed advice and practical nominated delivery team has developed this methodologies in the form of a Construction detailed plan, which is integral to program and Noise and Vibration Management Plan in order construction methodology. to manage the potential noise issues with the adjacent sensitive receivers. Lendlease Close attention to detail and the quality of the has extensive experience in managing these finished product are paramount, particularly on issues on similar health projects and will look this multifaceted Healthcare Project. Lendlease to introduce the following measures on this believes this focus on quality must be promoted project such as: and fostered amongst the workforce on the project. This begins with an efficient site establishment –– Adopt and modify the protection strategy for strategy, and clean amenities which will set the any heritage or significant buildings located standard for a high-quality outcome. on the site; The planning and methodology assessment for • The necessary vibration monitoring and back to the project has identified a number of key stages base alarm monitoring to ensure the nominated in the general configuration of the site during accepted level stipulated by the SESLHD and construction. This section provides an overview associated buildings is not breached; of the overall approach adopted with detail • Positioning major plant away from sensitive description of these stages provided below. receiver boundaries where possible concrete pumping zones, cranage, and loading zones have 5.2 DILAPIDATION SURVEYS AND been positioned away from operational existing MONITORING facilities. Where applicable treating plant with mufflers and noise mitigating filters; Prior to commencing works Lendlease will complete an extensive dilapidation survey of • The Construction Noise and Vibration existing infrastructure covering roads, footpaths, Management Plan mentioned previously, will external and internal areas of the existing buildings detail the criteria and protocols for vibration adjacent and interfacing with the construction site. and noise protocols to the surrounding Coordinated access to internal hospital areas will properties. This report details a number of be arranged through the Principal. The resulting sensitive receivers above ground in relation report will be provided to the Principal as a pre- to vibration being: commencement record of the existing built works –– Children’s Hospital; on the precinct adjacent to the construction areas. –– Existing “Core” Facilities; and Our team also propose to inspect existing plant and equipment conditions in the initial periods of –– University of New South Wales. the ECI to determine the capacity of any plant and equipment that the new works interface with. This is critical to inform design scope and establish key opportunities and risks for consideration during interface planning. Lendlease / August 2019 15
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 5.3 SITE ESTABLISHMENT Proposed methodology for site establishment, including crane location and swing radius 5.3.1 Hours of work • Site establishment and periodic changes to suit staging of works; For the purposes of construction planning we anticipate the working hours to be the following; • Piling; • Jump steel installation; General Construction hours • Essential services, relocations and cutovers; Respite periods • Excavation; and Monday – 7:00am to 6:00pm 6:00pm to 7:00am = Friday 11 hours • Key deliveries. Saturday 8:00am to 5:00pm 5:00pm to 7:00am Lendlease will agree the process with HI, LHD, (Mon) = 38 hours TMC, TfNSW, SCO and Randwick City Council Sunday No work n/a to address the approvals and additional measures required prior to scheduling any out of hour’s Special Construction Hours required on select works. The nature of these works would typically weekends* to maintain operation of Hospital loading include erection of hoardings, works to footpaths, dock services connections and other works that interface Respite with the surrounding operational hospital. periods With the Weekend hours proposed above, Friday 6:00pm to 10:00pm 10:00pm to sufficient ‘respite periods’ are provided to the (limited to site estab- 7:00am = 9 neighbouring residents. A minimum of 9 hours is lishment activities in hours provided as respite even when a Weekend closure preparation for weekend is underway. works) Weekend closures have been indicatively Saturday 7:00am to 10:00pm 10:00pm to scheduled in accordance with the below time (general construction 7:00am = 9 activi-ties excluding hours motion chart. These weekend dates will vary. excavation, sawing of Lendlease will provide sufficient notification to the rock, jack hammers, pile stakeholders of upcoming weekend closures to drivers, vibratory roll-ers/ ensure all stakeholders are aware. Approximately compactors of the like) 29 weekend closures are anticipated between Sunday 7:00am to 10:00pm 10:00pm to November 2019 to February 2022, with 11 reserve/ (general construction 7.00am = 9 contingent weekends. activities excluding hours excavation, sawing of Throughout the duration of these works, Lendlease rock, jack hammers, pile will ensure compliance with the approved hours. drivers, vibratory rollers/ However certain construction activities on a given compactors of the like) day may require additional time to complete to *Required for a total of 29 weekends plus 11 reserve/ ensure the safety of the workers or neighbours. contingent weekends (total project duration of 130 These high risk scenarios will be identified and weekends). approval sought from the relevant Authorities. Through consultation with HI and LHD, loading In addition to regular working hours, there will be dock closures on a weekday may be sought to occasional extended periods (Weekend closures) facilitate the weekend works schedule. A Friday or when out of hours works are required. These out Monday shutdown of the loading dock will facilitate of hours works will be necessary to conduct the high risk works such as mobilisation of cranes, following activities: steelwork and other construction materials. 16 Lendlease / August 2019

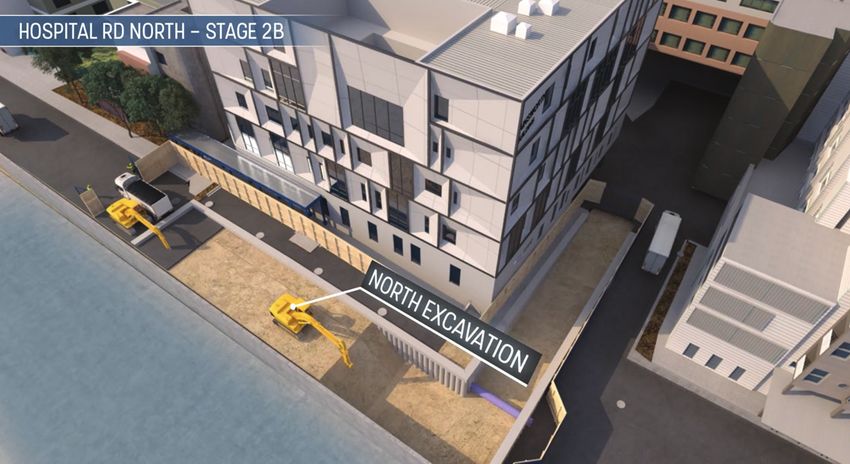

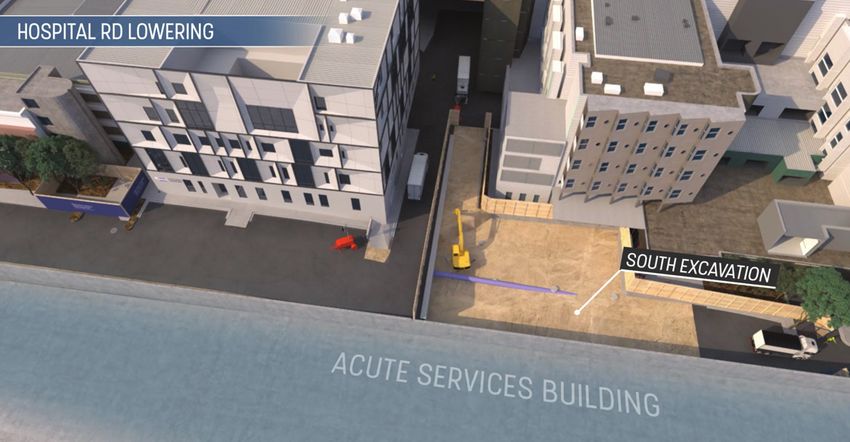

RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 5.3.2 Proposed site plan During the course of RCR the Lowering of Hospital Road and UNSW Eastern Extension, see below proposed site establishment to be completed in the following stages: • Stage 1 – Integrated ASB Addition. This plan highlights the location of the site accommodation, project office inclusive of clients office, this plan also demonstrates how the site will be accessed by delivery drivers and couriers on a day by day basis. High Str eet Gate 4 Exit Entranc e and exit Gate 1 Roadal Hospit UNSW Exit Entranc e and exit Gate 2 Street Botany Legend A-class hoarding RANDW IC Stage 1 Boundary HOSPIT K ALS CAMPU ’ Vehicle entry gate S Construction traffic Light construction traffic Gate 3 Magill Exit Street Hospital Road Lowering UNSW Eastern Extension Site accommodation and client site office Pedestrian link bridge Note: Traffic routes are to be utilised as the road network allows Hoist locations Tower crane Indicative Site Plan, Crane radius Subject to consultation Indicative Site Plan subject to consultation Figure 2 –Lowering of hospital road and UNSW Extension Lendlease / August 2019 17
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 5.3.3 Site establishment schedule 5.3.5 Site access points, construction traffic and Deliveries To meet the site possession date of January 2020, a well-planned site mobilisation strategy will be Lendlease understand that one of the keys to the finalised during the Planning Phase. successful delivery of the Integrated ASB Addition will be the flow of materials and equipment into The Lendlease delivery team will continue to and out of the construction site. We believe it finalise the construction methodology plan through is imperative that our planning considers and subcontractor procurement, on-site detailed successfully manages: investigations and validation. • The maintenance of pedestrian and traffic flows 5.3.4 Site considerations to the surrounding roads Lendlease has carefully planned and considered • The unimpeded continued use of existing the staging requirements for the Integrated ASB vehicular and pedestrian entry and exit points to Addition. These established strategies are to the Campus; and best manage logistics of the project within a live hospital campus. In doing so we have identified the • 24-hour access to the ambulance drop off following key considerations for management of area for Prince of Wales Hospital and Sydney the site: Children’s Hospital Network. • Site establishment schedule; To achieve this, an extensive Traffic and Pedestrian Management Plan will be developed giving specific • Worker transport and parking; focus to: • Pedestrian access and circulation routes; • Carpark entry and egress: Carpark operations • Site evacuation / major incident response; will be maintained at all times, including all car • Site compound and amenities; park services and emergency egress. Particular focus will be on peak flow access and egress • Temporary services; during hospital shift change overs and strategies • Site temporary services; will be employed to ensure flows are maintained; • Fencing and hoarding for site segregation; • Supplementary offsite parking: LendLease have identified supplementary parking for hospital • Site access points, construction traffic and staff, visitors, contractors, and consultants deliveries; which could potentially alleviate current • Materials storage and handling; parking pressures over the 3 year life of the • Working adjacent to residential and business redevelopment. Lendlease will continue to work properties; with HI, SESLHD and Randwick City Council to explore and realise any supplementary offsite • Site management controls; parking opportunities during the ECI stage. • Business continuity of Randwick Health Campus, (Please Refer to Section 8 Traffic Management); Sydney Children’s Hospital, and the University of • Disabled pedestrian access and paths of travel: New South Wales, Royal Hospital for Women; Throughout all activities, disabled pedestrian • Risk management; access will be maintained with details of alternate routes and distances of paths of travel; • Construction methodology; and • All swept paths to be updated through the • Project completion. design phase with our coordination with the TfNSW; • Lendlease will consult with all suppliers to ensure the correct size and weight vehicles are allocated to the project and are cognisant of carriage weight constraints; • Ambulance entry: No works or vehicle 18 Lendlease / August 2019

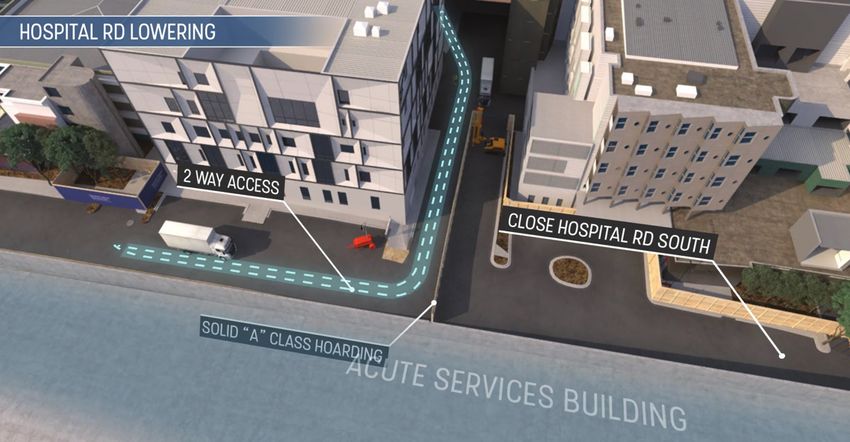

RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION movements will be allowed to affect the access 5.3.7 Site security and gates of ambulance entry and parking area; and The site perimeter will be secure at all times with • Construction Vehicles: Mitigating impact to the no unauthorised access permitted. As detailed Hospital precinct and surrounding roads will above the perimeter of the site will be secure with be considered along with a detailed analysis full height plywood A Class hoardings. of delivery frequency in conjunction with the Out of hours security patrols will be utilised during program and access routes to the site from the shutdown periods, Christmas and Easter will the various approaches. Procedures for timely also be monitored by external security services. delivery notification will be developed (e.g. call prior to arrival and also advise on aborted CCTV with active motion sensors will be used to deliveries). track any unauthorised access to site, worker and materials hoists or site accommodation. 5.3.6 Fencing and hoarding for site segregation and safety Construction worker access to the site will be strictly controlled through our secured gate system. Lendlease understand the critical importance of Individuals will require a personalised identity maintaining a secure and safe perimeter hoarding swipe card to gain access to site. This also creates line to protect the public and staff from construction a live record of who is on site at any given time activities and prevent unauthorised access into the in order to provide check list if the site is ever construction site 24 hours a day. Segregation of the evacuated in case of emergency. site accommodation compound from the main site is equally important for worker safety. 5.3.8 Site compound and amenities Site security is paramount for public safety and we Lendlease places emphasis on the quality and will implement security turnstiles on the entry to amenity of the project and accommodation the site to prevent unauthorised access. Vehicle facilities. Quality facilities set a standard and a management will be managed by Traffic Controllers level of expectation that we expect our staff and and security guards will be utilised out of working subcontractors to take with them to the workface hours during the later stages of the works. on site. Any “A Class” plywood hoarding and any sections Accommodation and amenities for the of permanent chain wire fencing will be covered construction workforce will be provided in with RCR shadecloth and will be updated and demountable site sheds adjacent to the ASB maintained throughout the project in line with the construction. project requirements. These site sheds will be erected, relocated and disestablished throughout the redevelopment to cater for fluctuating workforce demand and moving work areas. All site accommodation will be joined by covered walkways to ensure the workforce and office staff can move around the area and stay dry from any inclement weather. Lendlease / August 2019 19

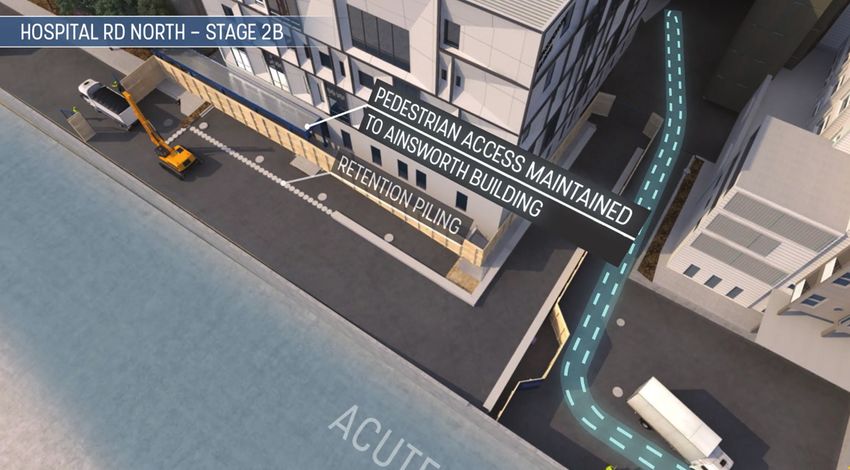

RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 5.3.9 Pedestrian access and circulation routes Lendlease will continue to work with the above authorities and contractors to ensure constant and Lendlease have identified that the existing hospital open communication whilst to initial demolition access is to be maintained throughout each and site remediation works along High Street civil construction stage of the RCR. See Figure 6 for and over infrastructure works are undertaken. proposed pedestrian and vehicular circulation routes. Key considerations for traffic and material movements Lendlease note that all boundaries are still accessible by pedestrians, and a local diversion that • The light rail project (CSELR) is now is the will be in place exists at the eastern end of Magill testing and commissioning phase. Lendlease Street which will direct pedestrians across the road are working pro-actively with the light rail to ensure their safety and welfare at all times. contractor and will continue to have co- ordination meeting to ensure all works are Interface with Light Rail along High Street timely managed and co-ordinated. Lendlease understand through consultation with TfNSW (Transport for New South Wales), TMC (Transport Management Centre) and the light rail contractor the sensitivities around the High Street interchange. Lendlease propose to utilise the following traffic flow to enter the construction site Clara Street then turn right onto High Street then left into Eurimbla Avenue access path for the first 8 weeks to ensure a safe and successful site establishment and demolition sequence. In this period Lendlease will ensure that correctly sized vehicles are mobilised to site to ensure no disruption to essential light rail operations. Figure 3 – Finished state of The Light Rail Infrastructure Along High Street 20 Lendlease / August 2019
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION 5.3.10 Construction worker support 5.3.12 Waste management Lendlease see that the health and wellbeing of our Lendlease will ensure our supply chain is construction workers is paramount and provide responsible and accountable for maintaining a our construction workforce on site with a more clean, clear and safe working environment. Rubbish comfortable environment, and support healthier bins will be provided to all work areas and will be minds in the workplace. Initiatives Lendlease regularly removed to the central skip bin location provide onsite include: by the subcontractors for collection and transport from site to the waste recycle facility. • Quit smoking support; Bins will be moved via the person and materials • Bupa Healthy Options; hoists or by the crane, dependant on the where • Healthy living courses; and they are being loaded from and the waste material • Mates in Construction (MIC) – mental that is being removed from site. Crane lifted steel health support. bins will be used to service the top floors where structure trades are working, and large Otto bins 5.3.11 Temporary services will service the lower levels where fitout and service trades are working. Lendlease have developed a series of preliminary Temporary Services Plans for each Stage of the Redevelopment. These plans will be further developed following detailed site investigations. Figure 4 Lendlease / August 2019 21
RANDWICK CAMPUS REDEVELOPMENT INTEGRATED ASB ADDITION The site skips will be centrally located at Ground 5.4 CRANES AND MATERIALS HANDLING Level to ensure an easier pick up from our bin Proposed methodology for cranage and establishing contractor. a Helicopter Management Plan. Waste will be separated at the approved waste management centre. Auditable records will be kept of quantities of all materials both recycled 5.4.1 Crane selection and materials handling and disposed landfill. Records will be monitored During the course of the works scope the existing to ensure Lendlease internal recycling targets are tower cranes will be used. achieved or exceeded. This information will be collected and reported in compliance with our The specific layout of the tower cranes have been Environmental Management Plan and its Waste specifically adjusted to suit the new construction Management and Recycling Sub-Plan over the of the lowering of hospital road and the UNSW duration of the project. A sample summary is Eastern Extension (Base Building only) this is to graphically and statistically referenced on the allow the critical path trades a tower crane that can following pages. effectively service the new site area. To ensure the RCR project meets its sustainability The current tower cranes will be compliant with targets, waste management reports will show all CASA and SACL requirements and Lendlease monthly and cumulative performance. will ensure that our aviation consultant reviews and checks the proposed locations to ensure 5.3.13 Temporary works compliance at all levels. At various stages of the construction life cycle protection decks, proprietary B - Class Hoardings 5.5 ENVIRONMENTAL PROTECTION or bespoke engineered items and other temporary Proposed methodology for environment protection, works such as shoring, retaining walls etc will be including noise, dust, vibration & visual. required. These items will be carefully planned and scrutinised. Lendlease experience shows such temporary works are usually associated with high The site area will require careful management of risk activities and will need to be fully engineered, site run-off. Perimeter protections installed during certified and Environmental Health and Safety the works will be reviewed on site during the (EH&S) compliant. Planning Phase period. Lendlease will carry out daily site inspections and ad hoc inspections in The temporary works that will be required to be response to changes in environmental conditions. undertaken during the course of the early and These inspections will focus on protective enabling works include: measures for all site boundaries, access roads and 1. Establishing temporary construction zones and stormwater pits. localised traffic diversions. These daily inspections will enable any issues to be identified and corrected immediately, resulting in no impact on the environment, local community and public ways. 22 Lendlease / August 2019
