Papua New Guinea: Port Moresby Power Grid Development Project.
Social Monitoring Report

Semi-annual Report

July 2021

    Papua New Guinea: Port Moresby Power
          Grid Development Project.

Prepared by PNG Power Limited for the Asian Development Bank.

This social monitoring report is a document of the Borrower. The views expressed herein do not
necessarily represent those of ADB Board of Directors, Management, or staff, and may be
preliminary in nature.

In preparing any country program or strategy, financing any project, or by making any designation
of or reference to a particular territory or geographic area in this document, the Asian
Development Bank does not intend to make any judgments as to the legal or other status of any
territory or area.
Loan Number:            L2998/2999
Project Number:         43197-013
Report:                 Semi-annual

                            Social Monitoring Report
                            (Reporting Period: July – December 2020)

          PAPUA NEW GUINEA: PORT MORESBY
          POWER GRID DEVELOPMENT PROJECT

                  Prepared by PNG Power Limited for Asian Development Bank

                                Submission date: 02 July 2021
Table of Contents

Contents                                                                                                                 page no.
 Table of Contents.................................................................................................................... 3
 ABBREVIATIONS ................................................................................................................... 4
 1.0 INTRODUCTION............................................................................................................... 5
 2.0 BACKGOUND OVERVIEW ............................................................................................... 5
 3.0 MONITORING PURPOSE ................................................................................................ 6
 4.0 MONITORING ACTIVITIES .............................................................................................. 6
 5.0 POM GRID SUB-PROJECT STATUS ............................................................................... 7
 6.0 SP1 Activities, Issues, & Updates ..................................................................................... 8
 6.1 Site Visits/Inspections ....................................................................................................... 8
 6.2 Land Issues....................................................................................................................... 8
 7.0 SP4B Activities, Issues, & Updates ................................................................................... 8
 7.1 Consultations .................................................................................................................... 8
 7.2 Connectivity Update .......................................................................................................... 9
 Table 2: SP4B Energy Access Connectivity Update-December 2020 ..................................... 9
 8.0 SP 5/6 Activities, Issues & Updates .................................................................................. 9
 8.1 Stakeholder Consultation and Awareness ......................................................................... 9
 8.2 Rouna and Sirinumu Land Issues Identified. ................................................................... 10
 Table 3: SP 5/6 Rouna & Sirinumu HPP Refurbishment Status ............................................ 10
 9.0 GRIEVANCE REDRESS ................................................................................................. 10
 10.0 CONCLUSION .............................................................................................................. 11
 11.0 RECOMMENDED ACTION PLAN ................................................................................. 11
 12.0 APPENDIX .................................................................................................................... 12
 The following documents can be provided by PPL ................................................................ 12
 12.1       Copy of Kilakila Substation Land Title ....................................................................... 12
 12.2       Copy of Letter from Morata Hari regarding Trespassing on Dogura Land .................. 12
ABBREVIATIONS

ADB     Asian Development Bank
AP      Affected People
CBD     Central Business District
CEMP    Construction Environmental Management Plan
CEPA    Conservation and Environment Protection Authority
DEC     Dongfang Electric International Corporation
DLPP    Department of Lands and Physical Planning
DRS     Deed of Release and Sale
EMP     Environmental Management Plan
GoPNG   Government of PNG
GRM     Grievance Redress Mechanism
HSE     Health, Safety & Environment
HVL     High Voltage Line
ILG     Incorporated Land Group
IPBC    Independent Public Business Corporation
KCH     Kumul Consolidated Holdings
kV      Kilovolt
LAA     Land Access Agreement
LAF     Land Agreement Form
LG      Lease Grant
LVL     Low Voltage Line
MOA     Memorandum of Agreement
MP      Member of Parliament
NCD     National Capital District
PGK     Papua New Guinea Kina (Currency)
PMU     Project Management Unit
PNG     Papua New Guinea
PPGDP   Port Moresby Power Grid Development Project
PPL     PNG Power Limited
ROW     Right of Way
SP      Sub-project
TL      Transmission Line
TLI     Transfer of Land Instruments
TT      Transmission Tower
VILG    VAGA Incorporated Land Group
1.0 INTRODUCTION

The Asian Development Bank (ADB) is supporting Papua New Guinea (PNG) to develop and
expand its energy sector in the Port Moresby Power Grid Development Project (PPGDP)
through a sovereign loan fund. The designated implementation agency is PNG Power Ltd (PPL), a
fully integrated power authority responsible for the generation, transmission, distribution and
retailing of electricity throughout PNG. The project will upgrade and extend the transmission
and distribution grid, improve substation capacity, as well as upgrade and rehabilitate two
existing hydropower plants. It is aimed at reducing fossil fuel consumption, while increasing the
access to energy and improving network reliability in the grid.

2.0 BACKGOUND OVERVIEW

The Port Moresby Power Grid Development Project is funded by ADB loan 2998/2999-PNG1.
The Project Agreement was signed between ADB, the Independent Public Business
Corporation (IPBC)2, and PPL on the 28th of May 2013. The ADB loan and counterpart funding
provided by the Government of PNG (GoPNG) is managed by PPL through its Project
Management Unit (PMU) and supported by the ADB PNG Resident Mission (PNRM). The PMU
is supported by technical assistance from an international consultancy firm namely Fichtner
GmbH Limited Consultant. The Project is aimed to achieve significant improvements in power
generation, supply, efficiency, and reliability.

The Project is subdivided into six subprojects that entail significant investments into power,
transmission, distribution, and generation. It proposes the construction of new facilities and the
rehabilitation of existing facilities serving the Port Moresby Grid. The ADB safeguards
categorization for this project is Category B for the environmental and social component as per
the Safeguards Policy Statement 2009 (SPS, 2009). The Involuntary Resettlement (IR) for this
project is Category B because of the potential resettlement impacts in Kilakila Substations and
Transmission Line (TL) where land acquisition is required. The TL will have a minor impact on
small area of land to be cleared for mounting of poles and the lines will run overhead with no
impact to flora and fauna. The project components are;

          I.   Subproject 1 (SP1) Kilakila Substation and 66kV Transmission Line.
         II.   Subproject 2 (SP2) Substation Capacitor Addition.
        III.   Subproject 3 (SP3) Upgrade of 11kV System to Open Loop Mesh.
        IV.    Subproject 4 (SP4A) Loss Reduction Program; (SP4B) Energy Access.
         V.    Subproject 5 (SP5) Rouna 1 Hydropower Plant Rehabilitation & Upgrade.

 1
     ADB Loan L2998/2999: Port Moresby Power Grid Development Project
 2
     IPBC is now known as Kumul Consolidated Holdings (KCH).
VI.   Subproject 6 (SP6) Sirinumu Hydropower Plant Upgrade.

 Subprojects (i) to (iv) will take place in and around the Port Moresby area in the National
 Capital District (NCD). Subprojects (v) and (vi) are respectively located about 20km and 35km
 north east of Port Moresby along the Laloki River valley.

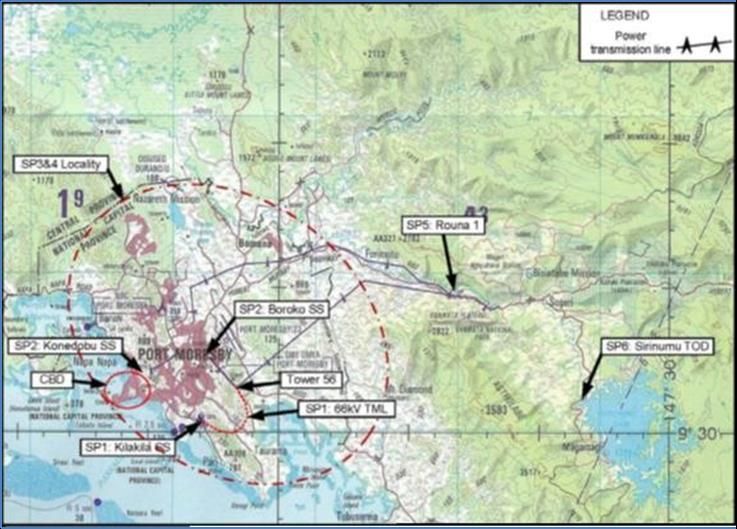

Figure 1: POM Power GRID Development Site Plan

3.0 MONITORING PURPOSE
Safeguards Monitoring is to ensures that the PPGDP subprojects are compliant to meet ADB’s
SPS (2009) requirements and GoPNG regulations on social and environmental sustainability
and protection. The monitoring is done monthly, and the reports are submitted semi-annually to
ADB as a requirement for disclosure purposes. This monitoring of project development activities
was carried and conducted during the months from July to December 2020.

4.0 MONITORING ACTIVITIES
The social monitoring activities are carried out by the PMU Safeguard officer to monitor the
implementation of the approved Resettlement Plan. This includes updating the stakeholder
consultation and awareness activities, grievance redress mechanism (GRM), compensation as
well as, social benefits encountered by the project during the reporting period.
The Kila-Kila Sub-project during construction had all monitoring activities carried out on a
weekly basis. Follow ups were done with the stakeholders (if necessary) in relation to issues
affecting the project. The social safeguards issues arising from the sub projects are dealt with
through the PMU-PPL.

Routing inspections are done on a monthly basis along the Transmission Towers for SP1, to
confirm that no new developments are occurring along this line

Consultations with the Rouna and Sirinimu Landowners for SP5/6. The Rouna and Sirinimu
rehabilitation project were schedule to be carried out within the first (1st) and second (2nd)
Quarter of 2020 but could not eventuate due to the current global COVID 19 pandemic issues
and restrictions of movements within the area.

Despite of that, site inspections and monitoring were done on the following areas,

     1) Nearby and Surrounding Communities / settlements
     2) Transmission Tower Routes
     3) Substation Site at Kilakila
     4) Access Routes to Transmission Tower sites

5.0 POM GRID SUB-PROJECT STATUS

See table below for overall project updates:
                         Table 1: PPGDP Subproject Status Update

       PPGDP Subproject                 Date                 Status               Complete %
           Kilakila Substation &                    Civil Works                 99 %
 1         66kV Transmission          29/04/21      Electrical                  100 %
                    Line                            OHL                         70 %
          Substation Capacitor
 2                                      Has moved to the Loss Reduction Team within PPL.
               Addition
            Upgrade of 11kV                         Contract signed with PESTECH YOUNGFU
                                      03/02/20      joint venture (PYJ) on 30 Dec 2019
 3        System to Open Loop
                 Mesh                 05/10/20      Kick-off Meeting
            A) Loss Reduction
                                        Has moved to the Loss Reduction Team within PPL
                Program;
 4                                                  Undergoing connection     100%
            B) Energy Access          29/04/21      Pending energising        11%
                                                    Energized                 89%
                                                    DEC submitted rev 02 of their CEMPs for
                Rouna 1&              26/10/20
                                                    review
 5&6      Sirinumu Hydropower
              Plant Upgrade           31/12/20      Mobilisation in the process of completion
6.0 SP1 Activities, Issues, & Updates

The main activities covered, and land issues dealt with are in the construction of the Kilakila
Substation & Transmission Line during the reporting period are as follows:

       6.1 Site Visits/Inspections
 Site visits at the substation site have ceased due to the completion of TL project. Inspections
 along the TL route continue on a need basis and follow-ups site inspections.

       6.2 Land Issues

The land title certificate for the Kilakila Substation was received from Lands Titles Commission
of DLPP on 21 September 2020, after a lengthy process of customary land acquisition. This land
is now legally owned by PPL.

The long-awaited decision from the district courts for disputed tower locations T3 & T4 was
handed down on 29 December 2020. The granting of the Orders by his Honor Justice Canning’s
in favor of the PPL application to Set-Aside the Interim Injunction/Restraining Order restraining
PPL entering the specific sites where T3 & T4 towers are located. The Judge also refused an
attempt of a Stay Application by the Plaintiff (complainant) after considering PPL’s submission
as well as the Plaintiff. The Order made by his Honor Justice Canning’s are as follows:

The Stay Application by the Plaintiff is Refused Application to Set-Aside the Interim Injunction by
the Defendant (PPL) is Granted. (The Defendant is free to enter site to continue progress effective
4January-2021 after 12-Noon). The substantive matter has been heard at 1:30 pm on 4Feb-2021.

A grievance letter was delivered on 3 September 2020 by one of the landowner groups,
trespassing on customary land where T2 and T1 is going to be located. This land is at the Six
Mile-Taurama (junction) roundabout and it has already been compensated by PPL. The letter
was received by the PMU and given to PPL Legal team to respond. PPL responded that this is
an in-house issue between members of the Uhadi and Iarogaha Incorporated Land Group (ILG).
PPL is not a party to this dispute, so it should not stop the PPL from continuing with the tower
erections.

7.0 SP4B Activities, Issues, & Updates

       7.1 Consultations
Regular consultations could not be carried out during the second quarter due to COVID 19
restrictions, however any issues of major concerns and needed the stakeholder concerns were
brought to their attention.

       7.2 Connectivity Update

 Due to COVID 19 restrictions the progress of the installations to most of the rural households
 has been slow during the reporting period. However, all the low voltage line connections and
 meter installations are 100% complete, while 39% is still to be energized. Summarized in table
 below.

 Table 2: SP4B Energy Access Connectivity Update-December 2020

                                                  Completed       Completed
                                        Total                                     Energized
   Contractor           Villages                        MSK       Service Line
                                      Customers                                  Installations
                                                  Installations    Stringing
                      Pari               211      211     100%    211    100%     64     31%
      AN2E            Kerekadi           20        20     100%     20    100%     20     100%
  Contractor Ltd      Dinalata           20        20     100%     20    100%     20     100%
                      Gereka             98        98     100%     98    100%     98     100%
  Papua Power         Papa village       63       166     100%    166    100%     63     100%
        Ltd           Boera village      109      109     100%     69    63%       0      0%
     Photons          Kilakila
                                         96        96     100%     96    100%     124    100%
  Engineering &       village
   Construction       Gereka
                                         40        40     100%     0      0%       0      0%
        Ltd           village
  Project Team
                                         34        34     100%     34    100%     34     100%
     Installed
              Total                      691      691     100%    691    100%     424    61%

8.0 SP 5/6 Activities, Issues & Updates

       8.1 Stakeholder Consultation and Awareness
 The proposed program for community awareness was put on hold by the management hence
 as well as with Covid restrictions. This awareness is purposely aimed at the affected
 communities within the Rouna and Sirinimu villages. There were other issues that arose due
 to internal disputes between landowner factions. This has also delayed the schedule of
 awareness programs.
8.2 Rouna and Sirinumu Land Issues Identified.

Legacy issues will always be an ongoing matter between the Management of PPL, Eda Ranu,
Government of PNG, and the traditional landowners of Rouna and Sirinumu Dam in Sogeri,
Central Province. The issue is to do with outstanding Royalty Payments owed by the State to the
traditional landowners of Rouna and Sirinimu hydro power stations. Only when the landowners
are satisfied with the assistance provided to them then this issue can be put to rest. In the
meantime, the project has engaged six males from the landowner groups to work on the sub-
project hence ease the tensions and work has progressed.

 Table 3: SP 5/6 Rouna & Sirinumu HPP Refurbishment Status

          Activity              Date                              Status

  Contract                                  Contract awarded to Dongfang Electric
                            19 April 2019
  Awarding                                  International Corporation (DEC)

  Project                                   In-house disputes between different
  Awareness &                3rd Quarter    landowner factions, coupled with Covid
  Consultation (ILG              2021       restrictions delayed this from eventuating.
  Meeting)                                  Will plan for third quarter 2021.

  Mobilization               7 July 2020    Final 20% was received

9.0 GRIEVANCE REDRESS

 The Grievance Redress Mechanism (GRM) is the same for both the environmental social
 safeguards and PMU is the focal for coordination with legal team and or responding to affected
 people following GRM. The GRM process can be seen in figure 2. All grievance and issues
 arising from the sub-projects are made known to the PMU or the Contractor. Landowners
 including the ILG executives are consulted when there is a matter regarding the land then
 followed by recording of grievance and redressed through GRM.

 The grievances received during this reporting period have been outlined above and are all
 following the GRM process for redressing those grievances.
Figure 2: GRM Process Flow Chart

10.0 CONCLUSION

 In this monitoring period there were delays in carrying out of Social Safeguard programs.
 Especially the awareness activity presentations that were supposed to take place at sub-
 projects (SP) five (5) and six (6). These difficulties were due to COVID19 restrictions on
 communal gatherings and internal landowner differences. SP1 the land issues for T3 and T4
 were sorted by the courts at the end of December 2020. The land disputes for T1 and T2 were
 regarded as internal infighting between clan members of Uhadi-Iarogaha ILG therefore the
 risk of stop work is minimal or less likely.

11.0 RECOMMENDED ACTION PLAN

 Table 4: Action Plan

                                    Action to be                     When (Completion
   No        Items (issue)                           By Whom
                                    undertaken                              date)

          SP1 T1 and T2          PPL Legal         PPL Legal
   1.0                                                               Seeking Restraining
            land Issue            Service            team                  Order
SP 5/6 Project                          P. Omaro
   2.0                          Organising                         Pending
          Awareness
                                                 /L. Naris

         SP 5/6 Financial
   3.0                          Organising       P. Omaro          Pending
         Literacy Training

12.0 APPENDIX

The following documents can be provided by PPL

 12.1 Copy of Kilakila Substation Land Title
 12.2 Copy of Letter from Morata Hari regarding Trespassing on Dogura Land
You can also read
