Technical Note Contingency Evaluation Fund (CEF)
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Decentralized evaluation for evidence-based decision making WFP Office of Evaluation Decentralized Evaluation Quality Assurance System (DEQAS) Technical Note Contingency Evaluation Fund (CEF) Background 1. Under the Evaluation Policy (2016-2021), WFP commits to assigning 0.8 percent of its total contributions income annually to addressing the needs of its entire evaluation function by 2021 at the latest1. 2. The Corporate Evaluation Strategy (2016-2021) set out a triple funding model for the evaluation function on the road to sustainable financing arrangements. This triple funding model, endorsed by the Assistant Executive Director - Resource Management Department and the full Executive Management Group in April 2016, includes: i. PSA for Centralized Evaluations (CEs), the augmented role of the Office of Evaluation (OEV) setting standards, oversight and guidance for the entire function; and the six Regional Evaluation Officers; ii. Project sources (Direct Support Cost (DCS), Trust Funds and, in future under the Financial Framework Review (FFR), ‘implementation costs’) for the conduct and management of project-related Decentralized Evaluations (DE)2; iii. Multilateral funding for OEV-managed services to support the DE function. 3. The Corporate Evaluation Strategy also announces the creation of a Contingency Evaluation Fund (CEF) with two components and WFP’s Management Plan 2017-2019 includes a 2017 allocation of US$ 2 million for the CEF. The CEF components are: i. Support to planned and budgeted DEs where Country Offices (CO) face genuine resource constraints at the time the evaluation is needed (US$ 1.5 million replenishable from PSA); and ii. Part of OEV-managed services to support decentralized evaluations, such as capacity development for DE and an outsourced quality support mechanism (US$ 500,000 annual; multilateral funds). 4. This Technical Note describes the process for operation of Item 3 (i). Contingency Evaluation Fund Purpose and Nature 5. Purpose: to enable the conduct of decentralized evaluations in under-funded situations and to enable Regional Directors (RDs) to effectively support COs in their evaluation planning and budgeting. 1 See para 43 of the Evaluation Policy. In 2015, the actual expenditure was 0.19% of total contributions income, but this included only the centralized evaluation function. Figures for decentralized evaluation were not available. 2 Project sources (and ‘Implementation Costs’) will also contribute to the costs of project-related centralized evaluations, such as of corporate emergency responses. Under the Country Strategic Plan (CSP) Policy (approved by the Executive Board, Nov.2016) and the Financial Framework Review, ‘portfolio budgets’ will also include provision for OEV-managed Country Portfolio Evaluations (CPE), to be conducted towards the end of the life of the CSP – usually Year 4. 1
6. Size and Nature: US$ 1.5 million. Disbursements will be in the form of grants to eligible applications, approved by the Evaluation Function Steering Group (EFSG)3. When 80% of the initial allocation has been disbursed, the EFSG will request the Strategic Resources Allocation Committee (SRAC) for replenishment on the basis of evidence of use for conduct of DEs. Criteria 7. A key feature of the CEF is that it supports and reinforces desired behaviour change. It is incentive-based. Under the Evaluation Policy, evaluation must be planned and budgeted adequately in project documents at the time of project design. The CEF will only be available for those DEs which complied with this. It will not be used to fill gaps due to planning and/or budget omissions. 8. The criteria shown below are designed to support that intent and to be straightforward, transparent and unambiguous, so that requests can be approved rapidly by the EFSG. They have been developed in consultation with key stakeholders, building on relevant experience from the Operations Evaluation Series and DEs planned to date. A) Eligibility criteria: i. Planning/ budgeting: The DE was actually planned and budgeted in the project document and/or in the Country Office’s Annual Performance Plan (APP) (and, in future, Country Strategic Plans and CO Management Plan - COMP)4. ii. Evaluability: Though under-funded, the operation/activity to be evaluated has been implemented to an extent that makes evaluation possible. The threshold will vary from case to case, but would normally be around 30% (of project value). iii. Utility: The DE is timed in such a way to ensure that the evidence generated feeds into management decisions on future programmes or policies. B) Criteria for assessing priorities and size of grant: i. Reasonable cost: the DE budget should be ‘reasonable’ given the scope, purpose and proposed team for the DE concerned. Costs will vary according to the scope, methodology and contracting mode, but an average cost of US$130,000 will be used as an indicative starting point for estimation of reasonableness for a typical DE; US$250,000 for Impact Evaluations5. ii. Relevant to decision making: the DE should be of a scope, purpose and nature appropriate to feed evidence into programming decisions and in line with DE types listed in the Evaluation Policy. iii. Size of the COs (as defined in WFP Management Plan – see Annex II)6: large and very large COs are expected to have fewer genuine resource constraints than other COs. Small and very small COs are expected to have the greatest and most frequent resource constraints. Therefore, an allocation from the CEF is likely to be larger and more frequently given in favour of small or very small COs. 3 See EFSG membership in Annex III. 4 Since Trust Fund projects are typically funded up front, the budget for evaluation should be available, provided it was included in the project design. Therefore, very few Trust Funded projects are expected to face genuine resource constraints and be eligible for CEF. 5 This is based on the historical experience of the series of 65 Operations Evaluations (2013-2016) and of DEs planned in 2016 under the Evaluation Policy - in the absence of reliable figures on the WFP’s decentralized evaluations prior to 2016. 6 This criterion draws on learning from the series of centralized Operations Evaluations, now concluding. 2
iv. Need and affordability: DE budget as a proportion of the actual resource-based DSC available to the CO for the year in question. This will be based on information of the resource-based budget funded, programmed and spent. v. Promoting fulfilment of evaluation coverage norms: higher priority is given to Country Offices where the last evaluation was more than 3 years before the request. vi. The CO is required to contribute at least 30% to the costs. Anticipated Demand 9. As at November 2016, globally, 2 DEs have been completed under the new Evaluation Policy, 20 are on-going (to be completed during 2017) and 16 more are planned to start in 2017. Two have already informed OEV that they will rely on CEF funding to proceed. 10. Since the CO is required to contribute at least 30% to the costs, using the guide prices (above) of US$130,000 for ‘regular’ DE and US$250,000 for decentralized impact evaluation, the maximum application per evaluation to the CEF will be US$91,000 (‘regular’ DE) or US$175,000 (impact DE). Thus, with maximum funding approval for each application, the CEF would be able to support 8 impact DEs or 16 ‘regular’ DEs, before replenishment is required. Of DE’s currently planned for 2017, about 40% are impact evaluations. Fund Management and Process 11. The EFSG is responsible for the management and decisions on allocation of this component of the CEF on the basis of applications received from RDs7. 12. Allocation decisions will be made by the EFSG, taking into account the advice from review of applications by each applicant’s Regional Bureau (RB), and then OEV and Budget and Programming Division (RMB) against the criteria above. In addition, Project Budget and Programming Service (RMBP) will provide to each CEF decision making meeting of the EFSG a global overview of the status of DSC funding available in resource-based budgets so that the degree of need is transparent. 13. Annex I shows a summary flow-chart of the CEF process from submission of application through to disbursement. Annex II includes the CEF Application Form and Annex III the proposed Assessment Form to be used for reviewing applications. Table 1 (below) summarizes the key actors and their roles. Table 1. Summary of Fund Management Roles EFSG Fund management & allocation decisions OEV Secretariat to EFSG and the CEF; assessment of applications RB REO with RD approval Screening and submission of applications to the CEF Secretariat Project Budget and Provision of data on eligibility, prioritization and grant size Programming Service (RMBP) Role in assessment of applications Disbursement Organizational Budgeting Service (RMBB) Fund establishment and replenishment 7 Corporate Evaluation Strategy 2016-2021 (para 94). 3
14. Frequency of disbursement decisions: This will depend on actual demand, but is recommended to be once every 2 months. This will enable timely start and completion of DE’s which are dependent on CEF support in order to ensure that the evidence generated can feed into relevant decisions on future programmes (utility). 15. All complete and eligible applications ready for EFSG consideration will be uploaded to the Teamwork Space (TWS) EFSG Library on the CEF by OEV after clearance by the Director of Evaluation. The corresponding assessment and record of approvals will also be kept in that Library. 16. Monitoring and Reporting on use of the CEF: will be coordinated by OEV as the CEF Secretariat, based on data from WINGS, extracted and collated by RMBP. Monitoring data will be incorporated in the dashboard of Key Performance Indicators (KPIs) on evaluation function reporting, for use by the EFSG. Annual reporting on the first CEF allocation will include reflection on the additional rations enabled by this allocation from the Programme Support and Administration (PSA)8. Progress review 17. The criteria, process and template forms may be adjusted after the first round of CEF allocations, as necessary to ensure smooth functioning of the CEF. The CEF will be included in the ‘proof of concept’ review of the DE system scheduled for Quarter 3 2017. 8 Required by RMBB because funded from the additional USD 35 million for centralized services supporting COs as per Table IV.1: Main areas of increase in the PSA Budget of the Management Plan approved at EB.2/2017. 4

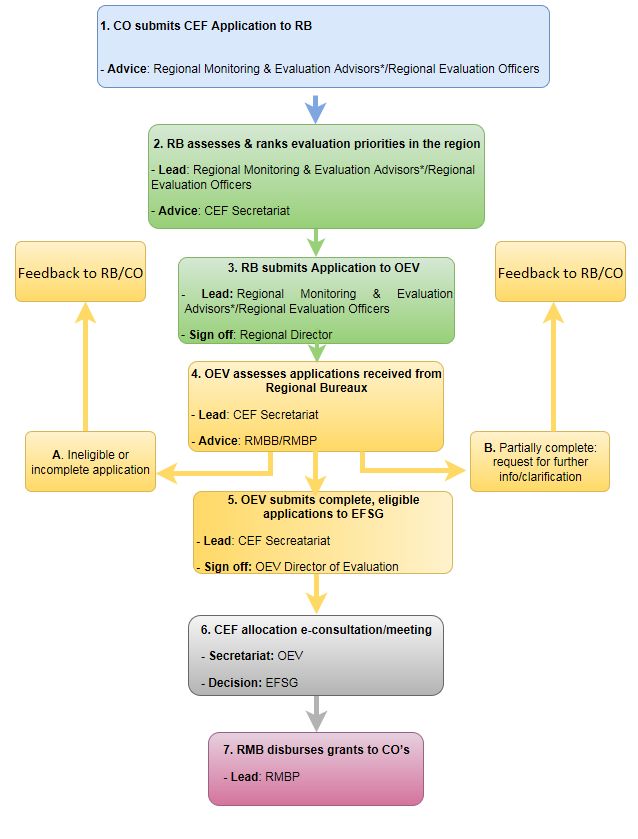

Annex I: Contingency Evaluation Fund Process *The Regional Monitoring and Evaluation Advisors will provide support until the Regional Evaluation Officers are on board and operational at the beginning of 2017. 5
Annex II: CEF Application Form CONTINGENCY EVALUATION FUND (CEF) Application N. [Insert RB, APPLICATION FORM Year/Progressive application No] RBX/YEAR/0X To be filled in by RB Submission Date 1. GENERAL INFO ON THE APPLICANT [To be filled in by CO] RB ☐RBB ☐RBC ☐ RBD ☐ RBJ ☐ RBD ☐ RBN RB Contact Person Name: Functional Role: CO CO Contact Person Evaluation Committee Chair Name: Functional Role: CEF Contact Point Name: Functional Role: Time period within the evaluation Evaluation Title scope (Please attach TORs) Joint ☐ Regional ☐ if so, specify which partners: if so, specify which countries: Planned start date9: Planned completion date10: Expected Evaluation duration Latest possible completion Latest possible date11: date12: Project/Activity Type of Evaluation Project/Activity No Title ☐Operation(s) ☐Impact Type of Evaluation, Project/Activity Title and No if ☐Activity relevant ☐Pilot ☐Theme ☐Transfer modality ☐Other Expected duration of intervention Starting date: Completion date: to be evaluated Total budget of intervention to be evaluated US$ Implementation of intervention to be evaluated (US$ funded value % versus total intervention cost) 9 An evaluation starts when Inception Mission commences. 10 Completion occurs when the final evaluation report is approved. 11 In terms of timeliness and utility to feed into the decision making process. 12 In terms of timeliness and utility to feed into the decision making process. 6
US$: Total planned budget for evaluation in original plan (CO work plan: % of DSC: original Project Budget, CP Budget, COMs, APP) (Please attach evidence of plan & budget for the under-funded DE) % of total operation costs: % of total activity costs: Total evaluation cost funded by CO US$: Source: Total requested from CEF US$: % of total evaluation cost: 2. DETAILED INFORMATION ON THE DECENTRALIZED EVALUATION [To be filled in by CO] 2.1 Indicate the planned date and Explain the nature of key programming decisions into which the DE is supposed to feed evidence Key programming Nature Planned date decision ☐Design of new interventions ☐Revision of current interventions ☐Implementation of current interventions ☐Closure of current interventions ☐Scale-up of pilot / innovation / prototype ☐High-risk interventions13 ☐Before third repeat of an intervention of similar type and scope ☐Other (please specify) 2.2 Explain the reasons for the shortfalls in CO funding compared to planned budget for evaluation in original plan 2.3 Indicate the year of last evaluation of the activity concerned and specify whether the evaluation was DE or CE Year Title of evaluation CE/DE 13 Based on corporate enterprise risk management. 7
3. ADDITIONAL INFORMATION [To be filled in by CO] 3.1 Indicate the date of last evaluation (s) in the CO and specify whether the evaluation was DE, Operation Evaluation, Country Portfolio Evaluation over the last two years 14 Year Title of evaluation CE/DE 3.2 Evaluation co-funder(s) – if any Name Contact details % Contributions in US$ 3.3 Other remarks (at CO’s discretion) 4. RB ASSESSMENT OF APPLICATION AND PRIORITARIZATION [To be filled in by RB/REO15] 4.1 Score each question on a scale of 0 (Disagree), 1 (Agree), 2 (Strongly Disagree) Key Question RB assessment 1. Is the evaluation timely to feed into the decision making process? (yes/no) If yes, which decision(s) and date of decision. 2. Are there other CEs contributing to the above decision-making process? (yes/no) If yes: which? 3. Are there DEs contributing to the above decision-making process? (yes/no) If yes, which? 4. Was the latest evaluation undertaken by the CO conducted more than 3 years before the submission of the CEF request? Yes/no 5. Is the DE cost reasonable for scope, purpose & contracting mode 16? Yes/no (If no, application should be re-formulated by CO with RB advice) TOTAL 4.2 Regional Director Prioritization High ☐ Medium ☐ Low ☐ [Please tick the box] Rationale [Open Text, taking account of regional priorities and/or national context] 14 Not necessarily of the activity being evaluated now. Reviews, baseline studies should not be included. 15 Regional Monitoring and Evaluation Advisors (RMEAs)s until Regional Evaluation Officers (REOs) will be on board in each RB. 16 Refer to Indicative Evaluation budgets by operation size in page 15 of DEQAS (average cost: US$ 126,255. For Impact Evaluation the cost is between US$ 200,000 and US$ 400,000 with the mode US$ 250,000. 8
Annex III: Assessment Form for a CEF Request ASSESSMENT FORM FOR A CONTINGENCY EVALUATION FUND REQUEST RB: Application No # Decision E-consultation No & Date: Meeting No & Date: (EFSG) This form is to be used in conjunction with the separate ‘CEF Application Form’. It aims to provide: 1. A framework for systematic and objective assessment of each application for funding from the CEF, based on the agreed CEF criteria. 2. An advice to the EFSG for its decision on whether and at what level CEF funding be approved for the application concerned. 3. The basis for feedback to applicants. 9
A. RELEVANCE OF THE DE: ASSESSED BY OEV17 [To be filled in by OEV] Advice Name: Function: Date: (OEV) Key Questions Advice (OEV) Source of Remarks Information 0 if = Disagree TOR 1. Is the evaluation timely to feed into 1 if = Partially agree Other (please the decision making process?18 2 if = Agree specify): 0 if ≥ 3 CEs TOR 2. Are there other CEs contributing to 1 if = 1 or 2 CEs Other (please the above decision-making process? 2 if = 0 CEs specify): 0 if ≥ 3 DEs TOR 3. Are there DEs contributing to the 1 if = 1 or 2 DEs Other (please above decision-making process? 2 if = 0 DEs specify): 0 if = Yes within 3 TOR 4. Was the latest evaluation undertaken years Other (please by the CO conducted more than 3 years 1 if = No, more than 3 specify): before the submission of the CEF years request? 2 if = 0 DEs in the country 0 if = Disagree TOR 5. Is the DE cost reasonable for scope, 1 if = Partially agree Other (please purpose & contracting mode19? 2 if = Agree specify): Sum of the score Total 17 Only those countries with a minimum of 6 are eligible. 18 Score has to be minimum 1 or 2. 19 Refer to Indicative Evaluation budgets by operation size in page 15 of DEQAS (average cost: US$ 126,255. For Impact Evaluation the cost is between US$ 200,000 and US$ 400,000 with the mode US$ 250,000. 10
B. SIZE OF CO: RMBB ASSESSMENT OF APPLICATION [To be filled in by RMBB] Advice Name: Function: Date: (RMBB) Key Question Advice (RMBB) Source of Remarks Information 1. CO size classification (as per annual 0 if Large & Very WFP Management Plan) large 1 if Medium 2 if Small & very small C. APPLICANT NEED: RMBP ASSESSMENT OF APPLICATION [To be filled in by RMBP] Advice Name: Function: Date: (RMBP) Key Question Advice (RMBP) Source of Remarks Information 1. What is the proportion of the proposed DE budget to the DSC available for the year to the applying CO (expressed as %)? 2. What percentage of the applicant CO’s total resource-based budget for the relevant year is funded? 3. What percentage of the applicant CO’s total resource-based budget for the relevant year is programmed? 4. What percentage of the applicant CO’s total resource-based budget for the relevant year is spent? Conclusion on level of need for CEF funds High/Medium/Low/None: 11
SECRETARIAT RECOMMENDATION TO EFSG YES/NO 1. Recommended for funding US$ 2. If recommended, advised size of CEF contribution 3. Any special conditions for funding (Specify here) EFSG DECISION YES/NO 1. Approves this DE for funding US$ 2. If approved, size of CEF contribution 3. Any special conditions for funding (Specify here) 12
Annex III: EFSG membership Composition of the EFSG Membership Chair: Chief of Staff Secretary: Director of Evaluation Membership: Regional Directors Director, Policy and Programme Director, Budget and Programming Director, Government Partnerships Director, Performance Management and Monitoring Director, Human Resources Chief Information Officer Director, Innovation and Change Management 13
Annex IV: List of Acronyms APP Annual Performance Plan CE Centralized Evaluation CEF Contingency Evaluation Fund CO Country Office COMP Country Office Management Plan CPE Country Portfolio Evaluation CSP Country Strategic Plan DE Decentralized Evaluations DEQAS Decentralized Evaluation Quality Assurance System DSC Direct Support Cost EFSG Evaluation Function Steering Group FFR Financial Framework Review KPI Key Performance Indicator PSA Programme Support and Administration RB Regional Bureau RD Regional Director RMEA Regional Monitoring and Evaluation Advisor REO Regional Evaluation Officer RMB Budget and Programming Division RMBB Organizational Budgeting Service RMBP Project Budget and Programming Service SRAC Strategic Resources Allocation Committee TWS Teamwork Space 14
