PTH 10 (BRANDON) DALY OVERPASS PROJECT - Construction Period Summary December 2020
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below

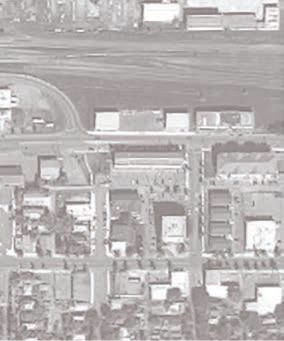

DALY OVERPASS OVERVIEW • Due to growth in the region and the importance of PTH 10 HILTON AVENUE !# !" PA R KER as a major route, the current BOUL EVAR D three-lane Daly Overpass !" structure has created a ‘bottleneck’ in the system. FRED BROWN WAY MAPLE AVENUE 19 TH STREET NORTH • Manitoba Infrastructure is constructing a new four-lane 18TH STREET facility to replace the 50+ PACIFIC RAILWAY STICKNEY AVENUE DIAN year-old overpass. CANA MCDONALD AVENUE NORTH • The construction period !" is expected to run until Late 2023. City of CANADIAN PACIFIC RAILWAY Brandon PACIFIC AVENUE • MI will continue to provide EXTENSION PACIFIC AVENUE project updates throughout the construction period. ROSSER AVENUE LEGEND N O R T H Project Area 2
PROJECT COMPONENTS • The project includes the following components: – A new four-lane bridge over the CP Rail facility – A separate new pedestrian/active transportation bridge just east of the new bridge – New on/off ramps to connect 18th street with Pacific Avenue – Property acquisitions to enable construction, improve sight lines and improve functionality of the bridge APPROXIMATE CONSTRUCTION AREA CANADIAN PACIFIC RAILWAY 3
PROJECT PROCESS • This graphic illustrates the project process to date. WE ARE HERE ROUND 1 ROUND 2 ROUND 3 ON-GOING STAKEHOLDER STAKEHOLDER STAKEHOLDER GENERAL ON-GOING CONSULTATION CONSULTATION COMMUNICATION CONSTRUCTION (IDENTIFY ISSUES/ INCLUDING INCLUDING UPDATES THROUGH CONCERNS) OPEN HOUSE OPEN HOUSE PUBLIC CHANNELS (SHARE PRELIMINARY (SHARE PREFERRED OPTIONS) PLAN) EVALUATE AND PRELIMINARY VALUE DETAILED SELECT CONSTRUCTION DESIGN AND ENGINEERING DESIGN AND LAND PREFERRED STUDY ACQUISITION PERIOD OPTIONS PLAN 4
PUBLIC AND STAKEHOLDER ENGAGEMENT • The project team has met with many !" !# groups and individuals who are likely N O R T H to have an interest in this project. • Some of these groups include: As si ni bo – City of Brandon departments in e Ri v er – CP Rail – Utilities – Adjacent landowners and PROJECT SITE businesses – Nearby residents CANADIAN PACIFIC RAILWAY – Emergency services – Transit and active transportation !# interests 18TH STREET NORTH – Organizations and interest groups – Bridge users – Others as they were identified throughout the project • MI will continue to communicate with the general public throughout the LEGEND construction period. Immediate Project Area Stakeholders Larger Project Area Stakeholders 5
PROPOSED PLAN !" 5. Pavement upgrades HILTON AVENUE PA R KER BOUL EVAR D 6. A pathway is provided along the east side of 18th 18TH STREET Street. 1. Sidewalk upgrades NORTH FRED BROWN WAY MAPLE AVENUE 7. Vehicular and pedestrian access 19TH STREET NORTH is maintained for McDonald Avenue and Stickney 2. Earthwork to build Avenue. the road foundation. STICKNEY AVENUE R ID G E MCDONALD AVENUE N EW B 3. The roadway is 8. New separate shifted to the east, pedestrian bridge allowing the existing bridge to be used during construction. New Bridge DGE N EW B RI PACIFIC AVENUE 4. Parking lot and access changes ROSSER AVENUE 6
NEW BRIDGE CROSS SECTIONS • The drawings below are cross-section diagrams of the new bridges. WEST PROTECTIVE SCREENING EAST AND HANDRAILS SAFETY FENCE SOUTHBOUND NORTHBOUND SAFETY FENCE LAMP POSTS 5 Steel Girders 5 Steel Girders PACIFIC AVENUE/CP RAIL BRIDGE WEST EAST SOUTHBOUND NORTHBOUND SAFETY SAFETY FENCE FENCE 8 Precast Prestressed Box Girders @ 1200 8 Precast Prestressed Box Girders @ 1200 STICKNEY AVENUE/MCDONALD AVENUE BRIDGE 7
NEW BRIDGE PROFILE • This graphic illustrates the profile of the new bridge over Pacific Avenue and the CP Rail tracks. STEEL GIRDERS 8
PROJECT TIMING The estimated timeframes for key project milestones are as follows: • Site preparation work (including soft dig operations for utilities) to take place in November 2020 (Completed) • Demolition contract to be advertised on December 17, 2020 • Building demolitions (including the Kullberg building) will begin in January 2021 and are expected to be substantially complete by April 2021 • Offline bridge construction is anticipated to begin in May 2021 • First traffic changes will likely occur in May 2021 • Construction completion including demolition of the existing bridge is targeted for late 2023 9
CONTACT INFORMATION Questions and comments about the project can be directed to: dalyoverpass@gov.mb.ca 10
