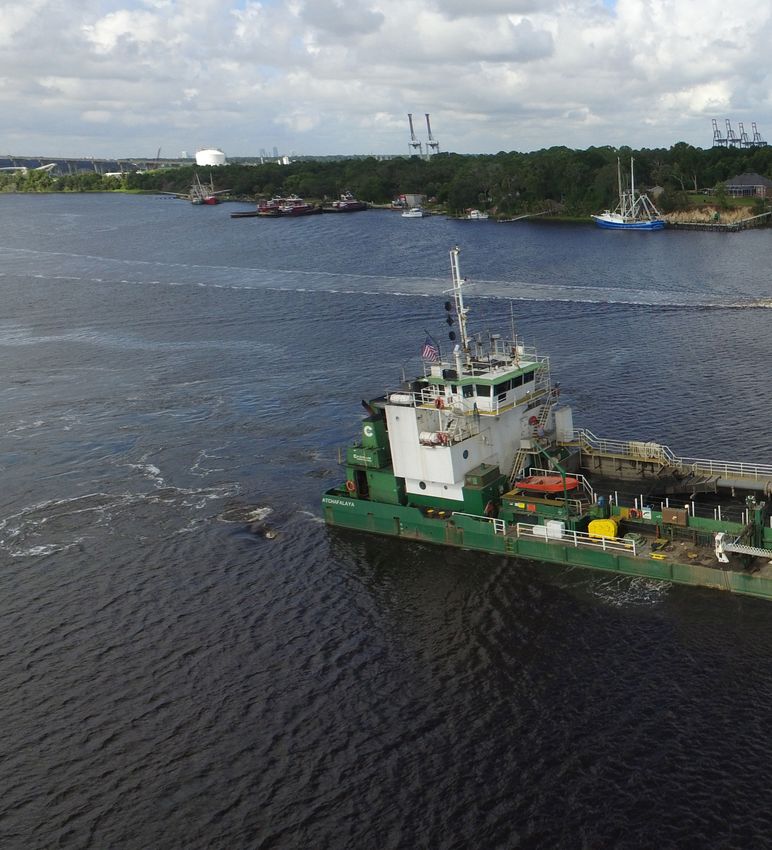

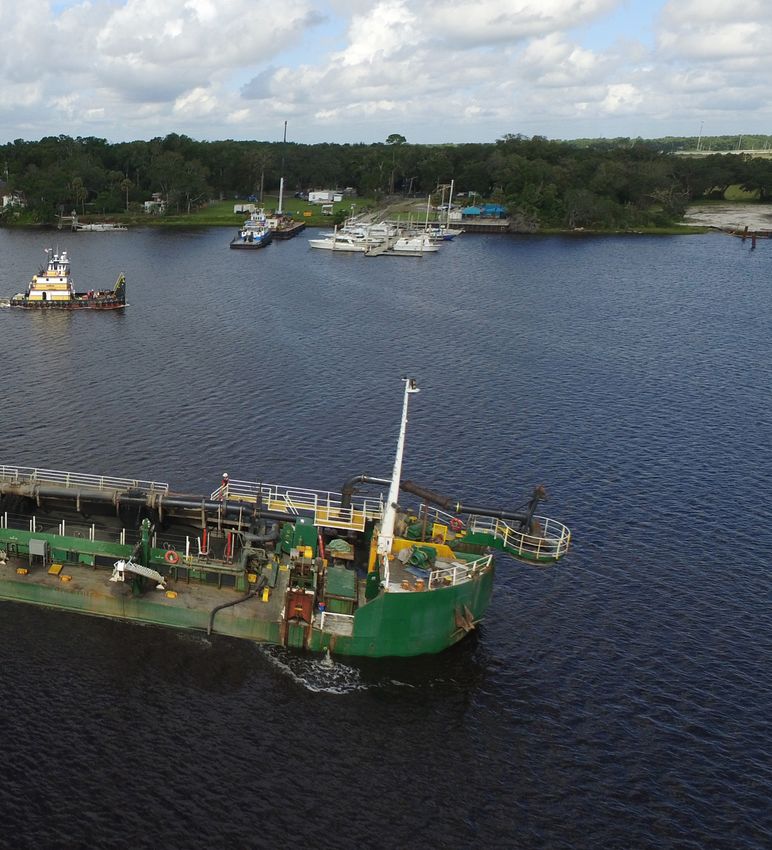

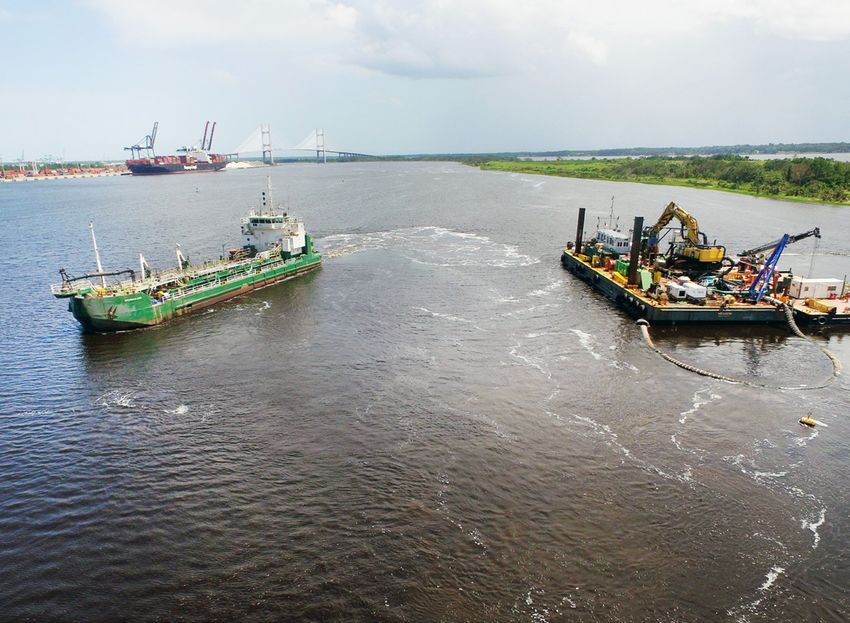

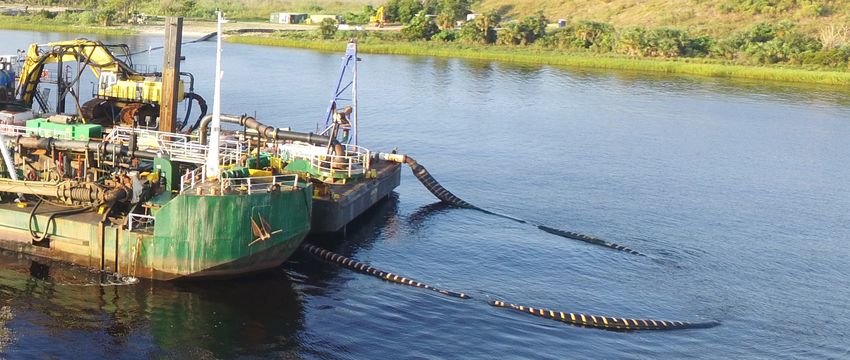

Jacksonville Harbor Maintenance Dredging
By Josh Rusk

Last April, the United States Army Corps of          of Palm Beach, Florida and completed a small
Engineers (USACE), Jacksonville District awarded     4-day emergency project which allowed the Port to
Cashman Dredging a $10-Million Maintenance           re-open the channel for deep-draft vessels.
Dredging project for Jacksonville Harbor. Not
having been dredged since 2013, over a half-         Cashman’s hydraulic-offloader barge, the Kraken,
million yards of shoaled-in material needed to be    joined the Atchafalaya in Jacksonville to provide
removed within 38- and 40-foot projects consisting   hydraulic offloading of dredged material. Lastly,
of Cut-7 through Cut-45, Cut-55, Cut-G, and the      a drag barge was assembled locally at the Mobro
Lower Terminal Channel. The dredge spoils were       Marine yard in Green Cove Springs, which was
transported and disposed in Bartram Island,          used as a staging area for the mobilization effort.
Cell A. This project is the largest hopper dredge    In addition to internal equipment, RC Ventures was
project by contract value and volume in Cashman’s    brought on to manage the disposal island and the
operational history of the Trailing Suction Hopper   land-side scope of work. As work was beginning,
Dredge (TSHD) Atchafalaya.                           daily temperatures reaching as high as 120˚F,
                                                     threatened the start of the project and was a safety
                                                     concern for the crew. During this time, site safety
                                                     and superintendent teams developed a work
                                                     program to manage the heat and continue work
                                                     without delay.

Mobilization began in late May as the team started
to move the equipment to the job site. The
Atchafalaya departed from Tampa following a pre-
job tune-up. While making the sail from Tampa to
Jacksonville, the Atchafalaya stopped at the Port

3                                                           CASHMAN INK         SPRING/WINTER 2019
ASHMAN ink WINTER/SPRING 2019 - A CASHMAN FAMILY OF COMPANIES PUBLICATION - Jay Cashman, Inc.
“The Team collaborated effectively and challenged and encouraged each other throughout the project enabling
their commitment and teamwork to make the project a resounding success” – Josh Rusk, Project Manager

                                                           with the Port of Jacksonville and other contractors
                                                           was necessary to ensure safety in the oncoming
                                                           traffic and for scheduling.

                                                           The project was completed two months ahead of
                                                           schedule and under budget. USACE’s, Jacksonville
                                                           District Project Engineer, Gavin Jackson said,
                                                           “[Cashman’s] equipment and production was more
                                                           than adequate for the contract requirements,
                                                           allowing them to complete the contract ahead of
                                                           schedule. [Cashman] mobilized a booster pump to
                                                           increase productivity, which aided in their efforts to
                                                           meet the schedule. Government surveys revealed
                                                           overruns in the before-dredge volume which
                                                           [Cashman] was able to dredge and complete ahead
                                                           of the original contract date. [Cashman] was able

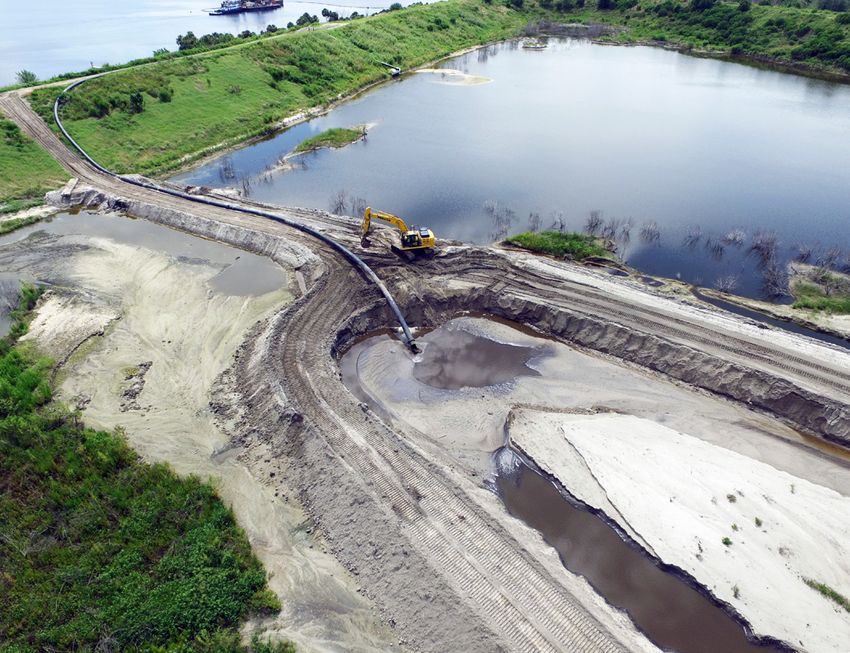

   Upon mobilization, the team discovered hundreds         to demobilize ahead of the scheduled date, which
   of nesting endangered birds consisting of a variety     allowed the Local Sponsor’s contractor to utilize
   of species which were located in the Bartram            the staging area ahead of schedule.”
   Island disposal area which threatened to delay the
   job for the duration of the bird nesting season.
   Together, Cashman, the USACE, and RC Ventures
   reworked the disposal plan to avoid impacting the                 The Project Team consisted of:
   protected birds. Rerouting the pipeline corridors
   and mobilizing a dewatering operation to the             Project Manager: Josh Rusk
   Island prevented the nests from being flooded by         Project Engineer: Sean Moriarty
   the later added dredge slurry. This solution led the     Superintendents: Aaron McIntyre, Matt Boykin, Chris
   USACE to give the project an exceptional rating in       Vandermeer, Ryan Collett
   the management category.                                 Dredge Captains: Dan Hassett, Brad Wallace
                                                            QC Manager: John Riffey
   The majority of the dredged material was located         Safety Manager: Bryan Borges
   in the lower terminal channel, adjacent to the busy      Safety Representative: Nerio Garcia
   Talleyrand terminal, which also had an unrelated         Surveyors: Matt Perry, Mackenzie Bernard, Dave
   dredging project underway. Constant coordination         Radloff

    WWW.JAYCASHMAN.COM                                                                                            4
ASHMAN ink WINTER/SPRING 2019 - A CASHMAN FAMILY OF COMPANIES PUBLICATION - Jay Cashman, Inc.
CASHMAN INK   SPRING/WINTER 2019
ASHMAN ink WINTER/SPRING 2019 - A CASHMAN FAMILY OF COMPANIES PUBLICATION - Jay Cashman, Inc.
WWW.JAYCASHMAN.COM
ASHMAN ink WINTER/SPRING 2019 - A CASHMAN FAMILY OF COMPANIES PUBLICATION - Jay Cashman, Inc.
CASHMAN INK   SPRING/WINTER 2019
ASHMAN ink WINTER/SPRING 2019 - A CASHMAN FAMILY OF COMPANIES PUBLICATION - Jay Cashman, Inc.

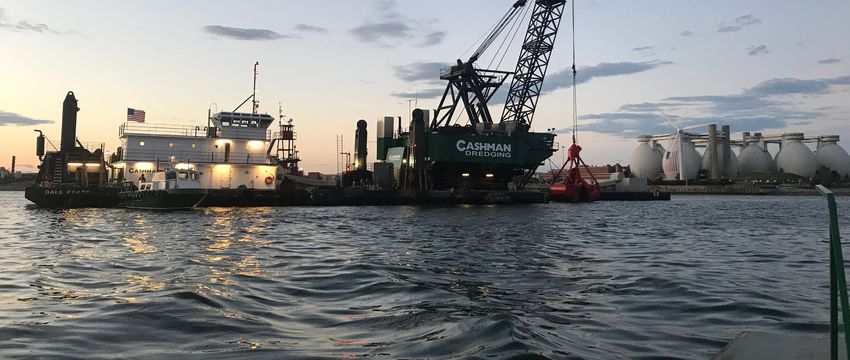

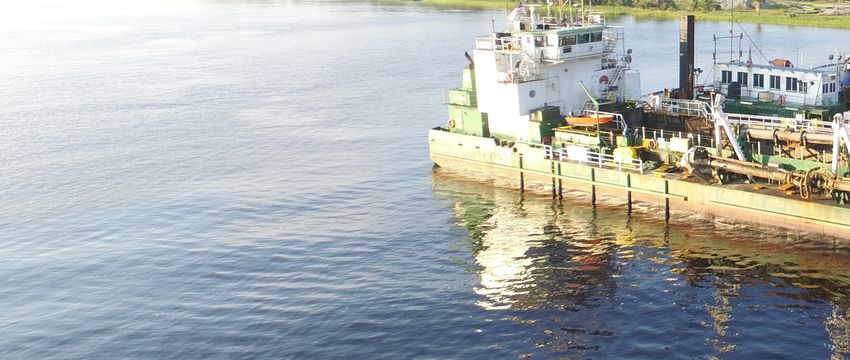

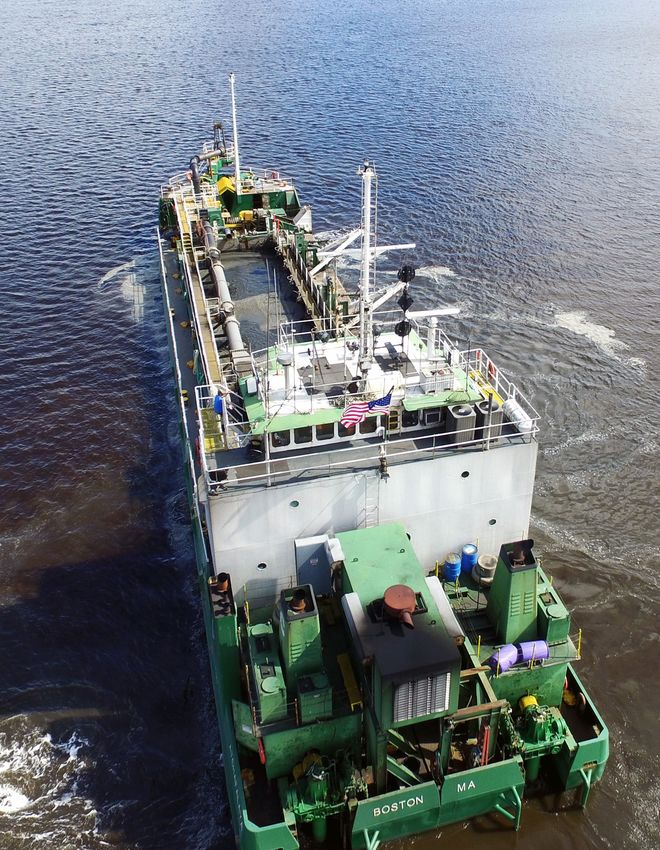

Boston Harbor
Improvement Dredging
By Steve Tobin

Cashman Dredging, along with our Joint Venture
(JV) partner, Dutra, was awarded the USACE’s
Boston Harbor Improvement Dredging contract
(Boston), which is a three-year contract that covers
~52-Million-ft2 (just over seven miles) of the Boston
Harbor Entrance Channel. Beginning in July 2018,
the JV team started dredging the challenging
requirement of the USACE’s 350,000-yd3 per month
demand. Over 3.8-Million-yd3 has been dredged
(as of March 2019) by Cashman Dredging’s Dale
Pyatt, FJ Belesimo, and Captain AJ Fournier (AJ),
and Dutra’s Paula Lee. Notably, this is Cashman
Dredging’s largest project by volume.

The Scope of Work includes dredging 49 separate
acceptance areas with a total of ~12-Million-           dump scows of dredged material to the MBDS for
yd3. The material is being transported to Mass          placement.
Bay Disposal Site (MBDS) located approximately
20-nautical miles from the project site. Up to seven    Boston Harbor is New England’s busiest corridor
split-hull dump scows are being used to dispose         with cruise ships, container ships, and LNG Tankers
the material.                                           frequenting the area. The high-traffic corridor
                                                        paired with its proximity to Logan International
Including Innovative Technology as part of the          Airport makes the project complex with a plethora
project, Cashman installed the Scow Geofence            of daily challenges. Federal Aviation Administration
System (SGS) designed by Cashman Dredging to            (FAA) restrictions means no drone, sonar, or video
add an additional layer of quality control to the       footage can be captured, and any aerial shots need
process of material disposal via split-hull scow.       to be coordinated and approved by the FAA. New
This prevents the scow from inadvertently opening       England’s weather is unrelenting, unforgiving,
during loading, maintenance, and transit to the         and changes constantly which can cause a safety
dredge-spoil disposal site. Using a relay to connect    problem, especially in the winter with ice building on
the SGS to the programmable logic controller            the dredges and cranes. Additional complications
(PLC), SGS prevents operation of the “OPEN”             include Deer Island’s newly directional-drilled
control of the scow when located outside of a           power lines along with existing power lines; high
predefined area (geofence) that was developed for       rock; lobstermen; and port coordination.
the particular disposal coordinates. Only when the
scow is positioned within the geofence area does        The project is anticipated to be completed in 2021.
the scow’s OPEN control become operationally
enabled. To date, the JV has transported over 1,300

 WWW.JAYCASHMAN.COM                                                                                         8
ASHMAN ink WINTER/SPRING 2019 - A CASHMAN FAMILY OF COMPANIES PUBLICATION - Jay Cashman, Inc.
Woods Hole Ferry Terminal
Construction
By Brendan Campbell

In December 2017, Jay Cashman, Inc. (JCI) was           construction of the first of three slips. The plan
awarded by the Steamship Authority (SSA) the            was to utilize two crews, one water-based and
Reconstruction of the Woods Hole Ferry Terminal         one land-based, to work concurrently to complete
in Falmouth, MA. This three-and-half-year project       their respective work in the most cost- and time-
must be accomplished in phases during ‘off-             effective manner. Having so many unknowns, the
seasons’- between Labor Day and Memorial Day.           water-based demolition of the existing wharf
During construction, the SSA requires two terminals     operation proved to be a challenging task. The
to be open for regular ferry operations. Therefore,     land-based crew commenced sheet piledriving for
JCI is required to reconstruct only one slip at a       the new bulkhead system, including sheetpiles,
time to ensure the two slips remain operational.        walers and tie-rods. Once demo was completed,
During each ‘summer season’ all three slips must        the water-based crew began the unique
be operational.                                         piledriving operation of driving 96” diameter
                                                        piles, 120’ long, into their positions where they
From January through May of 2018, JCI prepared          will serve as support for the fenders in the new
the site for the first of three ferry terminal slip’s   terminal. Throughout operations, obstructions
construction. Prep work included construction of        requiring changes to the project schedule and
temporary fenders and excavation work consisted         resources have been addressed with the Owner.
of approximately 20,000-yd3 of material including
steel piles, wood piles, concrete structures, granite   The team has worked diligently with the Owner,
seawall, timber lagging walls, tie rods, contaminated   through tough and changing conditions, to keep
and non-contaminated soils, and boulders.               everything moving as efficiently as possible
                                                        for the project. As of February 2019, JCI is
JCI remobilized in September 2018 to commence           approximately 78% complete with the piledriving
                                                        operation, approximately 90% complete with the
                                                        Sheetpile-Bulkhead System, while completing
                                                        some additional work as directed by Owner.
                                                        Upcoming work includes utilities, concrete work,
                                                        transfer bridge system construction, and fender
                                                        installation on the 96” monopiles.

                                                        We look forward to continuing our excellent
                                                        relationship with the SSA and providing them
                                                        what they need each season.

9                                                               CASHMAN INK        SPRING/WINTER 2019
Port of Miami New North
Cruise Berth 7 Deepening
By Kyle Reeves

Cashman Dredging was contracted by Ebsary              the AJ to complete the dredging and successfully
Foundation to assist with the deepening of the         finish the project.
New North Cruise Berth in the Port of Miami,
Florida to 37 feet. Cashman’s responsibilities         There was a significant overrun in the available
included dredging ~117,000-yd3 of sand, coral,         quantities on the project, as it was originally
debris, and limestone into fixed-bottom hopper         expected that 80,000-yd3 would be removed.
scows; transloading the material from the scows to     Cashman cleared ~15,000-ft2 of limestone outside
land for re-handling and offsite disposal.             the original scope in order to provide Royal
                                                       Caribbean an unabridged, clear berth.
The Captain AJ Fournier encountered ~44,000-ft2
of limestone around the middle of the terminal’s       Today, the terminal is home to the ships Allure of
berth. As a result, the crane barge was set up with    the Seas and Symphony of the Seas.
a ‘punch’ - a large steel chisel from the crane that
fractured the limestone. Cashman installed survey
equipment on the crane to improve accuracy and
efficiency of the punch. This innovative method
separated the limestone and made it possible for

 WWW.JAYCASHMAN.COM                                                                                    10
By Todd Presson

This past fall was busy for Patriot Renewables!         continue pursuing. We have also had a number of
Hosting over 600 students and guests, we gave           evening tours to see the Perseid and Tourid meteor
most of them a first-time opportunity to explore an     showers, as well as a rare chance to see the Northern
operating wind project up close. Our operational        Lights (in the direction of Rangeley) at the end of
sites in Maine – Saddleback Ridge Wind in               last summer. This spring, we look forward to being
Carthage; Canton Mountain Wind in Canton;               featured guests and judges for the state-wide Kid-
Spruce Mountain Wind in Woodstock; and Beaver           Wind competition, which will send the winning
Ridge Wind in Freedom offered recreational and          team of junior engineers to compete nationally at
informative events for the general public, as well      the American Wind Energy Association (AWEA)
as formal groups. A successful partnership with         annual tradeshow - WINDPOWER Conference and
the University of Maine Cooperative Extension           Exhibition in May.
and Maine Science Teachers Association enabled
Patriot to become Maine’s educational connection
to renewable and wind energy, environmental
stewardship, and project development since
renewable energy is becoming an increasing part
of Maine’s diverse energy economy.

Hosting classroom events featuring hands-on
lessons that complement grade-appropriate STEM
curriculum, our presentations focus on wind turbines,
generators, gear ratio, blade design, or renewables
on the New England Grid system. University of
Maine at Farmington (UMF) and UMaine Extension
4-H partnered with Patriot Renewables to offer a        On the operations side, Patriot is expanding.
program for 20 middle school students from Hong         Our overall portfolio now exceeds 100 MWs (100
Kong. Students designed and built wind turbine          million watts). We purchased a controlling interest
generators in their classroom, and then followed        in a 4-turbine, 8.4 MW wind project in Tiskilwa,
up their experience by visiting an operational site     Illinois called AgriWind that we are repowering
to apply their learning. We have had a continued        with new generators later this year. We invested in
initiative from UMF, where Geology Professor            an 8-turbine, 20 MW wind project in Palm Springs,
Doug Reusch has been using our Saddleback Ridge         CA called Edom Hills, and we are proceeding with
Wind site in Carthage as an extended classroom          repowering activities on our Beaver Ridge Wind
each semester. His explorative work with students       project, which is now in its 11th year of operation(!).
has led to scientific publications and geological
discoveries that Professor Reusch is excited to

11                                                             CASHMAN INK          SPRING/WINTER 2019
By Charles McGann

FAIRBANKS, AK                                          80’ 9% nickel shell was erected within the outer
In December 2017, Preload Cryogenics, LLC was          tank. Inner tank construction was completed in
awarded the design and construction for a 20,000       early February 2019. Work on the suspended
m3 (5.25 million gallons) full containment LNG         ceiling and in the annular space (between inner and
storage tank in Fairbanks, AK by Fairbanks Natural     outer tanks) is currently ongoing. Topside work will
Gas. The tank is comprised of a precast, prestressed   commence in early March and be ready for early
concrete secondary (outer) containment wall            stages of commissioning this Spring.
(35.2 m by 27.1 m), a 9% nickel primary (inner)
containment wall (33.3 m by 23.5 m), 9% Ni primary
and secondary floor plates and an ASTM A516 low-
temperature carbon steel dome.

Preload Cryogenics broke ground on January 1,
2018. The work on-site included site clearing,
excavation and replacement of 30,000 yd3 of
unsuitable subgrade to reach stable till (at a depth
of 17’ below grade), installation of active (and
passive) subgrade cooling systems to maintain
existing permafrost conditions and construction of
an at-grade concrete base mat foundation.
The precasting of the secondary wall panels was
performed in Anchorage, AK concurrently with           BETHLEHEM, PA
subgrade improvement and foundation construction       In December 2018, Preload Cryogenics, LLC was
work. Following the completion of the foundation       awarded the design and construction of a precast,
construction work, the secondary wall panels were      prestressed concrete secondary (outer) containment
erected via the ‘tilt-up’ method and braced on the     wall for a 7,500 m3 (2.0 million gallons) LNG full-
concrete foundation. Circumferential prestressing      containment tank (27 m by 19.3 m) in Bethlehem,
of the outer wall was performed throughout the         PA. Preload will be serving as a subcontractor to
month of August in preparation of setting the          American Tank & Vessel on this project for UGIES.
steel dome roof in-place. The roof (and suspended      Site civil work, including clearing and grading, is
aluminum ceiling) was fabricated at-grade adjacent     currently on-going. The tank foundation work is
to the tank foundation concurrently with outer wall    scheduled to start in June 2019 and secondary
construction and prestressing operations and set       wall panels will be erected and circumferentially
in-place on September 12, 2018.                        prestressed in August/September 2019. Outer wall
                                                       construction this summer/early fall will support the
With the outer wall complete and the dome              “drying-in” of the tank for subsequent inner tank
secured, the primary containment system including      work throughout next winter.
an insulated base, a 9% Nickel floor plate and an

 WWW.JAYCASHMAN.COM                                                                                     12
By Mark Quinn

Constantly looking to update our already               is anticipated that we will manage the disposal
extensive barge fleet, Sterling Equipment              of over 40,000 Tons of material over a 3-month
recently purchased a 240 x 76 x 17’ barge              period.
located in Morgan City, LA. The barge is an ex-
heavy lift rig that was used in the Gulf of Mexico.    The Quincy, MA yard is designated as a secure
The crane has been removed and the vessel is           facility by the United States Coast Guard. As
undergoing transformation to bring it to code          a result, it has the capacity to allow foreign-
for ABS All Oceans Classification. The newest          flagged vessels to dock and load or offload
addition to the fleet brings great versatility as it   cargo. In February, over 100 pieces of cargo
can be used as a deck barge or dredge.                 from a 650’ ship was offloaded. The larger items
                                                       weighed over 60 Tons. Currently, another vessel
In March, we contracted May Ship in Staten             is anticipated to dock at the Yard towards the
Island, NY to build a 180 x 60 x 12’ ABS Spud          end of March where the cargo, weighing up to
Barge. The barge is unique because of its heavy        30 Tons each, will be offload.
deck loading towards the stern. As a result, the
barge will be capable of handling a 400-Ton            This coming summer Sterling will offload several-
Crane on deck. It will be built with (2) 80’ x 36”     thousand yards of dredged material at a facility
Square Spuds. Estimated delivery is October            in Staten Island, NY for a premier Client. The
2019. Additionally, another 220 x 60 x 12’ ABS         Sennebogen 880 Material Handler with a 12-yd3
Spud Barge is to be built in the near future.          Bucket will be used to off-load Hopper Barges.

Sterling was recently awarded the removal              Safety is of utmost importance at Sterling
and installation of a well-known Marina on the         Equipment. As a result, the Team has stepped
Charles River in Cambridge, MA. The new dock           up the safety culture to ensure zero incidents
will be delivered to the Quincy Yard where it will     happen. All employees are working hand-in-
be loaded onto a barge and transported to the          hand with management to better the safety
Marina. A crane barge at the Marina will be used       program. The Management Team is very happy
to complete the work. The projected start date         with the overall cooperation within the company
is sometime in the Fall of 2019.                       and would like to thank everyone for their hard
                                                       work. We try to educate employees on job-
Another notable project involves the unloading         specific tasks while being aware of the hazards
of disposal and demolition materials from the          of working in a Marine Environment.
Tappan Zee Bridge, NY, where Sterling will
oversee the project on behalf of the Tappan
Zee Constructors. The material will be barged
to a facility in Bayshore, NJ where it will be
off-loaded and sent to various landfill sites. It

13                                                            CASHMAN INK        SPRING/WINTER 2019
By Jaclyn Cashman

Kilkea Castle Hotel and Golf Resort had an            tourist destination, to our pleasant surprise, with
incredible first year. After the massive renovation   many guests coming from America.
and Grand Opening, the Castle nearly broke
even, which is an incredible success for the hotel/   The spa will open late Spring 2019. We will have
hospitality industry. Boasting 35 weddings in 2018    plenty of treatment rooms for facials, massages,
and for 2019 we have over 60 weddings confirmed       and space for hair, makeup, and nails.
and will probably pick up another ten for this year
alone. Key dates for 2020 are going fast with 20      It has been great that so many Cashman employees
weddings already booked!                              have taken the opportunity to visit Kilkea and we
                                                      continue to extend that invitation in 2019. We
The event business has been strong as well. We will   will probably look to do a special sometime this
hold about 50 events & conferences this year.         year when airfares are down, and occupancy is
                                                      low. Jay said, “I don’t think of the off season as
                                                      bad in Ireland. I spend most of my time in Ireland
                                                      during the off season. Horseback riding is good.
                                                      Fishing is fun. Crowds are smaller. Airfares are
                                                      cheaper. Hunkering down in a pub with the locals
                                                      not crowded out by tourists and a fire burning is a
                                                      real treat”.

                                                      Please email jaclyn.cashman@kilkeacastle.ie if you
                                                      would like to visit.

Jay said, “It has been a thrilling year. Stellar!”

Players have been really impressed with the quality
of the golf course. We held our first Pro Am this
past summer. Golf Societies have been another
area of business that we have picked up and local
Memberships are also thriving.

This year we look forward to tripling our overall
business and becoming a world-class hotel with
global recognition. The hotel has become a popular

 WWW.JAYCASHMAN.COM                                                                                   14
Innovation: Setting Industry Standards
By Aiden Horan & Renae Hatcher

Innovation is at the heart of the Cashman Family
of Companies, changing the way we operate,
plan, design, and build. Having executed some
of the most difficult and complex projects, from
large-scale marine construction projects to one
of the largest remediation dredging projects in
U.S. history, innovation is vital to our growth and
continued success.

In order for an innovative culture to prosper,
managers encourage progressive mindsets across
all levels of employment, from field personnel to
top level management. Aiden Horan, Vice President
of Engineering, is the innovation frontrunner for
the Cashman Family of Companies. Mr. Horan
expresses, “Not only do we utilize innovation to
increase our efficiencies and competitiveness within
our existing business units, we look to innovation as
a tool to explore untapped or emerging markets in
an effort to examine new business opportunities.”

To date, Cashman has held several companywide
innovation seminars that have since resulted in
hundreds of manhours of discussion and idea
generation. Attendees range from Chairman and
CEO to recently hired field personnel. Mr. Horan
points out, “The key to the success of innovation
within Cashman is due to the determination from
the company owner, Jay Cashman. Jay promotes
an innovative mindset and culture within the
organization and is always open to new approaches

15                                                      CASHMAN INK   SPRING/WINTER 2019
“There is a very favorable environment for promoting and entertaining ideas within Cashman, if you enjoy
thinking about things differently or have an idea that you have been exploring for some time, we would love to
hear from you; there is no such thing as a bad idea.” -Aiden Horan, Innovation Frontrunner

                                                           and ideas from anyone.” Varying perspectives leads
                                                           to the generation of ideas that bolster a commercial
                                                           advantage within our core competencies and
                                                           beyond.

                                                           The Cashman Family of Companies are in various
                                                           stages of patenting nine innovations ranging from
                                                           new marine technology to industrial breakthroughs
                                                           relative to LNG storage tanks. Mr. Horan adds,
                                                           “The balance must be struck between being
                                                           innovative and staying afloat commercially.” Our
                                                           enduring passion to sustain a culture of innovation
                                                           has generated everlasting potential for growth and
                                                           success. At Cashman, it is our goal to be the best
                                                           at everything we do and to remain industry leaders
                                                           known for pushing the envelope of possibility and
                                                           never settling for the status quo.

WWW.JAYCASHMAN.COM                                                                                        16
Safety & The Cashman Legacy
Dan Schultz, Vice President of EHSQ, recently
participated in the Council for Dredging and
Marine Construction Safety’s meeting to share
Cashman’s approach to safety. His opening
statement: “What we are looking for today in our
company is legacy, not just a history. Legacy will
last and change others” This philosophy is central
to the safety legacy and culture we work hard to
achieve daily. The Cashman Way, blends elements                 Preventing Injuries & Fatalities
                                                                                    FIELD GUIDE

                                                                  GRAVITY       MOTION

                                                                 MECHANICAL   ELECTRICAL

                                                                  PRESSURE    TEMPERATURE

                                                                   SOUND       CHEMICAL

                                                                 RADIATION    BIOLOGICAL

                                                     of a compliance-based systems and behavior-
                                                     based approaches building upon each element.
                                                     By engaging Cashman leadership and crew to
                                                     participate in site visits, walk-throughs, hazard
                                                     hunts, hazard recognition and mitigation, near-miss
                                                     reporting, keeping stop-work authority important,
                                                     and advocating for off-the-job safety we see our
                                                     improvements and goal of “Zero” that much more
                                                     achievable.

17                                                         CASHMAN INK                      SPRING/WINTER 2019
Heavy Civil & Marine Construction                 Dredging

The Cashman Family of Companies
          Renewables                  Pre-Stressed Concrete Storage Tanks

              549 South Street | Quincy, MA | 02169
                         info@jaycashman.com
                         www.jaycashman.com

WWW.JAYCASHMAN.COM                                                     20
HEAVY CIVIL/MARINE   DREDGING   ENERGY   RENEWABLES   TANKS
You can also read
