CIP_2015 Title Pages 2016:Layout 1 6/19/15 11:24 AM Page 15
WATER SYSTEM
Pinocchio
PINOCCHIO GETS EATEN BY A WHALE
By Mark AndersonFY 2016 - 2020 Capital Improvement Program
Water System
Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Priority Description
1 Distribution Mains FY 2015 - 2020 (1001) 18,578,506 2,793,506 2,270,000 3,015,000 3,500,000 3,500,000 3,500,000
2 Meters and Services FY 2015 - 2020 (1002) 10,150,344 1,520,344 1,070,000 1,560,000 2,000,000 2,000,000 2,000,000
3 Customer Driven Meters and Services FY 2015 - 2020 (1003) 6,995,893 1,265,893 930,000 1,200,000 1,200,000 1,200,000 1,200,000
4 Fire Protection System Improvements FY 2015 - 2020 (1019) 8,267,448 2,035,248 210,000 1,290,000 1,577,400 1,577,400 1,577,400
5 Upgrade Well Pumps, Booster Pumps, Switchgears and 3,980,566 1,480,566 0 950,000 750,000 400,000 400,000
Meters FY 2015 - 2020 (1020)
6 Reservoir Improvements FY 2015 - 2020 (1037) 12,116,365 696,365 820,000 600,000 2,000,000 7,000,000 1,000,000
7 Miscellaneous Water System Improvements FY 2015 - 2020 2,263,072 323,072 340,000 400,000 400,000 400,000 400,000
(1006)

8 Management Information Systems - Water and Power 726,564 451,564 0 100,000 75,000 50,000 50,000
Department FY 2015 - 2020 (1025)
9 Sunset Perchlorate Treatment Plant FY 2015 - 2020 (1062) 1,189,959 669,959 220,000 150,000 50,000 50,000 50,000
10 Well Collector Pipelines (1044) 12,609,718 12,609,718 0 0 0 0 0
11 Arroyo Spreading Basins and Intake Structures (1040) 10,590,370 2,222,870 1,620,000 6,000,000 700,000 35,000 12,500
12 Recycled Water (1013) 17,885,564 13,885,564 0 1,000,000 1,000,000 1,000,000 1,000,000
13 Enterprise Resource Plan (ERP) - Water System (1072) 638,244 380,618 199,405 58,221 0 0 0
14 Customer Information System (1011) 2,589,585 965,585 0 650,000 550,000 224,000 200,000
15 Water and Power Warehouse Modernization (1056) 1,769,047 1,769,047 0 0 0 0 0
16 Water Telemetry and On-Line Water Quality Detectors FY 374,398 154,398 20,000 50,000 50,000 50,000 50,000
2015 - 2020 (1034)
17 Geographic Information System - Water and Power 1,028,903 703,903 0 100,000 75,000 75,000 75,000
Department (1009)
18 Field Service Automation (1012) 538,678 318,678 0 55,000 55,000 55,000 55,000
19 Monk Hill Perchlorate Treatment Plant (1063) 4,655,148 3,005,148 0 500,000 200,000 450,000 500,000
20 Radio Equipment Replacement (1065) 1,102,827 1,052,827 0 25,000 25,000 0 0
21 Interactive Voice Response System (IVR) (1016) 302,101 220,851 0 25,000 18,750 18,750 18,750
22 Devil's Gate Tunnels (1043) 391,278 351,278 0 10,000 10,000 10,000 10,000
23 Facility Security Systems (1054) 1,172,636 372,636 0 300,000 400,000 50,000 50,000
15 - SummaryFY 2016 - 2020 Capital Improvement Program
Water System
Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Priority Description
24 New Well Projects (Conjunctive Use) (1021) 3,275,880 275,880 0 85,000 2,915,000 0 0
25 Water Quality Treatment (1041) 394,459 394,459 0 0 0 0 0
26 Enterprise Content Management System (1071) 97,300 97,300 0 0 0 0 0
Total 123,684,853 50,017,277 7,699,405 18,123,221 17,551,150 18,145,150 12,148,650
15 - SummaryFY 2016 - 2020 Capital Improvement Program
Water System
Distribution Mains FY 2015 - 2020
1001
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
1 1001 Distribution Mains FY 2015 - 2020
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 18,578,506 2,793,506 2,270,000 3,015,000 3,500,000 3,500,000 3,500,000
Total 18,578,506 2,793,506 2,270,000 3,015,000 3,500,000 3,500,000 3,500,000
DESCRIPTION: This project provides for the installation of both new and replacement water
distribution mains at various locations throughout the City. Work includes installation of new gate
valves, water services, fire hydrants, and asphalt or concrete patching/resurfacing of the trenches as
required by code. The actual amount of pipe installed can vary due to size and complexity of
projects. There are approximately 500 miles of water distribution mains in the system. The average
life expectancy of a water main is between 80 and 100 years. The goal of this project is to replace
all water distribution and fire protection mains every 80 to 100 years, or as required.
JUSTIFICATION: New and replacement distribution mains are required to fulfill increased
service demand, capacity needs, and upgrades to aging infrastructure to ensure system operating
efficiency. This project will ensure adequate water for fire protection in accordance with public
safety requirements.
SCHEDULE: The goal is to install three miles of new distribution and fire protection mains
including installation/repair of 100 gate valves, water services, fire hydrants and related asphalt or
concrete patching/resurfacing of trenches as required by code. The actual amount of pipe installed
can vary due to size and complexity of projects. The goals and amount of cash flow requested is
needed to meet the workplan goals for each fiscal year.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with Public Facilities
Element of the General Plan by helping to achieve a high level of maintenance for existing
facilities.
IMPACT ON THE NORTHWEST: Portions of this project are located in Northwest Pasadena
which is an area targeted for revitalization.
HISTORY: This is an ongoing project that was created before 1980. The project was segmented
into a multi-year phase starting in FY 2012. This is the new phase of this project for FY 2015 -
2020.
Responsible Department:
15.1 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Meters and Services FY 2015 - 2020
1002
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
NEW 1002 Meters and Services FY 2015 - 2020
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 10,150,344 1,520,344 1,070,000 1,560,000 2,000,000 2,000,000 2,000,000
Total 10,150,344 1,520,344 1,070,000 1,560,000 2,000,000 2,000,000 2,000,000
DESCRIPTION: This project provides for the installation of new water meters and services
throughout the City. Work included in this project involves the replacement of worn-out meters,
services, meter vaults, boxes, and steel plate covers, as needed. The installation of new automatic
meter readers (AMR) is expected to end in FY 2016. Beginning FY 2017, the installation of new
advanced metering infrastructure (AMI) systems and meters (Smart Meters) will begin. Additional
meters will continue to be replaced on an as-needed basis. Installation of AMI meters will upgrade
the technology available to the customer for monitoring their water use and will improve the
method of collecting meter data for billing. The repair or replacement of steel plates and/or vaults
will continue on an as needed basis.
JUSTIFICATION: Upgrading the water metering technology will benefit the customer by
allowing them greater access to their water use data. Enhancements to the billing system will also
be realized. The replacement of old and non-functioning water meters, services, meter vaults,
boxes, and covers is necessary to meet customer demand and provide a safe and efficient city
infrastructure. Repair or replacement of steel plates and/or vaults have been included for the safety
of pedestrians.
SCHEDULE: Focus in FY 2016 will be on the installation of 2,000 small and 100 large AMR
meters. An outside contractor may be used to install small meters. Additional work in FY 2016
will include the installation of 200 new services and the replacement of approximately three meter /
vault plate covers. The replacement of small meter box covers is expected to begin in FY 2016.
The amout of cashflow requested is needed to meet the workplan goals of FY 2016.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to achieve a high level of maintenance for existing
facilities.
HISTORY: This is an ongoing project that was created before 1980. The project was segmented
into a multi-year phase starting in FY 2012. This is the new phase of this project for FY 2015 -
2020.
Responsible Department:
15.2 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Customer Driven Meters and Services FY 2015 - 2020
1003
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
3 1003 Customer Driven Meters and Services FY 2015 -
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
2020
Aid to Construction (Water) 6,995,893 1,265,893 930,000 1,200,000 1,200,000 1,200,000 1,200,000
Total 6,995,893 1,265,893 930,000 1,200,000 1,200,000 1,200,000 1,200,000
DESCRIPTION: This project provides for the installation of new water meters, services, and
mains as requested by customers and developers throughout the City. It also includes new fire
hydrants and other requirements from the Fire Department for new building/development projects.
JUSTIFICATION: Meeting customer and developer requests for new meters and services is an
important priority in providing water service. Work is done in conjunction with the Fire
Department requirements.
SCHEDULE: PWP will install mains, meters, and services for customers upon request and at
customers' expense.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to provide a high level of service and greater work
productivity by using available technology.
HISTORY: This project was originally created and received initial funding in FY 2007. The
project was segmented into a multi-year phase starting in FY 2012. This is the new phase of this
project for FY 2015 - 2020.
Responsible Department:
15.3 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Fire Protection System Improvements FY 2015 - 2020
1019
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
4 1019 Fire Protection System Improvements FY 2015 -
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
2020
Water Fund 8,267,448 2,035,248 210,000 1,290,000 1,577,400 1,577,400 1,577,400
Total 8,267,448 2,035,248 210,000 1,290,000 1,577,400 1,577,400 1,577,400
Fire Protection System Improvements DESCRIPTION: This project provides for the installation of both new and replacement water
distribution mains as necessary to sustain current fire protection requirements at various locations
throughout the City. Work includes installation of new fire hydrants, gate valves, services, and
asphalt/concrete patch/resurfacing as required by code. New developments will pay for required
new mains. When mains are installed anticipating a future development, special connection charge
and/or front footage charges are assessed and collected from property developers as covered under
project #1003.
JUSTIFICATION: This project will ensure adequate water for fire protection in accordance with
public safety requirements.
SCHEDULE: The goal is to install three miles of new distribution mains including installation /
repair of 100 gate valves and asphalt / resurfacing as needed. Total miles installed will include CIP
projects 1001, 1019 and 1063. The amount of cash flow requested for each CIP project is needed
to meet the workplan goal for water distribution main installations in FY 2016. The actual amount
of pipe installed may vary due to size and complexity of projects.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to ensure adequate water for fire protection.
HISTORY: This is an ongoing project that was created before 1980. The project was segmented
into a multi-year phase starting in FY 2012. This is the new phase of this project for FY 2015 -
2020.
Responsible Department:
15.4 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Upgrade Well Pumps, Booster Pumps, Switchgears and Meters FY 2015 - 2020
1020
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
5 1020 Upgrade Well Pumps, Booster Pumps,
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Switchgears and Meters FY 2015 - 2020
Water Fund 3,980,566 1,480,566 0 950,000 750,000 400,000 400,000
Total 3,980,566 1,480,566 0 950,000 750,000 400,000 400,000

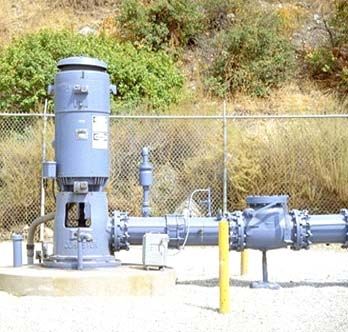

DESCRIPTION: This project provides for the upgrading or replacing of older and less efficient
well and booster pumps, meters, and obsolete and outdated switchgears.
JUSTIFICATION: Some of the existing well and booster pumps and meters are old and
inefficient. Some of the switchgears are also old and may not meet current codes. Greater operating
reliability and efficiencies will be realized by these upgrades.
SCHEDULE: In FY 2016, design is expected to start on the upgrades to the Santa Anita Booster
Station. Additionally, rehabilitation of the Monte Vista Well is expected to be completed. Other
well, booster pump, meters and switchgear will be upgraded as required.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to maintain a high level of service through more efficient
operation of our equipment.
IMPACT ON THE NORTHWEST: Portions of this project are located in Northwest Pasadena
which is an area targeted for revitalization.
HISTORY: This project was created and received initial funding in FY 1994. The project was
segmented into a multi-year phase starting in FY 2012. This is the new phase of this project for FY
2015 - 2020.
Responsible Department:
15.5 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Reservoir Improvements FY 2015 - 2020
1037
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
6 1037 Reservoir Improvements FY 2015 - 2020
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 12,116,365 696,365 820,000 600,000 2,000,000 7,000,000 1,000,000
Total 12,116,365 696,365 820,000 600,000 2,000,000 7,000,000 1,000,000
DESCRIPTION: This project will provide for major repairs and upgrades to the City's 15 existing
water tanks and reservoirs. Most of the tanks and reservoirs are over 60 years old. Examples of the
repairs and upgrades may include replacement of reservoir roofing, lining the reservoir floor with
hypaton liners, changing old outlet and inlet valves, seismic upgrades, and replacement of structural
supports.
JUSTIFICATION: The reservoir repairs will improve overall reservoir integrity, seismic stability,
and reduce or eliminate leaks.
SCHEDULE: In FY 2016, construction is expected to start on upgrades to Murray Hydro-
Pneumatic Zone and the design of the seismic upgrades to Sunset Reservoir.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to achieve a high level of maintenance for existing
facilities, and it is also consistent with the Seismic and Safety Element by minimizing losses due to
natural disasters.
HISTORY: This project was created and received initial funding in FY 1994. The project was
segmented into a multi-year phase starting in FY 2012. This is the new phase of this project for FY
2015 - 2020.
Responsible Department:
15.6 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Miscellaneous Water System Improvements FY 2015 - 2020
1006
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
7 1006 Miscellaneous Water System Improvements FY
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
2015 - 2020
Water Fund 2,263,072 323,072 340,000 400,000 400,000 400,000 400,000
Total 2,263,072 323,072 340,000 400,000 400,000 400,000 400,000
DESCRIPTION: This project provides for miscellaneous distribution, purification, pumping
plant, reservoir, ground water, gravity water, and general plant improvements to the water system at
various locations throughout the City.
JUSTIFICATION: This project is necessary to provide ongoing improvements as required to
maintain water quality, improve the security and appearance of physical plants and reservoirs, and
maintain adequate health standards.
SCHEDULE: In FY 2016 miscellaneous projects will be constructed and water mixing equipment
purchases and installations as required.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to ensure an adequate supply of safe potable water for
consumption and adequate water for fire protection.
HISTORY: This is an ongoing project that was created before 1980. The project was segmented
into a multi-year phase starting in FY 2012. This is the new phase of this project for FY 2015 -
2020.
Responsible Department:
15.7 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Management Information Systems - Water and Power Department FY 2015 - 2020
1025
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
8 1025 Management Information Systems - Water and
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Power Department FY 2015 - 2020
Water Fund 726,564 451,564 0 100,000 75,000 50,000 50,000
Total 726,564 451,564 0 100,000 75,000 50,000 50,000
DESCRIPTION: This project provides for the development, upgrade, and maintenance of local
area networks (LAN) at each of four departmental worksites; acquisition of equipment to
interconnect substations, water facilities, and existing networks; and integration of all information
critical to Water and Power (PWP) operations into the same, nonredundant database. It will further:
Install routers and firewalls in the Department's network structure;
Convert Water and Power documents and drawings to electronic format and
collect/validate field data;
Procure an Automated Data Collection/Bar Coding system for the Warehouse;
Convert the existing meter and transformer inventory system currently stored on the
HP into a client-server application; and
Clean existing data prior to beginning the conversion process.
JUSTIFICATION: The Department's October 1991 MIS study found that considerable time
savings, administrative and operational benefits would accrue if manual procedures were automated
and if existing "islands of automation" were integrated. This would eliminate large amounts of data
entry and re-entry performed by several groups, resulting in increased productivity and reduced
errors. The barcode project will save time and money by automating inventory utilizing hand-held
barcode readers and barcodes. These automated systems reduce time and labor required to perform
inventory counts and virtually eliminate data entry errors, thus enabling the department to collect
inventory accurately and efficiently at a lower cost and with greater integrity. The existing meter
and transformer inventory systems are outdated and not serving the department's current needs and
they need to be converted to a client-server type application.
SCHEDULE: The workplan for FY 2016 includes: vulnerability assessment (cyber
security/hacking) and implement assessment recommendations; IT upgrades pertaining to servers,
switches, data center utilities; SAN enhancements; and miscellaneous hardware/software upgrades.
Responsible Department:
15.8 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Management Information Systems - Water and Power Department FY 2015 - 2020
1025
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to provide a high level of service through more efficient
management of resources.
HISTORY: This project was originally created in FY 1991 and received initial funding in FY
1992. The project was segmented into a multi-year phase starting in FY 2012. This is the new
phase of this project for FY 2015 - 2020.
Responsible Department:
15.8 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Sunset Perchlorate Treatment Plant FY 2015 - 2020
1062
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
9 1062 Sunset Perchlorate Treatment Plant FY 2015 -
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
2020
Water Fund 1,189,959 669,959 220,000 150,000 50,000 50,000 50,000
Total 1,189,959 669,959 220,000 150,000 50,000 50,000 50,000
Responsible Department:
15.9 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Sunset Perchlorate Treatment Plant FY 2015 - 2020
1062
DESCRIPTION: This project provides for the design and construction of a perchlorate treatment
system, including a disinfection facility, for the Sunset Reservoir wells. Initially the plant will treat
Bangham, Copelin and Sunset wells. Garfield and Villa wells may not need treatment depending
on State Department of Health Services restrictions on blending and future maximum contaminate
level requirements. The Sunset Reservoir wells were shut down in January 2002 when the State
lowered its action level for perchlorate. An investigation is being conducted to determine the source
of the perchlorate contamination affecting the Sunset Wells. Improvements and remediation to the
contamination will be ongoing.
JUSTIFICATION: Treating the Sunset Reservoir wells is essential to control the spread of the
perchlorate contamination plume in the groundwater. With treatment the City can resume using its
local water resources.
SCHEDULE: Construction of the disinfection facility at Sunset Reservoir will continue through
the second quarter FY 2016. The construction was delayed in FY 2015 due to a breach of contract
(non-performance) and subsequent termination of the construction company originally hired. The
project has since been redesigned and efforts to select a new contractor are underway. Construction
is expected to resume in the fourth quarter of FY 2016.
Efforts to locate the source of the perchlorate contamination of the Sunset Wells will continue in
FY 2016 and are ongoing until final resolution. PWP will continue to negotiate with the JPL
technical and legal teams to develop the planning and data needed to move forward with the
construction of the perchlorate treatment system.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element Objective 1 by providing a high level of public service at minimum cost. The project is
also consistent with Objective 2 by providing a more efficient utilization of public facilities. In
addition, the project is consistent with Objective 5 by providing a high level of maintenance of
existing facilities.
IMPACT ON THE NORTHWEST: This project is located in Northwest Pasadena which is an
area targeted for revitalization.
HISTORY: This project was created and initially funded in FY 2005. The project was segmented
into a multi-year phase starting in FY 2016.
Responsible Department:
15.9 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Well Collector Pipelines
1044
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
10 1044 Well Collector Pipelines
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 12,609,718 12,609,718 0 0 0 0 0
Total 12,609,718 12,609,718 0 0 0 0 0
DESCRIPTION: This project provides for the collection of water from water wells through a
pipeline system and piping this water directly to reservoirs. There are two main collector pipelines.
The westside collector completed in 1999 conveys water flows from Garfield and Villa wells to
Sunset Reservoir. The eastside collector will convey water flows from Jourdan, Chapman,
Woodbury, Monte Vista, Craig, Twombly and Wadsworth wells to Jones Reservoir.
JUSTIFICATION: This project will allow the blending of well water in the reservoir to meet
current and future water quality regulations. Combining the well water flows will make future
water treatment of well water more efficient and less costly. Also, this project will eliminate any
entrained-air problems from wells.
SCHEDULE: Work in FY 2016 will include minor amounts of paving, calibration and monitoring
associated with the construction of the disinfection facility. This project is expected to be
completed in FY 2017.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to ensure an adequate supply of safe potable water for
consumption.
HISTORY: This project was created and received initial funding in FY 1998. The westside
collector pipeline was completed in 1999.
Responsible Department:
15.10 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Arroyo Spreading Basins and Intake Structures
1040
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
11 1040 Arroyo Spreading Basins and Intake Structures
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Proposition 84 2,791,579 0 550,000 2,026,579 215,000 0 0
Water Fund 7,798,791 2,222,870 1,070,000 3,973,421 485,000 35,000 12,500
Total 10,590,370 2,222,870 1,620,000 6,000,000 700,000 35,000 12,500
DESCRIPTION: This project provides for increased spreading of water runoff in the Arroyo
Seco.
JUSTIFICATION: This project will allow for the capture and spreading of water runoff in the
Arroyo Seco. The work allows for the diversion of water to the existing ponds for storage used for
groundwater recharge. In addition, it facilitates better management of local water resources and
may help to reduce reliance on expensive imported water.
SCHEDULE: Construction is expected to start in FY 2016 on the improvements to the Arroyo
spreading basins. Work will include demolition of the existing parking lot (previously utilized by
JPL employees), installation of 1/2 mile of distribution main, new recreational parking areas and
construction of new spreading grounds.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to ensure an adequate supply of safe potable water for
consumption and adequate water for fire protection.
IMPACT ON THE NORTHWEST: This project is located in Northwest Pasadena which is an
area targeted for revitalization.
HISTORY: This project was created in FY 1995 and received initial funding in FY 2001.
Responsible Department:
15.11 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Recycled Water
1013
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
12 1013 Recycled Water
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 17,885,564 13,885,564 0 1,000,000 1,000,000 1,000,000 1,000,000
Total 17,885,564 13,885,564 0 1,000,000 1,000,000 1,000,000 1,000,000
Responsible Department:
15.12 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Recycled Water
1013
DESCRIPTION: This project will involve an evaluation of potential sources to obtain recycled
water, a determination of use base, and design/construction of facilities and infrastructure to
provide and distribute recycled water. This includes the cost to participate in the expansion of the
City of Glendale's recycled water system (contribution ends in FY 2017). Phase 1 will serve four
customers (including Brookside Golf Course). The scope of work for this project will include the
installation of a pipeline and a storage facility at Sheldon Reservoir site to capture tunnel water and
store recycled water, and the installation of approximately 4.5 miles of 20" pipeline starting at the
Scholl Canyon in Glendale to the Art Center College, Brookside Golf Course, and ending at the
Brookside Park. The project will also include the evaluation and conversion of an existing drinking
water tank to recycled water or installation of a new 1.25 MG storage tank at Scholl Canyon, one
pressure reducing station on West Drive, and a 20" pipeline to Sheldon recycled water reservoir.
JUSTIFICATION: Future water supplies in Southern California are expected to be limited.
Recycled water can augment fresh water supplies through its use for golf courses, freeway
landscaping, parks, schools, large turf areas, and industrial processes.
SCHEDULE: Project design and EIR are expected to be completed in FY 2016 and necessary pre-
construction permits will be obtained. Should outside funding become available, construction is
expected to begin FY 2017 on Phase 1 of the non-potable/recycle water system. Phase 1 includes
the installation of piping from the Scholl Canyon reservoir, installation of a pressure reducing
station at West Drive, and installation of pipeline between Scholl Canyon and West Drive.
Management is actively seeking outside sources of funding (governmental grants and loans).
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the General Plan and
would allow the purchase of more economical water for specific use. It will also allow the
Department to utilize existing water resources efficiently, and it is consistent with Land Use
Element Objective 18 by increasing the efficiency of water use.
IMPACT ON THE NORTHWEST: Portions of this project are located in Northwest Pasadena
which is an area targeted for revitalization.
HISTORY: This project was created and received initial funding in FY 1993.
Responsible Department:
15.12 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Enterprise Resource Plan (ERP) - Water System
1072
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
13 1072 Enterprise Resource Plan (ERP) - Water System
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 638,244 380,618 199,405 58,221 0 0 0
Total 638,244 380,618 199,405 58,221 0 0 0
Responsible Department:
15.13 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Enterprise Resource Plan (ERP) - Water System
1072
DESCRIPTION: This project provides for the replacement of the water systems' portion of the
Enterprise Resource Planning (ERP) system that will seamlessly integrate all information from the
financial, human resources, payroll, and budget systems. The scope of this multi-year initiative
includes the analysis, selection, purchase and implementation of the software and hardware
necessary to replace and integrate these systems under a single ERP system.
JUSTIFICATION: The City of Pasadena's current financial system was implemented on July 1,
1997 and the current version is no longer supported by the vendor. In addition, various components
within this system are not integrated which results in numerous inconsistencies in the financial
information provided. Further, this system is not integrated with the human resources, payroll, and
budget systems. This non-integration requires extremely labor-intensive processes to validate the
information for accuracy, which results in an increased risk for human error.
An ERP system is a software package that can seamlessly integrate all information flowing through
an organization from a single information repository, including financial and accounting, human
resource information, payroll, budget, inventory, asset, customer information, and others. An ERP
system can deliver new management capabilities, improve operating efficiencies by streamlining or
eliminating inefficient manual processes, increase accuracy, and deliver real-time financial
information and reporting to City management. In the process, it will eliminate disparate stand-
alone systems, provide an opportunity to re-engineer processes with industry best practices and
templates, and establish a backbone structure that can be leveraged to handle all operational
processes.
SCHEDULE: The ERP is an enterprise project being coordinated through DoIT.
RELATIONSHIP TO THE GENERAL PLAN: This project is consistent with Public Facilities
Element Policy 202.0 by achieving a high level of public service through more efficient
management and greater work productivity.
SPECIAL CONSIDERATION: The budget includes the Water Fund's cost allocation for the
ERP project and additional PWP costs to build interface solutions to Tyler Munis.
HISTORY: This project was created as the Enterprise Resource Planning System (project 71149)
in FY 2013 and initially funded with Water Fund in FY 2015.
Responsible Department:
15.13 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Customer Information System
1011
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
14 1011 Customer Information System
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 2,589,585 965,585 0 650,000 550,000 224,000 200,000
Total 2,589,585 965,585 0 650,000 550,000 224,000 200,000
DESCRIPTION: This project provides for the purchase and implementation costs to acquire a
new Customer Information and Utility Billing System. The ECIS (Customer Information System)
utility billing system has been in place for 10 years and is not keeping up with technology. ECIS is
an aging legacy system that is losing its capability to keep up with newer technologies to improve
meter reading, billing, customer payment and collection.
JUSTIFICATION: The ECIS utility billing system is vital to the security and timeliness of
customer information, meter reads, billing, customer payment and collection. As the system ages
and its capabilities become limited, the system does not deliver the service and information
customers expect. Further, the current system is not flexible, which requires vendor support at an
hourly rate for any changes needed to be made by the Department.
SCHEDULE: The workplan for FY 2016 will include selection of a consultant to complete the
requirement definition, develop an RFP and evaluate responses for upgrade or replacement of the
utility billing system.
RELATIONSHIP TO THE GENERAL PLAN: This project is consistent with the Public
Facilities Element of the General Plan by helping maintain a high level of public service through
expanded services, efficient management and greater work productivity.
HISTORY: This project was created and received initial funding in FY 2000. One CIS system
software upgrade was completed in FY 2003, a second in FY 2007, and a third upgrade completed
in FY 2009.
Responsible Department:
15.14 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Water and Power Warehouse Modernization
1056
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
15 1056 Water and Power Warehouse Modernization
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 1,769,047 1,769,047 0 0 0 0 0
Total 1,769,047 1,769,047 0 0 0 0 0
DESCRIPTION: This project provides for the modernization of the warehouse including the
upgrading of the freight elevator. Included in this plan is the enhancement of the existing fire
sprinkler system along with installation of new fire alarms to bring the building up to code. These
changes will allow the warehouse to operate with maximum efficiency using a computer inventory
tracking system. Racks, shelving, and bin systems will be replaced as needed, or if deemed to be
seismically unsafe. Racking and shelving will be a combination of open and closed for maximum
space utilization. Grip pallet racks for oversized or heavier-weight items will be installed and
current open racks retrofitted for weight-bearing loads. Materials handling equipment including
pallet jacks, carts, dollies, basket hampers, coil lifters, etc. will be replaced as needed.
Ergonomically correct workstations will also be installed throughout the warehouse.
JUSTIFICATION: The warehouse has not had any significant upgrades in approximately 30
years. Racking systems inside the warehouse are inadequate, undersized, and not properly laid out
to provide for efficient storage and retrieval of inventory. Exterior racks in the yards are not up to
code for heavy loads and are seismically unsafe.
SCHEDULE: Work on existing warehouse building is scheduled to continue in FY 2016 for
Water utility functions.
RELATIONSHIP TO THE GENERAL PLAN: This project is consistent with the Public
Facilities Element of the General Plan by helping to maintain a high level of service through
efficient warehouse management and greater work productivity. It also provides a safe and secure
working environment for employees.
HISTORY: This project was created in FY 2003 and fully funded in FY 2012.
Responsible Department:
15.15 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Water Telemetry and On-Line Water Quality Detectors FY 2015 - 2020
1034
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
16 1034 Water Telemetry and On-Line Water Quality
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Detectors FY 2015 - 2020
Water Fund 374,398 154,398 20,000 50,000 50,000 50,000 50,000
Total 374,398 154,398 20,000 50,000 50,000 50,000 50,000
DESCRIPTION: This project provides for upgrading the existing Supervisory Control and Data
Acquisition (SCADA) system to make it more reliable under normal and major failure conditions.
JUSTIFICATION: The current SCADA system for the Water Division was implemented in FY
2001. The new system entails computer communication equipment, and instrumentation and
controls at remote water division sites. The system provides reliable, accurate, and additional water
system data through upgraded telemetry equipment and field instrumentation. It also provides more
reliable and expandable service, reduces manual reporting, and allows integration of software
programs such as inventory control and maintenance management.
SCHEDULE: SCADA upgrade to automate the communication process and related fine tuning
will continue into FY 2016.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to ensure an adequate supply of safe potable water for
consumption and adequate water for fire protection.
HISTORY: This project was created and received initial funding FY 1994.
Responsible Department:
15.16 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Geographic Information System - Water and Power Department
1009
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
17 1009 Geographic Information System - Water and
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Power Department
Water Fund 1,028,903 703,903 0 100,000 75,000 75,000 75,000
Total 1,028,903 703,903 0 100,000 75,000 75,000 75,000
DESCRIPTION: This project provides for the analysis, development, and procurement of a
departmental geographic information system (GIS) for the Water and Power Department. The base
map has been completed, followed by application development, hardware procurement and/or
procurement of custom off-the-shelf programs, and conversion of utility data.
JUSTIFICATION: The GIS will reduce the cost of maintaining manually produced and updated
maps and record systems. It will also reduce duplicate record keeping by different sections of the
department. In addition, it will provide greater reliability, faster data access, and more efficient
processing of information.
SCHEDULE: The FY 2016 workplan includes: web GIS enhancements; Mapplet implementation
for iOS; Water Mobile GIS enhancements; ESRI and ArcFM software training; and miscellaneous
upgrades.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to maintain a high level of public service through more
efficient management and greater work productivity.
HISTORY: This project was created before FY 1994 and received initial funding in FY 1994.
Responsible Department:
15.17 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Field Service Automation
1012
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
18 1012 Field Service Automation
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 538,678 318,678 0 55,000 55,000 55,000 55,000
Total 538,678 318,678 0 55,000 55,000 55,000 55,000
DESCRIPTION: This project provides for the following upgrades for the Customer Service Field
Service Group Meter Readers and Reconnect:
Automatic Meter Reads (AMR) - Radio Frequency Meter Reading Handheld Devices
and drive-by meter reading equipment
Upgrades of Meter Reading Software (MVRS)
Meter Reading Training Software
This project is expected to help automate to the extent possible, utility meter reading and reconnect
processes.
JUSTIFICATION: Upgrades to the Customer Service Meter Reading Operation will reduce the
operational costs of meter reading and help improve billing accuracy by enabling the department to
obtain accurate reads from the field. AMR water meters are being installed throughout the City.
Meter Reading Handheld devices are being upgraded and enabled to read regular water meters and
AMR water meters. MVRS Meter Reading Software is being upgraded to accommodate changes in
the upload and download of information from the billing system. Meter Reader Training Software
will be upgraded to provide meter readers with the latest training tools. Other forms of meter
reading such as drive-by and remote reading technology will be investigated for possible pilot
programs. Mobile dispatching of service orders will also be investigated for a possible pilot
program.
SCHEDULE: In FY 2016, workplan includes on-going projects for software and hardware
upgrades to meter reading handheld device, water probes, electric probes, and meter reading
software.
RELATIONSHIP TO THE GENERAL PLAN: This project is consistent with the Public
Facilities Element of the General Plan by helping to maintain a high level of public service through
expanded services, efficient management and greater work productivity.
HISTORY: This project was created and received initial funding in FY 2000.
Responsible Department:
15.18 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Monk Hill Perchlorate Treatment Plant
1063
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
19 1063 Monk Hill Perchlorate Treatment Plant
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Federal Funds - NASA 4,655,148 3,005,148 0 500,000 200,000 450,000 500,000
Total 4,655,148 3,005,148 0 500,000 200,000 450,000 500,000
DESCRIPTION: This project provides for the design and construction of a perchlorate treatment
system for the Monk Hill wells. The plant will treat Arroyo, Well 52, Windsor and Ventura wells.
Perchlorate was first detected June 1997, and by January 2002 all four wells were shut down when
the State lowered its action level for perchlorate.
JUSTIFICATION: Treating the Monk Hill wells will help control the spread of the perchlorate
contamination plume in the groundwater. With treatment, the City can continue using its local
water resources instead of relying on expensive imported water supplies. The responsible parties
will pay the cost of this groundwater treatment process.
SCHEDULE: The purchase of the Calgon perchlorate treating equipment for the Monk Hill
Treatment plant will occur in FY 2016. In addition, work will begin at the Monk Hill facility
during FY 2016 for the installation of a new backwash line and pipeline located in the former JPL
parking lot.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element Objective 1 by providing a high level of public service at minimum cost. The project is
also consistent with Objective 2 by providing a more efficient utilization of public facilities. In
addition, the project is consistent with Objective 5 by providing a high level of maintenance of
existing facilities.
IMPACT ON THE NORTHWEST: This project is located in Northwest Pasadena which is an
area targeted for revitalization.
HISTORY: This project was created and received initial funding in FY 2006.
Responsible Department:
15.19 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Radio Equipment Replacement
1065
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
20 1065 Radio Equipment Replacement
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 1,102,827 1,052,827 0 25,000 25,000 0 0
Total 1,102,827 1,052,827 0 25,000 25,000 0 0
DESCRIPTION: This project provides for the research, analysis, procurement, and
implementation of new digital radio equipment for Pasadena Water and Power (PWP) field
operations. This project will also look into incorporating mobile data terminal technology or
vehicle locator devices for PWP vehicles.
JUSTIFICATION: The existing radio equipment does not conform to the upcoming Federal
Communications Commission rule requirements. Therefore, PWP plans to replace existing
equipment with digital radio equipment that conforms to the new requirements.
SCHEDULE: In FY 2016, additional radios will be purchased as needed.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with Objective 4 of the
Public Facilities Element of the General Plan by helping to provide a high level of service and
greater work productivity by using available technology. This project is also consistent with Public
Facilities Objective 2 by providing more efficient development and utilization of public facilities.
HISTORY: This project was created and received initial funding in FY 2007.
Responsible Department:
15.20 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Interactive Voice Response System (IVR)
1016
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
21 1016 Interactive Voice Response System (IVR)
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 302,101 220,851 0 25,000 18,750 18,750 18,750
Total 302,101 220,851 0 25,000 18,750 18,750 18,750
DESCRIPTION: This project will provide for the Water Division's share of the procurement of
the Pasadena Water and Power's portion of an Interactive Voice Response/Interactive Web
Response (IVR/IWR) system.
JUSTIFICATION: The new IVR/IWR system will expand service to customers by providing
immediate alternatives for automated information access and payments as well as personal
assistance via telephone or the internet. It is an integral part of Pasadena Water and Power's effort
to increase customer service levels while reducing operating costs in a deregulated environment.
Integration of the IVR/IWR system with Orcom will bring call-back functionality to the system.
SCHEDULE: The workplan for FY 2016 is to procure hardware and software for voice activated
commands; convert a portion of the existing application to a conversation style IVR; and modify
options to accommodate Electronic Bill Presentment and Payment (EBPP) functions.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to maintain a high level of public services, efficient
management and greater work productivity.
HISTORY: This project was created and received initial funding in FY 1999.
Responsible Department:
15.21 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Devil's Gate Tunnels
1043
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
22 1043 Devil's Gate Tunnels
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 391,278 351,278 0 10,000 10,000 10,000 10,000
Total 391,278 351,278 0 10,000 10,000 10,000 10,000
Water flow from Devil's Gate Tunnel DESCRIPTION: This project will rehabilitate the Devil's Gate Tunnels, upgrade pumping
equipment to maximize the use of surface runoff water through Devil's Gate tunnels, and the
installation of a metering system for water diverted for irrigation.
JUSTIFICATION: Water from the Devil's Gate Tunnels can be diverted for irrigation at various
locations and will reduce the use of groundwater and/or the purchase of more expensive imported
water.
SCHEDULE: Work during FY 2016 will include the continued environmental monitoring,
mitigation and reporting, repairs to facility, and the calibration and testing of meters as part of this
CIP project.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to maintain a high level of service through more efficient
management of resources. It is also consistent with the Conservation Element by encouraging a
more efficient utilization of the City's water resources.
HISTORY: This project was created and received initial funding in FY 1996.
Responsible Department:
15.22 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Facility Security Systems
1054
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
23 1054 Facility Security Systems
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 1,172,636 372,636 0 300,000 400,000 50,000 50,000
Total 1,172,636 372,636 0 300,000 400,000 50,000 50,000
DESCRIPTION: This project will provide for new security systems and upgrades to existing
security systems at all water facilities. These security systems include: new video monitoring
systems; electronic keying devices; security lighting; intrusion alarm upgrades; perimeter protection
upgrades; and gate entry protection upgrades.
JUSTIFICATION: This project will provide security systems at all water facilities consistent with
accepted industry standards. These security systems will reduce the water system's exposure to
security breaches.
SCHEDULE: Work planned in FY 2016 will include a study to develop the scope of work
necessary for the upgrade of security systems at all Water facilities, including new security
cameras, motion detectors, keycard access and installation of new gate entry systems.
RELATIONSHIP TO THE GENERAL PLAN: This project is consistent with the Public
Facilities Element of the General Plan by helping to provide a high level of public service through
more efficient management of resources.
HISTORY: This project was created and received initial funding in FY 2003.
Responsible Department:
15.23 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
New Well Projects (Conjunctive Use)
1021
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
24 1021 New Well Projects (Conjunctive Use)
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 3,275,880 275,880 0 85,000 2,915,000 0 0
Total 3,275,880 275,880 0 85,000 2,915,000 0 0
DESCRIPTION: This project will provide for drilling new groundwater wells and recovery wells
and capital facilities that could include aquifer recharge and storage. Recovery wells allow for
injection of water into the groundwater aquifer. Groundwater wells have a useful life of
approximately 100 years. Many of the Water and Power wells are at the end of their usefull life.
Drilling new wells will serve to replace existing older wells.
JUSTIFICATION: The option of refilling natural aquifers with injection or percolation is of
increased in importance, particularly during long-term dought conditions. Economies of scale will
be realized from efficient use of the available storage space in the underlying groundwater basin,
and at the same time improve the reliability of water supplies during periods of drought.
SCHEDULE: No work is anticipated for FY 2016. Work is expected to begin FY 2017 on a
feasibility study to determine the best location for the installation of a new groundwater well.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to maintain a high level of service through more efficient
management of resources. It is also consistent with the Conservation element by encouraging a
more efficient utilization of the City's water resources.
OPERATING BUDGET IMPACT: The wells will permit greater purchases of MWD water at
reduced rates. The result will be a reduction in annual operating expenses.
HISTORY: This project was created and received initial funding in FY 1992.
Responsible Department:
15.24 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Water Quality Treatment
1041
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
25 1041 Water Quality Treatment
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 394,459 394,459 0 0 0 0 0
Total 394,459 394,459 0 0 0 0 0
DESCRIPTION: This project provides for the design, engineering, and construction of facilities
to treat Pasadena area water for increasing contaminant levels (nitrate, perchlorate, etc.).
JUSTIFICATION: Pasadena wells are slowly showing increasing contaminant levels and will
exceed State maximum contaminant levels in the near future. These facilities will treat the local
well water. Local well water is cheaper than imported water.
SCHEDULE: Work is expected to begin on a study to explore the best method of biological
treatment for nitrates and perchlorates at various wells.
RELATIONSHIP TO GENERAL PLAN: This project is consistent with the Public Facilities
Element of the General Plan by helping to ensure an adequate supply of safe potable water for
consumption.
HISTORY: This project was created and received initial funding in FY 1996.
Responsible Department:
15.25 Water and Power DepartmentFY 2016 - 2020 Capital Improvement Program
Water System
Enterprise Content Management System
1071
Priority Project No. Description Total Appropriated Proposed
Estimated Through Adopted Proposed Proposed Proposed FY 2020
26 1071 Enterprise Content Management System
Costs FY 2015 FY 2016 FY 2017 FY 2018 FY 2019 and Beyond
Water Fund 97,300 97,300 0 0 0 0 0
Total 97,300 97,300 0 0 0 0 0
DESCRIPTION: This project provides for the replacement of the document imaging and records
management system. The replacement system, an Enterprise Content Management (ECM) system
is expected to be used by all departments for document management needs and provide the
following core feature functions: document imaging, content management, records management, e-
forms, e-signatures, and automated workflow. The project will include the development of a
standard taxonomy (document indexing scheme) and updated records retention schedules based on
the taxonomy established per department.
JUSTIFICATION: The current imaging and records management system, which is an electronic
repository for all official City records, birth certificates, and planning and building permits, requires
replacement after nearly ten years in service. In addition, nearly every City department identified
document imaging, records management, automated workflow and e-forms as an efficiency and
cost savings solution during the development of the Five-Year IT Strategic Plan. Electronic
management of documents and other forms of content reduces the need for physical storage space,
which reduces office space requirements and storage fees. Staff performing clerical duties such as
copying and filing can be redirected to perform higher level functions and paper based processes
and routing can be streamlined using automated workflow. Compliance with records and archiving
policies will be greatly improved with features that include audit trails, permissions and digital
signatures.
SCHEDULE: No work is scheduled for FY 2016.
RELATIONSHIP TO THE GENERAL PLAN: This project is consistent with the Public
Facilities Element Policy 202.0 by providing a high level of public service through more efficient
management and greater work productivity.
SPECIAL CONSIDERATION: This project is also shown in the Electric System (Project 3204)
and Technology Projects Sections. The appropriate dollar amount is not included in the Category
Summary total for the Technology Projects Section to avoid duplication. This project sheet is the
Water System's portion of a larger project. The total estimated project cost is $400,000.
HISTORY: This project was created and fully funded in FY 2013.
Responsible Department:
15.26 Water and Power DepartmentYou can also read
