System Status Briefing (April – June 2016) BRIAN MOLEFE Group Chief Executive July 2016 CONFIDENTIAL
Contents 1 Operational highlights 2 Distribution Overview 3 Generation Performance 4 Outlook 5 New build update 6 Majuba power station silo & Duvha unit 3 updates 7 Conclusion
Overview of Eskom’s electricity value chain Distribution challenges Generation Stable, no load shedding Transmission Stable, no major incidents Stable with localised Distribution faults Mining, Metros and large industry Total Distribution 5,689 million Customers Industry, commercial and farming Supply to municipalities and residential 3
We continue to experience overall excellent operational performance • Eskom has sufficient Generation capacity to meet the peak demand, due to improved energy availability factor; currently the year-to-date figure stands at 78.9 %. In the next five years Eskom will add an additional 8 169 MW capacity from our current new build project • On the Transmission side, we have excellent performance year-to-date with no system minutes incidents greater than 1 • Distribution network performance (SAIFI and SAIDI) within acceptable limits, however we have localised incidents due to illegal connections, theft and plant failure, which are being addressed 4
Contents 1 Operational highlights 2 Distribution Overview 3 Generation Performance 4 Outlook 5 New build update 6 Majuba power station silo & Duvha unit 3 updates 7 Conclusion
Eskom continues to work hard to speedily restore and stabilise the Distribution network around the country • In the past few weeks Eskom Distribution has experienced a number of localized power outages • The key causes of the power outages are illegal connections which result in the overloading of our networks, cable theft and the vandalism of electricity infrastructure • Technical faults and routine planned maintenance also result in power interruptions • Eskom responded by replacing damaged or failed equipment and in some cases upgrading the infrastructure, this approach has proven not to be sustainable
Over the past few weeks, the Eskom team has worked hard to restore and stabilise the Distribution network in Gauteng Hot spots identified Key cause and impact of outages Remedial actions undertaken • Illegal connection and • Stabilise overloading • Repaired and replaced 31 mini Soweto substations and 287 transformers: • Cable theft and vandalism o 61 transformers in Soweto o 44 Trf in Randfontein o 16 transformer in Sandton Kagiso o 42 transformer in Midrand o 45 transformer in Ekhureleni o 42 transformer in the Vaal Katlehong o 36 transformer in Tshwane • Breaker trips – reset breaker, upgrade • Plant failure and split the network • Upgraded & replaced damaged cables Mamelodi • Proactively engaged with affected • About 5 mini sub-stations fail a communities day Bophelong Note: Approximately 250- 500 people impacted when a mini sub-station fails 7
Background and impact of illegal connections, theft and vandalism Areas such as Soweto, Kathlehong, Diepsloot, Bramfischerville, Sebokeng have been mostly affected by localised outages. The design philosophy on these townships was done with a maximum demand of 2kVA per stand, however illegal connections overload the transformers, resulting in failures These areas are infested with illegal connections, back yard shacks, bypassed meters and vandalised pillar boxes resulting in network overloading and thus causing localised power failures. These factors cause equipment to operate above their maximum rated or operating parameters thus reduces the life’s span of the equipment 8

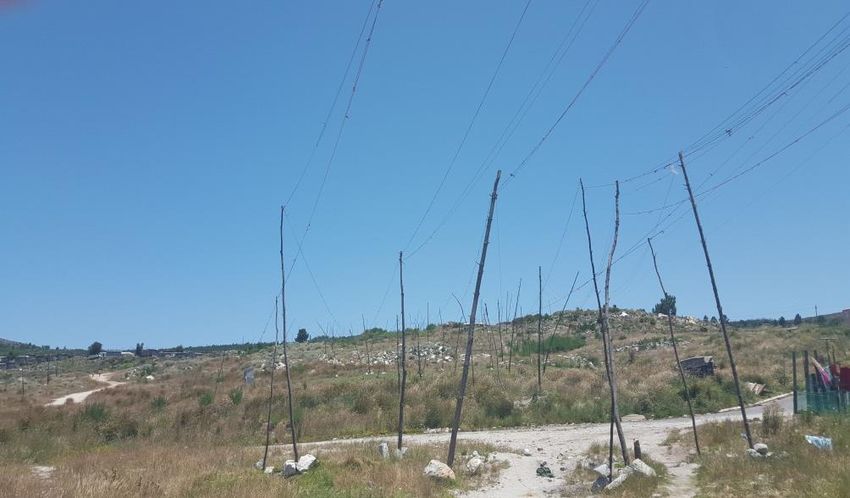

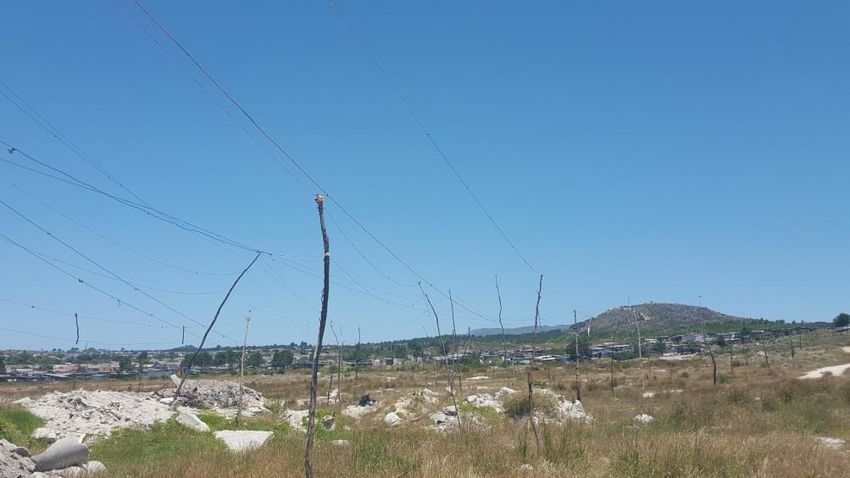

Pictures taken to illustrate the severity of illegal connections in the Western Cape – 18 July 2016 Illegal connections Illegal power lines 9
Overloading caused by backyard dwellers increasing demand on the network Assumption and analysis: Assuming that Diepsloot has 2000 stands with an average of 6 backyard dwellers per stand Instead of 2000, the area has now yielded 12 000 dwellings Original design capacity of 4MVA (Based on 2000 stands), increased to 24MVA as a result Eight shacks can be seen in the photo This will result in continuous trips of the transformers feeding this households The back yard dwellings (with an observed ratio of 1: 8 average) , pose a risk to the infrastructures and provision of reliable electricity. Protective Structures are damaged, forcefully There are 15 rooms in this house all illegally connected opened and metering equipment is bypassed 10

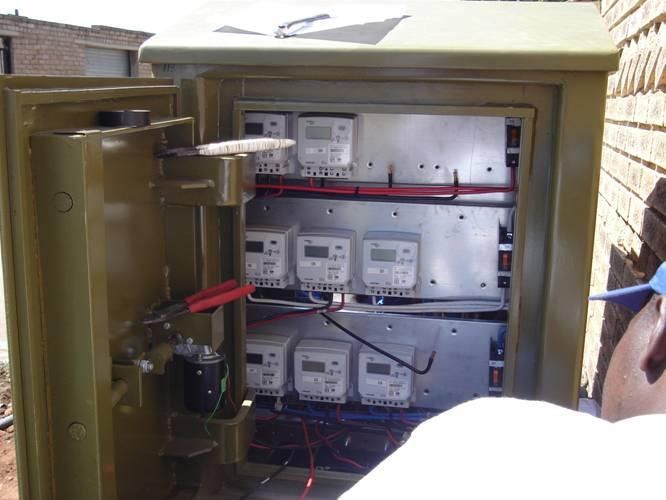

Immediate response to this problem Eskom responded by replacing damaged or failed equipment and in some cases upgrading the infrastructure, this approach has proven not to be sustainable. Other Interventions included the installation of protective structures, replacement of burnt fuses, retention of sagging conductors and load balancing on phases which are all costly solutions. Developed community partnerships and intensified training (develop sense of ownership). As part of network maintenance all open pillar boxes are closed and damaged infrastructure is normalised. Increased security measures to deal with fraud related to meter bypasses and conductor theft. 11 11
Sustainable solutions • A three-pronged approached has been developed to recover, stabilise and improve the performance of the electricity network. • Eskom remains committed in ensuring that customers have a continuity of supply and ensuring a sustainable solution to the current challenges. • It is also important for communities to support our efforts towards removal of illegal connections and installation of smart meters so as to ensure that we can accelerate the overall service level improvement. • Eskom customers are urged to report electrical faults at 08600 37566
Contents 1 Operational highlights 2 Distribution Overview 3 Generation Performance 4 Outlook 5 New build update 6 Majuba power station silo & Duvha unit 3 updates 7 Conclusion
Performance Highlights for Q1 F2017(1/2) Description Maintenance • No load shedding has been implemented since August 2015 without load (except for 2 hours and 20 minutes) shedding • Average planned maintenance (PCLF) for Q1 F2017 is 11.11 % • OCGT energy sent out has decreased from 1 801 GWh in Q1 F2016 to 16 GWh Q1 F2017, which is a 98% decrease in energy Low diesel from diesel generators usage and spend • This resulted in a decrease in diesel costs from R 3.9 bn to R 86 m from when comparing Q1 F2016 and Q1 F2017 which is a 98% decrease in diesel spend
Performance Highlights for Q1 F2017 (2/2) Description • Energy availability reached record highs of 81 % for the month of June. This was last achieved in July 2013. Increased • The energy availability has increased from 69.6 % (Q1 F2016) to availability 78.6 % (Q1 F2017) which translates into an additional 3 775 MW of extra power made available from the improvements made in the existing fleet • Eskom has been able to meet demand this financial year even during Demand and the weeks where demand was higher than last year Sales • Eskom has increased cross boarder sale by 33% when comparing the energy (GWh) sent out
Plant performance has been improving considerably since October 2015 Performance over the past nine months Percentage Breakdowns1 Planned maintenance Available energy Insights 12,9 12,0 9,6 9,3 9,5 18,0 17,4 14,7 17,0 15,6 • For the month of 9,7 9,7 June 2016, energy 11,5 availability 12,9 12,1 16,0 11,2 9,8 reached record 12,0 12,3 highs of 81 % for the month of June 2016 ,this was last achieved in July 2013 78,9 81,0 80,8 71,8 74,7 74,2 75,9 • During the last 70,0 70,3 69,3 quarter planned maintenance exceeds unplanned breakdowns Oct-15 Nov-15 Dec-15 Jan-16 Feb-16 Mar-16 Apr-16 16-May Jun-16 Jul-16 1 - Includes breakdowns and other non plant losses 16 2 – month to date performance on 17 July 2016
OCGT usage and costs have both decreased as a result of improved Generation availability OCGT performance over the past nine months GWh Energy Send Out (GWh) 400 381,2 Insights 350 • Improvements in 300 286,7 EAF have resulted in lower usage of 250 diesel and hence a reduction in the 200 180,3 costs • For Q1 2017, YTD 150 savings in diesel 100,1 costs is R 649.6 100 million 50 • Dispatching the 21,2 diesel generators 6,6 6,3 4,8 5,0 1,7 0 less frequently, Oct Nov Dec Jan Feb Mar Apr May Jun Jul1 has resulted in a decrease in maintenance Load 21 16 10 5.6 1.3 0.4 0.4 0.3 0.3 0.2 intervals, which is Factor (%) a further decrease in Cost (R’m) 854 555 278 187 62 25 25 46 14 5.8 maintenance cost 1 – month to date performance on 04 July 2016 17
The improved performance of the Eskom plant is not due to lower demand Daily peak demand compared to available capacity Megawatts 2 2 Insights • The available capacity is significantly higher than the capacity available last year • The available capacity this year is greater than the peak demand last year and that of this year • This means that if we had this year’s capacity available last year we would have avoided load shedding last year 1 – improvements made in energy availability and capacity from Medupi 6 and Ingula 4 2 – Excluding IPP’s however including Cahora Bassa 18
Comparison of how the highest peak demand was met in 2015 vs 2016 Build up of how peak demand is met Megawatts IPP Support OCGT Eskom (Excl Gas) Mandatory Demand Reductions Contracted Demand Reductions1 Insights 34481 34899 • The peak demand in 2015 333 779 0 0 could not be met and 1121 2514 required 2500MW of mandatory demand reduction as well as 2242 2250MW of OCGT usage. 358 • The peak demand so far in 2016 was supplied 32999 without any mandatory 29034 demand reduction or OCGT usage. • This was possible due to the Eskom generation availability being 4000MW higher in 2016 than in 11 Jun 2015 30 May 2016 2015 during the annual peak 1- Virtual power station or interruptible load supply agreements 19
With Eskom’s excess capacity, we have increased our exports Break down of Southern African Power Pool (SAPP) Sales per customer SAPP Sales (GWh) EDM CEC ZESA SEC Insights into Quarterly sales ORC ZESCO Skorpion BPC LEC DAM NamPower Motraco • Eskom has firm cross border sales to end-use customers which have 3,955 remained fairly constant at ~ 2 200GWh, increasing by 70GWh • The firm and non-firm sales to utilities has increased by 2,984 ~ 900GWh • The total cross-border sales increased by 970GWh • Eskom supply is making an increasing and positive contribution to support the economies of SADC and to offset the impact of the drought on the Kariba power station • With progressive additional capacity coming online in South Africa Eskom will be reviewing the exports with a view to assess future sustainability Q4 2015 Q4 2016
Contents 1 Operational highlights 2 Distribution Overview 3 Generation Performance 4 Outlook 5 New build update 6 Majuba power station silo & Duvha unit 3 updates 7 Conclusion
Outlook Tetris Maintenance Plan • Our prognosis for winter and beyond is that there will be no load shedding • Eskom is progressing well with the maintenance of its power generating plant whilst supplying the country’s electricity needs, while also minimising usage of open cycle gas turbines • Eskom is targeting a maintenance budget: • 8 500 MW in Winter • 11 500 MW in Summer • Renewable energy will continue to contribute up to Photovoltaic 900 MW and wind 880 MW of the total installed capacity of 2 310 MW of electricity generated during the day from solar and wind including Eskom’s Sere wind farm
The Tetris plan indicates no loadshedding for the remainder of the year Available Capacity Operating Reserves PCLF UCLF Peak Demand Installed Capacity 45000 Installed Capacity is the total generating capacity from Eskom’s Winter UCLF Summer UCLF combined fleet 5500 MW Plant Breakdowns 6500 MW 40000 Plant Breakdowns: from the available capacity we subtract the anticipated breakdowns 35000 Planned Maintenance Operating Reserve Planned Maintenance: from this we also need to subtract the planned maintenance Operating Reserve: 2000 MW buffer to cater for sudden 30000 Increase in load or if generating units are lost Peak Demand: the forecasted demand does not exceed the available capacity and we still have the 2000 MW of operating 25000 reserve as a buffer. Therefore the prognosis is no load Available Capacity shedding for the remainder of the year Available Capacity: the capacity available to meet the demand we now have to superimpose the demand forecast for the year to compare it with the this available capacity. 20000 Jul Aug Sep Oct Nov Dec Jan Feb Mar 2016 2017 Tetris V4.20
1 Planned Maintenance – July to September 2016 Available Capacity = Installed Capacity - Peak Demand - UCLF Eskom is targeting a maintenance budget of 8.5 GW for Winter months 9000 8000 7000 6000 Operating Reserve Drakensberg 1 Kendal 6 Matla 3 5000 Camden 1 Hendrina 10 Lethabo 3 4000 Port Rex 3 Koeberg 1 Hendrina 8 Gariep 4 HCB 1 Drakensberg 4 Komati 5 Duvha 5 Komati 7 Hendrina 1 Majuba 3 3000 Tutuka 4 Tutuka 3 Lethabo 1 Ankerlig 3 Tutuka 6 Ankerlig 4 Kriel 3 2000 Matimba 4 Grootvlei 6 Grootvlei 1 Grootvlei 2 1000 Kendal 5 Arnot 1 Komati 3 Camden 2 0 Hendrina 7 18-Jul 20-Jul 22-Jul 24-Jul 26-Jul 28-Jul 30-Jul 02-Sep 04-Sep 06-Sep 08-Sep 10-Sep 12-Sep 14-Sep 16-Sep 18-Sep 20-Sep 22-Sep 24-Sep 26-Sep 28-Sep 30-Sep 01-Aug 03-Aug 05-Aug 07-Aug 09-Aug 11-Aug 13-Aug 15-Aug 17-Aug 19-Aug 21-Aug 23-Aug 25-Aug 27-Aug 29-Aug 31-Aug Jul Aug 2016 Sep The no loadshedding plan allows for available capacity as we seldom dip into the operating reserves 24 Source: Tetris Plan V4.20
2 Planned Maintenance – October to December 2016 Available Capacity = Installed Capacity - Peak Demand - UCLF Eskom is targeting a maintenance budget of 11.5 GW for summer months 9000 8000 7000 6000 Operating Reserve Tutuka 5 Tutuka 1 Tutuka 6 Matimba 3 Hendrina 4 Ankerlig 3 HCB 1 Majuba 4 Kriel 1 5000 Duvha 2 Matla 3 Hendrina 2 Majuba 2 Duvha 6 Kendal 1 Vanderkloof 1 Drakensberg 1 Hendrina 7 Komati 4 Komati 6 4000 Lethabo 6 Kendal 5 Koeberg 1 Komati 7 Ankerlig 1 Matla 2 3000 Majuba 3 Lethabo 5 Matimba 6 Gourikwa 1 2000 Tutuka 4 Medupi 6 Kriel 4 1000 Drakensberg 2 Camden 1 Hendrina 10 Hendrina 1 Grootvlei 2 Camden 2 Komati 3 0 01-Oct 03-Oct 05-Oct 07-Oct 09-Oct 11-Oct 13-Oct 15-Oct 17-Oct 19-Oct 21-Oct 23-Oct 25-Oct 27-Oct 29-Oct 31-Oct 02-Dec 04-Dec 06-Dec 08-Dec 10-Dec 12-Dec 14-Dec 16-Dec 18-Dec 20-Dec 22-Dec 24-Dec 26-Dec 28-Dec 30-Dec 02-Nov 04-Nov 06-Nov 08-Nov 10-Nov 12-Nov 14-Nov 16-Nov 18-Nov 20-Nov 22-Nov 24-Nov 26-Nov 28-Nov 30-Nov Oct Nov Dec 2016 The no loadshedding plan allows for available capacity 2016 as we seldom dip into the operating reserves 2 Source: Tetris Plan V4.20
3 Planned Maintenance – January to March 2017 Available Capacity = Installed Capacity - Peak Demand - UCLF Eskom is targeting a maintenance budget of 11.5 GW for summer months 8000 7000 6000 5000 Operating Reserve Majuba 1 Duvha 2 Tutuka 3 Kendal 6 Matla 1 Hendrina 4 Tutuka 6 Hendrina 5 4000 Grootvlei 2 Camden 2 Tutuka 5 Koeberg 2 Kendal 2 Kendal 1 Lethabo 4 Gourikwa 2 Matla 4 3000 Ankerlig 5 Gourikwa 3 Kriel 5 Kriel 4 Ankerlig 7 Matimba 2 Matimba 1 Kriel 1 Hendrina 2 2000 Palmiet 2 Grootvlei4 Lethabo 6 Arnot 5 Matla 2 Komati 6 Hendrina 1 1000 Kriel 2 Hendrina 3 Hendrina 10 Drakensberg 2 0 Camden 1 01-Jan 03-Jan 05-Jan 07-Jan 09-Jan 11-Jan 13-Jan 15-Jan 17-Jan 19-Jan 21-Jan 23-Jan 25-Jan 27-Jan 29-Jan 31-Jan 02-Feb 04-Feb 06-Feb 08-Feb 10-Feb 12-Feb 14-Feb 16-Feb 18-Feb 20-Feb 22-Feb 24-Feb 26-Feb 28-Feb 02-Mar 04-Mar 06-Mar 08-Mar 10-Mar 12-Mar 14-Mar 16-Mar 18-Mar 20-Mar 22-Mar 24-Mar 26-Mar 28-Mar 30-Mar Jan Feb Mar 2017 2 The no loadshedding plan allows for available capacity as we seldom dip into the operating reserves 6 Source: Tetris Plan V4.19
Contents 1 Operational highlights 2 Distribution Overview 3 Generation Performance 4 Outlook 5 New build update 6 Majuba power station silo & Duvha unit 3 updates 7 Conclusion
New Build Update (1/2) • Medupi Unit 6 was commissioned on 23 August 2015, adding 794 MW to the national grid. • Since the previous update, the turbine on barring, first oil fire and first coal fire milestones were achieved on Medupi Unit 5, which are important milestones towards boiler blow through, first synchronisation and ultimately commercial operation of the unit. • Medupi Unit 5 is expected to be commercially operational in March 2018 (P80). • Eskom has managed to synchronise all Ingula units to the national grid, ahead of schedule. The last two units (2 &1) were synchronised on 21 May and 16 June 2016 respectively. • lngula Unit 4 was successfully commissioned on 10 June 2016, adding 333 MW to South Africa’s electricity grid. • Repairs on Ingula Unit 3 are progressing well and all the remaining Ingula units (3, 2 & 1) are on track for commercial operation during 2017
New Build Update (2/2) • Kusile power station continues to achieve set milestones on the path for Unit 1 commercial operation, recently completing the draught group run milestone on 11 June 2016. • Kusile Unit 1 is expected to be commercially operational in July 2018 (P80). • At the end of May 2016, 10.1 km’s of transmission lines have been constructed and 800 MVA’s of substation capacity commissioned for 2016/17 financial year. The targets for 2016/17 FY are 525 km’s and 1 800 MVA. • Since inception in 2005, the capacity expansion programme so far added 7 364 MW of generation capacity, 6 162 km of transmission lines and 32 890 MVA of substation capacity to the national grid.
We remain focused on bringing new capacity online P80 dates CO = commercial operation CO achieved in CO in Mar 2015 CO in Aug 2015 Jun 16 CO by Jul 2017 CO by Jul 2018 100 794 333 333 800 Mar 2015 Aug 2015 Jun 16 Jul 2017 Jul 2018 5 620MW Sere Wind Farm Medupi Unit 6 Ingula Unit 4 Ingula Unit 1 Kusile Unit 1 Post MYPD 3 Mar 2015 Jan 2017 May 2017 Mar 2018 2019/20 Majuba recovery Ingula Unit 3 Ingula Unit 2 Medupi Unit 5 Duvha Unit 3 1200 333 333 794 600 600MW from Unit 3 gap CO by Jan 2017 CO by May 2017 CO by Mar 2018 Fully recovered solution in Feb 2015 Project falls outside 600MW from Unit 4 in MYPD3 window Mar 2015
New capacity will fuel the South African economy Additional MW to be added to the South African grid Installed capacity (MW) Medupi + Sere Ingula Insights Kusile Current capacity • Eskom is 55,000 53,389 51,789 52,589 progressively 50,195 4,864 adding capacity 50,000 4,864 47,807 4,864 over the next 4,070 45,419 2,482 3,200 4,000 seven years 45,000 44 420 1,600 2,400 894 800 1227 1,332 1,332 1,332 1,332 1,332 1,332 • Ingula will be 40,000 40,000 fully commissioned in 35,000 2017 43,193 43,193 43,193 43,193 43,193 43,193 43,193 • Medupi will be fully commissioned by 10,000 2020 5,000 • Kusile will be fully commissioned by 0 2016 2017 2018 2019 2020 2021 2022 2022
Contents 1 Operational highlights 2 Distribution Overview 3 Generation Performance 4 Outlook 5 New build update 6 Majuba power station silo & Duvha unit 3 updates 7 Conclusion
Majuba Power Station silo & Duvha Unit 3 update Majuba Permanent solution Duvha unit 3 update • Good progress continues on delivering • The contract negotiations for the the permanent solution for the recovery rebuild portion of the scope have been of the coal silo at Majuba. terminated. • Completion is on track for end December • The supplier was unable to meet the 2017 (P80) conditions precedent to enable • Plans to accelerate completion are in agreement on the contract. place and progressing well • Eskom has appointed suppliers who will commence with the structural assessments and repairs scope of work. Based on the current works schedule no additional delay is foreseen • Eskom will commence in a new commercial process. Management is yet to approve initiation of the new commercial process.
Contents 1 Operational highlights 2 Distribution Overview 3 Generation Performance 4 Outlook 5 New build update 6 Majuba power station silo & Duvha unit 3 updates 7 Conclusion
Conclusion • Eskom has stabilised and to date we have not implemented load shedding in almost 11 months (except for 2 hours and 20 minutes) • We are ensuring that power supply remains unconstrained through our maintenance programme • We are also aggressively executing the capital build programme which will increase our generation capacity. • Eskom has worked hard to restore and stabilise the electricity distribution network around the country, and we remain committed in ensuring that customers have a continuous supply of electricity.
