Roadmap for the early implementation of the Capacity Allocation Mechanisms Network Code - Update of October 2013
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
Roadmap for the early implementation of the Capacity Allocation Mechanisms Network Code Update of October 2013
Content 1. Executive Summary ......................................................................................................... 3 2. Background..................................................................................................................... 6 3. Governing Arrangements ................................................................................................ 7 3.1. Need to update the current governing structure ................................................................. 7 3.2. Roles and responsibilities within the new framework .......................................................... 8 4. Implementation ............................................................................................................. 11 4.1. Scope of projects related to CAM NC provisions ................................................................ 11 4.2. Implementation timelines at project level.......................................................................... 16 4.3. Geographical scope of the projects .................................................................................... 19 4.4. Review of issues related to CAM implementation challenges............................................ 20 4.5. Review of lessons learned, solutions adopted and open questions arising during CAM NC early implementation ...................................................................................................................294 4.6. Key factors for success in early implementation of CAM ................................................... 29 ANNEX 1: Pilot Projects Main Features .................................................................................. 31 ANNEX 2: Early implementation of CAM NC per Interconnection Point .................................. 43 Page 2 of 46
1. Executive Summary The XXI Madrid Forum of 22-23 March 2012 called upon “TSOs, with the full involvement of relevant NRAs and Member States, to work towards setting up a number of regional pilot projects and regional pilot platforms” for the early implementation of the Network Code on Capacity Allocation Mechanisms (hereafter the CAM NC). A draft Roadmap was presented at the XXII Madrid Forum of 2-3 October 2012. Participants invited ACER and ENTSOG “to promote the convergence of the ongoing projects to avoid duplication of costs, as well as to report on progress of implementation at its next sessions”. The CAM Roadmap was published on 1 March 2013 on ACER and ENTSOG websites1 and presented at the XXIII Madrid Forum of April 2013. The Forum welcomed the CAM Roadmap and encouraged ACER and ENTSOG to “continue the work in close cooperation with the relevant stakeholders by e.g. collecting and documenting common problems and best practices to enable efficient solutions.” This updated version of the CAM Roadmap presents the state of play of pilot projects for the early implementation of the CAM NC, including the implementation of key provisions of the CAM NC at interconnection points. This updated Roadmap also contains information on the valuable experience gained from the solutions adopted and the open questions shared by the participants in the pilot projects during the first quarters of 2013. All parties involved – ACER, ENTSOG, European Commission, TSOs and NRAs – have cooperated closely in this update of the Roadmap, starting from the experience gained through the existing CAM pilot projects. Early implementation of the CAM NC provisions can potentially promote, on the one hand, significant progress towards the internal market by 2014 and, on the other hand, opportunities to share knowledge about the experience gained from voluntary early implementation through pilot projects before the CAM NC provisions become binding on 1 November 2015. The Roadmap aims to support this knowledge sharing by: Providing background information about the Roadmap elaboration process, by describing when and how it was decided to carry out such a Roadmap and the main steps of the process leading to its development; Outlining the organisational arrangements that can help to oversee and facilitate the implementation process during the implementation of pilot projects; 1 http://www.acer.europa.eu/Gas/Regional_%20Intiatives/CAM_roadmap/Pages/default.aspx http://www.entsog.eu/public/uploads/files/publications/CAM%20Network%20Code/2013/a)%20CAM%20Roadma p%20-%20Final%20version%20010313%20-%20v2.pdf Page 3 of 46
Describing roles and responsibilities for all parties involved in developing and facilitating pilot projects; Providing an overview of this implementation process: o reporting on how current projects are implementing key provisions of the CAM NC; o reporting at the level of interconnection points which firm standard capacity products (where available) are being offered and how they are being offered in the course of early implementation (included in this updated version of the Roadmap); Mapping the geographical scope of the projects; Reporting the implementation challenges and issues identified by project participants; Listing key factors that have been identified as contributing to the success of early implementation efforts; Eventually enabling the convergence of current (or yet to be started) pilot projects towards integrated solutions. The CAM Roadmap is structured in two main parts. It first focuses on the governance of the pilot projects i.e. how all parties involved will relate and communicate in order to monitor and facilitate these projects, while in the second part details on the implementation of the pilot projects are provided. As explained above, the first version of the CAM Roadmap was published in March 2013 and is now updated including information on recent developments of the projects. This document will be updated periodically to reflect progress in the early implementation of the CAM NC. The diagram in Figure 1 is intended to give an overview of the main steps and targets to be reached until the end of 2013, as part of the early implementation of the CAM NC within the EU. These include: Key milestones in the pilot projects forming the building blocks for this Roadmap (more details in section 2); and Steps envisaged as part of the governance process, to support the projects in attaining their goals (more details in section 1). Page 4 of 46
Figure 1 – Key achievements in early implementation and planned targets until the end of 2013 Page 5 of 46
2. Background The Roadmap has the goal of fostering the early implementation of the provisions from the Network Code on capacity allocation mechanisms (CAM NC), before it becomes legally binding on 1 November 2015 after its adoption through the so-called Comitology process in 2013. For that purpose, the Roadmap identifies and monitors sequential steps of implementation through pilot projects at cross-border interconnection points in EU Member States, which will test the NC provisions, hence paving the way towards the timely implementation of the CAM NC across Europe. The early implementation is a voluntary process and relies on the commitment of TSOs and NRAs involved in the pilot projects, as well as on the support of ACER, ENTSOG, the European Commission and stakeholders. Early implementation of CAM NC is offering the opportunity to draw lessons from the experience gained during pilot projects’ implementation in order to support and encourage further work and therefore promote significant progress towards the creation of the gas internal market by 2014. To achieve this goal the Roadmap intends to: (i) provide an overview of projects currently under development, (ii) share information, in particular on best practices, and identify issues and solutions adopted throughout the development of the voluntary projects, (iii) set targets for future work within the scope of the Roadmap, (iv) describe roles and responsibilities for all the parties involved in the development of the pilot projects and (v) promote, to the extent possible, transparency in the process towards stakeholders and convergence of the pilot projects towards a coherent implementation of the CAM NC provisions with the same understanding across the different projects throughout Europe. The CAM Roadmap, published on 1 March 2013, was presented at the XXIII Madrid Forum of April 2013. The Forum welcomed the CAM Roadmap and encouraged ACER and ENTSOG to “continue the work in close cooperation with the relevant stakeholders by e.g. collecting and documenting common problems and best practices to enable efficient solutions.” The Forum also invited ACER and ENTSOG to “promote the convergence of the on-going projects to avoid duplication of costs, as well as to report on progress of implementation at its next sessions.” The Roadmap which will be described herein after is articulated in two parts. The first one describes the organisational and governing framework, namely how all parties involved in the Roadmap relate and communicate with each other in order to facilitate a smooth implementation of CAM pilot projects. The second part first illustrates the timeline for implementation of each pilot project, together with a description of the network code provisions which are contextually implemented by those projects, and secondly presents the timeline and milestones of each project. Page 6 of 46
3. Governing Arrangements 3.1. Need to update the current governing structure The CAM Roadmap represents a novelty in the context of the Gas Regional initiative since it focuses on a cross-regional dimension, which is essential to increase consistency between and across the work of the regions and thus efficiently pave the way to the completion of the internal market by 2014. In 2012 the Gas Regional Initiative experienced a step-change in pace with the launch of the Implementation Roadmap of capacity allocation mechanisms (CAM Roadmap). The introduction of this cross-regional approach is favoured if the parties involved in the projects’ implementation build upon the work already done and share the results obtained across the three regions in order to identify best practices and efficient market-tested solutions. The CAM Roadmap does not intend to add unnecessary bureaucracy; indeed it aims to build as much as possible upon existing structures and it takes into account the experience gained at regional level through structures such as the Regional Coordination Group (RCC), the Stakeholders Group (SG), the Implementation Group (IG) and others. However, it is time to add an additional EU-wide dimension, able to promote cross-regional coordination among projects, collaboration between ACER and ENTSOG and a framework for information and consultation to relevant stakeholders of the European gas sector. Indeed, the Roadmap is a tool to facilitate the early implementation of CAM NC by: Promoting experience sharing and exchange of lessons learned between existing and future pilot projects voluntarily launched by TSOs and NRAs; Ensuring that lessons drawn from the implementation of pilot projects are carefully considered when the identification of solutions to problems related to the implementation of another project is required; Informing adequately all interested stakeholders about the ongoing process; Enabling ACER and ENTSOG to monitor the whole process, as requested by the Madrid Forum, ensuring the coherence of solutions adopted by the different projects, avoiding the duplication of costs and aiming to facilitate and enable the early implementation of the CAM NC. Page 7 of 46
3.2. Roles and responsibilities within the new framework The main pillars of the CAM Roadmap are represented by pilot projects. Parties involved in each pilot project are the best placed to decide on the organisational structure that suits them best (i.e. using the current regional groups – RCC, SG, IG – if they wish, or setting up ad-hoc groups). For the sake of simplicity, the groups managing each pilot project are identified in this CAM Roadmap document as “Core Groups”. Each Core Group is made up of TSOs implementing a pilot project and responsible NRAs. They may also collaborate with relevant stakeholders to exchange views on the project features. The Core Group oversees pilot project implementation and it mainly deals with the identification of national requirements and the resolution of technical and legal questions related to the project. In order to favor coordination at cross-regional level, each Core Group is invited to appoint two (or more) representatives (at least one from the NRAs and one from the TSOs) which have the task to report on progress made, obstacles faced, solutions adopted and identified issues of general interest. The latter encompasses issues that need to be discussed at EU level because they may affect other projects. The cross-regional coordination is ensured by two new groups, namely: an EU Stakeholders Group and a CAM Coordination Group. These groups work in close cooperation with ACER and ENTSOG which have the important role of promoting and facilitating a consistent implementation of the CAM projects across Europe concomitantly to the market developments of each gas region. The EU Stakeholders group comprises representatives of the European Commission, ACER, ENTSOG, Member States, NRAs and TSOs representing the pilot projects (as well as other NRAs and TSOs interested), the Lead Regulators of the three gas regions and stakeholder associations, and has the aim to: Involve and engage EU stakeholders; Promote a high level of transparency in each step of the implementation process. The CAM Coordination group encompasses EC, ACER, ENTSOG and NRAs and TSOs representing the pilot projects. Member States have also the possibility to participate; other interested NRAs and TSOs may be invited as well. Its main aim is to facilitate the implementation process by: Building a common understanding on how to apply NC provisions; Identify and exchange best practices among participants and anticipate any issue or complexity arising from the implementation process, so as to promote the adoption of the most effective solution or solutions building upon the work already done; Page 8 of 46
Monitor the developments of the projects’ implementation according to the objectives and timeline set in the Roadmap; Discuss the evolution of national regulations aimed at ensuring consistency between the pilot projects; Support projects facing problems and/or delays which might arise in the course of the projects’ implementation, by helping to identify and promote solutions. The aim will be to resolve problems swiftly and with a consensual approach. This new framework and the interaction between the different groups can be represented as shown in the figure in the following page. The first meetings of respectively the CAM Coordination Group and the EU Stakeholders Group took place on 6 March 2013 in Brussels and were well attended, including ACER, ENTSOG, EC, TSOs, NRAs and stakeholders representatives. At these meetings, the state of play of the pilot projects as well as the adaptation of national regulatory frameworks was presented followed by a constructive dialogue on the issues and difficulties encountered so far and suggestions to address them. Stakeholders also had the opportunity to be informed about the process, asking questions and clarifying their doubts. These first meetings were widely recognised as being useful by all participants. The second meetings of the two respective groups took place on 18 September in Ljubljana, where a review of the progress on projects’ implementation was carried out, and discussions were held on the issues of common interest arising on the implementation process. Page 9 of 46
4. Implementation This second part of the Roadmap illustrates the details of the implementation of the CAM NC provisions for each of the projects involved. For this purpose, the following sections have been included: Description of the network code provisions that are in place or are foreseen to be implemented The timeline and milestones of each project Geographical scope of the projects Review of issues, lessons learned, solutions adopted and open questions that arise during CAM NC early implementation Key factors for success in early implementation of CAM A fuller description of each project can be found in Annex 1. Finally, Annex 2 contains a table which provides information at the level of interconnection points (IP) on the firm standard capacity products (where available) being offered and how they are being offered in the course of early implementation. 4.1. Scope of projects related to CAM NC provisions The table below summarises the pilot projects currently taking place in EU Member States. As early implementation of the CAM NC is voluntary, it should be noted that the table does not represent an assessment of implementation compliance by ACER or ENTSOG but instead is intended to give an overview of the scope of projects in progress and the approaches taken. Page 11 of 46
Member PROJECT NAME Project description States TSOs involved involved Bayernets, BOG, Energinet DK, Fluxys Austria, Belgium, FluxysTenp, Belgium, Common platform for the Gascade, Gas Connect Denmark, allocation of capacity Austria, GRTgaz, GRTgaz France, 1* PRISMA according to CAM NC rules. Deutschland, GTS, GTG Germany, Implementation will be Nord, GUD, Nowega, Italy, progressive starting in April Ontras, Open Grid 2013. Europe, Snam Rete Gas, Netherlands TAG, Terranetsbw, (at present) Thyssengas (open to other TSOs) 1) Pilot: Allocation of bundled quarterly product Bundled Product at according to CAM NC rules Germany, Ontras, 2 Lasów 2) Allocation of all bundled Poland Gaz-System products according to CAM NC Allocation of firm rolling monthly bundled capacity on Bundled Product the HU-RO interconnector FGSZ, and Capacity Hungary, 3 via the Regional Booking Transgaz Platform -Hungary/ Romania Platform according to the (open to other TSOs) Romania CAM NC, applying the ‘product bundling’ principle Coordinated implementation of Allocation of standard GRTgaz, CAM NC at all IPs France, products as a bundled TIGF, 4** between entry-exit Portugal, product via auctions in REN, systems in the South Spain virtual points Enagas Region: France, Portugal and Spain * Some functionalities provided by the platform may not be adopted by all connected TSOs during the voluntary phase of CAM early implementation. The information below shows which of these elements are being implemented at which IPs. ** At this stage, it is envisaged that the progressive auctioning of standard bundled products at the IP between GRTgaz North-GRTgaz South and the IP between France and Spain will take place on the PRISMA platform. Page 12 of 46
CAM NC IMPLEMENTATION PER PROJECT The below table reports on: Provisions already in place by the end of 2012 (marked with 2012) Key provisions of the CAM NC that current projects are already planning to implement by the end of 2013 (marked with 2013) Key provisions of the CAM NC that current projects are already planning to implement by the end of 2014 (marked with 2014). Coordinated Bundled implementation Product and Projects Bundled of CAM NC at CAM NC 2 Capacity PRISMA Product at all IPs between Provisions Platform - Lasów entry-exit Hungary/ systems in the Romania South Region Joint, anonymous, web- based platform 2013 2013 2012 established Using already existing Platform platforms 2012 2013 Web-based platform not yet used 2012 Platform offers secondary capacity 2014 2014 Yearly 2013 2014 2013 2012 Bundled Capacity Standard Firm Quarterly 2013 2013 2013 2012 Products Monthly 2013 2014 2013 2012 Day Ahead 2013 2014 2013 Within-day 2013 1 Some functionalities provided by the platform may not be adopted by all connected TSOs during the voluntary phase of CAM implementation. The information below shows which of these elements are being implemented at which IPs. Page 13 of 46

Auctions used 2013 2013 2013 2012 Other allocation method currently used 2012 CAM timings 2013 2013 2013 2012 Auction timings Other auction timings 2013 2012 Ascending clock algorithm for yearly, 2013 2013 2013 2013 Auction algorithm monthly, quarterly products Uniform price algorithm for day-ahead, within- 2013 2014 2013 2013 day products Bundled product offered 2013 2013 2013 2012 All capacity offered as bundled to the extent it 2013 2013 2013 2012 Bundling can be matched Follows CAM NC rules Not 2012 on offer of unbundled 2013 applicable 2013 capacity Virtual Interconnection Not Not Not Point established 2012 applicable applicable applicable CAM Centralised Approach Nomination 2013 (i.e. Single Nomination) Decentralised Approach 2012 (i.e. double nomination) Day-ahead product Interrupti 2013 2013 offered ble Other interruptible 2013 2012 products offered Page 14 of 46
2013 Default interruption (At discretion lead time used of TSOs) 2013 Other interruption lead (At discretion time used of TSOs) Timestamp + pro rata 2013 At discretion of approach to (At discretion TSOs and NRAs interruption sequence of TSOs) involved 2013 At discretion of Other approach to (At discretion TSOs and NRAs interruption sequence of TSOs) involved One contract with each 2013 2013 2013 2012 Contract TSO model Single contract Co-operation practices co-operation Principles of 2013 2013 in line with CAM NC Other co-operation practices currently used National Reserve price = discretion of 2013 2013 2012 regulated tariff TSOs and NRAs involved National 50:50 default rule discretion of applied for split of 2013 2013 2012 TSOs and NRAs auction premium Tariffs involved National Other rule applied for discretion of split of auction TSOs and NRAs premium involved National National Over and under discretion of discretion of recovery mechanisms TSOs and NRAs TSOs and NRAs approved by NRA involved involved Page 15 of 46
4.2. Implementation timelines at project level PRISMA Main 2011 2012 2013 2014 2015 Milestones Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 CAM in place PRISMA Joint platform 1. Announcement of initiative 2. Analysis of CAM NC requirements 3. Discussions with NRAs to ensure national regulatory context allows early implementation of CAM 4. Development of process and functional specifications 5. Development of ICT specifications 6. Foundation of new company 7. Implementation and testing 8. Prepare and implement go-live 9. Integration of new TSOs 10. Progressive implementation of new features (continues throughout 2014) Bundled Product at Lasów 2011 2012 2013 2014 2015 Main Milestones Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Bundled CAM in place Product at Lasów 1. Discussions between NRAs and TSOs on nature and arrangement of the project conducted 2. Concept paper developed and agreed for the Pilot project 3. Development of Cooperation Agreement and Terms and Conditions for both networks 4. Implementation of IT infrastructure with respective platform and TSO interfaces complete 5. Go live and first auctions – Pilot project (June 2013 auction for first three quarters of 2014) 6. Memorandum of Understanding for the inclusion of further CAM products concluded 7. Product implementation 8. Auction of the further CAM products foreseen Page 16 of 46
Bundling product and capacity platform – Hungary / Romania Main 2011 2012 2013 2014 2015 Milestones Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 HU-RO CAM in place bundling and allocation 1. Transgaz and FGSZ signed MoU in order to co-operate on 3rdenergy package issues 2. Joint working groups established. 3. Platform for CAM-NC compliant offer of capacity completed and ready for use 4. Harmonising access rules involving both TSOs and NRAs 5. First capacity offer (monthly bundled capacity; 3rd Monday of November 2013) 6. Target for availability of further platform functions: handling of daily nominations and renominations; secondary capacity trading. 7. Progressive introduction of further standard capacity products according to CAM NC auction calendar and optionally outside of the calendar if so agreed between the project partners. Coordinated implementation of CAM NC at all IPs between entry-exit systems in the South Region: Spain, France and Portugal Main 2012 2013 2014 2015 Milestones Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Spain - Portugal VIP (*) Spain- France CAM in place border IP between GRTgaz North and GRTgaz South (**) 1. Discussions with NRAs and agreement to develop a bundled capacity auction process 2. Finalisation and publication of associated documentation and corresponding approval by NRA’s 3. Open Information Sessions for Shippers (Madrid and Lisbon) 4. Firm yearly product auctions: pre-qualification and qualification phases for shippers; capacity bidding window (24 - 25 July) Page 17 of 46
5. Firm monthly product auctions: pre-qualification and qualification phases for shippers; capacity bidding window (10- 11 September) 6. Interruptible firm and monthly products auctions: qualification phases for shippers; capacity bidding window (17-18 September) 7. Firm yearly products auction: pre-qualification and qualification phases for shippers; capacity bidding window (27-28 June) 8. Firm quarterly products auction: qualification phases for shippers; capacity bidding window (16-17 July) 9. Interruptible year and quarterly products auction: capacity bidding window (22-23 July) 10. Expected first annual yearly capacity auction in March 2014 using a common platform 11. Expected first annual quarterly capacity auction in June 2014 using a common platform 12. Expected first rolling monthly auction in September 2014 13. First rolling day ahead auction, subject to development of TSOs IT systems (the latest in Nov 15) (*) 10, 11 and 12 will be possible if all interconnected TSOs develop their IT on time (**) The schedule for implementing auctions at the IP between GRTgaz North and South areas (via the PRISMA platform) is still under discussion in France. Page 18 of 46

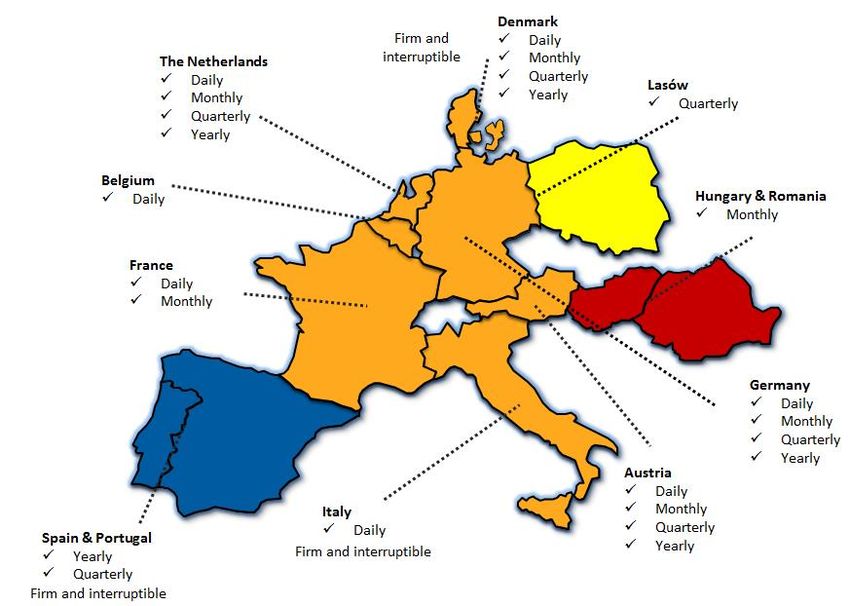

4.3. Geographical scope of the projects The map below summarises the products that will be offered in 2013 in each of the countries involved in pilot projects. As indicated in the previous section, several TSOs are envisaging the implementation of further capacity products during 2014. This list of products reflects the current status and it may be modified due to future internal evaluations by TSOs and discussions with the relevant NRAs where necessary. Fig 3. Products offered during 2013 by the pilot projects throughout the EU. Page 19 of 46
4.4. Review of issues related to CAM Implementation challenges This section aims to analyse the issues with implementation that have been encountered in each of the projects in place or already planned and the barriers that may be faced by TSOs: - General issues (including those areas where pilot projects are not currently in progress) General issues and challenges The likelihood that CAM NC will change somewhat during comitology leads to concerns that early implementation may result in wasteful expenditure, Stability of CAM NC and hence a cautious approach by NRAs and TSOs in a number of countries. A large number of European and national initiatives are currently being developed and implemented. This means that some countries (e.g. some Workload/ prioritisation smaller countries and those with less experience of implementing European energy legislation) are fully occupied with cannot devote resources towards voluntary projects Any change imposes costs on network users (e.g. costs of modifying their IT systems). Particularly in areas of zero or very rare contractual Network user support congestion, network users have sometimes been resistant to moves necessary towards early implementation, as the current system in place may be easier and less costly for them. TSOs rely on a large number of complex, interconnected IT systems, the nature and structure of which differ considerably between countries. Integration of back end Integrating these systems with new front-end systems for the systems implementation of CAM is a costly and time consuming process and in some cases may be impossible to complete before the mandatory deadline for implementation of CAM. Early implementation requires that governments prioritise work on Legality of CAM NC reviewing and granting requests for derogations or on amending legislation provisions if needed. Co-ordination with There may be a reluctance in some cases to re-open regulatory regulatory regime settlements to allow early implementation of CAM Due to the interconnected nature of their systems, TSOs generally have Co-ordination between substantial experience in co-ordination with neighbouring companies. The neighbouring regimes development of similar co-operation between neighbouring NRAs is also essential for implementation; this is still under development in some cases. Page 20 of 46
- In those areas where pilot projects are already taking place: TSOs and Project Review of issues NRAs involved The early implementation of the CAM NC to such an extent in Europe requires a pragmatic and coordinated approach between the different 19 TSOs NRAs and TSOs involved. Such a coordination is essential on e.g. the involved following points (not exhaustive list): Combined offer of bundled products at an IP Definition of the big and small price steps at both sides of a border Agreements on auction premium split PRISMA Also, experience has shown that the European NRAs wish to converge towards a limited amount of platforms. This requires a governance process that needs to be agreed upon between the involved TSOs. Other TSOs Finally, IT developments, both for the implementation of the auction interested are algorithms and for the connection of the IT tools with the respective welcome to join back-ends of the parties active on the platform represent a huge the project amount of time, effort and money. But as it is shared amongst many countries, these costs are optimised. These efforts will in the future lead to create more proximity between the TSO offers, for the benefit of gas sellers. TSOs and Project Review of issues NRAs involved Alongside the development and the entering into force of the CAM NC the TSOs discussed an early implementation of the respective provisions to gather experience (Pilot Project). After a successful pilot the work is focusing on offering other CAM products prior to the implementation deadline in November 2015. The work done is Ontras and Gaz- Bundled separated into the following milestone: System (TSOs) Product Agreement on concept and products to be offered during pilot BNetzAand ERO (agreement on quarterly products – Pilot Project) at Lasów (NRAs) Definition of specific supplementary access conditions Agreement on platform approach for the Pilot Project Technical/practical connection to platform and backend definition Agreement what future capacity should be offered as bundled Memorandum of Understanding to implement the CAM products IT-implementation to auction the residual products Page 21 of 46
TSOs and NRAs Project Review of issues involved In the CEE region, the general environment for the early implementation of the CAM NC, especially the introduction of bundled capacity allocation necessitates close cooperation between all TSOs and NRAs involved in the alignment of the below criteria: Network usage dimensions, FGSZ and Transgaz (TSOs) Licensing for genuine capacity bundling (i.e. any Network User should have sufficient access to both transmission HEO and ANRE systems concerned), (NRAs) The issue of multi-currency environment should be addressed access rules for bundled capacity products, TSOs that operate at least VTP should be accessible for Bundled Capacity an IP may accede owners. Bundled to the Regional The Regional Booking Platform concept and IT solution – due to Product Booking Platform special regional regulatory, but also practical and financial reasons and (RBP) both on user- – was created focusing on the following principles reflecting the Capacity only or on equal expectations of a large number of various stakeholders: Platform shareholding basis, High reliability (in order to accommodate Member State, immediately or at NRA and customers’ S.o.S. concerns), any later time. Scalability both in operations and offered services (on TSO Hungary/ TSOs that join request), Romania before 2014 are Easy usage (on TSO and Network Users’ request), given the Technical requirements for least cost/effort introduction, opportunity to take and short implementation time (on TSO and Network part in shaping the Users’ request), terms of the Joint Fair business model based on real cost drivers (TSO and Venture. NRA concern). The Booking Platform particularly aims at offering services beyond primary capacity sales: Secondary Capacity Market services o Title Tracking o Anonymous Market Place Single nomination and allocation, Client Risk Management Comfort services. Page 22 of 46
TSOs and Project Review of issues NRAs involved The auction between Spain and Portugal in 2012 was very useful to identify which regulations had to be adapted, which documentation and processes had to be developed, and to raise awareness among shippers of the implications of the NC (“bundled capacity”, standard capacity Coordinated products,…). implementation GRTgaz, TIGF, The 2013 auction has followed the same pattern as 2012 of CAM NC at all Enagas and REN edition but some issues have been improved: IPs between (TSOs) prequalification and qualification windows for shippers to entry-exit participate in the allocation process have been extended; systems in the capacity products offered, minimum bids for product per CRE, CNE and price step. South Region: ERSE (NRAs) In 2012, the SGRI made progress in the common definition France, Portugal to achieve early application of CAM in the cross-border and Spain interconnections in the Region and among the French Balancing zones. The IT systems implementation plans for the TSOs in the Region is of utmost importance to develop the auctions, so efforts are being made to progress in this issue. Page 23 of 46
4.5. Review of lessons learned, solutions adopted and open questions arising during CAM NC early implementation The following tables present a number of issues which are not explicitly referenced in the CAM NC but which often must be addressed during the implementation of the NC provisions. Each of the tables gives a brief description of the issue and collects examples of solutions adopted. Definition of price steps Brief description Example/s of solutions adopted The CAM NC does not specify the ratio The PRISMA platform allows any whole-number ratio between the large price steps and the between small/large price steps. The number of price small price steps, i.e. how many small steps is not limited. price steps would be included in a large price step. At the Spain-Portugal VIP, price steps are defined on the Operational discretion is left to TSOs and basis of a proportional incremental premium equal to 3% booking platform operators. (arithmetic progression) of the tariff in each country with 30 price steps per Member State. Auction premium from bundled capacity and split and destination of auction revenues Brief description Example/s of solutions adopted In article 26 of the CAM NC, the split of the revenues above the reserve price is left to At the IPs where capacity is allocated via PRISMA, the the agreement between TSOs and to the default rule (50:50 split of the auction premium) is applied, approval by NRAs. In the absence of an unless otherwise justified on a case-by-case basis and agreement, a default rule of equal split approved by the relevant national regulatory authority, if (50:50) is applied. This implies that different necessary. alternatives are possible if TSOs agree on a different split (and NRAs approve it); different practices can be observed. At the Spain-Portugal VIP, the default rule is also applied. Regarding the destination of congestion revenues, or auction premium, it has been noted that Chapter 4 of the Tariffs FG addresses this issue. Page 24 of 46
Inter-relation between CAM and CMP Brief description Current status A number of provisions of the CAM NC have interactions with some of the requirements on The eventual concurrent implementation of the CMP Guidelines. Examples are the provisions CMP Guidelines and CAM NC requirements and related to the offer of bundled capacity at both potential coordination issues are analysed in a sides of an IP in combination with the document3 developed by ACER in spring 2013, with implementation of the capacity surrender limited input from ENTSOG and selected industry mechanism established by the CMP Guidelines. associations4, which is now published on the ACER The application of these provisions from the website5. CAM NC and the CMP Guidelines has to take place in a compatible and consistent way. Bundling of different firm capacity products Brief description Example/s of solutions adopted On PRISMA, two bundling approaches are possible: Classic bundling approach, where the bundling of capacity products is done “offline” by the TSO. TSOs submit bundled or unbundled products which cannot be changed by the platform. The coordination and The amount of capacity that can be bundled matching implies “offline” coordination between TSOs at each IP is in some cases limited due to especially regarding day-ahead products; the existence of asymmetric available capacity at both sides of the IP. Moreover, Cross bundling approach, where the bundling of different levels of capacity firmness at each capacity products is done “online/automatically” by the side of the IP may require specific rules to platform. TSOs submit capacity raw data (currently allow for effective bundling. booked and available capacity) to the platform. The matching and creation of the bundled and unbundled products is done by the platform in accordance with applicable legal/regulatory framework, in a sequential manner according to a priority order where products of different types or “flavors” exist at one side of the border. 3 “Issue paper” on the need for coordinated decisions at EU level for the implementation of the CMP guidelines. 4 ACER half-day workshop held on 12 June 2013. 5 http://www.acer.europa.eu/Official_documents/Acts_of_the_Agency/Publication/ACER_CMP_Guidance issue paper on CMP implementation_20130808.pdf Page 25 of 46

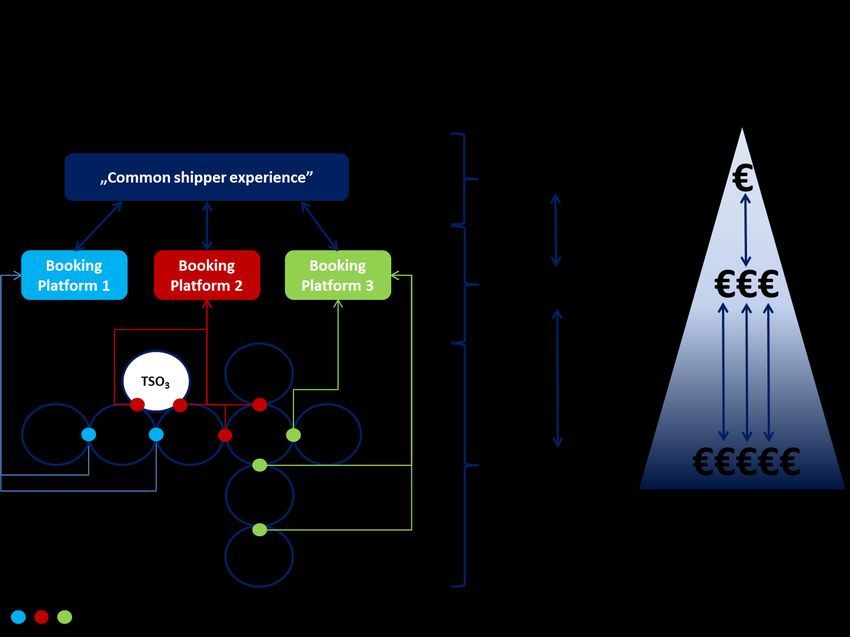

Costs of booking platforms Brief description Current status With the establishment of joint booking platforms, two issues arise: (i) the split of fixed and variable costs across the TSOs which join the The establishment and use of platform (which is an internal matter to be decided upon by those ‘joint web-based booking TSOs) platforms’, as required under the (ii) recognition by relevant NRAs of the costs borne by TSOs in the CAM NC, involves capital allowed revenues (or equivalent in non-revenue cap regimes). expenditure and operational The establishment of joint booking platforms is required by CAM NC expenditure to be incurred by (article 27) and the related costs should be recovered. In a number TSOs. of Member States, NRAs have already recognised the joint platform costs incurred by TSOs. However, in others, this recognition is still How such fixed and variable pending. Some NRAs have recalled that insurances must be given costs are shared across the TSOs that all TSO costs, including any incurred for joint booking using a given platform and platforms, are efficiently incurred by TSOs and that the costs of whether they are recognised as setting up or joining an alternative platform should be considered. ‘efficiently incurred’ by the This is an outstanding issue in some projects where a decision in this relevant NRAs remains an open respect will have to be taken by NRAs, defining practical solutions as issue in some Member States. soon as possible where recognition of costs has not yet taken place. In addition, the absolute and relative costs of joining some existing platform are a key concern especially for small and medium-sized TSOs (e.g., those in Ireland, Portugal and Slovenia). Activities of joint platforms and need for appropriate exchange of information Brief description Current status TSOs should ensure that CAM With the objective of transparency, a copy of the general terms implementation activities which and conditions (GTs&Cs) between PRISMA and network users is take place via joint platforms are available on the ‘Download’ webpage, a public section of transparent to the market and PRISMA’s website. For a revision of the GTs&Cs planned for 1 NRAs, allowing appropriate January 2014, PRISMA conducted a public consultation, including exchange of information. a public workshop, to solicit any questions or concerns from network users. Page 26 of 46
Harmonisation of capacity contracts at both sides of the border Brief description Current status The implementation of the CAM NC will result in the harmonisation of a number of Concerns have been expressed by some stakeholders, aspects of capacity contracts (duration, such as EFET, regarding existing differences among the units, etc.). The CAM NC, however, does not contractual terms applied by TSOs at both sides of an IP require standardisation of capacity products (e.g. different degrees of firmness) which create in terms of firmness. Further harmonisation inefficiencies or additional costs. In contrast, some other of contractual terms will result eventually network users have asked that the rights underlying the when other network codes are existing contracts are maintained. implemented (e.g. the balancing network code as regards nominations). Some The above concerns are expected to be treated as part of stakeholders, however, are calling for yet the scoping exercise for the proposed network code on additional harmonisation. The appropriate Rules for Trading. degree of harmonisation of capacity contracts is an open issue and requires analysis at EU-level. Different currencies in use at each side of the border Brief description Example/s of solutions adopted In the HU/RO project, it was decided to keep the reserve price in the corresponding currencies and then execute the bids in percentages of the reserve prices. When TSOs allocate capacity at IPs In the project between PL/DE at Lasów IP, a different approach where the currency in use at each has been followed as one currency (€) was selected for the side of the border is different, bids. The applicable exchange rate is the same as that applied operational challenges arise. In at the moment of the completion of auctions. such situations, TSOs are working in order to solve the potential issue. In PRISMA, only the currency for the Danish TSO, energinet.dk, is different from the euro used elsewhere. At the moment, no currency conversion mechanism has been implemented on the platform itself. Energinet.dk is responsible for converting Danish kroners into euros (and vice versa) when sending (receiving) data to (from) the platform. Page 27 of 46
Harmonisation of the gas day between countries with different time zone Brief description Example/s of solutions adopted Potential issues could also arise This issue was addressed bilaterally in a successful way wherever when TSOs allocate capacity at IPs it appeared. Given that the standard gas day is now defined where the time zones are different (Article 3 “Definitions” of the CAM NC), this should not be an at both sides of the border. TSOs issue for CAM early implementation projects in the future. are working in order to tackle the potential issue. Licensing issues Brief description Example/s of solutions adopted Energy shippers in Hungary and some other Central-Eastern European Member States are required to obtain a licence to trade gas at wholesale level; however, the licence criteria differ The different requirements in from Member State to Member State. A form of cross-border terms of licenses for the users to licensing is therefore needed. This is a key issue that is being operate in different countries addressed in discussion with NRAs. might create in some cases a potential obstacle to take into In France, all network users are required to obtain a licence from account when accessing bundled the government, which then enables them to sign a transmission capacity at certain IPs. contract with GRTgaz and/or TIGF. It is not, however, the task of the TSO to check the validity of the licence, as it is a representation of the network user who commits on it and remain liable for any misrepresentation. Page 28 of 46
4.6. Key factors for success in early implementation of CAM The following table lists identified key factors for success (KFSs) in early implementation of CAM NC based on observation of projects and interviewing project participants. The key factors have been identified in two separate groups: project specific factors and problematic issues of general interest. With regards to the first group, TSOs and NRAs have the role to identify and report on the steps needed in order to successfully implement the pilot project. For wider factors with European scope, these should be addressed within the structures described in the ‘Governance’ section. Project specific factors Legal and regulatory National regulatory rules shall allow for the early environment implementation of CAM (*) Coverage of CAM NC requirements shall be as wide as possible Degree of coverage of CAM Currently key aspects such as the offer of bundled capacity and NC the implementation of Coordinated auctions is developed in several pilot projects Strong commitment and support from all parties involved is Strong support from all needed parties (TSOs, NRAs, GRIs, ENTSOG, ACER, the EC, Member States and Network Users) NRAs shall guarantee that the costs efficiently incurred by TSOs Coverage of costs are covered e.g. by tariffs * With regards to regulatory requirements: other pieces of legislation at national level that have an impact on CAM implementation shall be identified by TSOs and NRAs. TSOs and NRAs will monitor draft legislation in development and will highlight the pieces that need to be changed to allow CAM Implementation. Page 29 of 46
European factors (wider scope) The share of experiences allows opportunities for other TSOs to learn from experience gained in pilots Share experiences It minimises the duplication of efforts and the existence of inefficient costs Stability is especially important with regards to auction Stability of provisions in CAM algorithms, NC due to its impact on the design of IT projects Geographical diversity of pilot projects allows wide Geographical diversity implementation of CAM NC in Europe Ability of TSOs to devote resources to develop new solutions is Resources also a required condition Convergence Progressive convergence of projects is strongly recommended Page 30 of 46
ANNEX 1: PILOT PROJECTS MAIN FEATURES A. PRISMA and current participating bundling initiatives Member TSOs involved States Project description Involved 19 TSOs involved: - Common platform for the allocation of Bayernets, BOG, Energinet Austria, capacity according to CAM NC rules DK, Fluxys Belgium, Belgium, FluxysTenp, Gascade, Gas Denmark, - The common platform is operation since April Connect Austria, GRTgaz, France, 2013 GRTgaz Deutschland, GTS, Germany, - New functionalities, e.g. secondary market and GTG Nord, GUD, Nowega, Italy, within day, will be implemented Ontras, Open Grid Europe, Netherlands Snam Rete Gas, TAG, (at present) - The platform is open to all TSOs interested in Terranetsbw, Thyssengas the project. Project Features The service company is operating the platform, carry out auctions and distribute the products on behalf of the TSOs since April 2013. The shares & costs of the new company are distributed over the participating countries based on the ENTSOG voting rules. The platform connects the different backend systems of the various TSOs using standard IT-communication interfaces. Requirements have been developed by TSOs and platform operators; the requirements have been evaluated by and discussed with IT specialists. Existing infrastructures has been effectively used to ensure cost efficiency. The platforms TRAC-X, Capsquare & Link4Hubs, have been replaced by the new joint platform which uses all their benefits and collective experience. With the joint platform shippers are able to book capacities at European network points through one single tool. Currently 277 shippers and more than 830 users are using the platform In addition the platform is able to handle regional regulatory specifics of different countries Secondary market features will be implemented in 2014 Within day will be implemented at latest by November 1 st 2015 Page 31 of 46
Bundled capacity allocation at Tarvisio-Arnoldstein Member States TSOs involved Project description Involved Allocation of bundled capacity according to CAM Network Code rules via a proposal for day-ahead capacity allocation at Austria-Italy IP in order to better TAG, Snam Rete Austria, Italy connect Baumgarten and PSV hubs. Gas - Firm and interruptible bundled day-ahead capacity allocated in both flow directions. - IP involved: Arnoldstein/Tarvisio Background In July 2011 TAG and SRG have developed a joint procedure for the coordinated interruptible capacity allocation at both sides of the IP being assigned via auction on TAG system and with a corresponding nomination on SRG system. At the beginning of 2012 the concerned NRAs and TSOs have started to work on the early implementation of CAM NC for the allocation of day- ahead capacity. Project Features A joint task force has been established amongst NRAs and TSOs. Joint guidelines related to the adoption of the CAM NC provisions have been developed by the NRAs and shared for comments with the involved TSOs, which have been subsequently formally consulted in autumn 2012. The Joint guidelines are intended to provide the required regulatory background to TAG and SRG for the early implementation of the CAM NC provisions concerning day-ahead capacity. The project has been presented in the SSE GRI and warmly welcomed by stakeholders. SRG and TAG have taken part to the establishment of the Joint capacity platform (PRISMA) through which they are offering bundled day-ahead capacity products at Arnoldstein/Tarvisio. Joint Guidelines (consulted with stakeholder during October 2012) have been published in early 2013. Network Code and Terms & Conditions resulted consequently updated in order to implement the new provisions. Allocation of daily bundled capacity products (firm and interruptible) according to the CAM NC provisions has started in April 2013. Next steps The introduction of other products is under evaluation by concerned parties and is foreseen during 2014. Page 32 of 46

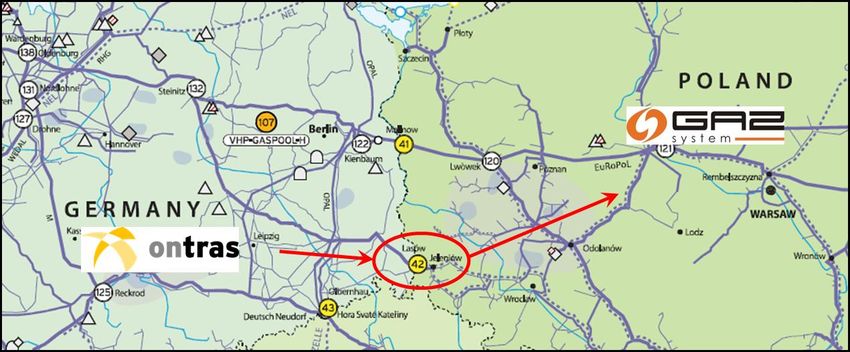

B. Bundled Product at Lasów Member States TSOs involved Project description Involved Allocation of bundled capacity according to CAM NC rules. The aims of the project are: - Define how a bundled capacity product can be Ontras, Germany, implemented between Germany and Poland. - Early implementation of CAM NC rules (for selected products during pilot phase and the residual CAM products afterwards). - Via a pilot phase, test if and how further bundled products can be offered. - Learn from experiences for future Gaz-System Poland cooperation/development stages. - Work towards the integration of the European gas market. Project Features The auctions are carried out on the basis of the CAM NC During the pilot phase, the TSOs offered quarterly capacity products for the first three quarters of 2014. Both TSOs intend to implement: Yearly products according to CAM as of March 2014 (and in the following years) Subsequent quarterly products as of June 2014 (and in the following years) Monthly and daily CAM products and intend to offer these products as of end 2014 Page 33 of 46
Contract set up Achievements Concept paper agreed with NRAs in summer 2012 Capacity to be bundled in the future agreed Cooperation Agreement finalized Specific Terms & Conditions developed Joint Product Description Paper published Service Agreement with PRISMA finalized Market consultation held from 5th until 23rd of November 2012 including a Shipper Workshop on 15th November Terms & Conditions of both TSOs published Shipper Manual how to register with the TSOs/platform and how to auction the capacity developed and published Shipper registration in April and May 2013 completed On the 3rd and 4th of June 2013, the Transmission System Operators (TSO) GAZ-SYSTEM S.A., Poland and ONTRAS Gastransport GmbH, Germany (ONTRAS) for the very first time offered the bundled capacity products at the interconnection point Lasów. Results The three auctions have been carried out properly. Resulting of the shipper bids the following bundled capacities were allocated: 2nd quarter of Gas Year 2013/2014 [January 2014 – March 2014] auctioning 57,980 kWh/h (5,200 nm3/h): Page 34 of 46
o Allocated capacity: 57 000 kWh/h o Free capacity: 980 kWh/h 3rd quarter of Gas Year 2013/2014 [April 2014 – June 2014] auctioning 57,980 kWh/h (5 200 nm3/h): o Allocated capacity: 20,100 kWh/h o Free capacity: 37,880 kWh/h 4rd quarter of Gas Year 2013/2014 [July 2014 – September 2014] auctioning 57,980 kWh/h (5,200 nm3/h): o Allocated capacity: 21,115 kWh/h o Free capacity: 36,865 kWh/h Next steps In May 2013 ONTRAS and GAZ-SYSTEM signed a Memorandum of Understanding for better cooperation and further works on bundling the capacity in future. Both TSOs committed to implement the provisions of the European Network Code on Capacity Allocation Methodologies ahead of its official entering into force. Page 35 of 46
C. Hungary-Romania capacity bundling and allocation project Member States TSOs involved Project description Involved Allocation of bundled capacity on the HU-RO FGSZ, Hungary, interconnector via Booking Platform according to the CAM NC. The HU/RO interconnector went operational in fall 2010. The project was eligible for EEPR funding. It serves the Transgaz Romania purposes of both security of supply and market facilitation. Background Transgaz and FGSZ signed a MoU in July 2012 in order to cooperate on 3rd Energy Package issues as well, establishing five joint working groups for: o Capacity bundling and booking platform (pilot project) o Alignment of network usage dimensions o Alignment of operational balancing o Alignment of commercial balancing o Enabling bidirectional gas flow Project Features Phase I of the pilot project – lifting barriers and introducing short term bundled products that are allocated via the Regional Booking Platform Development of the Romanian VTP under discussion Harmonized VTP-VTP access rules involving NRAs (HEO and ANRE) in order to enable genuine capacity bundling (‘product bundling’), Simplified licensing process Harmonization of gas day (according to CAM NC) Bundling of the following products according to CAM NC auction calendar o Monthly capacity and Day-ahead capacity o Allocation of bundled capacities via the Regional Booking Platform o Synchronised and simplified nomination rules Phase II of the pilot project – introducing all standardised products Bundling of Within-Day capacity, Quarterly capacity and Yearly capacity Introducing additional services e.g. secondary capacity transactions, all nominations via the Page 36 of 46
Booking Platform “RBP” Regional Booking Platform The Regional Booking Platform (RBP) was especially developed in order to comply with the CAM NC requirements. The RBP is a stand-alone software, a ready-to-implement, fully CAM NC compliant solution. The RBP has a web-based functioning as a thin client, i.e. TSOs and Network Users can continue using their existing back-end systems, there is no or almost no back-end development requirement due to the RBP software design. This solution ensures the most overall costs efficiency considering the vast variety of existing TSO and Network User back- end systems. High-performance scalable design that can accommodate in theory all simultaneously running auctions of all the European IPs at the same time. High reliability criteria are defined o permanently available test environment for new releases, o at least 99.95% availability, o continuously running backup service at a different physical site, o security is ensured through https connection and user authentication issued by trusted provider, Open-end development, i.e. new European or national regulatory requirements or TSO business ideas can be added in a flexible way. From a technical point of view, it is ready to be used, however the actual start of the platform depends on when harmonized national rules enable its usage (see the Main Milestones section). Available functions as of 6th September 2013: o All Phase I & II capacity products are available for booking, o CAM NC auction algorithms (uniform price and ascending clock), o Auction calendar (automatic and manual), o System and business entity setup TSO setup, Capacity available for bundling, Network User credit limit. IP setup, Network User setup, Indication of active IPs, Licensed shippers checked by TSOs, Network User representative authentication. o Capacity bundling and capacity roll-over, Page 37 of 46
