IRP DATA REPOSITORY TASK ORDER #3 PROJECT MANAGEMENT PLAN - KENTUCKY TRANSPORTATION CENTER, UNIVERSITY OF KENTUCKY October 1, 2020
←
→
Page content transcription
If your browser does not render page correctly, please read the page content below
IRP DATA REPOSITORY TASK ORDER #3 PROJECT MANAGEMENT PLAN KENTUCKY TRANSPORTATION CENTER, UNIVERSITY OF KENTUCKY Responsible Principal: Jennifer Walton Co-Principal: Brian Howell October 1, 2020
IRP Data Repository – Project Management Plan TABLE OF CONTENTS OVERVIEW .................................................................................................................................. 4 1.1 PURPOSE OF PROJECT MANAGEMENT PLAN ................................................ 4 1.2 PROJECT PURPOSE & OBJECTIVES ................................................................... 4 1.3 PROJECT STAFFING .............................................................................................. 5 1.3.1 IRP, Inc. ............................................................................................................... 5 1.3.2 IRP, Inc. Board of Directors ................................................................................ 5 1.3.3 Kentucky Transportation Center (Project Management and CMV consultants .. 6 1.3.4 Seikosoft (IT Developer) ..................................................................................... 6 1.3.5 IRP Steering Panel ............................................................................................... 6 1.3.6 IRP Data Panel ..................................................................................................... 7 1.3.7 Requirements/Testing/Reporting Jurisdiction Volunteers ................................... 7 1.3.8 Pilot Jurisdictions ................................................................................................. 8 1.4 GOVERNANCE ....................................................................................................... 9 1.4.1 Governance Purpose ............................................................................................ 9 1.4.2 Governance Hierarchy ......................................................................................... 9 1.5 ROLES & RESPONSIBILITIES ............................................................................ 11 1.5.1 IRP, Inc. ............................................................................................................. 11 1.5.2 IRP Board of Directors ...................................................................................... 11 1.5.3 Member Jurisdictions ......................................................................................... 11 1.5.4 Kentucky Transportation Center ........................................................................ 12 1.5.5 Seikosoft ............................................................................................................ 13 1.5.6 IRP Steering Panel ............................................................................................. 13 1.5.7 IRP Data Panel ................................................................................................... 13 PROJECT PLANS ...................................................................................................................... 14 1.6 SCHEDULE PLAN................................................................................................. 14 1.6.1 Milestone Schedule ............................................................................................ 14 1.6.2 Tasks & Deliverables Schedule ......................................................................... 17 1.6.3 Payment Schedule .............................................................................................. 17 1.7 COMMUNICATIONS PLAN ................................................................................ 17 1.7.1 IRP Board of Directors ...................................................................................... 18 1.7.2 IRP Jurisdiction Members.................................................................................. 18 1.7.3 IRP Steering Panel ............................................................................................. 18 1.7.4 IRP Data Panel ................................................................................................... 19 1.8 RISK REGISTER PLAN ........................................................................................ 20 1.8.1 Executive Support .............................................................................................. 21 1.8.2 Scope .................................................................................................................. 21 1.8.3 Costs................................................................................................................... 21 Page 2 of 28
IRP Data Repository – Project Management Plan 1.8.4 Changes .............................................................................................................. 21 1.8.5 Stakeholders ....................................................................................................... 22 1.8.6 Communications ................................................................................................ 22 1.8.7 Resources ........................................................................................................... 23 1.9 CHANGE CONTROL PLAN ................................................................................. 23 1.10 DOCUMENTATION PLAN .................................................................................. 25 PROJECT MONITORING ....................................................................................................... 25 1.11 METHODOLOGIES AND TOOLS ....................................................................... 25 1.12 MEASURING AND REPORTING PROGRESS ................................................... 26 1.12.1 Scope .................................................................................................................. 26 1.12.2 Schedule ............................................................................................................. 26 1.12.3 Costs................................................................................................................... 27 CLOSURE ................................................................................................................................... 27 APPENDIX A: PROJECT MANAGEMENT PLAN APPROVAL........................................28 Page 3 of 28
IRP Data Repository – Project Management Plan OVERVIEW 1.1 PURPOSE OF PROJECT MANAGEMENT PLAN The Project Management Plan, or PMP, is a single, approved document that guides the project’s execution, monitoring and control, and closure. The intended audience of the IRP Data Repository PMP is all project stakeholders including IRP, Inc., IRP board of directors, Seikosoft, Kentucky Transportation Center, and other project stakeholders. 1.2 PROJECT PURPOSE & OBJECTIVES The IRP Data Repository project will result in a high-quality, timely, and complete vehicle registration database that is readily accessible to enforcement in all states and Canadian provinces. This project phase focuses on developing the data exchange architecture for the future IRP Data Repository in accordance with the requirements stated within the IRP request for proposals (RFP). In Task Order 3, Seikosoft will develop the IRP Data Repository in coordination with IRP, Inc., and IRP’s project manager (Kentucky Transportation Center) to ensure conformance to RFP functional requirements while meeting project timelines within budget. The objectives for this project are as follows: a. Ensure Shared Project Understanding b. Develop IRP Data Repository c. Migrate Existing IRP Member Data into New System d. Validate IRP Data Repository Page 4 of 28
IRP Data Repository – Project Management Plan 1.3 PROJECT STAFFING 1.3.1 IRP, Inc. No. Member Name Position Role Email Phone 1 Tim Adams CEO Executive Sponsor tadams@irpinc.org (502) 845-0398 2 Ken Carey Director, IRP Plan Compliance and Education Plan Compliance kcarey@irpinc.org (703) 963-1604 3 Robin Murphy Director, Clearinghouse and Information Systems Mgt. Program/Project Manager rmurphy@irpinc.org (703) 963-1286 1.3.2 IRP, Inc. Board of Directors No. Name State/Province Position Organization Email Phone 1 Tammi Popp Pennsylvania Chair Department of Transportation tpopp@pa.gov (717) 783-4508 2 Vacant Vice Chair 3 Vacant Past Chair 4 Kevin Davis Idaho Treasurer State Tax Commission kevin.davis@tax.idaho.gov (208) 334-7601 5 Renee Kyser Alabama Secretary Department of Revenue renee.kyser@revenue.alabama.gov (334) 479-3101 6 James Walker New Jersey Region I NJ Motor Vehicle Commission james.walker@mvc.nj.gov (609) 777-1637 7 Portia Manley North Carolina Region II Division of Motor Vehicles pmanley@ncdot.gov (919) 861-3332 8 Deann Williams Kansas Region III Division of Motor Vehicles deann.williams@kdor.ks.gov (785) 296-3686 9 Paul Harbottle Ontario Canadian Rep Road User Safety Division paul.harbottle@ontario.ca (416) 235-4559 10 Terry Wallace Alberta Canadian Rep Alberta Transportation terry.wallace@gov.ab.ca (780) 427-7508 11 Vacant Rotating Position Page 5 of 28
IRP Data Repository – Project Management Plan 1.3.3 Kentucky Transportation Center (Project Management and CMV consultants No. Name Position Email Phone 1 Jennifer Walton Program Manager jennifer.walton@uky.edu (859) 257-7239 2 Brian Howell Project Manager brian.howell@uky.edu (859) 218-0017 3 Jeff Tipton Project Consultant jeffrey.tipton@uky.edu (502) 321-1333 4 Mark Bell Project Consultant markbell@twc.com (859) 433-7799 1.3.4 Seikosoft (IT Developer) No. Name Position Email Phone 1 Chris Campbell CEO/Owner chris@seikosoft.com (208) 589-2860 (208) 497-0637 (office) 2 Toby Piquet Project Manager toby@seikosoft.com (208) 715-1050 (cell) 3 Cody Marshall Applications Architect/Owner cody@seikosoft.com (208) 716-7295 4 Jordan Hayashi IT Leader Developer/Owner jordan@seikosoft.com (206) 473-7402 5 Christian Martinsen Software Developer christian@seikosoft.com (209) 736-7930 1.3.5 IRP Steering Panel No. Name State/Province Organization Email Phone 1 Tammi Popp Pennsylvania Department of Transportation tpopp@pa.gov (717) 783-4508 2 Ravi Surapaneni Indiana Department of Revenue rsurapaneni@dor.in.gov (317) 615-7446 3 James (Jim) Walker New Jersey Motor Vehicle Commission james.walker@mvc.nj.gov (609) 777-1637 4 Kevin Davis Idaho State Tax Commission kevin.davis@tax.idaho.gov (208) 334-7601 5 Deann Williams Kansas Division of Motor Vehicles deann.williams@kdor.ks.gov (785) 296-3686 6 TBD (Canadian) 7 Tom Kelly NA Federal Motor Carrier Safety Administration thomas.kelly@dot.gov (202) 480-5240 8 Tim Adams NA IRP, Inc. tadams@irpinc.org (502) 706-0196 9 Robin Murphy NA IRP, Inc. rmurphy@irpinc.org (703) 963-1286 Page 6 of 28
IRP Data Repository – Project Management Plan 1.3.6 IRP Data Panel State/ No. Name Organization Email Phone Province 1 Chris Flynn NA Federal Motor Carriers Safety Administration chris.flynn@dot.gov (617) 494-2662 2 Edmond Joe NA Federal Motor Carriers Safety Administration edmond.joe@dot.gov (202) 507-3794 3 Drew Clark Kentucky Transportation Cabinet drew.clark@ky.gov (502) 892-8580 4 Tammy Gomez Texas Department of Transportation tammy.gomez@txdmv.gov (512) 465-3756 5 Val King Saskatchewan Government Insurance vking@sgi.sk.ca (306) 775-6351 6 Deb Roeder Iowa Department of Transportation deborah.roeder@iowadot.us (515) 237-3255 7 Cathy Beedle Nebraska Department of Motor Vehicles cathy.beedle@nebraska.gov (402) 471-3894 8 Scott Greenawalt Oklahoma Corporation Commission s.greenawalt@occemail.com (405) 522-8772 9 Isai Marichamy Nevada Department of Motor Vehicles iamarichamy@dmv.nv.gov (775) 684-4913 10 Robin Murphy NA IRP, Inc. rmurphy@irpinc.org (703) 963-1286 11 TBD (Law Enforcement Representative) 1.3.7 Requirements/Testing/Reporting Jurisdiction Volunteers No. Name State/ Province Organization Email Phone 1 Cassidy Cade South Carolina Department of Motor Vehicles cassidy.cade@scdmv.net (803) 896-2693 2 Mathieu Chasse Quebec Automobile Insurance Corporation mathieu.chasse@saaq.gouv.qc.ca (418) 528-3333 3 Cindy Douglass New Hampshire Department of Safety cindy.douglas@dos.nh.gov (603) 227-4110 4 Jerri Hunter Idaho Transportation Department jerri.hunter@itd.idaho.gov (208) 334-8626 5 Charito Mackay British Columbia Insurance Corporation charito.mackay@icbc.com (604) 981-8305 6 Mary Withkowski New York Department of Motor Vehicles mary.withkowski@dmv.ny.gov (518) 473-8187 7 Jared Hill (Data Privacy) Georgia Department of Revenue jared.hill@dor.ga.gov (404) 724-7660 Page 7 of 28
IRP Data Repository – Project Management Plan 1.3.8 Pilot Jurisdictions State/ No. Name Organization IRP Platform Email Phone Province 1 Dina Smith Colorado Department of Transportation FAST dina.smith@state.co.us (303) 205-5621 2 Jenny Adler " " " jenny.adler@state.co.us NA 3 Natalie Wendell Minnesota Department of Transportation Explore natalie.wendell@state.mn.us (651) 201-7972 4 Mike Thomas North Carolina Department of Transportation In House methomas@ncdot.gov (919) 508-1776 5 Mike Spears " " " mspears@ncdot.gov (919) 508-1880 6 James (Jim) Walker New Jersey Motor Vehicle Commission Legatus james.walker@mvc.nj.gov (609) 777-1637 7 Mary Withkowski New York Department of Motor Vehicles Celtic mary.withkowski@dmv.ny.gov (518) 473-8187 8 Valerie King Saskatchewan Government Insurance In-House vking@sgi.sk.ca (306) 775-6351 Page 8 of 28
IRP Data Repository – Project Management Plan 1.4 GOVERNANCE 1.4.1 Governance Purpose Governance empowers organizational leaders with the authority and the appropriate mechanisms to execute their role as decision-makers. Complex and highly coordinated projects must have a robust governance hierarchy to be successful. IT projects such as this rely on good governance to maintain proper communications and decision-making for all parties involved. This governance hierarchy will delineate clearly defined roles and responsibilities for each organization involved (see Roles and Responsibilities section for details). The governance hierarchy will also appoint decision-making authorities at different levels commensurate with their designated oversight roles. KTC will provide periodic updates to the governance authorities as outlined within the communication plan. 1.4.2 Governance Hierarchy The governance hierarchy provides a framework for coordinating efforts throughout the project life-cycle for successful development and implementation of the IRP Data Repository. There are currently seven major parties identified within the governance hierarchy: IRP, Inc., IRP Board of Directors, IRP Member Jurisdictions, IRP Steering Panel, IRP Data Panel, Seikosoft, and KTC. Although each party serves a different purpose, all must work together within their established roles to successfully execute the project. The governance hierarchy relationship occurs along three main efforts: line of coordination, line of execution, and line of oversight. First, separate parties communicate, share information, and coordinate efforts through the line of coordination approach. Lines of coordination are the most basic, yet fundamental, principle for mission success. The second approach, line of execution, charges a party with responsibility for producing an intended outcome and/or deliverable. For example, the IT consultant would be responsible for producing project deliverables through its line of execution to IRP, Inc. All lines of execution are conducted through the terms of formal agreed upon arrangements such as contracts, statements of work, or memorandums of agreement. Lastly, the line of oversight ensures governance authorities execute their roles as decision-makers at agreed upon stages during the stage. Technically complex and cost-intensive projects require robust oversight to ensure the project meets its intended goals, satisfies the client’s (IRP member jurisdictions) needs, and sufficiently considers key stakeholder concerns. This project assigns oversight roles to three main parties: IRP, Inc.; IRP Steering Panel; and the IRP Board of Directors. IRP, Inc. is responsible for routine, day-to-day decisions. The IRP Steering Panel and IRP Board of Directors will be responsible for higher-level decisions elevated to intermediate or executive status. Those statuses are defined in the following Roles and Responsibilities section. The IRP Data Repository Governance Hierarchy figure depicts all involved parties and their relationships to one another. Page 9 of 28

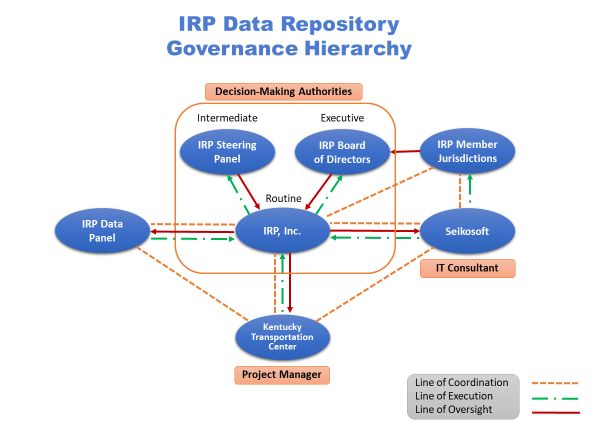

IRP Data Repository – Project Management Plan Figure 1. IRP Data Repository Governance Hierarchy Page 10 of 28
IRP Data Repository – Project Management Plan 1.5 ROLES & RESPONSIBILITIES 1.5.1 IRP, Inc. Role • Serves as the main supervisory authority for the development and implementation of the IRP Data Repository Responsibilities • Provides routine decision-making authority for daily project tasks (i.e., all responsibilities not specifically assigned to the IRP Steering Panel and IRP Board of Directors) • Serves as first-line oversight authority for the IT consultant (Seikosoft) • Facilitates required coordination and communications across the different project groups • Ensures various stakeholder concerns and values are incorporated into the design and build process for the platform 1.5.2 IRP Board of Directors Role • Serves as the executive authority for project governance, most notably on major functional requirements and budget decisions Responsibilities • Provides oversight and direction on the project • Issues final-authority executive decisions o On budget requests exceeding $25K for any milestones identified in the Seikosoft signed contract o On any additions, deletions, or significant changes to the functional requirements as identified in the Seikosoft signed contract • Allocates financial resources to support the project in line with the agreed upon contract • Monitors and supervises IRP, Inc. as the representative authority for the IRP member jurisdictions 1.5.3 Member Jurisdictions Roles • General: Membership base of the IRP Plan and represent the end-use customers and beneficiaries of the new IRP Data Repository Page 11 of 28
IRP Data Repository – Project Management Plan • Requirements/Testing/Reporting Volunteers: Assist IRP, Inc. with developing requirements for the IRP Data Repository; testing specific features/components of the developed system and providing user interface assessments (e.g., user tests); and formulating and testing reporting requirements (e.g., viable system reports) • Pilot Volunteers: Provide initial validation of the new IRP Data Repository netting procedures and ensure conformance to requirements (i.e., netting data matches between existing and new systems) Responsibilities • Grant authority to the IRP Board of Directors to act on behalf of their interests • Provide expertise and knowledge to the project by allowing key personnel to contribute to the project’s outcomes. Select jurisdictions will provide volunteers to assist with, but not limited to, the following activities: o Project panels and volunteers o User feedback vis-à-vis beta testing o Focus groups o Surveys o Interviews • Provide financial resources to the project through their participation in the IRP Plan 1.5.4 Kentucky Transportation Center Role • Provides project management and commercial motor vehicle registration/safety services to IRP, Inc. on the IRP Data Repository Responsibilities • Assist IRP, Inc. in managing the project through the development and implementation stages • Develop the IRP, Inc. Project Management Plan and assist IRP, Inc. with its compliance. Notable PMP requirements include: o Assist IRP, Inc. with defining roles and responsibilities for project participants o Assist IRP, Inc. with developing a decision-making matrix for the project’s organizational authorities o Assist IRP, Inc. with defining a change control process o Assist IRP, Inc. with defining elevated project risks and corresponding mitigation measures • Monitor project schedule and assist IRP, Inc. with ensuring project participants adhere to project milestones and time-phased tasks • Assist IRP, Inc. with tracking Seikosoft progress and deliverables through the project timeline for contractual compliance Page 12 of 28
IRP Data Repository – Project Management Plan • Research and develop a service level agreement for the new IRP Data Repository • Develop written project progress updates and correspondence on behalf of IRP, Inc. to communicate with specified project stakeholders (see Communications Plan) • Plan and facilitate IRP Steering Panel and IRP Data Panel meetings • Document minutes/notes from IRP Steering Panel and IRP Data Panel meetings • Research funding opportunities such as federal grants • Develop grant applications, as applicable • Provide grant reporting for any financial awards received 1.5.5 Seikosoft Role • IT developer responsible for developing, operating, hosting, and maintaining the IRP Data Repository Responsibilities • Meet all requirements as stated within the First Statement of Work (SOW) dated August 28, 2020 • Meet all requirements as stated within the IRP Data Repository Development, Operation, Maintenance, and Hosting Agreement dated August 28, 2020 1.5.6 IRP Steering Panel Role • Serves as a mid-level authority for project governance, most notably on intermediate functional requirements and budget decisions Responsibilities • Serves as primary advisory group to IRP, Inc. and KTC on the project • Provides oversight and direction on the project • Issues intermediate executive decisions o On budget requests exceeding $10K but less than $25K for any milestones identified in the Seikosoft signed contract o On any intermediate changes to the functional requirements as identified in the Seikosoft signed contract • Supports the project through project review, guidance, and decisions, as needed 1.5.7 IRP Data Panel Role • Provides knowledge and expertise on data needs and requirements for the project, particularly in electronic verification of credentials (EVOC) Page 13 of 28
IRP Data Repository – Project Management Plan Responsibilities • Reviews and prioritizes data needs within the scope of the contract • Defines data requirements for the electronic verification of credentials • Defines data attributes for consistency across data fields • Identifies potential data needs for the future • Reviews and evaluates data errors from the different IRP Data Repository sources (e.g., member jurisdictions, database partners) • Proposes mitigation measures for data errors. These may include: o Screening protocols/logic for system o Standardization for data inputs o Automation to reduce manual errors • Actively participates and contributes to the project through scheduled meetings, feedback sessions, document reviews, and content creation PROJECT PLANS 1.6 SCHEDULE PLAN 1.6.1 Milestone Schedule The vendor’s proposed project schedule commences October 1, 2020 and concludes on August 30, 2022. It is divided into separate milestones associated with key deliverables and due dates. Page 14 of 28
IRP Data Repository – Project Management Plan Table 1. Seikosoft Project Milestones Milestone Deliverable Milestone Description Phase Number Date 1 1.0 Project Initiation 1 1-Oct-2020 2 5.0 Netting Functionality 1 1-Jan-2021 3 6.0 Historical Data Migration 1 1-Feb-2021 4 2.0 Hosting Environment Setup 1 31-Mar-2021 5 4.0 Back-End Base System Development 1 1-Apr-2021 6 3.0 Front-End Base System Development 1 1-Jun-2021 7 Phase 1 - 10%, Hold Back Released upon Successful Parallel Processing 1 8 7.0 Jurisdiction Onboarding - Current Layout 1 1-Sep-2021 Phase 1 - Hold Back Released upon Successful Onboarding of all 9 1 Jurisdictions to Current Layout and Normal Operation for 3 months. 10 11.0 Documentation and Training (Phase 1 Partial at 50%) 1 30-Sep-2021 11 9.0 FMCSA and Enforcement Interface 2 1-Oct-2021 12 8.0 Development of Dynamic Layout Tool 2 1-Nov-2021 Phase 2 - 10%, Hold Back Released when Milestones 11 and 12 are in 13 2 production for 30 days Phase 2 - 5%, Hold Back Released 30 days after the acceptance of Milestone 14 2 13 15 10.0 Jurisdiction Transition - Future Layout 3 1-Jul-2022 16 11.0 Documentation and Training (SOW 3 partial at 50%) 3 30-Aug-2022 17 12.0 Project Closeout (Phases I, II, and III) 3 30-Aug-2022 18 Phase 3 Hold Back Released upon Project Closeout 3 Page 15 of 28
IRP Data Repository – Project Management Plan Table 2. Seikosoft Project Schedule Phase I Phase II Phase III May-21 May-22 Mar-21 Mar-22 Nov-20 Aug-21 Nov-21 Aug-22 Milestone Task Description Dec-20 Dec-21 Sep-20 Oct-20 Feb-21 Apr-21 Sep-21 Oct-21 Feb-22 Apr-22 Jan-21 Jun-21 Jan-22 Jun-22 Jul-21 Jul-22 0.0 Continual Project Administration 1 1.0 Project Initiation 2 5.0 Netting Functionality 3 6.0 (a) Historical Data Migration - Option 1 4 2.0 Hosting Environment Setup 5 4.0 Back-End Base System Development 6 3.0 Front-End Base System Development 8 7.0 Jurisdiction Onboarding - Current Layout 10 11.0 Documentation and Training 11 9.0 FMCSA and Enforcement Interface 12 8.0 Development of Dynamic Layout Tool 15 10.0 Jurisdiction Transition - Future Layout 16 11.0 Documentation and Training 17 12.0 Project Closeout (Phases I, II, and III) 13.0 Initial SOC Audit Compliance 14.0 Hosting, Operations, and Maintenance Page 16 of 28
IRP Data Repository – Project Management Plan 1.6.2 Tasks & Deliverables Schedule Seikosoft will adhere to all requirements contained within the first statement of work dated August 28, 2020. Each of the listed 18 milestones has an agreed upon list of tasks and deliverables required for successful completion of that milestone. 1.6.3 Payment Schedule IRP, Inc. will pay the vendor (Seikosoft) per the terms and conditions stated within the IRP Data Repository Development, Operation, Maintenance and Hosting Agreement. Specifically, the vendor will be paid per the following: 7. Fees and Payment, Page 19: “Subject to all terms and conditions set forth herein, and SEIKOSOFT's performance of Services to IRP's reasonable satisfaction and IRP's Acceptance of the applicable Deliverables and SEIKOSOFT’s fulfillment of applicable Milestones, IRP shall pay SEIKOSOFT the fees ("Fees") for the work described in the RFP as contained in the Implementation Plan.” Milestone deliverables must be accepted by IRP, Inc. for satisfactory completion of the contract and subsequent payment. The deliverable review process will determine the status of successful milestone completion. This review process will include the following steps: 1. Vendor will provide milestone contractual deliverables by their respective due dates as stated within the SOW to IRP, Inc. 2. IRP, Inc. will have up to a two-week review and comment period to review the deliverables for acceptance (see First SOW). a. If any discrepancy is noted from the expected scope of the deliverable/s, then IRP, Inc. will notify the vendor of the discrepancy/s for correction. b. The vendor will have up to 3 business days to review the noted discrepancy/s and submit a plan for correction to IRP, Inc. 3. Upon IRP, Inc. acceptance, the payment to the vendor may proceed within the terms and conditions stated within the contract. 1.7 COMMUNICATIONS PLAN The IRP Data Repository project has many project participants and impacts various stakeholders. Robust and frequent communications are critical to project success. Due to geographical distances and time constraints, the primary means of communication will occur through Microsoft Teams. The Teams platform will allow for project members to Page 17 of 28
IRP Data Repository – Project Management Plan interactively engage in real-time through audio/video streaming. This forum also enhances project coordination through other capabilities including: • Repository for sharing documents • Allow real-time changes to documents by multiple users during sessions • Recording option for capturing meetings • Enhanced security through invite features and real-time participant monitoring In select instances, it may be beneficial to bring project members together in-person for a facilitated session and/or formal meeting. IRP, Inc. will make these determinations on a case-by-case basis and rely upon up-to-date protocols involving the still ongoing COVID- 19 health crisis. 1.7.1 IRP Board of Directors IRP, Inc. will provide periodic project updates to the IRP Board of Directors during regularly scheduled board meetings. These updates will typically occur through an oral or PowerPoint presentation. KTC may assist IRP, Inc. in that effort, as requested. KTC will also produce monthly progress reports for the board. These progress reports will highlight the project’s current status, major accomplishments, and expenditures incurred during the monthly period. 1.7.2 IRP Jurisdiction Members IRP, Inc. will provide quarterly progress reports to all IRP jurisdiction members throughout the development phase. KTC will develop these reports and send to IRP, Inc. for review and acceptance prior to dissemination. The one-page reports will provide a high-level description on the project’s status and major accomplishments. This report will also indicate future project tasks that may impact jurisdictions. 1.7.3 IRP Steering Panel IRP, Inc. and KTC will conduct monthly conference calls with the IRP Steering Panel. KTC will schedule and coordinate these meetings and provide agendas to participants beforehand. Typically, these calls occur during the 3rd Tuesday of each month from 11:00 am Eastern Standard Time and last one hour. Additional meetings may be scheduled on an as-needed basis. The purpose of these calls is to facilitate interactive dialogue and accomplish the following: • Provide project progress updates to the IRP Steering Panel, including completed work and deliverables • Promote discussion on project direction and focus Page 18 of 28
IRP Data Repository – Project Management Plan • Obtain periodic reviews and feedback from the IRP Steering Panel on project deliverables These meetings will take place primarily through Microsoft Teams. The provided agendas for each meeting will indicate the topic/s of discussion and any other pertinent notes. Afterward, KTC will draft meeting minutes and provide a copy to panel members. In some instances, IRP, Inc. and/or KTC may communicate with the IRP Steering Panel through focused and succinct emails for follow-up items stemming from meetings or other minor issues. The full 2020-2022 meeting dates are listed below. Table 3. IRP Steering Panel Meeting Schedule, 2020-2022 2020 2021 2022 Meeting Meeting Meeting Month Month Month Date Date Date January -- January 19 January 18 February -- February 16 February 15 March -- March 16 March 15 April -- April 20 April 19 May -- May 18 May 17 June -- June 15 June 21 July -- July 20 July 19 August -- August 17 August 16 September -- September 21 September -- October 20 October 19 October -- November 17 November 16 November -- December 15 December -- December -- 1.7.4 IRP Data Panel IRP, Inc. and KTC will conduct conference calls every two weeks with the IRP Data Panel or on an as-needed basis. KTC will coordinate the scheduling of these meetings and provide agendas to meeting participants beforehand. Typically, these calls occur during the 2nd and 4th Tuesday of each month from 11:00 am Eastern Standard Time and last one hour. Additional meetings (or longer scheduled meetings) may be scheduled on an as- needed basis. The purpose of these calls is to promote dialogue and accomplish the following: • Identify and discuss confirmed (and possibly emerging) data needs and requests for the IRP Data Repository • Prioritize data needs and requests • Define data attributes and standardization for data fields • Identify and review data errors and ways to mitigate them o Identify existing IRP member jurisdiction errors o Identify potential future IRP member jurisdiction errors Page 19 of 28
IRP Data Repository – Project Management Plan o Brainstorm and develop screening protocols and logic for identifying errors o Examine tools (e.g., automation) to reduce errors • Assign data reviews and/or tasks to select members and/or the overall panel on an as-needed basis These meetings will take place primarily through Microsoft Teams. The provided agendas for each meeting will indicate the topic/s of discussion and any other pertinent notes. Afterward, KTC will draft meeting minutes and provide a copy to panel members. In some instances, IRP, Inc. and/or KTC may communicate with the IRP Data Panel through focused and succinct emails for follow-up items stemming from meetings or other minor issues. The full 2020-2022 meeting calendar is tentatively projected with the project dates as listed below. Table 4. IRP Data Panel Meeting Schedule 2020 2021 2022 Meeting Meeting Meeting Month Month Month Date Date Date January -- January 12, 26 January 11, 25 February -- February 9, 23 February 8, 22 March -- March 9, 23 March 8, 22 April -- April 13, 27 April 12, 26 May -- May 11, 25 May 10, 24 June -- June 8, 22 June 14, 28 July -- July 13, 27 July 12, 26 August -- August 10, 24 August 9, 23 September -- September 14, 28 September -- October 27 October 12, 26 October -- November 10, 24 November 9, 23 November -- December 8 December 14 December -- 1.8 RISK REGISTER PLAN All projects have inherent risk. A risk is a known or unknown condition or event that can have an adverse impact on the project’s stated objectives and goals. For many projects, risks are most associated with unfavorable outcomes related to requirements, quality, schedule, and costs. Nevertheless, a risk may directly or indirectly impact any aspect of project management. This project management plan lists the anticipated risks associated with the IRP Data Repository project in the form of a risk register. Furthermore, the project management plan seeks to mitigate any identified risk through a mitigation plan. The mitigation plan recommends strategies for reducing the identified risks. However, no risk can be completely eliminated. Rather, KTC seeks to fully inform the project sponsors on the potential risks associated with this project, along with measures to counter those risk. In doing so, this strategy should allow all project stakeholders to successfully complete all tasks per the project work plan. Page 20 of 28
IRP Data Repository – Project Management Plan 1.8.1 Executive Support • Risk #1: Decision makers not clearly defined for project approval and/or decision points • Risk #2: Decision makers fail to reach agreement on approvals and/or decisions • Risk #3: Decision makers provide inadequate support to project (e.g., absent from project meetings, provide feedback past requested deadlines, etc.) • Mitigation Plan: IRP identifies a clearly defined approval process and decision- making bodies for inclusion into the approved work plan (see Governance Hierarchy). Project decision makers agree to abide by and cooperate within the architecture of the project’s statement of work and accompanying project management plan. This will help ensure that decision makers support final project decisions and meet their project commitments, including required meetings and reviews. 1.8.2 Scope • Risk #1: Scope lacks critical tasks and/or activities • Risk #2: Scope creep due to the additional requests during project duration • Risk #3: Estimates are inaccurate for scope (e.g., costs, time requirements) • Mitigation Plan: IRP, Inc. and Seikosoft have an agreed upon statement of work and contract detailing the scope of services required, including project milestones, tasks, costs, and schedule. Scope creep will be minimized through strict adherence to the statement of work, vendor contract, and the change control plan contained within this PMP. 1.8.3 Costs • Risk #1: Invoiced costs fail to meet the established standards stated within the SOW and the IRP Data Repository Development, Operation, Maintenance, and Hosting Agreement • Risk #2: Unanticipated cost exceedances occur during the course of this project • Mitigation Plan: IRP, Inc. will only provide scheduled payments when project milestones have been satisfactorily met per the SOW and the IRP Data Repository Development, Operation, Maintenance, and Hosting Agreement. Unanticipated cost exceedances will be submitted by Seikosoft to the Change Control Board using the process established within this PMP. 1.8.4 Changes • Risk #1: Changes requested outside of Change Control Plan Page 21 of 28
IRP Data Repository – Project Management Plan • Risk #2: Excessive changes requested by IRP, Inc., and other stakeholders • Risk #3: Ambiguous or non-specific changes requested by IRP, Inc., and other stakeholders • Mitigation Plan: IRP and Seikosoft will only implement changes per the stipulations found within the Change Control Plan, including the creation of a Change Control Board. Only project changes validated and approved by the Change Control Board will be considered for implementation. 1.8.5 Stakeholders 1 • Risk #1: Internal stakeholders fail to provide reviews and/or feedback in a timely manner per the project schedule • Risk #2: Internal stakeholder conflicts hinder consensus on project milestones and deliverables, particularly those items requiring review and/or approval • Risk #3: Internal stakeholders have inaccurate expectations involving project deliverables, schedule, etc. • Risk #4: Internal stakeholders become disengaged and ignore requests for information (e.g., surveys, interviews, etc.) • Risk #5: Legal and/or regulatory changes from external stakeholders impact project • Mitigation Plan: Internal stakeholders agree to abide by and cooperate with the scope contained within this PMP. This will help ensure that internal stakeholders agree to meet timely review requests and support project decisions as agreed upon through the formal approval process. Furthermore, IRP, Inc. and KTC will monitor the external environment for any potential issues (i.e., legal, regulatory, events) that could potentially disrupt or alter the project. 1.8.6 Communications • Risk #1: Miscommunications between IRP, Inc., Seikosoft, and any internal stakeholder groups (see organizational hierarchy) lead to a lack of shared understanding on intended requirements, inputs, timelines, etc. • Risk #2: Insufficient communications between IRP, Inc., Seikosoft, and any internal stakeholder groups lead to knowledge gaps and potential for unmet expectations at project milestones 1 Internal Stakeholders include those parties defined within the organizational hierarchy: IRP Board of Directors; IRP Member Jurisdiction; IRP, Inc.; IRP Steering Panel; IRP Data Panel; Seikosoft; and KTC. Page 22 of 28
IRP Data Repository – Project Management Plan • Risk #3: Excessive communications between IRP, Inc., Seikosoft, and any internal stakeholder groups lead to excessive project hours dedicated simply to communications and diverted from other project activities • Mitigation Plan: IRP, Inc., Seikosoft, and internal stakeholder groups will follow the communications plan as contained within the approved project management plan. 1.8.7 Resources • Risk #1: Inadequate vendor personnel resources available to meet project scope within budgetary and schedule constraints • Risk #2: Vendor personnel turnover leads to gaps in knowledge and/or increased workload distribution among remaining personnel • Mitigation Plan: Seikosoft will adhere to the project staffing plan contained within the contract. IRP, Inc. will work with Seikosoft to identify any concerns should Seikosoft experience unexpected attrition on any key project staff members. 1.9 CHANGE CONTROL PLAN Complex projects inherently entail risk, or a possible hazard, as requirements, schedules, and costs change through a project life-cycle. By themselves, changes are not necessarily harmful to the project’s intended outcomes. However, changes which lead to unexpected outcomes contribute to project risks. A major risk for any project is deviation from the original defined plan which results in an adverse outcome. Unforeseen changes frequently result in detrimental project outcomes, sometimes quite severe. This can be seen in the form of increased project resources, excessive costs, schedule delays, poor quality, inadequate standards, or a myriad of other unfavorable outcomes. For the purposes of this project, changes are defined as any item involving scope, requirements, schedule, budget, or a similarly-related project item that deviates from the originally approved Seikosoft contract, statement of work, and project management plan, respectively. The project will rely upon an IRP Change Control Plan (CCP) to make any official changes to the project contract, work plan, and management plan throughout its duration. This plan will rely upon designated groups with formal authority to authorize any changes to the contract, work plan, or management plan. No other project member, advisory official, or group forum can approve official project changes outside of the groups listed within this CCP. For this project, the change control plan will be delegated to three groups: the Change Control Board, the IRP Steering Panel, and the IRP Board of Directors. The initial change control authority will be the Change Control Board or CCB. This body is comprised of equal membership between Seikosoft, and IRP, Inc. The members on this board are as follows: Page 23 of 28
IRP Data Repository – Project Management Plan • Tim Adams, IRP, Inc. • Robin Murphy, IRP, Inc. • Chris Campbell, Seikosoft • Cody Marshall, Seikosoft The CCB will be responsible for making decisions on minor project changes. These insignificant changes are those expected to occur more frequently and do not have a medium- or large-scale impact on the project’s scope or budget. The CCB will meet and formulate a resolution anytime a minor discrepancy occurs from the original project scope or budget. The CCB will have sole authority for resolving changes when both of the following conditions apply: • On budget requests not exceeding $10K for any milestones identified in the Seikosoft signed contract • On any minor changes to the functional requirements as identified in the Seikosoft signed contract For scope or budget changes beyond these thresholds, the CCB is expected to elevate those concerns to the appropriate authority in accordance with the change control plan descriptions described further below. The IRP Steering Panel will be responsible for reviewing and authorizing any intermediate project changes. This panel has been authorized decision-making authority on behalf of the IRP Board of Directors when those decisions are minor to intermediate in nature. Specifically, any vendor or stakeholder requested changes to the vendor contract, statement of work, or project management plan require IRP Steering Panel approval whenever one of the following two conditions apply: • On budget requests exceeding $10K but less than $25K for any milestones identified in the Seikosoft signed contract • On any intermediate changes to the functional requirements as identified in the Seikosoft signed contract Any intermediate changes to the approved contract, work plan, or management plan may impact the project scope, resources, budget, and/or schedule. In such an event, the requesting party (e.g., vendor, stakeholder, etc.) will submit their change order request to IRP, Inc. at least 10 business days prior to the date of the requested change to initiate the review and approval process. The IRP Steering Panel will have up to 10 business days to review the request and make its decision. The IRP Board of Directors will be responsible for reviewing and authorizing any major project changes. Specifically, any vendor or stakeholder requested changes to the vendor Page 24 of 28
IRP Data Repository – Project Management Plan contract, statement of work, or project management plan require IRP Board of Directors’ approval whenever one of the following two conditions apply: • On budget requests exceeding $25K for any milestones identified in the Seikosoft signed contract • On any additions, deletions, or significant changes to the functional requirements as identified in the Seikosoft signed contract Any major changes to the approved contract, work plan, or management plan will likely impact the project scope, resources, budget, and/or schedule. In such an event, the requesting party (e.g., vendor, stakeholder, etc.) will submit their change order request to IRP, Inc. at least 20 business days prior to the date of the requested change to initiate the review and approval process. The IRP Board of Directors will have up to 20 business days to review the request and make its decision. The vendor will make a good faith effort to provide immediate notifications when they expect to make project changes impacting the original contract approval. Examples of significant changes may include, but are not limited to, the following: reduction in project scope to other items, increase in project budget, increase in personnel, lengthening of project schedule, or other project items. 1.10 DOCUMENTATION PLAN All official project documents will be stored and archived within the designated IRP Teams channel. This includes any documents developed by or for the following stakeholder groups: Seikosoft, IRP Steering Panel, IRP Data Panel, KTC, and IRP, Inc. Finalized documents may be transferred into the IRP share drive for archiving by authorized users (e.g., IRP, Inc. and KTC) upon completion Project documents may include, but are not limited to, the following: meeting agendas, meeting minutes, presentations, project plans, project decisions/approvals, and other deliverables. PROJECT MONITORING 1.11 METHODOLOGIES AND TOOLS IRP, Inc. and KTC will use the following tools during this project. • IRP Portal • Microsoft Office • Microsoft Excel • Microsoft PowerPoint • Microsoft Teams Page 25 of 28
IRP Data Repository – Project Management Plan IRP, Inc. and KTC also reserves the right to use other project tools that provide additional value to the project deliverables and/or outputs. Other tools will only be used if they provide added value to the final product and/or means of communication and enhance project outcomes. 1.12 MEASURING AND REPORTING PROGRESS KTC will assist IRP, Inc. with managing the overall project across the various project phases. In the initial development phase, this effort will primarily occur through three domains: scope, schedule, and costs. Additional details on those domains and their monitoring requirements are described within this section. Once the IRP Data Repository goes live, the primary management tool will be the approved Service Level Agreement (SLA) between Seikosoft and IRP, Inc. IRP, Inc. and KTC will monitor Seikosoft’s performance at this time using terms stipulated within the SLA, including their hosting, security, maintenance and tier 2 level help desk services. 1.12.1 Scope The IRP Data Repository scope encompasses those deliverables and milestones specified within the approved Seikosoft Statement of Work (082820) and Operation, Maintenance and Hosting Agreement (082820). If additional statements of work (SOWs) are added to this project at a later date, they will correspondingly be added to the overall project scope and monitored. Seikosoft will submit a monthly progress report as defined in the statement of work. This monthly status report will be submitted by Seikosoft within 5 business days of the close of each month. At a minimum, this report will include the following: • Identification and description of completed work items • Identification and description of work items not completed (in accordance with the project schedule) and why • Comprehensive list of issues by priority, status, and estimated completion date • List of all project risks and their mitigation strategies KTC will work directly with IRP, Inc. to monitor completed work items per these contractual agreements and upon official acceptance by IRP, Inc. 1.12.2 Schedule KTC will assist IRP, Inc. with monitoring the overall project schedule. This will rely on two components: vendor development schedule and stakeholder involvement. In the former, KTC will rely on Seikosoft’s released project schedule (see table 2) to track their on-time completion of required tasks. In the latter, KTC will actively take the lead in Page 26 of 28
IRP Data Repository – Project Management Plan coordinating meetings with the IRP Steering and Data Panels to ensure stakeholder involvement and project oversight. Those meetings are intended to follow the published schedule shown within Tables 3 and 4 within this document but may be subject to change. Additional meetings with other stakeholders may be requested on an as-needed basis at IRP, Inc.’s direction. 1.12.3 Costs KTC will assist IRP, Inc. with monitoring the overall project costs. The total costs are expected to be incurred across three groups: Seikosoft, KTC, and the Escrow Vendor. Seikosoft is the IRP Data Repository system developer and primary driver of costs. The other groups, KTC and Escrow Vendor, will help manage the overall project and secure software code via deposit, respectively. IRP, Inc. will provide copies of monthly invoices they receive from Seikosoft and the Escrow Vendor to KTC. KTC will combine these cost invoices with their own monthly invoice and develop a monthly cost tracker to monitor overall project costs. CLOSURE The project will be considered officially closed once the terms and conditions found within the vendor statement of work and contract have been successfully met. Page 27 of 28
IRP Data Repository – Project Management Plan Appendix A: Project Management Plan Approval The undersigned acknowledge they have reviewed the IRP Data Repository Project Management Plan and agree with the approach it presents. Changes to this Project Management Plan will be coordinated with and approved through the processes outlined within the Change Control Board (as shown in the Change Control Plan). Signature: Date: Print Name: Title: Role: Signature: Date: Print Name: Title: Role: Page 28 of 28
