EEXXEECCUUTTIIVVEE SSUUMMMMAARRYY - 0.1 BACKGROUND - Varanasi Development Authority ...

Page created by Tina Silva

CONTINUE READING
EEXXEECCUUTTIIVVEE SSUUMMMMAARRYY - 0.1 BACKGROUND - Varanasi Development Authority ...
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                EXECUTIVE SUMMARY

 EXECUTIVE SUMMARY
 0.1    BACKGROUND
        Varanasi is the fifth most populous city in the state of Uttar Pradesh and it is often
        referred to as "the holy city of India" or “the religious capital of India". Varanasi is well
        connected by road, rail and air with other parts of the country. The city is surrounded
        by Jaunpur and Azamgarh in north, Bhadoi and Allahabad in west, Mirzapur and
        Robertsganj in south & Mughal Sarai and Ghazipur in east. Varanasi is a tourist centre
        with ghats, temples, educational and archaeological sites as main attractions. Varanasi
        is a UNESCO declared heritage city attracting sizable number of tourist from across the
        world each year. The city also has a strong cantonment base along with Diesel
        Locomotive Works (DLW) and Bharat Heavy Electrical Ltd. (BHEL) as major industrial
        units.

        As per the National Urban Transport Policy (NUTP), Comprehensive Mobility Plan
        (CMP) for Varanasi was prepared in 2009 which lays out a set of measured steps that
        are designed to improve transportation scenario in the city in a sustainable manner.
        The CMP proposes a total of 57.5 km length of rail based mass rapid transit system
        (MRTS) network in Varanasi. 25.9 km of the proposed network was to be completed in
        Phase II (2015 – 2019) and the remaining network to be completed in Phase III (2020 –
        2029) of implementation programme.

        The State Government has now decided to introduce an efficient, safe and high
        capacity rail based transport system in Varanasi. RITES Ltd. has been engaged to
        prepare Detailed Project report (DPR) of Rail Based Mass Rapid Transit System (MRTS).

        The study area for the assignment is boundary of Varanasi Urban Agglomeration or
        the administrative boundary of Varanasi Development Authority (VDA) for which the
        Master Plan 2031 has been prepared. The study area expands over 260 SqKm and
        includes Varanasi Municipal Area, Varanasi Cantonment Board, Manduadih Railway

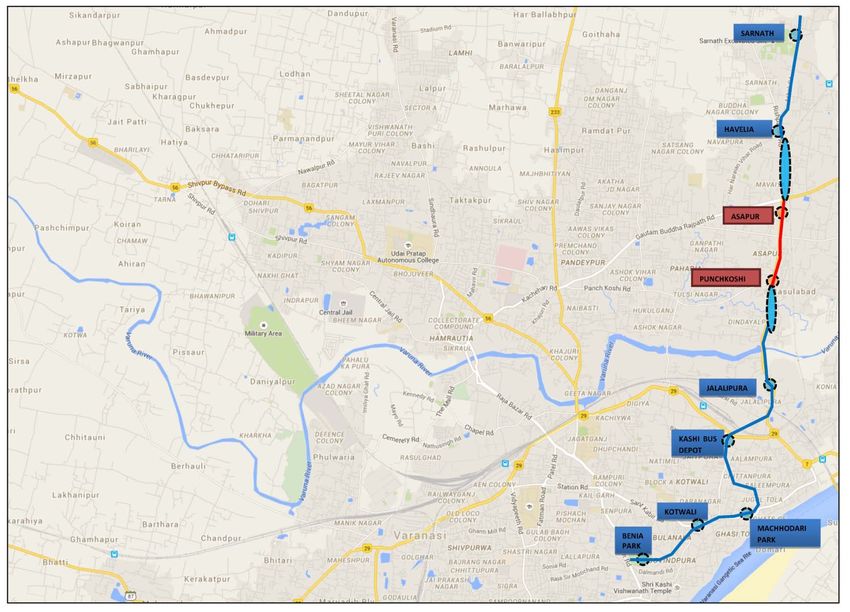

        Settlement, Phulwaria, Shivdaspur and Kandwa. (Figure 0.1)

 0.2    FUTURE GROWTH AND TRANSPORT DEMAND FORECAST
        The Master Plan for Varanasi 2031 outlines the likely growth in various parts of the
        study area. The projected population, employment and student enrolment in the
        years 2021, 2031 and 2041 is presented in the Table 0.1.

                                                       February, 2016                   Page 0‐1
EEXXEECCUUTTIIVVEE SSUUMMMMAARRYY - 0.1 BACKGROUND - Varanasi Development Authority ...
Detailed
 D        Project Repo
                     ort for Rail Based Masss Transit System in Varanasi
                                                                V
Fin
  nal Report                                                                   EXECUTIVE SUMMARY
                                                                                         S

                                                   FIGURE 0.1:STUDY AREA ‐ VARANASI
                                                                           V        DEVELLOPMENT AUTHO
                                                                                                     ORITY AREA

                                                        February, 2016                   Page 0‐2
EEXXEECCUUTTIIVVEE SSUUMMMMAARRYY - 0.1 BACKGROUND - Varanasi Development Authority ...
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                       EXECUTIVE SUMMARY

                                       TABLE 0.1: LANDUSE PARAMETERS

         SN                   Parameters                    2015          2021   2031   2041
         1         Population (Lakh)                         20.6         25.7   31.4    33.6
         2         Employment (Lakh)                         5.8          7.6    9.8     12.0
         3         School Enrolment (Lakh)                   4.9          6.2    7.6     9.0

        A number of traffic & travel surveys were conducted to appreciate and quantify
        the traffic and transport characteristics of commuter travel within the Study
        Area. This data analysis has helped us in accessing existing traffic characteristics
        and developing the Travel Demand Model.

        Comprehensive field surveys and house hold survey were carried out within the
        study area and are listed as under:

              i.       Road Network Inventory Surveys
              ii.      Speed & Delay Surveys
              iii.     Classified Traffic Volume Count Surveys (Mid‐blocks / Screen lines,
                       Intersections & Outer Cordons)
              iv.      Origin‐Destination Surveys at Outer Cordon Locations
              v.       Terminal Passenger (in + out counts) & OD Surveys including Opinion
                       and Willingness to Pay Survey at Bus, Rail Terminals and Airport
              vi.      Bus stops/Auto Stand/IPT Surveys (boarding + alighting + OD) including
                       Opinion and Willingness to Pay Survey
              vii.     Pedestrian Movement Counts
              viii. Parking Surveys
              ix.      Household Interview Surveys
              x.       Work Centre Surveys

        Based on extensive traffic surveys, CMP proposals, Master Plan 2031 and
        extensive consultation with all Stake holders following two priority corridors
        were identified.

        A four stage travel demand model has been developed for transport demand
        forecasting. The daily ridership is shown in the Table 0.2. Total Daily ridership on
        the Phase‐I metro corridors for the years 2021, 2031 and 2041 is expected to be
        5.1 Lakh, 6.7 Lakh and 9.2 Lakh passengers respectively.

                                                       February, 2016                           Page 0‐3
Detailed Project Report for Rail Based Mass Transit System in Varanasi
  Final Report                                                                              EXECUTIVE SUMMARY

                          TABLE 0.2: RIDERSHIPON PHASE‐I METRO CORRIDORS

                            Corridor                      Year              Daily Trips (Lakh)
                                                         2021                      3.2
                  BHU to BHEL                            2031                      4.2
                                                         2041                      5.9
                                                         2021                      1.9
                  BeniaBagh to Sarnath                   2031                      2.5
                                                         2041                      3.2

          The peak hour station boarding and alighting on Phase‐I metro corridors are
          presented in Table 0.3.

                       TABLE 0.3: STATION LOADS ON PHASE‐I METRO CORRIDORS

                                      Peak Hour 2021*              Peak Hour 2031*           Peak Hour 2041*
           Station
                                    Boarding Alighting           Boarding Alighting         Boarding Alighting
Corridor 1: BHU to BHEL
BHU                             5000      4600                     8100         5200             12800     12100
TulsiManasMandir                600       1600                     800          1700              800      1800
Ratnakar Park                   1700      1300                     2300         1400              2500     1700
Kali Bari                       1100      1100                     1600         1700              2200     2500
Kashi Vishwanath                2200      2300                     2500         2500              2800     2800
BeniaBagh                      11600     12300                    15200         16600            17400     17600
Rathyatra Chowk                 1800      1700                     2100         2000              5000     3200
Kashi Vidyapeeth                9100      6700                    10000         11300            14300     11500
Varanasi Junction               9000      8900                    12700         10100            13200     13500
Nadesar                         1000      2100                     1100         2900              1400     3700
Collectorate                    1400      2000                     3200         2500              3800     4800
Bhojubeer                       1400      1200                     1900         3000              5100     5300
Gilat Bazar                     1600      1600                     1900         1900              2100     2200
Sangam Colony                   1100      1000                     1300         1100              1400     1200
Shivpur                         800        800                     900          1000              1000     1100
Tarna                           1400      1800                     1600         2200              1900     2700
BHEL                            2100      2100                     2600         2600              3300     3300
Corridor 2: BeniaBagh to Sarnath (Akashwani)
Beniabagh                      11600     11100                    15700         14600            16400     16500
Kotwali                         2500      2900                     2700         3400              3000     3500
Machodari Park                  3200      3300                     3500         3600              3900     4000
Kashi Depot                     3800      4700                     5000         6300              6400     6500
Jalalipura                      600        500                     700           600              1600     1500
PanchKoshiChauraha              500        500                     600           600              800       700
AshapurChauraha                 5500      4700                     6400         5700              7600     6700
Havelia                         900       1200                     1100         1500              1400     1900
Sarnath                         2300      2100                     3400         3100              3900     3600
   * Two way boardings/alightings

                                                         February, 2016                                  Page 0‐4
Detailed Project Report for Rail Based Mass Transit System in Varanasi
 Final Report                                                                        EXECUTIVE SUMMARY

           The peak hour design ridership on Phase‐I metro corridors are presented in
           Table 0.4.

                   TABLE 0.4: DESIGN SECTION LOAD ON PHASE‐I METRO CORRIDORS

Corridor                  Corridor details                                   Design PHPDT
  No.                                                          2021        2031         2041     Design
   1         BHU to BHEL                                       13000       15500       20000     24000
   2         Beniabagh to Sarnath                              10000       13500       15500     18000

           Metro ridership increases gradually and the 2023 ridership is taken same as that
           of the year 2021 for the design purpose.

  0.3      SYSTEM DESIGN
  0.3.1     Permanent way
           Gauge

           The options available for P‐way Gauge are – Broad Gauge (1676mm), Standard
           Gauge (1435mm), Meter Gauge (1000mm). Standard Gauge (1435mm) is being
           used worldwide for metro railways with modern state of the art technology.
           Standard Gauge permits sharper curves (120m), which is advantageous for
           metro alignment in urban scenario. It also results in minimized property
           demolition / acquisition. The Land requirement for the maintenance depots,
           where a large number of lines are connected together, is also lower in Standard
           Gauge.

           Standard Gauge rolling stock results in recurring saving in energy consumption
           during operation as for the same passenger carrying capacity, gross weight of a
           metro coach is lower than for the Broad Gauge.

           As the metro rail alignment will pass through built‐up areas / stretches and in
           view of the advantages offered by Standard Gauge, it is proposed to adopt
           Standard Gauge (1435mm).

           Rail Section and Grade

           For main lines, 60KG UIC HH rails of grade 1080 are proposed. For other than
           main lines and Depot lines, 60 kg rails of grade 880 (without Head hardening) are
           proposed. These rails are being manufactured indigenously. The rails for main
           lines and depot lines should also conform to the technical specifications laid
           down by Indian Railways in IRS‐T‐ 12‐2009.

                                                        February, 2016                         Page 0‐5
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                              EXECUTIVE SUMMARY

        The rails should have cant of 1 in 20 and wheel profile of rolling stock should be
        compatible with rail profile.

        Formation

        Ballast less track is proposed for elevated and underground stretches. At Depot,
        following track structure is proposed to serve specific usage:‐

              Ballast less for Washing Line
              Steel pedestal for inspection lines
              Embedded Rail type inside Workshop
              Conventional Ballasted track for Stabling and other line

        Fastening System for Ballasted Track

        In Feb. 2015, Govt. of India, Ministry of Railways, has issued “Procedure for
        Safety certification and Technical clearance of Metro System”. Part‐A, Annexure
        C‐2 of the said document covers “Performance criteria of fastening system for
        ballastless track on Metro Railways/MRTS System”. Ministry of Railways has
        already approved certain fastening systems complying the requisite
        performance criteria.

        Further, scope for introduction of “new fastening system” has been made
        available (for those not approved by Ministry of Railways) with the proviso
        thatthe details of such fastening systems shall be made available to Ministry of
        Railways (MoR) and the same will be kept under observation by MoR for a
        period of two years under service conditions in association with Metro
        Railways/MRTS system.

        Turnouts and Scissor Crossover

        From considerations of maintainability and riding comfort, it is proposed to lay
        following two types of turnouts:

              On main lines, 1 in 9 type turnout with a lead radius of 300 m and speed
               potential on divergent track as 45 km/h.
              However, at BeniaBagh station, due to space constraint, 1:7 crossovers
               have been proposed with lead radius of 140m and speed potential on
               divergent track as 25km/h.
              On Depot lines, 1 in 7 type turnout with a lead radius of 140 m and speed
               potential on divergent track as 25 km/h.
              The Scissors cross‐overs on Main Lines (1 in 9 type) will be with a minimum

                                                       February, 2016               Page 0‐6
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                              EXECUTIVE SUMMARY

               track centre of 4.5 m.
         Welding

         To minimize noise and vibrations, track joints should be welded by Flash Butt
         Welding Technique and Alumino‐Thermit Welding may be done only for those
         joints which cannot be welded by Flash Butt Welding Technique.

 0.3.2    Traction system

         Traditionally, electric traction is used in Metro systems for requirement of high
         acceleration and pollution‐free services in urban areas. There are three standard
         and proven systems of electric traction for use in suburban and metro lines, viz:‐
         750V dc third rail, 1500V dc overhead catenary and 25kV ac overhead catenary
         system. All the three systems are presently in use in India (750 V dc third rail in
         Kolkata & Bangalore Metro, 1500V dc catenary in Mumbai suburban of Central
         Railways and 25 kV ac catenary in Delhi, Jaipur, Chennai, Hyderabad Metro &
         Indian Railways). 1500 V dc system of Central Railways in Mumbai suburban is
         currently being converted to 25 kV ac to meet increase traffic demand.

         The 1500V DC third rail system has been adopted in Chinese Metros by
         Guangzhou Metro and Shenzhen Metro during last decade. There is not much
         experience over use of 1500V DC third rail system and also it has major
         constraints on requirement of power block for any kind of attention to track,
         signaling and other equipment.

         Worldwide about 65% of the Metro rail Systems have 750V DC Third Rail traction
         system. The system offers the advantage of aesthetics, reliability and low
         maintenance. However, the traffic handling capacity is limited to about 45,000
         PHPDT. The traffic demand estimated for the corridors of Varanasi Metro is
         about 24000 passengers for BHU to BHEL corridor and 18000 passengers for
         Beniabagh to Sarnath corridor.

         Considering the ultimate traffic demand and the techno economic advantages
         offered by 750V DC system, it is proposed to adopt 750V DC Third Rail system for
         Varanasi MRTS.

 0.3.3    Rolling stock

         Rolling Stock proposed for Varanasi Metro will be similar to Bangalore/ Kochi
         Metro. Rolling stock will be suitable for grade of operation GoA3 or higher. The
         specifications of the rolling stock and its procurement may be decided on the
         basis of the project implementation mechanism. The broad features of Rolling
         Stock which may be followed for the present corridor are presented in Table 0.5.

                                                       February, 2016                Page 0‐7
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                             EXECUTIVE SUMMARY

                           TABLE 0.5: BROAD FEATURES OF ROLLING STOCK

         S.N.             Parameter                                       Description
                 Vehicle dimensions
                 Length (including coupler)           22.6 m
         1
                 Width                                2.9 m
                 Height                               3.9 m
         2       Train Composition                    3 CAR‐ DMC + TC + DMC
         3       Coach construction                   Lightweight stainless steel/Aluminium body
         4       Axle load                            16 T
         5       Propulsion system                    3 phase drive system with VVVF control
         6       Type of traction supply              750 V DC Third Rail Traction

         The carrying capacity of Metro Rail Vehicle is indicated in Table 0.6

                            TABLE 0.6: CARRYING CAPACITY OF METRO RAIL

                      Driving Motor Car
                                                       Trailer Car (TC)                 3 Car Train
                            (DMC)
  Description
                                        Dense              Dense                                      Dense
                   Normal Crush               Normal Crush       Normal                   Crush
                                        Crush              Crush                                      Crush

     Seated          43         43        43         50        50         50     136       136         136
    Standing         102       204        272       110        220        293    314       630         839

      Total          145       247        315       160        270        343    450       766         975

 0.3.4       Ventilation and air‐conditioning system

         The underground stations of the corridor are built in a confined space. A large
         number of passengers occupy concourse halls and the platforms, especially at
         the peak hours. The platform and concourse areas have a limited access from
         outside and do not have natural ventilation. It is therefore, essential to provide
         forced ventilation in the stations and inside the tunnel.

         The large quantity of heat generated in underground stations cannot be
         extracted by simple ventilation, especially when the outdoor air temperature
         and humidity is high. It is, therefore, essential to provide mechanical cooling in
         order to remove the heat to the maximum possible extent. As the passengers
         stay in the stations only for short periods, a fair degree of comfort conditions,
         just short of discomfort are considered appropriate.

         The details of the Ventilation and Air‐conditioning (VAC) system requirements
         for the underground section of the proposed corridors include the following:

                                                       February, 2016                                  Page 0‐8
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                 EXECUTIVE SUMMARY

                        Station Air‐conditioning System
                        Ventilation System for station plant rooms (ancillary spaces)
                        Station Smoke Management System
                        Tunnel Ventilation System

 0.3.5    Signalling system

         The signaling system shall provide the means of an efficient train control
         ensuring safety in train movement. It assists in optimization of metro
         infrastructure investment and running of efficient train services on the network.
         The Signaling & Train Control system will ensure –

              High level of safety with trains running at close headway ensuring
               continuous safe train separation.
              Eliminate accidents due to driver passing Signal at Danger by continuous
               speed monitoring and automatic application of brake in case of disregard
               of signal / warning by the driver.
              Provide safety and enforces speed limit on section having permanent and
               temporary speed restrictions.
              Improve capacity with safer and smoother operations. Driver will have
               continuous display of Target Speed / Distance to Go status in his cab
               enabling him to optimize the speed potential of the track section. It
               provides signal / speed status in the cab even in bad weather.
              Moving block feature shall provide enhancement of headway.
              Increase productivity of rolling stock by increasing line capacity and train
               speeds, and enabling train to arrive at its destination sooner. Hence more
               trips will be possible with the same number of rolling stock.
               Improve maintenance of Signaling and telecommunication equipments by
               monitoring system status of trackside and train born equipments and
               enabling preventive maintenance.

         The Communication based Train Control (CBTC) Signaling system provides
         adequate safety level of CENELEC SIL‐4 (Safety Integrity Level) and permits an
         operational headway of 90 seconds with continuous automatic train control. The
         CBTC Technology is proven now in many metros around the world and is also
         suitable for UTO (Unattended Train Operation) / DTO (Driverless Train
         Operation). Considering the above, CBTC system is recommended to be adopted
         for Varanasi Metro corridors.

                                                       February, 2016                    Page 0‐9
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                              EXECUTIVE SUMMARY

 0.3.6    Telecommunication

         The telecommunication system acts as the communication backbone for
         Signaling and other systems and provides telecommunication services to meet
         operational and administrative requirements of metro network shall be based
         on Giga Ethernet based IP network system.

         The state of the art latest technology being used in different metros worldwide,
         is proposed to be provided for the Varanasi MRTS.

 0.3.7    Fare collection system

         Mass Rapid Transit Systems handle large number of passengers. Ticket issue and
         fare collection play a vital role in the efficient and proper operation of the
         system. To achieve this objective, ticketing system shall be simple, easy to
         use/operate, easy on accounting facilities, capable of issuing single/multiple
         journey tickets, amenable for quick fare changes and require overall lesser
         manpower. Automatic fare collection system meets these requirements.

         The AFC system shall have functionality of interface to CCHS (Central Clearing
         House System) facility with provision of integration with other transit (metro,
         bus etc) and non‐transit (parking, toll etc) which may be planned in future in line
         with the state / national policy. In addition, the proposed AFC system shall also
         be NFC (Near Field Communication) enabled so that customers can use their NFC
         enabled Mobile phones for metro travel. Facility of recharging of Travel Cards
         using Cash, Debit/Credit Cards and Netbanking/web portal shall also be
         available. AFC system shall also support offsite sales terminals also, wherein
         cards and tokens can be dispensed at locations outside metro premises.

         Keeping in view Metro Railways Automatic Fare Collection System and the fact
         that Contactless card/ token technology proves to be cheaper than magnetic
         technology in life cycle cost due to reduced maintenance, it is proposed to
         provide computer based automatic fare collection system with Contactless
         smart token/card type ticketing.

 0.3.8    Platform screen doors (PSD)

         Platform Screen Doors (PSD) are proposed to be provided at stations to screen
         the passengers on the platform from the track. These glass doors shall be
         powered for automatic operation and located along the platform at the platform
         edge throughout the passenger area. The door locations will be corresponding to
         the train car passenger door locations. Opening/ closing of the PSD will be after
         receipt of the DOORS OPEN/ DOORS CLOSE command signals from the Signalling
         Link. Signalling link enables automatic operation of PSD only when the train

                                                       February, 2016               Page 0‐10
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                             EXECUTIVE SUMMARY

         stops within ±300mm limits.

         Considering the fact that half height PSD are cheaper to install than full height
         platform screen doors requiring more metallic framework for support, it is
         recommended to provide half height Platform Screen Doors at all the stations.

 0.4      CIVIL ENGINEERING
 0.4.1     Geometric design parameters

                                      TABLE 0.7: DESIGN PARAMETERS

          SN                      CRITERIA                                   DIMENSION
          1     Gauge                                                          1435 mm
          2     Design Speed                                                   90 Kmph
          3     Maximum Axle Load                                                16T
          4     Electric Power Collection                                 750V DC, THIRD RAIL

                             TABLE 0.8: HORIZONTAL CURVE PARAMETERS

                        Description                         U/G Section           Elevated Section
         Desirable Minimum Radius                               300 m                   200 m
         Absolute minimum Radius                                200 m                   120 m
         Minimum curve radius at stations                                   1000 m
         Maximum permissible cant (Ca)                                     110 mm*
         Maximum cant deficiency (Cd)                                       85 mm
         * The applied cant will be decided in relation to normal operating speeds at specific locations
           like stations/vicinity to stations.

                    TABLE 0.9: TRACK CENTRE AND HEIGHT IN ELEVATED SECTION

                                                         Minimum Track       Minimum Rail Level above
                 Parameter
                                                            Centre                Ground Level
         Mid‐Section                                         4.00 m*                   7.50 m**
         Station w/o Scissor Cross‐over                       4.00 m                   12.00 m
         Station with Scissor Cross‐over                      4.50 m                   12.00 m
       Note:
        *Track centre in elevated section can be modified as per the choice of
          girder/superstructure. For Double U‐girder minimum 4.60 m track centre will be
          provided.
       **For I‐girder and Box‐girder, Minimum Rail Level above Ground Level shall be 8.50 m

                                                       February, 2016                                Page 0‐11
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                           EXECUTIVE SUMMARY

               TABLE 0.10: TRACK CENTRE AND DEPTH IN UNDERGROUND SECTION

                                                      Minimum Track
                       Description                                        Depth below Ground Level
                                                          Centre
         Running section by TBM
                                                           15.00 m                20.0 m
         Running section by cut & cover except
                                                           4.60 m                 12.60 m
         ramp
         Stations by cut & cover and 13m island
                                                           16.03 m                20.0 m
         PF
         Stations by cut & cover and side
                                                           4.60 m                 20.0 m
         platform
         Stations by NATM
                                                           22.00 m                20.0 m

                                  TABLE 0.11: GRADIENT PARAMETERS

                 Description                        Desirable               Absolute Minimum
           Gradient at Mid‐Section                   Upto2%               Upto 4% (compensated)
           Gradient at Stations                        Level                   Upto 0.25%

                               TABLE 0.12: VERTICAL CURVE PARAMETERS

                Parameter                                                   Vertical Curve
         Desirable Radius on Main line                                         2500 m
         Absolute Minimum Radius on Main line                                  1500 m
         Minimum Length of Vertical Curve                                       20 m

 0.4.2     Engineering Survey
           Topographic Surveys
           i) Establishment of Horizontal Control Points using DGPS
           ii) Densification of Horizontal Control Points using Total station
           iii) Establishment of Vertical Control Points
           iv) Detailed survey of corridor
           v) Preparation of drawings.
           vi) Site verification of features and finalization of drawings.
           vii) Alignment design on basis of verified drawings

 0.4.3     Geotechnical investigations
           General Geology & Related Characteristics

         The general geological sequence of Varanasi region can be classified on the basis
         of lithology, the Quaternary sediments of the Gangetic plain have been broadly
         classified into Older Alluvium (Banda Alluvium and Varanasi Alluvium) and
         Newer Alluvium. The Banda Alluvium, which has provenance in

                                                       February, 2016                             Page 0‐12
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                            EXECUTIVE SUMMARY

         peninsular/cratonicregion rests over the Precambrian rocks. The sediments of
         Varanasi Alluvium of (Middle to Late Pleistocene age) derived from the
         Himalayan provenance overlie Banda Alluvium. The Newer Alluvium represents
         the youngest sequence. Generally, this sequence is confined within the flood
         plain limits of present day rivers. The area under study belongs to the central
         part of the Gangetic Alluvial Plain.

         The main drainage is provided by southeasterly flowing Ganga river whose
         braided course in the area has a maximum width of 5 km near Fatehgarh. The
         major tributaries flowing through the northern gangetic plain include Ramganga
         and Garra, having their confluence with Ganga at Bhojpur (1.5 km. d/s of
         Fatehgarh) and Kannauj, respectively. The generalized geological succession is
         shown in Table 0.13.

                           TABLE 0.13: GEOLOGICAL SUCCESSION IN VARANASI

      UNIT                                 LITHOLOGY

      NEWER ALLUVIUM
      Ganga, Ramganga, Garra, Kali
                                           Light grey, fine to medium‐grained sand,
      recent
                                           laminated clay and minor silt.
      Alluvium
      Ganga. Ramganga, Garra
                                           Fine to medium‐grained grey micaceous sand
      terrace
                                           with thin layers of silt and clay.
      Alluvium.
      Disconformity
                                           Polycyclic sequence of clay and silt with
      Silt‐clayey facies
                                           concrete and ferruginous concretions.
      Sandy facies                         Oxidised brownish micaceous sand and silt.

         Geotechnical Investigations

         In total, 30 BHs have been drilled of 30 m depth each, all along the length of
         proposed Metro alignment. 20BHs have been drilled in Corridor‐I (BHEL to BHU),
         9 BHs have been drilled in Corridor‐II (Sarnath to Kotwali) & 1 BHs have been
         drilled for depots.

         Considering field and lab test results, pile foundations have been recommended for
          the proposed viaduct at locations of BH‐1 to BH‐4, BH‐21to BH‐24, & BHD‐1.Shallow
          foundation is also recommended at location of BH‐D‐1 for light weight structures.
          Portion between BH‐5 to BH‐20 & BH‐25 to Bh‐29 is proposed as underground section.

                                                       February, 2016                            Page 0‐13
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                      EXECUTIVE SUMMARY

         The load capacities of piles are based on empirical correlation’s and should be
          confirmed by conducting pile load test as per IS: 2911 (Part 4) on test piles before
          execution of working piles.

         Since the proposed site is situated in seismic Zone III of the seismic zonation map of
          India, suitable seismic coefficient commensurate to seismic Zone III(IS: 1893) should
          be adopted in the design of the structures.

         Wherever Undisturbed samples (UDS) could not be obtained due to stiff soil (SPT
          value more than 30), cohesion & angle of internal friction values have been obtained
          from observed SPT N value.

 0.4.4    Route alignment
          Corridor‐1: BHEL to Banaras Hindu University

          Considering centre line of BHEL station as 0.00m, this corridor is 19350m long starting
          from ‐325m and running upto 19025m. This corridor consists of elevated and
          Underground stretches along with Switch over Ramps (SOR). The corridor is
          summarized in Table 0.14.

                         TABLE 0.14: SUMMARY OF SECTIONS OF CORRIDOR 1

    Alignment Type                            From(m)                     To(m)   Length(m)
    Elevated                                     ‐325                     3321      3646
    Ramp (+)7.5m to (‐)8.0m                      3321                     3755      434
    Underground                                  3755                    19025      15270
    Total                                                                           19350

              The proposed alignment of Corridor‐1 starts near BHEL along NH‐56. The
               alignment starts along NH‐56 as elevated and heads in East direction.
              Total length of the section is about 3.65 Km. Figure 0.2 shows the proposed
               corridor.
              Depot for both the corridors is proposed in Ganeshpur Land near BHEL.
               Total area required for the depot is 13.2 Hac.
              Total length of the corridor is 19.35 Km and is elevated for a length of 3.856
               Km, underground for 15.494 Km and 0.12 Km for depot entry/exit.
              17 stations have been proposed consisting of 4 elevated stations and 13
               underground stations.
              Summary of Special spans & Portals may be referred in Chapter 4 of this
               DPR.

                                                        February, 2016                      Page 0‐14
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                          EXECUTIVE SUMMARY

               Switch Over Ramp
              Ramp is required to provide transition from Elevated to underground alignment
               after Sangam Colony station. Horizontal and vertical alignment in this stretch has
               been designed in such fashion so that minimum land is required.
              The ramp (7.5m to (‐) 8.0m) has been proposed at limiting gradient of 4%
               (compensated) from Ch: 3310 m to Ch: 3744 m to become underground. About
               4340sqm land for locating the ramp will be required permanently in State
               Government road.
              MORT&H is planning for road widening of NH‐56 from Babatpur to GIlat Bazar.
               The planning is in initial stage and drawings are not developed. Consequently,
               MORT&H is informed the planning of MRTS corridor in the section from BHEL to
               Gilat Bazar.
                     TABLE 0.15: ABSTRACT OF HORIZONTAL CURVES – CORRIDOR 1

                                                   No. of
              S. No.       Curve Radius                                   Length   Percentage
                                                 Occurrences
                 1            ≤190                     0                   0.00      0.00
                 2         >190 500 ≤ 800                  3                   1472      12.47
                 5        >800 ≤ 1000                  2                    275      2.33
                 6           >1000                     1                    120      1.02
                             Total                    36                  11800     100.00

                         TABLE 0.16: ABSTRACT OF GRADIENTS – CORRIDOR 1

                                                   Nos. of                Length       %
              S. No.        Description
                                                 Occurrences                (m)      Length
                 1            Level (0%)              17                  6585       34.03
                 2          >0% to 1%                 14                  8674       44.82
                 3          >1% to 2%                 11                  2751       14.22
                 4          >2% to 3%                  3                   626        3.23
                 5              >3%                    1                   715        3.69
                               TOTAL                  46                  19350     100.00

        Corridor‐2: Benia Bagh to Sarnath

        Considering centre line of Benia Bagh station as 0.00m, this corridor is 9885 m long
        starting from (‐)245m and running upto 9395m and including 245m stabling lines at
        Beniabagh. This corridor starts with first station at BeniaBagh.

                                                       February, 2016                           Page 0‐15
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                              EXECUTIVE SUMMARY

        Track interchange between corridor‐I & II is planned at this station. The corridor runs
        underground from Benia Bagh upto Jalalipura. Further, it ramps up on North side of
        Varuna river with two elevated station at Punchkoshi and Asapur. The corridor further
        ramps down after crossing proposed flyover at Asapur road crossing. The corridor then
        runs underground from Havelia and terminates at Sarnath in Post Office land.

        The corridor is summarised in Table 0.17

                          TABLE 0.17: SUMMARY OF SECTIONS: CORRIDOR‐2

                                                         Chainage (m)                        Length
                Description
                                                From                       To                  (m)
   Underground                                  ‐245                      5300               5545
   UG Stablings                                   ‐                         ‐                245
   Ramp                                         5300                      5687               387
   Elevated                                     5687                      7235               1548
   Ramp                                         7235                      7625               390
   Underground                                  7625                      9395               1770
                                                                          Total              9885

                      TABLE 0.18: ABSTRACT OF HORIZONTAL CURVES – CORRIDOR 2

                                                No. of
         S. No.        Curve Radius                                       Length         Percentage
                                              Occurrences
            1               ≤190                     0                     0.00             0.00
            2           >190 500 ≤ 800                   1                     119              2.13
            5          >800 ≤ 1000                   2                     454              8.14
            6              >1000                     2                     215              3.86
                            Total                   21                     5570            100.00

                            TABLE 0.19: ABSTRACT OF GRADIENTS – CORRIDOR 2

                                                   No.s of
                                                                                             Percentage
       S. No.             Description            Occurrences                Length (m)
          1               Level (0%)                 11                        3225             33.46
          2               >0% to 1%                   5                        2754             28.57
          3               >1% to 2%                   2                         393             4.08
          4               >2% to 3%                   6                        1049             10.88
          5                  >3%                      3                        2218             23.01
                            TOTAL                    27                        9639            100.00

                                                         February, 2016                               Page 0‐16
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                              EXECUTIVE SUMMARY

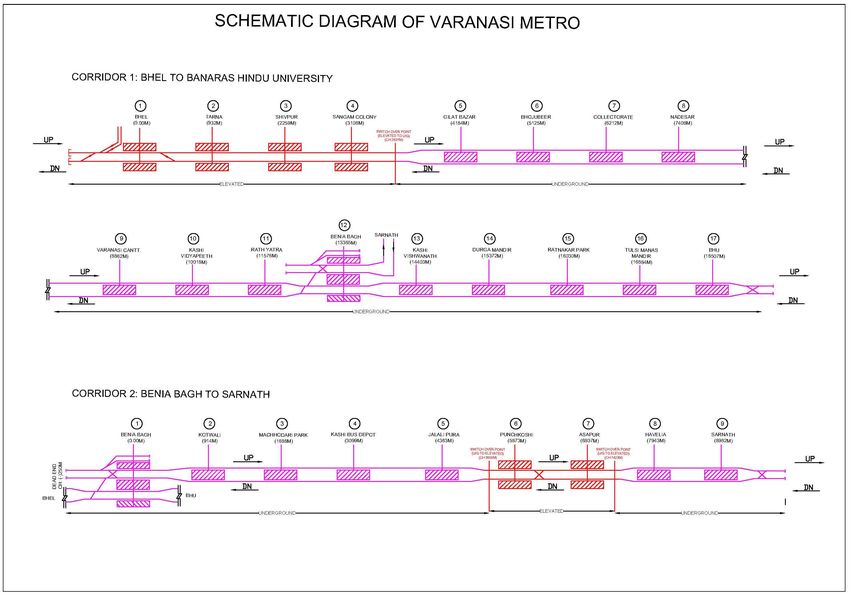

                              FIGURE 0.2: PROPOSED METRO CORRIDOR‐1

                                                       February, 2016              Page 0‐17
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                       EXECUTIVE SUMMARY

                                                                  FIGURE 0.3: PROPOSED METRO CORRIDOR‐2

                                                       February, 2016                       Page 0‐18
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                           EXECUTIVE SUMMARY

 0.4.5    ASI Monuments along Metro Corridors
                  TABLE 0.20: LIST OF ANCIENT MONUMENTS ALONG METRO CORRIDORS

                                                                       Distance
                                                     Prohibited
                                                                         from          Within        Within
    S.        Name of                Nearest         Distance as
                                                                      Monument's     Prohibited    Regulated
   No.       Monuments               Station           per ASI
                                                                       boundary      Area (Y/N)    Area (Y/N)
                                                         (m)
                                                                        wall (m)
  Corridor‐1: BHEL to BHU
          Victoria
    1                             BeniaBagh              100              10              Y              Y
          Memorial
                                  Kashi
          Man Mandir              Vishwanath
    2                                                    100              64              Y              Y
          Observatory             (Chitranjan
                                  park)
          Grave of
                                  Ratnakar
    3     European                                       100              100             N              Y
                                  Park
          Officers
  Corridor‐2: BeniaBagh to Sarnath
          Chaukhandi
    1                             Havelia                215              220             N              Y
          Stupa
    2     Sarnath                 Sarnath                172              218             N              Y

 0.4.6    Utility Diversion
          For identification of likely utilities in the proposed metro corridor ‐1 and Corridor ‐2, liaison
          was made with Organizations/Departments as mentioned in Table 0.21.

                             TABLE 0.21: UTILITY RESPONSIBILITY DEPARTMENTS

         S. No.        ORGANIZATION/ DEPARTMENT                                UTILITY SERVICES
                                                                  Road Construction and maintenance of
            1        MORT&H
                                                                  State highways, Municipal Roads etc.
            2        PWD                                          City Roads
                     Indian Railways                              Railway crossings, subways, signals, railway
            3
                                                                  bridges etc.
            4        VMC‐Jal Nigam                                Water pipe lines.
            5        Jal KalVibhag                                Sewer lines and Water lines
            6        Torrent Power                                HT/other overhead Power lines.
            7        VMC‐Sewerage                                 Sewerage pipe lines.
            8        VMC‐Storm Water Drains                       Storm water drainage.
            9        Irrigation Department                        Canal
           10        Gas Authority of India (GAIL)                Gas Pipelines
           11        Green Gas Limited                            Gas Pipelines
                                                                  Telecommunications      cables,    junction
           12        BSNL (OFC)
                                                                  boxes, telephone posts, O.H lines.

                                                       February, 2016                             Page 0‐19
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                         EXECUTIVE SUMMARY

         S. No.        ORGANIZATION/ DEPARTMENT                             UTILITY SERVICES
                                                               Telecommunications      cables,     junction
           13        BSNL (Cables)
                                                               boxes, telephone posts, O.H. Lines.
                                                               Telecommunications      cables,     junction
           14        Airtel (Cables)
                                                               boxes, telephone posts, O.H. Lines.
                                                               Telecommunications      cables,     junction
           15        Idea (Cables)
                                                               boxes, telephone posts, O.H. Lines.
                                                               Telecommunications      cables,     junction
           16        Tata Tele Services (Cables)
                                                               boxes, telephone posts, O.H. Lines.
                                                               Telecommunications      cables,     junction
           17        Vodafone (Cables)
                                                               boxes, telephone posts, O.H. Lines.
                     North Telecom           Region      (Long Telecommunications      cables,     junction
           18
                     Distance Cables)                          boxes, telephone posts, O.H. Lines.

 0.4.7    Stations
         List of stations along with their chainage and interstation distances (ISD) for Corridor‐1 and
          Corridor‐2 are given in Table 0.22 and 0.23 respectively. Wherever space and site condition
          permits, portal type arrangement is proposed for elevated stations. However, due to limited
          ROW and narrow roads, most of the elevated stations are proposed with Cantilever type
          arrangement, which is also used extensively in Jaipur Metro and for specific stations in LMRC
          as well as DMRC.
         Schematic diagram for Varanasi Metro corridors is shown in Figure 0.4.

                                                       February, 2016                          Page 0‐20
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                         EXECUTIVE SUMMARY

                                                                TABLE 0.22: LIST OF STATIONS FOR CORRIDOR‐1

    S.                                    Tentative            Inter Station   Station Height/      Underground/   Construction   Proposed   Proposed
               Station Name
   No.                                   Chainage (m)            Distance           Depth             Elevated     Methodology     Length     Width
    1      BHEL                               0.00                   ‐‐              13                 Elevated    Cantilever      85         19.2
    2      Tarna                              932                   932              13                 Elevated    Cantilever      75         19.2
    3      Shivpur                            2259                 1327              13                 Elevated    Cantilever      85         19.2
    4      Sangam Colony                      3106                  847              13                 Elevated    Cantilever      75         19.2
    5      Gilat Bazar                        4184                 1078             ‐15              Underground   Cut & Cover      160       26.55
    6      Bhojubeer                          5125                  941             ‐20              Underground   Cut & Cover      160       22.45
    7      Collectorate                       6212                 1087             ‐20              Underground   Cut & Cover      140       26.55
    8      Nadesar                            7408                 1196             ‐20              Underground   Cut & Cover      130       26.55
    9      Varanasi Cantt.                    8862                 1454             ‐20              Underground   Cut & Cover      140       26.55
   10      Kashi Vidyapeeth                  10018                 1156             ‐20              Underground   Cut & Cover      130       26.55
   11      RathYatra                         11576                 1558             ‐20              Underground   Cut & Cover      140       26.55
   12      BeniaBagh                         13365                 1789             ‐20              Underground   Cut & Cover      140        47
   13      Kashi Vishwanath                  14403                 1038             ‐20              Underground   Cut & Cover      130       26.55
   14      DurgaMandir                       15372                  969             ‐20              Underground   Cut & Cover      97        26.55
   15      Ratnakar Park                     16030                  658             ‐20              Underground   Cut & Cover      97        26.55
   16      TulsiManasMandir                  16884                  854             ‐20              Underground   Cut & Cover      160       22.45
   17      BHU                               18507                 1623             ‐20              Underground   Cut & Cover      160       22.45

                                                       February, 2016                            Page 0‐21
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                        EXECUTIVE SUMMARY

                                                                TABLE 0.23: LIST OF STATIONS FOR CORRIDOR‐2

                                                                                  Station                                      Proposed   Proposed
                                          Tentative            Inter Station                     Underground/   Construction
S. No.          Station Name                                                   Height/ Depth                                    Length     Width
                                        Chainage (Km)          Distance (Km)                       Elevated     Methodology
                                                                                    (m)                                           (m)        (m)
  1         BeniaBagh                         0.00                                  ‐20           Underground   Cut & Cover       140         47
  2         Kotwali                            914                   914            ‐20           Underground   Cut & Cover      130       26.55
  3         Machhodari Park                   1688                   774            ‐20           Underground   Cut & Cover      140       26.55
  4         Kashi Bus Depot                   3099                   1411           ‐20           Underground   Cut & Cover      97        26.55
  5         Jalalipura                        4363                   1264           ‐15           Underground   Cut & Cover      140       26.55
  6         PunchkoshiChauraha                5873                   1510           13               Elevated    Cantilever      75         19.2
  7         AsapurChauraha                    6807                   934            18               Elevated    Cantilever      85         19.2
  8         Havelia                           7943                   1136           ‐15           Underground   Cut & Cover      160       26.55
  9         Sarnath                           8982                   1039           ‐20           Underground   Cut & Cover      140       26.55

                                                       February, 2016                          Page 0‐22
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                              EXECUTIVE SUMMARY

                                                                                    FIGURE 0.4: SCHEMATIC DIAGRAM OF VARANASI METRO

                                                       February, 2016              Page 0‐23
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                       EXECUTIVE SUMMARY

 0.4.8     Land Requirement
           Land will be required for the following main components:
              MRTS Structure (including Route Alignment), StationBuilding, Platforms, Entry/Exit
               Structures, Traffic Integration Facilities, Depots, etc.
              Receiving/Traction Sub‐stations
              RadioTowers
              Temporary Construction Depots and work sites.
           Abstract of land requirements for different components of corridors are given in Tables 0.24
           and 0.25.
                       TABLE 0.24: LAND & STRUCTURES REQUIREMENT: CORRIDOR‐I
                                                                                          (IN SQM)
                                                             Permanent    Temporary       Structures
         Ownership                   Purpose
                                                                Land        Land         (Floor area)

      Central Govt
                             Alignment, Station etc              0.07       0.40             0.05
   (Northern Railway)
         State Govt
                             Alignment, Station etc                1         2.6           0.2633

                             Alignment, Station etc              1.05        2.5             0.52
                                                                 13.2                        0.5
                               Depot (Ganeshpur)                              0

          Private                  Casting Yard                    0          6               0

                                        RSS                       0.3         0               0

                                       Total                     14.55       8.5             1.02

                       TABLE 0.25: LAND & STRUCTURES REQUIREMENT: CORRIDOR‐II
                                                                                          (IN SQM)
                                                             Permanent    Temporary        Structures
         Ownership                   Purpose
                                                                Land        Land          (Floor area)
       Central Govt          Alignment, Station etc               0.14        0             0.0242

                             Alignment, Station etc               0.8        2.1             0.105

         State Govt                     RSS                       0.3         0                0

                                       Total                      1.1        2.1             0.105

                             Alignment, Station etc               0.13        0              0.18

          Private                  Casting yard                    0          4                0

                                       Total                      0.13        4              0.18

                                                       February, 2016                       Page 0‐24
Detailed Project Report for Rail Based Mass Transit System in Varanasi
      Final Report                                                                                EXECUTIVE SUMMARY

       0.5     STATION PLANNING AND INTERMODAL INTEGRATION
       0.5.1    Station planning

               The stations have been planned based on the basis of following parameters:

                     a. Station planning is dependent on the peak hour traffic load for each station.
                          In the design year, maximum PHPDT of 24000 passengers for ‘BHU to BHEL
                          and 18000 passengers for ‘Benia Bagh to Sarnath’ is expected.

                     b. The platform length is planned for 3 cars train.

                     c. The total evacuation time for the movement of all passengers in an
                          emergency from platform level to the landing at the next level does not
                          exceed 4.0 minutes (as per “NFPA 130 Guidelines”) in underground stations.
                          However this is 5.5 minutes in elevated stations considering that the stations
                          are open and the risk is much less.

                     d. The station planning is in compliance to the “Guidelines and space Standards
                          for Barrier Free Built Environment for Disabled and Elderly persons”
                          published by the Ministry of Urban Affairs and Employment India in 1998.

                     e. Seven typical designs have been suggested for various station types and
                          these will form basis for planning of all the stations (Table 0.26).

                  Type         Station Type              Size (sq m)            Levels        Construction Type
                   A           Underground               160 X 22.45              3             Cut and Cover
                   B           Underground               160 X 26.55              2             Cut and Cover
                    C          Underground               130 X 26.55              3             Cut and Cover
                   D           Underground               97 X 26.55               4             Cut and Cover
                    E          Interchange                140 X 47                3             Cut and Cover
                    F            Elevated                75 X 19.20               2               Cantilever
                   G             Elevated                75 X 21.70               2               Cantilever

                                               TABLE 0.26: STATION TYPOLOGY

 S.                                                   Station
No.       Name of Station           Description        Type        Size (sq m)       Levels     TSS             Entry/Exits
Corridor 1 BHU to BHEL
                                                                                                Yes     2 exits of 3.2 m wide stairs
1     BHU                          Underground           A         160 X 22.45           3
                                                                                                (S)          with 4 escalators
                                                                                                        2 exits of 2.4 m wide stairs
2     TulsiManasMandir             Underground           A         160 X 22.45           3      No
                                                                                                              with 1 escalator
                                                                                                 Yes    2 exits of 2.4 m wide stairs
3     Ratnakar Park                Underground           D          97 X 26.55           4
                                                                                                 (S)         with 4 escalators

                                                             February, 2016                                 Page 0‐25
Detailed Project Report for Rail Based Mass Transit System in Varanasi
      Final Report                                                                         EXECUTIVE SUMMARY

 S.                                                   Station
No.       Name of Station           Description        Type        Size (sq m)   Levels   TSS            Entry/Exits
                                                                                                 2 exits of 2.4 m wide stairs
 4     DurgaMandir                 Underground           D          97 X 26.55     4      No
                                                                                                       with 1 escalator
                                                                                          Yes    2 exits of 2.4 m wide stairs
 5     KashiVishwanath             Underground           C         130 X 26.55     3
                                                                                          (S)         with 4 escalators
                                                                                                 2 exits of 4.2 m wide stairs
 6     BeniaBagh                    Interchange          E           140 X 47      2      No    with 6 escalators (4 nos. up +
                                                                                                           2 down)
                                                                                          Yes    2 exits of 2.4 m wide stairs
 7     RathYatra                   Underground           C         140 X 26.55     3
                                                                                          (L)    with 2 escalators (both up)
                                                                                                  3 exits of 3 m wide stairs
 8     Kashi Vidyapeeth            Underground           C         130 X 26.55     3      No
                                                                                                      with 3 escalators
                                                                                          Yes     3 exits of 3 m wide stairs
 9     Varanasi Cantt.             Underground           C         140 X 26.55     2
                                                                                          (L)         with 3 escalators
                                                                                                 2 exits of 2.4 m wide stairs
 10    Nadesar                     Underground           C         130 X 26.55     3      No
                                                                                                       with 1 escalator
                                                                                          Yes    2 exits of 2.4 m wide stairs
 11    Collectorate                Underground           C         140 X 26.55     3
                                                                                          (L)          with 1 escalator
                                                                                                 2 exits of 2.4 m wide stairs
 12    Bhojubeer                   Underground           A         160 X 22.45     3      No
                                                                                                 with 2 escalators (both up)
                                                                                          Yes    2 exits of 2.4 m wide stairs
 13    Gilat Bazar                 Underground           B         160 X 26.55     2
                                                                                          (S)          with 1 escalator
                                                                                                 2 exits of 2.4 m wide stairs
 14    Sangam Colony                  Elevated           F          75 X 19.2      2      No
                                                                                                       with 2 escalator
                                                                                          Yes    2 exits of 2.4 m wide stairs
 15    Shivpur                        Elevated           F          85 X 19.2      2
                                                                                          (L)          with 2 escalator
                                                                                                 2 exits of 2.4 m wide stairs
 16    Tarna                          Elevated           F          75 X 19.2      2      No
                                                                                                       with 2 escalator
                                                                                          Yes    2 exits of 2.4 m wide stairs
 17    BHEL                           Elevated           F          85 X 19.2      2
                                                                                          (L)          with 2 escalator
Corridor 2 BeniaBagh to Sarnath
                                                                                                 2 exits of 4.7 m wide stairs
                                                                                          Yes
 1     BeniaBagh                    Interchange          E           140 X 47      2            with 6 escalators (4 nos. up +
                                                                                          (L)
                                                                                                           2 down)
                                                                                                 2 exits of 2.4 m wide stairs
 2     Kotwali                     Underground           C         130 X 26.55     3      No
                                                                                                 with 2 escalators (both up)
                                                                                          Yes    2 exits of 2.4 m wide stairs
 3     Machodari Park              Underground           C         140 X 26.55     3
                                                                                          (L)    with 2 escalators (both up)
                                                                                                  2 exits of 3 m wide stairs
 4     Kashi Bus Depot             Underground           D          97 X 26.55     4      No
                                                                                                 with 2 escalators (both up)
                                                                                          Yes    2 exits of 2.4 m wide stairs
 5     Jalalipura                  Underground           C         140 X 26.55     3
                                                                                          (L)          with 1 escalator
                                                                                                 2 exits of 2.4 m wide stairs
 6     PanchKoshiChouraha             Elevated           F          75 X 19.2      2      No
                                                                                                       with 2 escalator
                                                                                          Yes    2 exits of 2.4 m wide stairs
 7     AsapurChouraha                 Elevated           G          85 X 21.7      2
                                                                                          (L)         with 2 escalators

                                                             February, 2016                          Page 0‐26
Detailed Project Report for Rail Based Mass Transit System in Varanasi
       Final Report                                                                                 EXECUTIVE SUMMARY

 S.                                                    Station
No.        Name of Station           Description        Type         Size (sq m)        Levels     TSS            Entry/Exits
                                                                                                          2 exits of 2.4 m wide stairs
8      Havelia                      Underground           B          160 X 26.55          2        No
                                                                                                          with 2 escalators (both up)
                                                                                                    Yes   2 exits of 2.4 m wide stairs
9      Sarnath                      Underground           C          140 X 26.55          3
                                                                                                   (L)    with 2 escalators (both up)

        0.5.2     Parking at stations

                 Parking provision for commuters is one of the key factors determining success of the
                 metro system. Parking provisions along with priority to pedestrians through Foot Over
                 Bridges and Bus feeder services will encourage more commuters to use the metro
                 system who could safely park their vehicles at the nearest station, walk to the station
                 or rely on feeder connectivity. A total of 1,73,355 Sqm area of land has been
                 considered for parking and property development. A total of 19,202 Sqm of area with
                 14,162 Sqm along Corridor‐1 and 5,040 Sqm along Corridor‐2 is proposed exclusively
                 for parking near metro stations.

        0.5.3     Transit oriented / property development

                 Some land parcels along both the metro corridors have been identified after joint site
                 visits with VDA for parking and property development. Property development shall be
                 taken up on the upper floors, depending upon the FAR (upto 4) and permitted ground
                 coverage of 50%. A total of 4.97 lakh Sqm of property development having Residential,
                 Institutional and Commercial facilities for metro commuters has been proposed to
                 make the project financially viable. The summary of property development is
                 presented in Table 0.27.

                              TABLE 0.27: PROPOSED PARKING &PROPERTY DEVELOPMENT

                                                                                 Area in Sqm.
                                                                        Property      Total Property
      SN                 Metro Station                    Parking
                                                                        Development    Plot   Development Floor
                                                          Area
                                                                        Area           Area   Space (with FAR of 4)
      Corridor‐1:
       1 TulsiManasMandir                                      800               3400            4200           13600
       2 Ratnakar Park                                         900                               900
       3 BeniaBagh                                            1221                               1221
       4 Kashi Vidyapeeth                                     1200                               1200
       5 Varanasi Cantt                                       7241                               7241
       6 Bhojubeer                                             800                               800
       7 BHEL                                                 2000                             2000
       8 Depot at Ganeshpur*                                                120000            120000            360000
      Corridor‐2:
       8 Kotwali                                              1500               5700            7200           22800

                                                               February, 2016                                 Page 0‐27
Detailed Project Report for Rail Based Mass Transit System in Varanasi
 Final Report                                                                         EXECUTIVE SUMMARY

                                                                            Area in Sqm.
                                                                  Property       Total Property
SN                 Metro Station                    Parking
                                                                  Development     Plot   Development Floor
                                                    Area
                                                                  Area            Area   Space (with FAR of 4)
9    Machodari Park                                    1100           7900       9000            31600
10   Kashi Bus Depot                                   1240           4353       5593            17412
11   Jalalipura                                                      12800      12800            51200
12   Sarnath                                          1200                       1200
                    Total                             19202          154153     173355          496612

  0.5.4    Feeder services

          The planning of seamless transport integration facilities at the influence zones of
          various metro stations is of utmost importance. As all commuters will not be living
          within walking distance of the proposed network, proper planning for feeder services
          has been proposed along the metro system.

          The feeder buses shall be of high quality, ultra‐modern and customer oriented that
          can deliver fast, comfortable and cost‐effective urban mobility. Easy‐to‐board (low
          floor), attractive and environmentally friendly buses with air conditioning having
          capacity of 35 (Mini‐buses) are proposed for feeder system.

          The total number of buses required in the year 2021 is 74 buses, 47 for Corridor‐1 and
          27 for Corridor‐2 respectively.

          Public bicycle sharing will be provided for the passengers within 1 km to 2 km from the
          metro stations influence area. A bicycle sharing system is the service in
          which bicycles are made available for free and shared use to metro passengers on a
          short term basis.

  0.5.5    Intermodal integration and dispersal facilities

          The proposals have been formulated for facilitating traffic dispersal and circulation
          facilities based on the following considerations:

               Minimizing pedestrian/vehicle conflicts and effective passenger interchange with
                feeder modes. Proper design of circulation area adjoining the station building to
                ensure rapid/ efficient dispersal of the passengers and avoiding conflicts
                between pedestrian and vehicular traffic.
               Pedestrians require a convenient and safe access to the proposed metro station.
                For smooth movement of pedestrians, all the footpaths in the metro station
                influence zone will be considered to be upgraded to desired level of comfort and
                also proposed new within the stations vicinity areas.

                                                        February, 2016                         Page 0‐28
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                  EXECUTIVE SUMMARY

              High quality pedestrian access will be accomplished through design factors such
               as directness and connectivity, ease of movement, safety and security. The
               vendors if any on the footpaths shall be removed and desired accessibility to
               metro stations will be provided. The facilities (footpaths/ walkways) will be
               directly integrated with the system.
              Facilitating passenger interchange with other transit systems: Dedicated linkages
               will be proposed like subways, skywalks, covered walkways etc. which will reduce
               the passenger travel time and pedestrian load on the roads.
              Circulation area with adequate parking space, designated space for embarking
               and disembarking for vehicular traffic (pick‐drop zones) and feeder modes like
               Buses, IPTs and NMT.
              Availability of total carriageway and footpath widths required to cater to the
               proposed traffic volumes              to be augmented through strengthening of road
               shoulder areas and relocation of vendors/hawkers, on‐street parking and all
               encroachments from the service/ access roads.

 0.5.6    Traffic management plan

         The existing traffic loads on roads are projected along the proposed metro corridors
         and it is seen that the existing ROW along the corridors itself would take the load of
         traffic provided that the ROW is judiciously used. Only limited traffic diversions may be
         required.

 0.6     DISASTER MANAGEMENT MEASURES
         An effective system needs to be in placeunder the provision of ‘Disaster Management
         Act, 2005’. Provisions at metro stations include Fire Detection and Suppression
         System, Environmental Control System (ECS), Tunnel Ventilation System, Track‐way
         Exhaust System (TES), Power Supply System, DG Sets & UPS, Water Supply and
         Drainage System, Lights and other facilities which may be deemed necessary. In order
         to be prepared for any disaster, it is essential to train the concerned staff in situations
         such as fire, rescue of disabled trains, evacuation, etc. and mock drills need to be
         conducted.

                                                       February, 2016                  Page 0‐29
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                     EXECUTIVE SUMMARY

 0.7    DISABLED FRIENDLY FEATURES
        The metro system should be user‐friendly ensuring accessibility to persons with
        disabilities, people travelling with small children or are carrying luggage, as well as
        people with temporary mobility problems and the elderly persons.The standards are
        extracted from ‘Indian Roads Congress Code, 103:2012’, ‘Guidelines for Pedestrian
        Facilities, Model Building Bye Laws‐2011’ and ‘National Building Code‐2005’, ‘Space
        Standards for Barrier Free Built Environment for Disabled and Elderly Persons‐1998
        and 2013’and other international best practices / standards. Standarddisabled friendly
        facilities within station areas will be providedfor seamless movement around metro
        stations.

 0.8    SECURITY MEASURES
        Security system for metro system plays an important role in helping the system to
        become the preferred mode choice for commuters. The three phases of security
        system followed include Prevention, Preparedness and Recovery. Various provisions
        like CCTV cameras, baggage scanners, metal detectors, bomb detection equipment,
        wireless sets, snuffer dogs and related facilities will be part of station security system.

 0.9    TRAIN OPERATION PLAN
        The train operation plan for the proposed corridors will be based on the following
        salient features:

              Running of services for 16 hours of a day (6:00 hrs to 22:00 hrs) with a
                station dwell time of 20 – 30 seconds.
              Scheduled speed for corridor 1 and corridor 2 shall be 35 kmph and 34 kmph.
              Make up time of 5‐10% with 10‐15% coasting.
              Adequate services to ensure comfortable journey for commuters even during
                peak periods.

        Based on the Traffic demand, train operation plan and requirement of coaches for
        BHU to BHEL corridor and Beniabagh to Sarnath corridor for different horizon years is
        given in Table 0.28 and Table 0.29.

                       TABLE 0.28: TRAIN OPERATION PLAN: BHU – BHEL CORRIDOR

               Year                         2023           2031           2041      2051
               Trains Per Hour                13             16            21         25
               Cars per train                 3              3             3          3
               Avg. Head way (in             276            228           174        144

                                                       February, 2016                      Page 0‐30
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                      EXECUTIVE SUMMARY

               Year                         2023           2031           2041       2051
               Seconds)
               PHPDT Demand                 13000         15500           20000      24000
               Capacity       6p/m2         9958          12256           16086      19150
               Available      8p/m2         12675         15600           20475      24375

               Rake Requirement               21             24            32          38
               Total Coach
                                              63             72            96         114
               Requirement

                TABLE 0.29: TRAIN OPERATION PLAN: BENIABAGH – SARNATH CORRIDOR

               Year                         2023           2031           2041       2051
               Trains Per Hour                10             14            16          19
               Cars per train                 3              3              3          3
               Avg. Head way (in
                                             360            258           228         192
               Seconds)
               PHPDT Demand                10000          13500           15500      18000
               Capacity       6p/m2         7660          10724           12256      14554
               Available      8p/m2         9750          13650           15600      18525

               Rake Requirement               10             13            15          18
               Total Coach
                                              30             39            45          54
               Requirement

 0.10 MAINTENANCE DEPOT

        The Metro corridors will require depot cum maintenance facilities for the
        maintenance of 56 rakes of 3 car (38 rakes for corridor 1 and 18 rakes for corridor 2).
        Since, track connectivity between the two corridors is proposed at Beniabagh, one
        depot near BHEL / Ganeshpur is planned to cater to the maintenance requirements.

        The depots will have infrastructure with necessary facilities viz stabling lines,
        scheduled inspection lines, workshop for overhaul, unscheduled maintenance
        including major repairs, wheel profiling, heavy interior/under frame/roof cleaning etc.
        for the rolling stock operational on the corridors as well as maintenance facilities for
        Civil – track, buildings, water supply; Electrical – traction, E&M; Signalling &
        Telecomm. Automatic Fare Collection etc.

                                                       February, 2016                        Page 0‐31
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                          EXECUTIVE SUMMARY

 0.11 POWER SUPPLY SYSTEM

        Electricity is required for operation of Metro system for running of trains, station
        services (e.g. lighting, lifts, escalators, signaling& telecom, fire fightingetc) and
        workshops, depots & other maintenance infrastructure within premises of metro
        system.The power requirements of a metro system are determined by peak‐hour
        power demand for traction and auxiliary applications. Broad estimation of auxiliary
        and traction power demand is made based on the following assumptions:‐

                    Train operation with 3 car rakes with carrying capacity of 766 passengers
                     (standing @ 6 passengers/ m²).

                    Peak period headway of 144 seconds for BHU to BHEL corridor and 192
                     seconds headway for Beniabagh to Sarnath corridor.
                    Specific energy consumption of rolling stock – 75 KWh / 1000 GTKM
                    At grade/ Elev. station load – initially 200kW, ultimate design 300 kW
                    Underground station load – initially 1500kW, ultimate design 1800 kW
                    Depot auxiliary load – initially 1500kW, ultimate design 2000 KW
                    Regeneration @20%
                    Power factor of load – 0.9
                    Transmission losses @ 5%

        Keeping in view the above norms, the projected power requirement for the different
        horizon years is summarized in Table 0.30.

                               TABLE 0.30: POWER DEMAND ESTIMATION (MVA)

          Corridor                 BHU to BHEL                              Benaibagh to Sarnath

           Year        2021      2031       2041       2051         2021       2031     2041        2051
        Traction       7.45      9.25      11.90       14.42         2.47      3.45     3.95        4.69
        Auxiliary      25.43     27.31     29.19       31.03        12.72     13.62     14.51       15.40
        Total          32.88     36.56     41.09       45.45        15.18     17.07     18.46       20.09

 0.11.1         Sources of Power Supply

        Varanasi City has 220kV, 132kV, 33kV power transmission and distribution network to
        cater to various types of demand in the vicinity of the proposed corridor. Keeping in
        view of the reliability requirements and considering the complete length of corridors,
        it is proposed to avail power supply at 132 kV from M/s UPPTCL Grid sub‐stations to

                                                       February, 2016                              Page 0‐32
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                                     EXECUTIVE SUMMARY

        Receiving sub stations of the corridor at three locations. Sources of power supply as
        confirmed during discussions by M/s UPPTCL are given at Table 0.31.

                                      TABLE 0.31: POWER SUPPLY SOURCES

                 Grid sub‐station              Location of RSS of Metro   Approx. distance from
               (with Input voltage)                   Authority                    GSS

           Harahua GSS                        BHEL RSS (132/33 kV)                5 km

           BHU GSS                            BHU RSS (132/33 kV)                 6 km

           Sarnath GSS                        Sarnath RSS (132/33 kV)              5     km

 0.11.2       Auxiliary supply arrangements AND STANDBY POWER SUPPLY

        Auxiliary sub‐stations (ASS) are envisaged to be provided at each station for stepping
        down 33kV supply to 415V for auxiliary applications. The ASS will be located at
        mezzanine or platform level inside a room. The demand of power at each elevated
        station is expected to be about 200 kW in the initial years and is likely to reach 300 kW
        in the horizon year. Similarly, for the underground stations, the auxiliary load
        requirements have been assessed at 1500 kW for underground station which is likely
        to increase to 1800 kW in the horizon year.

        Each elevated station shall be provided with an Auxiliary Substation with two
        33kV/415V, 3‐phase, 500 kVA dry type cast resin transformers and the associated HT
        & LT switchgear. Two transformers (33kV/415V, 3‐phase) of 2000 kVA at each
        underground ASS for the underground stations are proposed to be installed (one
        transformer as standby).

        Apart from stations, separate ASS is required at each depot with 2x2000 kVA auxiliary
        transformers to cater to depot cum workshop load.

        In addition, it is proposed to provide standby DG set of 180 kVA at all elevated stations
        and 2 x 1000 kVA capacity at underground stations to cater to all emergency loads.

 0.12 ENVIRONMENTAL AND SOCIAL IMPACT ASSESSMENT

 0.12.1       Environmental impact assessment (EIA)

        The EIA provides a description of the direct and indirect environmental effects
        associated with the proposed metro corridors during various phases of project cycle.

                                                       February, 2016                         Page 0‐33
Detailed Project Report for Rail Based Mass Transit System in Varanasi
Final Report                                                              EXECUTIVE SUMMARY

        Baseline data has been collected from primary and secondary sources. Both negative
        and positive impacts have been identified and appraised.

        The negative impacts due to location of the proposed metro corridors include: Project
        Affected People (PAPs), Change of Land use, Loss of trees/forest and Utility/Drainage
        Problems. The impacts due to construction include: Soil erosion, pollution (water, air
        & noise) and health risk at construction site, Traffic diversion and risk to existing
        buildings, excavated soil disposal problems, dust generation, impact due to labour
        camp, increased water demand, impact due to supply of construction material.
        Anticipated Impacts due to operation are: noise pollution, water supply and sanitation
        at stations, traffic congestion issues and impact due to depots.

        A lot of positive impacts are anticipated which include employment opportunities,
        benefits to economy; quick service and safety; reduced fuel consumption and
        reduction in air Pollution.

        Mitigation measures and management plan for Compensatory Afforestation,
        Construction Material, Labour Camp, Energy Management, Hazardous Waste,
        Housekeeping, Air Pollution Control, Noise and vibration Control, Traffic
        Diversion/Management, Soil Erosion Control, Muck Disposal, Draining of Water from
        Tunnel, Water Supply, Sanitation and Solid Waste, Rain water harvesting, Construction
        Waste, Depot are suggested and cost of various environmental management plans,
        and environmental monitoring (both during construction and operation) have been
        worked out.

 0.12.2       Social impact assessment (SIA)

        The objective of Social Impact Assessment is to identify social impacts on the basis of
        sample socio‐economic survey and to prepare a preliminary Resettlement Action Plan
        (RAP). The SIA which includes RAP has been prepared in Right to Fair Compensation
        and Transparency in land acquisition, Rehabilitation and Resettlement Act, 2013 and
        Resettlement Policy Framework of Lucknow Metro Rail Corporation. The base line
        data have been collected from secondary sources such as the Census and the
        Statistical Hand Book and primary data have been collected through household survey
        conducted by RITES Social team during October‐November 2015.

        The project will require acquisition of 36.69 ha of land for construction of different
        components. Out of the total land, 7.41 ha is government land and 29.28 ha is private
        land. Out of the total government land, 2.31 ha is for permanent use and 16.78 ha is
        identified for temporary use.

        Total 102 structures will be affected out of which 18 are residential, 51 commercial 24
        are common properties like public toilets, gardens, educational institutions, water

                                                       February, 2016              Page 0‐34
You can also read
