Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff

Page created by Keith Cross

CONTINUE READING
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
Capital Project Update – Q4 2018
BUILDINGS

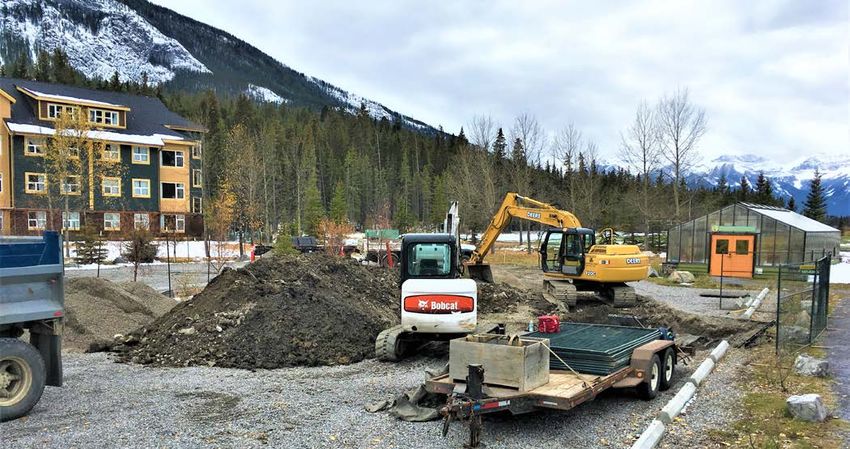

Air Exchange Unit - Grounds Shop
    Project description & goals: Installation of an air-exchange unit in the grounds shop to improve air quality and
    worker safety
    Current Status: Complete

Banff Elementary School Partnership
   Project description & goals: Partnership with Canadian Rockies Public Schools to incorporate space in phase 2 of
   the Banff Elementary school redevelopment for Out–of–School Club and an expanded gymnasium to better suit the
   needs of the community.
   Current Status: Partnership with CRPS has been collaborative and productive. Construction is ongoing with
   completion scheduled for the Spring of 2019. The Town has commenced design work for provide complimentary
   upgrades – sidewalks and formalized curb and gutter/parking to Bighorn and Moose Sts. Construction of these
   public realm upgrades are planned for next summer to be complete ready for the start of the 2019/2020 school
   year.

Buildings Lifecycle Maintenance
    Project description & goals: Scheduled maintenance and capital replacements for facilities
    Current Status:

        Library interior paint. Completed
        101 Bear Street, replace main doors upper storey. Completed
        Day Care –
                 Shingle replacement- Complete
                 Interior paint- Completed
                 Exterior paint- moved to 2019
                 Upgrade HVAC system. Engineering phase in process
        449 Cougar St., exterior paint- Completed
        Fire Hall-
                 Replace cedar shingles-Completed
                 Exterior renovation & paint- Completed
        552 Banff Ave., exterior paint-Completed

                                                           1
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
Projects for 2019:
        Town Hall Shingles, Attic Ventilation/ Insulation
        Town Hall Kitchen renovations
        Fire Hall Recycle Fence replacement
        Parkade Plumbing
        Operations Office Structural Assessment
        Library Ext. Paint
        Fleet Services Access Door Control Hardware
        Compound Main. Bldg.
                 -Replace Overhead unit, exhaust chimneys & stacks
                 -Roof inspection
        Wolf St Washroom Roof Drain Repair/ South Side Fascia
        Norquay Shelter Sheeting and Shingles replacement
        Gazebo Shingles replacement, Electrical & lighting upgrades
        221 Beaver Back Fence
        Staff Residence
                 552 Banff Ave Replace all railings and deck coverings
                 552 Banff Ave Replace hall carpet
                 449 Cougar St. replace small decks, landings

Council Chambers Redesign and Audio Sound System
   Project description & goals: to enhance audio and visual capabilities in Council Chamber and improve the room
   layout and functionality
   Current Status: Audio components are substantially installed and complete.

Exhaust Extraction System - Fleet Building
   Project description & goals: Installation of direct venting for vehicle exhausts to improve worker safety and air
   quality
   Current Status: TBC November 2018 - Electrical work already completed

The Fenlands Lifecycle Maintenance
   Project description & goals: the inspection, testing, service, repair or replacement of The Fenlands mechanical and
   structural envelope to ensure life expectancy is met.

    Current Status:
        Arena Lobby HVAC: Installation of air exchanger for hockey arena lobby complete
        Painting/Staining Exterior/Interior Walls- In progress
        Show power- Complete
        Arena & Curling entrance overlay complete
        Arena 2 benches refurbish-Completed
        SCBA replacement-Complete
        Bio-swale on going 80% completed

Fleet Transit Building – Fire Alarm
    Project description & goals: Installation of an audible alarm system that can be heard over work noise.
    Current Status: Project Completed

Operations Building Space Analysis & Redesign
   Project description & goals: a needs assessment, in collaboration with a consultant, to redesign and maximize the
   space available in the operations buildings (main building, transit building, fire hall and The Fenlands) and deliver
   comprehensive floor plans with associated renovation costs
                                                            2
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
Current Status:
    RFP accepted & contract expected to be awarded in Q4

Cave Ave Housing (COU17-142)
   Project description & goals: 6 lots on Cave Ave have been earmarked for the development of affordable rental
   accommodation. TOB negotiated the release of lots 145-155 Cave Ave with Parks Canada based on specific criteria
   for release, with the intent the BHC will manage and own the property post construction completion.

    Current Status: Preliminary site analysis and geotechnical work has been completed, resident survey has been
    completed to determine potential interest in types of units and from a neighbourhood perspective. Currently
    preparing a report to council that will summarize activity to date related to rental housing projects that have
    occurred in Banff (and across Bow Valley) and rental housing demand since the community housing strategy was
    implemented. This will provide information that will assist council in making time frame decisions related to this
    project.

Town Hall copy room renovation
   Project description & goals: renovation of copy room into office space to allow for additional staffing needs in
   Corporate Services
   Current Status: Complete

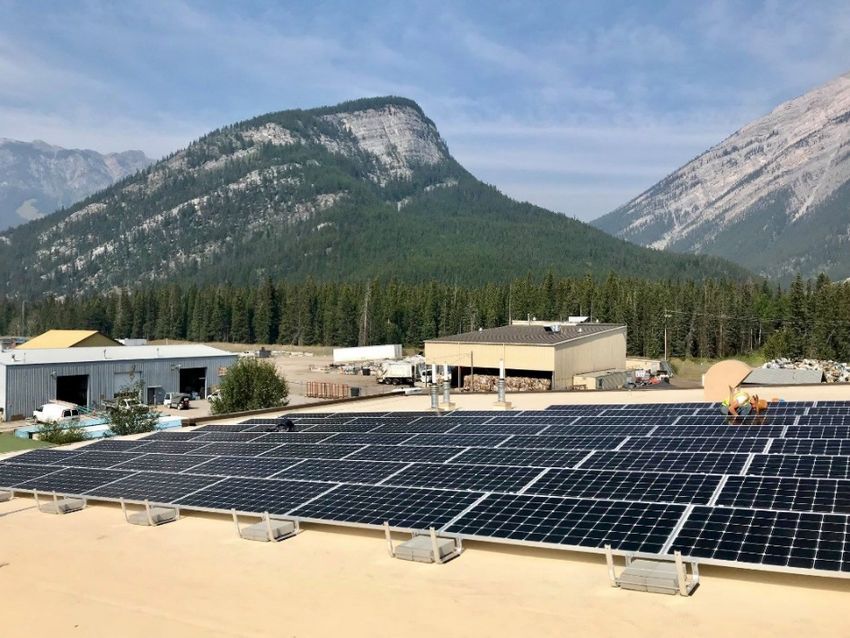

Fleet Building Solar Panels
    Project description & goals: Installation of a 24kw Solar array on the Transit Fleet building
    Current Status: The Banff Transit-Fleet Building in the industrial compound is the newest solar installation in Banff.
    Officially turned on August 24, 2018.

    This is now the municipality’s second largest solar system behind The Fenlands. This project was completed with
    the support of the Alberta Municipal Solar Program, which provided 25% funding for the project.

System power performance is provided live throughout the day in the link below:

Transit-Fleet Building Solar Power Generation

                                                            3
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
Town Hall Modernization
   Project description & goals: Due to changes in the service delivery as well as the demographics of Banff since the
   development of Town Hall, the reception area and how we interact with customers is in need of functional
   changes. This project contemplates:
       •       Increase the efficiency of the available space
       •       Increase the sense of welcoming
       •       Increase visibility of Town services (Community Services)
       •       Additional space for interaction with the public.
   Current Status: Detail design ongoing, construction to start in Q1 2019

                                                           4
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
FIRE

70 Congregate Lodging Cots & Pads
    Project description & goals: to purchase congregate lodging cots and pad for Emergency Social Services.
    Current Status: Project complete

Automated External Defibrillators
   Project description & goals: to purchase automated external defibrillators on a Ten (10) year lifecycle replacement
   schedule.
   Current Status: project complete

Bunker Gear
   Project description & goals: Purchase of 8 sets of bunker gear for 2017 recruit class.
   Current Status: Project complete

Fire Hose Replacement
    Project description & goals: Lifecycle replacement of firefighting hose.
    Current Status: Project complete

Fire vehicle replacement
    Project description & goals: Lifecycle replacement of 25-year-old aerial truck
    Current Status: Truck is in production with an anticipated delivery of November 2018.

Pager Replacement
   Project description & goals: to purchase 34 pagers on a five year lifecycle replacement schedule. The pagers are
   the primary mode of calling out fire department members in an emergency.
   Current Status: project has been pushed to early 2019

Type 5 wildfire pick-up truck kits
   Project description & goals: to purchase six (6) type 5 slip in Wildland Urban Interface pumping units. These units
   consist of 150 gal tank, pump, 200 foot hose reel and associated equipment for pump and run tactics to
   extinguish small fires started by fire embers landing in the community.
   Current Status: project complete

                                                            5
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
FLEET

Facilities - New Vehicle
    Project description & goals: Purchase of Kia Soul electric vehicle for use by facilities. Vehicle replaces GMC 1500 V8
    Current Status: Completed

Fall Arrest System
     Project description & goals: Installation of fall arrest system to protect employees working at height in the fleet
     building
     Current Status: TBC early December 2018

Fleet Management – Vehicle Replacement
    Project description & goals: Fleet Equipment replacement to align with Maximizing Life Cycle effectiveness, Green
    Fleet Policy C6000 & Equipment Task Right Sizing.
    Current Status: 10 Vehicles/equipment replacements were scheduled for 2018 with an additional 2 replacements
    carried over from 2017. Of the 12 total, 3 unit have been replaced with more fuel efficient/scope of work
    maximizing alternatives. 5 Units are in very good shape and can have their useful service life extended (these will
    be adjusted in the forecasted capital replacement budgets). 3 Units will be replaced in the next 6 months with
    Electric or Hybrid alternatives (Ice re-surfacer, parkade sweeper and a sedan/suv) and 1 unit will have a
    replacement with 4 season usefulness (current unit is only used in summer months).

Sidewalk Tractor
    Project description & goals: Increased service level for route 4 and all other pedestrian snow routes necessitated
    new equipment
    Current Status: Currently purchased 2 walk-behind power brooms, snow blower and a drop-down ramp to easily
    move the equipment around in interim. Currently evaluating machinery that best fits the scope of work and narrow
    sidewalks. The balance will be carried into 2019 with a request to blend approved capital and vehicle replacement
    dollars to purchase an appropriate multi-function machine for both summer and winter use.

Small Equipment
   Project description & goals: purchase of miscellaneous small equipment
   Current Status:
        Bobcat Bucket – Complete
        2 x heavy duty jack stands – Complete

Snow Plow Blade
   Project description & goals: Snow plow to enhance functionality of new hook lift truck fleet
   Current Status: Ordered, expecting installation mid October 2018

                                                            6
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
PARKS & RECREATION

Banff Recreation Grounds
   Project description & goals: Design and construction of projects identified in the Recreation Grounds Master Plan.
   Current Status
           • Skateboard Park – complete

           •   Seasonal south parking lot expansion – complete
           •   Multi-purpose building – geotechnical investigation complete, discussions ongoing with Frank Lloyd
               Wright initiative to establish if feasible to combine multi-purpose building with proposed rebuild.
               Further scope definition required in 2019.
           •   Ball diamond irrigation and regrading – to be completed in conjunction with the sports field
               improvements. Update at 2019 service review
           •   Ball diamond fencing improvements – to be completed fall of 2018
           •   Campfire pits maintenance – complete
           •   Removal of mountain biking skills park consisting of various constructed wooden and dirt features –
               complete
           •   Existing picnic tables improvements – complete
           •   Horseback riding trail construction – update at 2019 service review
           •   Topographical site survey – complete
           •   North parking lot repair – complete fall 2018
           •   North playground – complete fall 2018/spring 2019

                                                          7
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
Bike Racks Program
    Project description & goals: This project supports council’s priorities of transportation, trails, recreation and
    environment by creating approximately 180 net new bike parking stalls in key areas, mainly in downtown and at
    major trail connections.
    Current Status: 94 bike parking stalls were added in 2016 and a further 190 stalls were added in 2017. The total
    available stalls is over 800. The original project goal was exceeded by 104 for total added capacity of 284; $29,000
    under budget. Demand for further increases in capacity exists in additional locations and project savings can be
    directed towards additional racks. In summer 2018 bike rack capacity for 8 bicycles was installed at the Rec
    Grounds. In autumn 2018 bike rack capacity for 6 to be installed in Bear Parkade and weather permitting, bike
    parking capacity for 16 will be added in 4 locations along Banff Avenue.

        Usage of new In Ground
        U bike racks at Cascade
        Shops, Sat., August 19,           Demand for greater capacity at Caribou–Bear NE
        2017.                             corner, Saturday, May 27, 2017.

                                                            8
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
Bow Falls Viewpoint – Upgrade & Rehab
   Project description & goals: Improve Bow Falls Viewpoint by formalizing and re-surfacing trails and viewing areas,
   installing fencing to protect existing vegetation, constructing a new viewing platform and installing washrooms.
   Current Status: Preliminary design work is complete and will be presented, along with the results of a visitor
   survey, to council to help inform the scope of the project.

Central Park Washroom Replacement
   Project description & goals: Relocation and reconstruction of central park washroom.
   Current Status: The new washroom facility was opened to the public on July 1 2015. Outstanding deficiencies were
   completed in 2016. Remaining unspent funds to be returned to the reserves.

Columbarium & Memorial Garden
    Project description & goals: The development and installation of a columbaria, scattering garden and memorial
    wall at 606 Buffalo Street on Town-owned lands, outside of the Old Banff Cemetery. Both the adjacent Old Banff
    Cemetery and the Transformer Substation are protected municipal heritage resources and require some special
    considerations.
    Current Status: Structural investigation of the Banff Transformer Substation to determine if the building is suitable
    for the use of an enclosed columbaria has been completed. The results of the engineering report and options for
    landscaping, interior and exterior columbaria structures and scattering garden will be presented to Council and
    along with proposed project timelines and design development scope in Q4 2018.

Commonwealth Walkway
   Project description & goals: The Commonwealth Walkway program
   is designed to encourage active modes and commemorate the
   values of the 71 commonwealth nations and territories. Banff was
   chosen as the location for Canada’s Commonwealth Walkway.
   Installation of bronze markers form trails for self-guided
   interpretive tours around Banff townsite and the national park. This
   project is in partnership with Parks Canada, The Community
   Foundation of Banff and Canmore, Banff & Lake Louise Tourism, The
   Fairmont Banff Springs and Banff Centre.
   Current Status: Project is complete, $24,000 under budget – 38
   markers have been installed to form four trails radiating from a hub
   at the corner of Banff Ave to 1) Vermillion Lakes, 2) Sundance
   Canyon Day use area, 3) the Spray River trailhead via the Banff
   Springs Hotel and Bow Falls and Tunnel Mountain via the Banff
   Centre. Route tour descriptions are online at
   banff.ca/commonwealthwalkway and banffcanmorecf.org. This
   initiative completes the Visitor Loop recommendation in the Trails
   Master Plan. Remaining funds will be returned to the rerserves.

                                                            9
Capital Project Update - Q4 2018 - BUILDINGS Air Exchange Unit - Grounds Shop - Town of Banff
Community Greenhouse #2
   Project description & goals: Design and construction of a deep water line and foundation in 2018 to host a new
   greenhouse structure to be installed in 2019.
   Current Status: Environmental Assessment completed and approved; water line and foundation to be substantially
   complete by the end of 2018.

Cemetery Software
   Project description & goals: Upgrade obsolete operating system which assists with regulatory cemetery records
   and information.
   Current Status: Project delays due to supplier organizational structure changes; expect to be completed by year
   end 2019, awaiting contract finalization and implementation.

Greenhouse Exhaust Fan Update
   Project description & goals: Upgrade existing exhaust fan to assist in larger volume of air movement through the
   greenhouse building.
   Current Status: Complete, surplus funds to be returned to reserves

                                                         10
Legacy Trail – Banff Avenue Connection
   Project description & goals: Provide a safe, protected cycling experience from the west end of the Banff Avenue
   Legacy trail into Banff.
   Current Status: Traffic studies were completed and conceptual design integrating the Legacy Trail, adjacent
   developments (Husky, Voyageur Inn, Inns of Banff) and the Banff sign were completed. The project needs to be
   coordinated with Parks Canada due to proximity to the town boundary. Construction is planned for fall 2019.
   Concept design completed that would integrate a variety of east entrance components, and calm vehicle traffic.
   Proposed alignment is in line with industry best practice to ensure the safety of cyclists, pedestrians, Roam users
   and drivers. Application for project funding support has been made to Trans Canada Trail.

Mountainview Cemetery Roadway Improvement
  Project description & goals: To repair damaged curbs and remove excess vegetation and regrade and level driving
  surfaces.
  Current Status: Oct 2 2018 saw significant snow amounts with the project postponed until Spring 2019.

Norquay Road Trail
   Project description & goals: better provide for pedestrians and cyclist Fenlands users – dedicated trail that can be
   winter maintained
   Current Status: a complete land survey was conducted, concept drawings for full integration with other proposed
   west entrance improvements, and traffic study. Construction of trail and new lighting on track for 2019
   construction.

Neighborhoods Parks – Upgrades
   Project description & goals: Upgrade the Middle Springs Cabin windows in efforts to reduce vandalism. Included
   the install of plexiglass panes over windows to maintain the look and character of the building.
   Current Status: Carried forward to 2019. Will be undertaken in conjunction with other projects scheduled for the
   facility inclusive of floor repair/replacement.

                                                           11
Trails Improvements
    Project description & goals: Implement the recommendations identified in the Trails Master Plan.
    Current Status
         • Key connector from Bow River to Trail to Banff Ave at Legion re-graded to 5% by adding 20m for greater
            accessibility, new border fence, new ramp section sidewalk, and associated landscaping
         • After extensive public consultation, on-road active transportation routes (painted lanes) on Tunnel
            Mountain Road and Buffalo Street were completed in time for summer 2018 usage.
         • Bow Falls Road mixed use trail with horses or expanded road shoulder are currently being designed.
         • Bow River Trail, from the pedestrian bridge around Central Park to Wolf Street: pre-design complete for
            recommended widening to 3m. Administration will be seeking council direction on scope in 2019.
         • Trail signage upgrades: 200 signs were designed and installed, along with 20 net new posts at key locations.
            30 new mini maps were designed and installed for visitor orientation.
         • Whyte Museum trail connector, from Bear Street to Bow Ave: Agreement is being developed. Procurement
            is complete and construction is planned for spring 2019.
         • Twelve bike boxes were painted at downtown Banff Ave intersections for a safer cycling experience.
         • Upgrade all staircases on trails to include a bike ramp or rail. Four feasible staircases were upgraded with a
            bike ramp or rail in 2018. Other staircases were either too narrow or already had a natural gravel ramp.
         • Evaluate existing bike sharrow pavement markings – evaluation completed by consultant Stantec.
         • Complete a design to improve road conditions to the Banff Centre via St. Julien from Moose St. to Banff
            Centre in 2021– consultations with Banff Centre and Parks Canada, design in progress. Crosswalk to Tunnel
            Mountain Trailhead installed in advance
         • Gather shared bike use statistics from hotels – on-going.
         • Update web-based maps as trail improvements occur – in progress.
         • Update print base maps after key phases of trail improvements are completed – in progress.
         • Amend bylaws to limit rickshaw and horse use on trails – Traffic Bylaw changes completed.
         • Improve access to Bow Falls in winter – signs to allow at-risk access are installed

                                                           12
Trail Lighting Projects
    Project description & goals: Replacement of the pedestrian bridge lighting in line with the Trails Lighting Policy.
    Now dimed and more directional toward centre.
    Current Status: Complete. Design of the accesses to the pedestrian bridge from Buffalo Street and Glen Avenue is
    underway for 2019 installation.

                                                           13
Water Bottle Filling Stations
   Project description & goals: Installation of 4 free-standing water bottle fill
   stations in downtown area along Banff Ave.
   Current Status: Three stations have been installed, a fourth station will be
   installed close to Cascade Plaza in 2019

Parking, Traffic and Transit

Comprehensive off–street smart parking system
   Project description & goals: Installation of a smart parking system to help guide drivers to available parking stalls.
   Current Status: Real time parking stall monitoring was installed in nine lots from 2015 to 2017. Local signage is
   provided by the lots and real time data is available on the traffic dashboard.
   Accuracy issues have been identified in small lots with high stall turnover – where a 1% miscount of several
   thousand vehicles per day can compound to lot-count inaccuracies to a scale greater than 10% of the number of
   stalls. Tail-gating and cyclist/motorcycle/trailer-use of the lots also tends to exacerbate inaccuracy issues with the
   gate-counter technology implemented.

    Alternative technology – using overhead cameras with digital counting algorithms to monitor individual stall
    occupancy – will be installed as a trial in the Town hall lot and, if successful, will be installed in other suitable lots
    where accuracy issues continue to be an issue.

                                                               14
Downtown Pedestrian Counter
   Project description & goals: Installation of six pedestrian counter stations on Banff Avenue, Caribou Street, Bear
   Street and Wolf Street.
   Current Status: Five monitoring stations have been installed using stereoscopic video counting technology, which
   can detect pedestrian volumes and heights for traffic occurring beneath it. Accuracy rates are validated in the 90%
   to 100% range, although only traffic passing beneath the unit is measured. Weekly count data is currently being
   distributed to TOB staff, BLLT, and hosting landlords.

Transit Fleet for Increased Frequency on Banff Routes (Phase I)
    Project description & goals: Purchase of 3 new buses to enable peak 20-minute frequency on Routes 1 and 2
    Current Status: Bus purchase complete and fully funded through PTIF and GreenTRIP funding. Unspent funds to be
    returned to reserves.

Local Bus Stop Installation
    Project description & goals: Design and construction of transit shelters or other user improvements at key bus
    stops.
    Current Status: Design is ongoing. Approximately 5 shelters are planned to be built in 2019. Other bus stop
    improvements to improve route connectivity and marketing (signage) are being developed.

On-Street Parking Improvements
   Project description & goals: The original goal of this project was to Increase parking density along streets where
   enough right-of-way is available.
   Current Status: Council directed administration to focus on the streets adjacent to the Banff Elementary School. It
   was then decided to delay the project to complete the work in conjunction with the rebuilt of the school. Design
   consultants have been engaged to develop designs for sidewalk/curb and gutter along Big horn and Moose Streets
   to formalize parking around the Banff Elementary School. It is unlikely that parking capacity will be increased, but
   rather existing parking will be formalized. Construction is planned for Summer 2019
                                                          15
Traffic Monitoring Equipment Purchase
    Project description & goals: Purchase, install and operate 4 additional BluFAX devices for monitoring traffic.
    Expanding the network will grow the sections of roadway being monitoring and increase the accuracy of data.
    Current Status: Complete. New routes have been added to the traffic dashboard website.

Transit Bus Storage
    Project description & goals: Construction of a bus storage facility to prolong the life of the expanded fleet for Roam
    transit
    Current Status: Building size and performance specifications are being developed with the BVRTSC and Fleet. Cost
    sharing of the operating costs of the facility are being discussed with the BVRTSC commission members. RFD to
    confirm project scope and location will be brought to council in Q4 2018.

Transit Hub
    Project description & goals: Development of a transit hub to connect between regional and local routes.
    Current Status: The Dillon Banff Local Transit Service Review has recommendations on the location of a transit hub
    on the 300 block of Banff Avenue. The hub is located on both sides of Banff Ave at Elk Street. The hub will serve the
    users of routes 1, 2, 3, 4, 6, 7, 8 and On-it. Construction is planned to be substantially complete by the end of 2018.

                                                            16
Roads

Bear St Woonerff
   Project description & goals: Re-construction of Bear Street to permanently foster pedestrian priority.
   Current Status: In 2018, council directed administration to replace the deep utility services and to prioritize the
   street design of the pedestrian and cyclists over motorised transportation. Also in 2018, council directed
   administration to eliminate all on-street parking with the exception of two accessible stalls. Following these
   decisions, a consultant was retained through a Request for Proposal process to lead the development of conceptual
   designs. The concepts will include Bear, Wolf & Caribou Street and administration plans to present them to council
   by early 2019.

Bow River Bridge Piers Maintenance
   Project description & goals: The Bow River Bridge was designated a municipal heritage resource in December
   2016. Council committed funding from both a Capital Project Allocation and the Municipal Heritage Reserve. The
   project scope includes rehabilitation of the decorative masonry along the northern retaining land pier and the first
   river pier along the northern shoreline. The scope of work is purely cosmetic.
   Current Status: The Town was successful in receiving a grant from Alberta Culture of $11,920 to help fund this
   project, the grant falls short of the $150,000 required to complete the work. The project has been tendered and
   pricing is not within the approved funding limits. RFD will be presented to council to seek direction on project
   funding and scope.

Bridge and Culverts Maintenance
    Project description & goals: Inspection of all town trail bridges and replacement of the Marmot Crescent culvert.
    Current Status: The inspection of all trail bridges was completed by a consultant. Minor repairs and further
    inspections are required. This work is planned to be performed within the remaining capital budget.
    The Marmot Crescent culvert replacement contract has been awarded; construction is ongoing and is scheduled to
    be complete by the end of 2018.

Cave Avenue Reconstruction
   Project description & goals: Complete reconstruction of Cave Avenue from the Luxton Museum to the Cave and
   Basin National Historic Site. The scope included burial of overhead utilities, reconstruction of the water, sanitary
   and storm systems, new curb and gutter both sides of the street and sidewalk on the north side, new street lighting
   on the north side of the street, reconstruction of the full road structure.
   Current Status
   Asphalt cracks have been sealed. Project complete $180,000 under budget. Remaining unspent funds to be
   returned to reserves.

Lynx Street Light Replacements
   Project description & goals: Support the replacement and re-design of Fortis managed street lights along Gopher
   Street and Lynx street.
   Current Status: Detailed design has been completed for phase 1 of the project and the projected construction date
   is November 2018.

Permanent Rainbow Crossing
   Project description & goals: To show though this most visible symbol the Town of Banff supports and advocates for
   an inclusive community.

                                                          17
Photo courtesy of RMOL
    Current Status: Complete

Streetscape Design Guidelines Project
    Project description & goals: The Town of Banff is developing Streetscape Design Guidelines that describe standard
    roadway configuration options and overall style for each of the public street types in Banff. Developing streetscape
    design options collectively will provide a unified design standard for future roadway reconstruction projects and
    individual infrastructure improvement projects.
    Current Status: Administration is currently working with a team of professional landscape architects and engineers
    to develop streetscape design options that include cross-sections and detailed plans. The goal is to finish this
    project in 2018.

Railway Station Intercept Lot - Public Rd Enhancements
    Project description & goals: Design and potentially implement roadway improvements relating to the construction
    of an intercept lot located east of the railway station.
    Current Status: Initial design work has commenced on temporary changes at the Railway / Elk / Lynx intersection.
    Any proposals for permanent improvements will be returned to Council in order to address funding and related
    implications.

Roadway Overlay Program
   Project description & goals: Prioritized roadway overlays across the townsite to prolong the life of the road
   surface.
   Current status: 2018 scope was as follows
       • Banff Ave from Wolf to Fox Streets
       • Rabbit St from Banff Ave to Marten St
       • Marmot St
       • ~10 localised patches associated with utility repairs or local deterioration of the road surface.
       • Banff ave overlay was re-scheduled to 2019 due to weather conditions and the risk of creating issues with
            the pavement surface and road substructure by attempting the work in less than ideal weather conditions.

        The last town wide pavement assessment was carried out in 2014 and is in need of update; in 2019 the town
        will engage an inspection company to carry out a condition assessment that will inform future year’s scopes.

                                                           18
Sidewalk Improvement Program
    Project description & goals: Complete a series of upgrades and replacements to maintain and improve the quality
    of sidewalks.
    Current Status: The Town have engaged a consultant to develop streetscape design guidelines to develop concept
    templates of how street cross sections to better inform how we build and replace right of way infrastructure,
    including our sidewalks, in a more integrated fashion. This design work should be complete by the end of the year.
    Also this year a full review of our sidewalk conditions has been undertaken as per policy C7001, a report will be
    provided to council in September. Two high priority wheelchair ramps near the hospital were also replaced.

St. Julien Road Shallow Reconstruction & Storm Improvement
     Project description & goals: Reconstruction of St Julien Road to enhance pedestrian & cyclist connectivity, lighting
     and storm water management.
     Current Status: The sewer line under St Julien was inspected in 2018, to assess the condition of the line and
     determine if it should be replaced during this scope of work. Design has been prioritized with other projects and is
     pending the results of the streetscape design project (currently underway).

Street Lighting Upgrades Program – LED Retrofit
    Project description & goals: Retrofitting of existing Town-owned street lights with energy-efficient fixtures.
    Current Status: Design work is underway for the Moose Street/Moose Hotel area. LED fixtures have been ordered
    for two remaining locations to be installed in 2019.

Thermoplastic Line Painting
   Project description & goals: Permanent line painting at crosswalks and other important intersections.
   Current Status: Operations and engineering are determining best locations for new markings and to co-ordinate
   where applicable, with the roadway overlay program. Following the repaving of Banff Ave, thermoplastic line
   marking will be applied to Banff ave from Wolf to Fox streets

Banff Refreshing - Wolf & Caribou Trial
   Project description & goals: Implement seasonal pedestrian improvements over the next few years to reflect the
   Banff refreshing standard. The new streetscape provides adequate space for active or passive pedestrians while
   responding to the new AGLC requirements and Sidewalk Seating/Cafe Policy.
   Current Status: Complete, but minor improvements may occur in years going forward.

    Before

                                                           19
After

Resource Recovery

Automated Driveway Gate
   Project description & goals: Add driveway gate to resolve potential wildlife conflicts and better control movement
   of vehicles and waste into the Resource Recovery yard
   Current Status: Project has been awarded with installation to happen in Q4 2018.

District Heating System
    Project description & goals: Examine the feasibility of burning wood waste as a method of building heating
    Current Status: Final administrative review and edit is in progress; New Service Request to be presented at the
    2019 Service Review

Food waste decant and storage
   Project description & goals: Construction of a food waste storage area to enable the consolidation of trips to the
   Waste Water Treatment Plant (WWTP). Reducing operating costs per tonne and the number of wildlife
   disturbance events are the principal project goals.
   Current Status: This project is linked to a consideration of potential improvements to bio-solids & food waste
   processing. A temporary ramp will be created and roll-off bins used to bulk and decant Food waste liquids before
   shipping to a compost facility east of Calgary.

Pedestrian Bin Replacement
   Project description & goals: replacement of selected pedestrian bins at the end of their natural life cycle.
   Current Status: Finishing the wood cladding on this year’s bins with plans to exchange old for new by years end.
   More bins to be replaced in 2019.

                                                          20
Residential Bin Area Enhancement
    Project description & goals: enhance appearance of the residential area bins.
    Current Status: Have temporarily put this project on hold to wait the outcome of the targets and tactics presented
    at the 2019 Service Review but will replace residential bins as needed.

Rotating Grapple Attachment
   Project description & goals: Purchase of a rotating grapple to increase the efficiency of handling and sorting of
   material in the resource recovery yard
   Current Status: Purchase has been awarded, awaiting for grapple to arrive and be installed.

Transfer Station Upgrades
    Project description & goals: Repair of building siding and installation of a steel containment wall to increase
    capacity of the waste transfer site. The project will resolve storage shortages that arise when the West Dried
    Meats Lake Landfill is closed. Discussions are ongoing with the Bow Valley Waste Management Commission
    regarding cost sharing for the upgrades.
    Current Status: Now that business in the Transfer Station has slowed, the distorted exterior sheet metal has been
    replaced. The Bow Valley Waste Management Commission’s engineer to review Banff’s stamped drawing in order
    to access BVWMC funds for a portion of the improvements.

SEWER

Bow River Siphon Replacement & Ped Bridge
   Project description & goals: Replacement of the pipework carrying all sanitary waste across the Bow River by
   suspending 2 new sanitary force-mains to a new pedestrian bridge. The concept used funds allocated to
   excavation and environmental protection related to a recommended open cut solution to complete the pipework
   and pedestrian bridge within the project budget.
   Current Status: project complete. 4,000 average daily crossings in July and August 2017 (250,000 crossings).
   Upgrades to the level detection, mixer, grinder and odour control systems to mitigate the effects of rags and grease
   in the collection system have been completed within the project budget. Remaining unspent funds to be returned
   to reserves.

Bear St Woonerf - Sanitary Sewer
   Project description & goals: In 2018, council directed administration to replace the deep utilities. Design will be
   integrated with the new streetscape design.
   Current Status: Design ongoing.

                                                           21
Sewer Main Repairs
   Project description & goals: Using condition assessment data, prioritize and complete sanitary sewer repairs as
   budget permits.
   Current Status: 2017 funds were directed towards the replacement of 220 metres of pipe along Glen Avenue that
   was found to be in poor condition. This pipe replacement work is complete and the pipe is back in service. RFD to
   council requesting funds be moved ahead from the 2019 budget year to 2018 to address an emergency service
   installation to the Banff Springs Hotel. Work is progressing this fall weather dependant.

Sulphur Mtn Sanitary Sewer Main Replacement
    Project description & goals: Replacement of the fractured clay tile sanitary sewer from the Gondola/Hot springs
    parking lot to the Banff Springs Hotel
    Current Status: Design work complete and project is out to tender.

                                                                         (Fractured clay pipe)

Trunk Sanitary Sewer Condition Assessment & Cleaning
   Project description & goals: Cleaning and condition assessment of the sanitary main from Glen Avenue to the
   Waste Water Treatment Plant.
   Current Status: Cleaning is complete and the majority of the line was found to be in good condition. Council
   directed savings from the cleaning project to the replacement of 220 metres of pipe along Glen Avenue (above).
   Work completed, remaining unspent funds to be returned to reserves.

WWTP Capital Upgrades
  Project description & goals: Upgrades to maintain operational efficiency and effluent quality. See individual
  project descriptions and current status below.

        Filter upgrade 2017–2018:
        Replace existing filter technology, dual media gravity filter, to disk filtration. New technology
        Update:
             • Design–Build contract has been awarded to Tritech Group Ltd.
             • Filter equipment issues for fabrication
             • Communicated with Parks and Alberta Environment to identify regulatory requirements.
             • Installation of new filter package planned in March–April 2018. Complete commissioned fall 2018

                                                         22
Honeywell Building management system migration to plant SCADA
Honeywell building management system controls the HVAC system of WWTP. Migrating HVAC control
narrative to SCADA system eliminate the annual license and maintenance fee.
Current Status :
The project has been completed.

N–Viro Roof 2017–2018:
Replacement of existing roof and upgrade to HVAC system to improve indoor environment
Status: Fall 2018- project substantially complete with deficiencies and final commissioning scheduled
October 2018

Clarifier Drives:
Three clarifier drives have been leaking for the last couple of years. Installation of purchased drives
schedule in 2017–2018.
Status: Contract has been awarded to Davenport Millwright. Work underway primary one clarifier
complete. Contractor working on replacement of 2 secondary drives

                                                    23
WATER

Bear St Woonerf – Water
   Project description & goals: In 2018, council directed administration to replace the deep utilities. Design will be
   integrated with the new streetscape design.
   Current Status: Design ongoing.

Chlorinator
    Project description & goals: Install new flow-paced chlorinator to dose chlorine in line with water demand
    Current Status: New chlorinator is on site, awaiting proposals for ventilation system and flow pacing equipment.
    New chlorinator scheduled to be online winter 2018

Emergency Generators
   Project description & goals: Install emergency generators at key locations to safeguard critical needs in the event
   of prolonged power outage.
   Current Status: Generator installations have been completed for Town Hall (which included Central Park lift station
   and upgrading electrical infrastructure along with a new event panel for Central Park). Additionally, Elk Street,
   Whiskey Creek, Marmot and Birch Street sewage lift stations generator installations are complete.

    The 600kw generator for the wellhead water supply has been delivered but not commissioned. Administration is
    working with Parks Canada and Associated Engineering to finalize a path forward regarding a permanent location.
    Town is in alignment with Environment Canada guidelines for placement generator in current location. Parks
    Canada has chosen to conduct independent analysis on generator placement. Awaiting results of Parks study.

SCADA Upgrades
   Project description & goals: upgrades to the Supervisory Control and Data Acquisition (SCADA) system used to
   monitor and operate the town’s water and wastewater systems.
   Current Status: WWTP communication between PLCs switched to fibre optic, faster and reliable. Commissioning
   and testing have been successfully completed. The merger of distribution & collection and WWTP have been
   completed. PLC updates at Middle springs and Mountain avenue booster stations round out the project.

                                                           24
Valve Replacement
       Project description & goals: Using condition assessment data, prioritize and complete valve repairs or
       replacement as budget permits.
       Current Status: 2018 phase one Mountain Avenue completed which entailed service relocation and the
       capping of the 150mm water main on Mountain Avenue to prevent mainline freezing conditions. Phase 2 is the
       relocation of the fire hydrant on Mountain Avenue and capping the main north of parks administration
       building. Work scheduled to be complete this fall weather permitting.

OTHER

Bylaw Alberta First Responder Radio Communication System (AFRRCS) Radios
    Project description & goals: Update the current radios to multi-band AFRRCS compatible radios to effectively
    communicate with RCMP and other response agencies.
    Current Status: Currently, the RCMP is working on transition to the AFRRCS system, Bylaw radios will be purchased
    once the RCMP transition is made. This initiative is moved into 2019.

Catch Basin Replacement Program
    Project description & goals: Using condition assessment data, prioritize and complete catch basin repairs or
    replacement as budget permits.
    Current Status: 38 catchbasins with surface damage (grates or localized settling) were repaired in 2018. 2018 is the
    final year of this program however there is some carry over budget that the Administration intends to use to
    complete more surface repairs of catchbasins in 2019. Administration will also undertake an assessment in 2019 to
    inform future funding requests for storm water infrastructure.

Conversion to Electronic Forms Project
   Project description & goals: Electronic forms which can be filled out and submitted from any ToB mobile device.
   Current Status: Complete, final invoicing pending.

    The use of e–forms is resulting in improvements in efficiency of operations in the field and in the quality of data
    available for use by all staff.

    The initial electronic form project saved completed forms in pdf format. These were not searchable. It was hoped
    that this form saving process would be modified to save competed forms in a database format, but when the
    project was started there was no internal capability to do so, and it was intended that a third party would be
    engaged and paid to complete this conversion.

                                                            25
In 2015-16 John McAulay, IT Coordinator, ToB IT department, converted all existing forms to be saved to a
    database. John continues to work with ToB form creators to ensure new forms are configured to insert completed
    information into the database.

    Now that the database conversion has been completed, and is the repository for form data, a greater detail of data
    reporting and a more streamlined search function is possible. At the moment reporting is performed by a request
    to the IT department.

    The next step will be to complete a user accessible reporting mechanism, which has been started by IT, working
    with Fleet Services.

Financial Software Update
    Project description & goals: Update of financial software to current version including training for staff on the
    software.
    Current Status: Substantially complete. Administration is exploring options for the replacement of our job costing
    software with the remaining budget.

Information Governance Master Plan Implementation
    Project description & goals: In 2015 council accepted the Information Governance Master Plan as a guiding
    document for the Town’s information governance program. The plan is a multi-year, multi-phase forward roadmap
    to achieve an essentially complaint information management. The capital project approved in 2017 is for
    expenditures for electronic content management (ECM) and electronic records and document management
    systems (EDRMS) systems.
    Current Status: Continued implementation of the IG Master Plan foundations. A technology ready Information
    Governance Policy and Retention Schedule will be presented to council in Q4, 2018. The IT Coordinator worked
    closely with the Town of Canmore in the implementation of their pilot project. Once the best practices and
    learnings from the Canmore pilot project are fully developed, work will commence the final procurement of the
    required technologies.

Public Art Exhibit Project
   Project Description & Goals: Commission 4 artworks for 4 ½–year temporal exhibition at Bear Street Mall and Banff
   Town Hall; proceed with fabrication of all artwork exhibition materials/hardware and required installation.
   Current Status
        Bear Street Mall exhibition (When I Close My Eyes) to remain in place until end of 2019, at minimum.
        Banff Town Hall exhibition: Raven #2 was exhibited 2013-2014; Stuff Animals exhibit was extended to July 2017
        as it was temporarily removed during its display because of hardware failure; Love is Touching Souls will be
        exhibited from July 2017 until end of 2018.

                                                          26
River Ribbon Public Art Project
    Project description & goals: Commission new permanent art installation, River Ribbon by Alexander Caldwell;
    Current Status: River Ribbon was installed in December 2017.

                                                         27
Recreation Program & Facilities Software
   Project description & goals: The previous booking and registrations software is obsolete and servicing expired in
   2017, resulting in need to purchase new software. Procurement process was undertaken and BookKing was
   selected in spring of 2017. Improved reporting, online registration and payment and mobile point of sale and
   membership registrations (i.e. tablets for scanning membership cards at community classes, drop–in sports, etc.)
   identified as key features.
   Current Status: Project is 90% complete. Data transfer to new system is complete and on-line registration
   launched in the fall of 2018. All programs, services and facilities are now housed in the new system. Flex
   registration for children and youth programs is the only element still being processed in Class as we await the
   module development from BookKing(currently underway). A few remaining equipment pieces to support the new
   drop in punch passes and any supporting technology related to the child/youth program flex registration are still to
   be purchased in 2019 as we assess our needs for these supplementary pieces to best support the new system.

Signage & Wayfinding Master Plan
    Project description & goals: Town–wide wayfinding installation to enhance visitor experience.
    Current Status: The entrance sign on Norquay Road and a digital message sign to be located by the hospital are
    complete. Discussions with Parks Canada on the location of the entrance and digital message signs on Banff
    Avenue (east entrance) are ongoing

Storm Water Consulting Design
    Project description & goals: consultation and survey work to identify underlying issues causing ponding during
    heavy rain events and/or snow melt in several areas of town
    Current Status: consultant scope has been awarded and is ongoing

Town Entrance Sign Enhancement
   Project description & goals: construction of a crossing and traffic calming by the Banff sign at the Fenlands
   Current Status: Preliminary design work complete, project to be brought to council for discussion during budget to
   help inform the scope of the landscaping and traffic calming measures

                                                          28
DEER (Coyote) LANE

Coyote Lane
   Project description & goals: Construction of 131 below-market rental units – designed to meet or exceed priorities
   of liveability, environmental performance, Banff Design Guidelines, ease of maintenance, construction and
   operating costs. Project to be self-funding - without the need for a tax subsidy.
   Current Status:
    • Parks Canada supplied land for a 131–unit development at a 95% discount. The Provincial Government
         supplied $11.9M in funding.
    • The three main buildings achieved occupancy permit in late June 2018, 13 months after breaking ground.
    • 114 out of 122 units are currently occupied.
    • Rents for all units are 10-15% below market rate.
    • Construction of a further 9 units in 3 A-frame buildings is underway and scheduled for completion in
         November 2018 - 4 months after breaking ground on those units.
    • The project was completed on schedule and is currently under budget.
    • The building incorporates energy-saving initiatives including R50 roof insulation, heat-recovery ventilation
         systems in each unit, low flow plumbing fixtures, energy-efficient appliances and triple glazing
    • The building exceeds 2011 National Energy Code of Canada for Buildings (NECB) reference building efficiency
         (minimum building code) by 23%.
    • Electricity costs for the entire building, including all commonspace lighting, fans and pumps, elevator, door
         openers, suite heating, lighting and cooking and temporary power to the A-frames under construction were
         $5,000 ($41/unit) for the month of August when 110 units were occupied.
    • Offsite work is largely complete and will be complete before the end of 2018, off-site improvements to this
         area include:
             o Replacement of stormwater and sewer manholes in the lane as part of servicing the building.
             o Reconstruction of Coyote Lane, including paving and stormwater management improvements.
             o Sidewalks along Antelope St and Marmot St.
             o Formalization of 90 degree angle parking on Marmot St and pavement renewal.
             o Extensive tree planting along Antelope St and in the Deer Street ROW.
    • An official ribbon cutting ceremony is scheduled for October 17.

                                                         29
30
You can also read
