Operations and Release Working Group - Ricardo Wissmann-Alves - Head of IT Operations - MOSL

Page created by Jamie Conner

CONTINUE READING
Operations and Release Working Group - Ricardo Wissmann-Alves - Head of IT Operations - MOSL
Operations and Release Working Group

Ricardo Wissmann-Alves – Head of IT Operations

15 December 2020
Operations and Release Working Group - Ricardo Wissmann-Alves - Head of IT Operations - MOSL
Agenda
Item    Description                                                 Who     Time

1.      Welcome and introduction                                    RWA     10:00–10:15
2.      MOSL updates                                                RWA     10:15-10:45
        •      CMOS Maintenance schedule                            RWA
        •      Release Schedule 2021                                RWA
        •      Release 10.0 content                                 RWA
        •      Tariffs 2021/2022                                    HA
        •      Settlement                                           RWA
        •      G readings                                           RWA
                                                                    RWA
        •      Non Code Changes
3.      Forthcoming changes update                                  AH      10:45–11:15
        •      General                                              AH
        •      CPW106 – De-registration of long-term vacant SPIDs   AH/JJ
4.      Bilaterals Programme update                                 JG      11:15–11:30
5.      Data Issues / Improvements                                          11:30–11:45
        •      CMOS / Remedy users                                  RWA
        •      Notifications (Txxx.M)                               RWA
        •      Unplanned CMOS Outages                               RWA
        •      Observation Log (Improvement)                        HA
        •      Digital Certificates                                 JB
6.      AOB and wrap up                                             All     11:45–12:00

ORWG December 2020                                                                        2
Operations and Release Working Group - Ricardo Wissmann-Alves - Head of IT Operations - MOSL
Welcome and Introduction

   Participants
   Dynamics of web conference
   Hannah Allardice (IT Functional Consultant) will take the minutes
   Alex Crosbie (Digital Support Analyst) will state your name, please tell us your
    company name
   Feel free to switch your camera on

ORWG December 2020                                                                     3
Operations and Release Working Group - Ricardo Wissmann-Alves - Head of IT Operations - MOSL
MOSL Updates
Operations and Release Working Group - Ricardo Wissmann-Alves - Head of IT Operations - MOSL
Maintenance Schedule 2020
PRE PROD = MPS/MPS2                                                                                                                   Published on MOSL website
Outage time between 10:00 am and 04:00 pm for PRE PROD environments                                                                   CMOS > CMOS Releases
Outage time between 11:00 pm and 6:00 am for PROD environment
Oracle Database compression = Outage time between 6 pm on the first day (Friday) until 12 pm on the third day (Sunday)
                                    October/November
                                                                                                                    Oracle Database
                                    Friday 02/10/2020           Saturday 03/10/2020          Sunday 04/10/2020
                                                                                                                    compression
                                           MPS                         MPS                        MPS
                                   Monday 19/10/2020            Tuesday 20/10/2020         Wednesday 21/10/2020
                                     Cancelled (MPS)                   MPS                        MPS2
                                   Saturday 14/11/2020
                                          PROD

                                      December
                                   Monday 14/12/2020            Tuesday 15/12/2020         Wednesday 16/12/2020
                                                                                                                    Security
                                           MPS                         MPS2                        Mop Up
                                                                                                                    patch
                        NEW

                                   Saturday 19/12/2020
                                          PROD
                                 On 15/12/2020 there will be a planned maintenance of 30 minutes from 6pm in both
                                 MPS and MPS2 environments

                                       January 2021
                     Cancelled
                                   Monday 18/01/2021            Tuesday 19/01/2021         Wednesday 20/01/2021
                     Moved to
                                           MPS                        MPS2                       Mop Up
                     February
                                   Saturday 06/02/2021
                       2021
                                          PROD

                                      February 2021
                                   Monday 15/02/2021            Tuesday 16/02/2021         Wednesday 17/02/2021
                       NEW                 MPS                        MPS2                       Mop Up
                                   Saturday 20/02/2021
                                          PROD
ORWG December 2020                                                                                                                                          5
Operations and Release Working Group - Ricardo Wissmann-Alves - Head of IT Operations - MOSL
Release Schedule 2021
          Release    Deployment date             Time                         Environment
           10.0      16.04.2021                  10am-8am                     MPS2
                     30.04.2021                  10am-5pm                     Patch drop MPS2
                     14.05.2021                  6pm-2pm                      PROD
                     18.05.2021                  10am-5pm                     MPS

           10.5      30.07.2021                  10am-8am                     MPS2
                     13.08.2021                  10am-5pm                     Patch drop MPS2
                     27.08.2021                  6pm-2pm                      PROD
                     31.08.2021                  10am-5pm                     MPS

           11.0      01.10.2021                  10am-8am                     MPS2
                     15.10.2021                  10am-5pm                     Patch drop MPS2
                     05.11.2021                  6pm-2pm                      PROD
                     09.11.2021                  10am-5pm                     MPS
                            Published on MOSL website CMOS > CMOS Releases, including the Release
                            Notes updated on a weekly basis if changes have occurred

ORWG December 2020                                                                                  6
Release Management – R10.0

   NCC016 – Same Day Meter Readings Display
   NCC017 – Meter DPID Association History
   NCC019 – SPID status to be displayed on Premises screen
   NCC021 – Addition of business transactions button to search market information
    screen
   NCC022 – Meter Network Display
   CPW089 – T101 Adding Billing Address fields
             Further details for NCCs on MOSL website (Market Codes > Change > Non Code Change Requests)
             or MOSL Extranet - Non code change requests tracker

             Further details for CPWs Market Codes > Change > Changes

ORWG December 2020                                                                                     7
Release Management – R10.0

   NCC016 – Same Day Meter Readings Display
      Display of all meter readings (included retired readings) within the meter
        readings screen
      Current heading of the column stating “Removed” will be changed to Retired

ORWG December 2020                                                              8
Release Management – R10.0

   NCC017 – Meter DPID Association History
      Expand Meter / DPID association displays to show a historic meter / DPID
        association
      All meter / DPID associations that have been active at the SPID will be shown
      Trading Parties will be able to see when the active Meter / DPID ended and
        any reactivations that may occur after.

ORWG December 2020                                                                 9
Release Management – R10.0

   NCC019 – SPID status to be displayed on Premises screen
      SPID status to be shown on the Premises tab of the SPID
      Addition to the Core Data section of Premises where it displays the details of
        the Supply Points

ORWG December 2020                                                                  10
Release Management – R10.0

   NCC021 – Addition of business transactions button on to search market
    information screen
       A new button (B) for the BTD (Business Transactions Dossier) will be added on
         the results for the “Search Market Information” on the CMOS Portal.
       This will be a shortcut to go directly to the BTD

ORWG December 2020                                                                 11
Release Management – R10.0

   NCC022 – Meter Network Display
      Full visualisation of the Meter Network Display, regardless of the meter
        selected
      If the meter selected is a sub-meter, then the Meter Network Display will
        show the main meter
      If the meter selected is a main-meter, then the Meter Network Display will
        show the sub-meter(s)

ORWG December 2020                                                                  12
Release Management – R10.0

   CPW089 – T101 Adding Billing Address fields
      T101.W / T102.M New Data Items
          Developer/Business name*                                        Billing Address Line 4
          Customer Banner Name (if different                              Billing Address Line 5
           from Customer Name)                                             Billing Address Postcode*
          Billing Address Building Name                                   Contact Name
          Billing Address Line 1*                                         Contact Email
          Billing Address Line 2                                          Contact Number
          Billing Address Line 3
                     * Mandatory fields: if they are not known, then fill in with “Not Known”.
                     Remaining fields are optional and will be included in T102.M if provided in T101.W

ORWG December 2020                                                                                        13
System Code versions

System               Version         as of date

PROD                 9.0.1 (60111)                14/12/2020

MPS                  9.0.1 (59141)                14/12/2020
MPS2                 9.0.1 (59141)                14/12/2020

ORWG December 2020                                             14
Tariffs 2021/2022
Tariffs 2021/2022

   Timetable for Tariffs creation/update communicated on 1 December

   Tariff guidance document (CMOS > Training & Guidance > MOSL Guidance)
   Comms will be issued today

ORWG December 2020                                                          16
Settlement
Settlement timetable

          Published on MOSL website Customer Journey > Settlement > Settlement Runs

ORWG December 2020                                                                    18

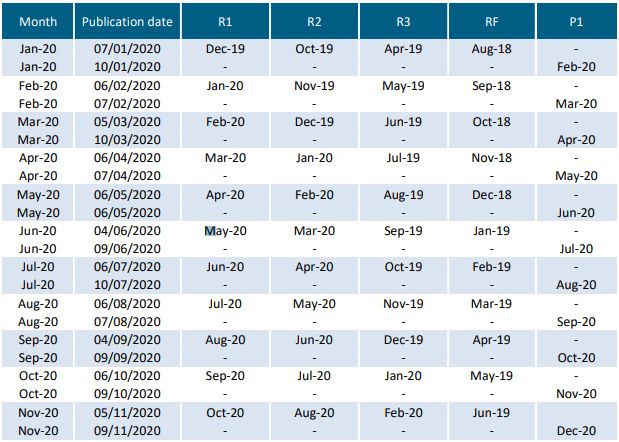

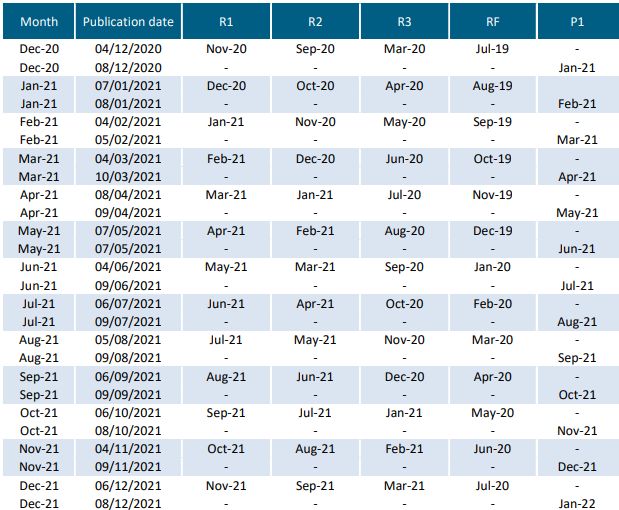

Settlement timetable

ORWG December 2020     19
Settlement

 Estimated Readings (ER run) being split into two stages to minimise runtime in
  advance of the RF calculation – comms always issued once the dates are confirmed
 January 2021 ER (RF = August 2019) will start on 28 December and the second
  stage will run on 4 January 2021
 Reminder comms will be issued on 22 December.

ORWG December 2020                                                             20
RF Settlement runs – G Readings
                          G readings created
              200,000

              180,000

              160,000

              140,000

              120,000

              100,000

               80,000

               60,000

               40,000

               20,000

                     0

ORWG December 2020                             21
Non Code Change
Non Code Change Process
Website: Market Codes > Change > Non Code Change Requests
Guidance: CMOS > Training & Guidance > MOSL Guidance > Non Code Change
Request (NCC) TP Guidance

    Allows changes to CMOS or MOSL systems to be requested and considered
           Sharepoint location for submitting change requests
                     MOSL EXTRANET / Non Code change Requests tracker
           Emailed confirmations of receipt
           Tracker Form of status
           Run consultations as per Code change CPs
           Submit to Panel if/when funding is required
ORWG December 2020                                                          23
NCC tracker
                                    Date                       Trading party                                                                                                                       Target
Request title                                 NCC Ref Category               Name                                                                                                         Status
                                    submitted                  submitted                              Describe the issue                                                                           Release
                                                                                                      CMOS offers users the option to select one of up to 5 buttons in the search
                                                                                                      market information screen to enter into a SPID depending on the set up of the
                                                                                                      SPID.
                                                                                                      As below where a SPID is set up for water & sewerage changes with an active
                                                                                                      meter & active DPID all 5 buttons are displayed.
                                                                                                      You are taken into the part of the SPID you wish to view depending on the button
Addition of business transactions                                                                     selected. Selecting P as an example will take you straight into the premises tab as
                                                              United Utilities                                                                                                                     CMOS
button on to search market          09/11/2020 NCC021 LVI                      Michael Floyd          below.                                                                              Review
                                                              Water Limited                                                                                                                        10.0
information screen                                                                                    Note that there is an additional tab not displayed on the front screen which is for
                                                                                                      business transactions. To navigate to the business transactions page you have to
                                                                                                      select one of the 5 buttons above then tab into the business transactions page.
                                                                                                      There is currently no way of going directly into the business transactions page.
                                                                                                      We often go into this page directly to find out granular information on
                                                                                                      transactions performed against a SPID.

                                                                                                      Currently a meter network is only displayed from the main meter downwards,
                                                                                                      with no information linked directly to the sub meter.
                                                                                                      In the “Meter Network” section of the Meter tab in the CMOS Portal, it shows the
                                                                                                      sub-meter(s) details associated with the main meter.
                                                                                                                                                                                                   CMOS
Meter Network Display               22/10/2020 NCC022 LVI     MOSL             Ricardo Wissmann-Alves When clicking on the sub-meter, regardless of the sub meter type, the user can’t Review
                                                                                                                                                                                                   10.0
                                                                                                      see that this meter is actually a sub-meter in a meter network. So any updates
                                                                                                      must be made with existing knowledge of the meter network that the user wishes
                                                                                                      to amend, which will have to be found in the Business Transaction Dossier or in
                                                                                                      Core Data.
                                                                                                      CMOS offers users the capability to check changes to service components via the
                                                                                                      service component history tab.
                                                                                                      This tab allows two data states to be compared for the following fields:
                                                                                                      Service component type
Service component history display                                                                     Special agreement flag
                                  18/08/2020 NCC020 LVI       United Utilities Michael Floyd          Special agreement factor                                                            Review
in CMOS
                                                                                                      Special agreement reference
                                                                                                      Tariff code
                                                                                                      Unfortunately, whilst the service components history tab creates a line to indicate
                                                                                                      that there has been a change to components with a change date, it does not
                                                                                                      actually give an indication as to what change has been made.

ORWG December 2020                                                                                                                                                                                           24
NCC tracker
                                 Date                       Trading party                                                                                                                          Target
Request title                              NCC Ref Category               Name                                                                                                         Status
                                 submitted                  submitted                             Describe the issue                                                                               Release
                                                                                                  As part of investigations into splits & mergers, unpaired SPIDs and other activities,
                                                                                                  users often perform a postcode search in CMOS. The search does seem to have
                                                                                                  some logic however, it appears to be based on a combination of created time/date
                                                                                                  and premises address, with any address starting with a 1 at the top of the returned
                                                                                                  search. Although numbers beginning with 1 are found at the top of the list they
                                                                                                  are not sequential as CMOS orders them based on the subsequent digit. For
                                                                                                  example as per the screenshot below 147 is displayed on the list above 15 -15a.
                                                                                                  When expanding the search to include 20 SPIDs (including some sewerage only
                                                                                                  SPIDs) it becomes clear that where there are sewerage only premises these are
Postcode search on search market                           United Utilities                       displayed at the top of the search results. The assumption is that the search is
                                 27/07/2020 NCC018 LVI                      Michael Floyd                                                                                               Rejected
information screen                                         Water Limited                          based on water SPID and as the premises address is blank, the SPID is displayed at
                                                                                                  the top of the search. At this point the sewerage address is then displayed in
                                                                                                  numeric followed by alphabetic order based on the sewerage premises address for
                                                                                                  the sewerage only address, then based on the water premises address for the
                                                                                                  remainder of the first 20 SPIDs created.
                                                                                                  As an example of SPIDs being returned based on creation, 143 Test Road is not
                                                                                                  included when searching on 10 SPIDs as this was not one of the first 10 SPIDs
                                                                                                  created however, when searching based on 20 SPIDs this appears above 147 Test
                                                                                                  Road as expected.

                                                                                                  This is in addition to functionality requested as part of NCC013.
                                                                                                  When reviewing a SPID's core data in the premises tab in LVI there is a supply
SPID status to be displayed on                             United Utilities                                                                                                                        CMOS
                                 27/07/2020 NCC019 LVI                      Michael Floyd         point's section which provides a hyperlink to go into the supply point. The service Review
premises screen                                            Water Limited                                                                                                                           10.0
                                                                                                  category, multiple wholesaler flag & landlord SPID flag are also displayed.
                                                                                                  It would be useful if CMOS could provide some form of indication as to when one
                                                                                                  or more of the SPIDs have been deregistered
                                                                                                  In line with MOSL IT Road Map, MOSL wants to provide a unified user interface to
                                                                                                  the market and want to establish a wider set of services to support this. These or
CMOS API Gateway                 26/06/2020 NCC015 LVI     MOSL           John Briggs                                                                                                 Review       CMOS 9.0
                                                                                                  similar services may, in time, be used in building the Bilaterals replacement
                                                                                                  solution.
                                                                                                  Within CMOS there are various scenarios that allow for different types of meter
                                                                                                  readings to use the same date. The issue is that when this happens, both meter                   CMOS
Same Day Meter Readings Display 26/06/2020 NCC016 LVI      MOSL           Chris Dawson                                                                                                Review
                                                                                                  readings are accepted but the first one is retired. Therefore the user only have                 10.0
                                                                                                  visibility of the "Active" meter readings.
                                                                                                                                                                                                   CMOS
Meter DPID Association History   26/06/2020 NCC017 LVI     MOSL           Ricardo Wissmann-Alves When a period of Meter-DPID association is split up by a period of disassociation, Review
                                                                                                                                                                                                   10.0
                                                                                                 the portal only displays the latest record, rather than all periods of association.

ORWG December 2020                                                                                                                                                                                            25
Forthcoming Changes Update

Amanda Hinde, Market Design
Implemented Code changes (6 Nov – 13 Nov 2020)
                                             CMOS
Ref #       Title                            Impact   Update

            Establishing Trade Effluent               Ofwat decision: 30 April 2020
CPW077                                       Y
            Charging Strength Methodology             Implemented: 6 November 2020

            Ability for Wholesalers to add            Ofwat decision 6 July 2020
CPW087                                       Y
            meter reads                               Implemented: 6 November 2020

                                                      Ofwat decision: 1 October 2020
CPM019      GDPR Data Security Standards     N
                                                      Implemented: 6 November 2020

CPW102/ Gender Neutrality in the Market               Ofwat decision: 8 October 2020
                                             N
CPM030 Codes                                          Implemented: 6 November 2020
CPW092/ Unified Disputes Process and         N        Ofwat decision: 26 October 2020
CPM029 Committee                                      Implemented: 13 November 2020

    ORWG December 2020                                                                  27
Changes awaiting implementation
                                          CMOS
Ref #          Title                      Impact   Update

                T101 Adding                        Ofwat decision: 1 October 2020
CPW089                                    Y
                                                   Implementation: 14 May 2021
                Billing Address fields​

   ORWG December 2020                                                               28
Ofwat Rejections
CPW061: Unsecured Credit Allowance (UCA) reflecting payment history (No CMOS impact)
 To create a new type of UCA for retailers that would be based on strong payment histories
 Ofwat considered there were insufficient rationale and evidence to support the case
 Decision: 27 November 2020

CPW086: Unsecured Credit Allowance (UCA) – Rebalancing (No CMOS impact)
 To increase the UCA for retailers with the highest level of credit assessment score from 20% to 40%
 Ofwat considered there were insufficient evidence
 Decision: 27 November 2020

CPW088: Enabling Wholesaler and Retailer to update meter location data (CMOS impacting)
 To allow retailers to update GIS X and Y coordinates, and to allow wholesalers to amend the Meter Location Free
   Descriptor Field
 Ofwat considered this could blur responsibilities for maintaining meter location data and did not offer value for
   money
 Decision: 7 December 2020

    ORWG December 2020                                                                                         29
Decisions at Panel Meeting (24 Nov 2020)
(No CMOS impact for all three change proposals below)
CPM036: Provision to vary term of Panel Members
 Allows Ofwat to grant the Panel an extension to the term of elected Panel Members
 Introduced due to coincidence of 2021 elections with Panel’s Governance Review recommendations
 Recommended for implementation 15 February 2021

CPW105: Provisions of Information Obligation
 Previously part of CPW059 which included the annual review of technical parameters
 Requirement for MOSL to prepare list of non code obligated documents remains but Panel no longer
   required to review their circulation
 Recommended for implementation 14 May 2021

CPW033: Improved process for managing Data Subject Rights Requests (GDPR)
 Developed by the GDPR Issues Committee
 Sets out timescales, responsibilities and recording of DSRR Requests
 Recommended for implementation 15 February 2021

   ORWG December 2020                                                                                30
Decisions at Urgent Panel Meeting (2 Dec 2020)
CPW108: Agreement to Unplanned Settlement Runs (USR) (No CMOS impact)
 Applies a backstop to requests for USR to prevent them becoming deadlocked
 Requests are deemed rejected after 20 business days
 Requesting party can then raise a dispute
 Recommended for implementation 5 days after Ofwat decision

   ORWG December 2020                                                          31
CPW106: De-registration of long-term vacant SPIDs

Amanda Hinde, Market Design
Janet Judge, Market Performance
What is the change? (Overview)

   CPW106 seeks to create an enduring process to identify ineligible Supply Points
    and create a backstop to facilitate their deregistration from CMOS, in order to
    reduce the number of long-term vacant Supply Points in the market.

   This change defines ‘Long-Term Vacant Supply Points’ as Supply Points associated
    with premises that have been marked as Vacant Premises for six (6) consecutive
    years or more with no identifiable consumption within the last six (6) years.

   MOSL will be the backstop to remove the SPIDs that have not been dealt with on
    the Candidate list.

ORWG December 2020                                                                    33
What are we doing? (High-level steps)
  1. MOSL produces                        2. Retailer        3. Wholesaler          4. MOSL is backstop to
Candidate Lists of long-                   reviews              reviews             “SPERR” SPIDs left on
  term vacant SPIDs                     Candidate List       Candidate List             Candidate List
      Candidate Lists                     Retailer has 3         MOSL uploads           MOSL monitors
    uploaded onto MO                    months to review     reviewed Candidate        progress using API
       Portal for the                   the Candidate List   Lists onto MO Portal
         Retailers
                                                              Wholesaler has 12       2 Days after issuing
                                       For SPIDs that                                   comms, MOSL
                                                                  months to
                                       should not be                                    deregisters the
                                                               investigate and
                                       deregistered,                                  SPIDs using SPERR
                                                               deregister SPIDs
                                    submit T112.R with
                                    text comment field
                                           “K21”.               For SPIDs that        MOSL publishes new
                                                                should not be         Candidate Lists after
                                                             deregistered, submit          3 months
                                                              T152.W with “K21”.
  Key:   MOSL   Retailer   Wholesaler
                                                                                                       34
Why are we doing this?
   “De-registrations are a low priority for trading parties. They naturally focus on vacant Supply Points
    with high consumption or volumetric charges given the revenue and cost impact, rather than
    focusing on Supply Points in the market which may need to be considered for deregistration.” –
    PwC’s review of vacancy in FY19/20
                                                                  Problems with high
                                                                  vacancy levels:
                                                                  • Inflates size of NHH
                                                                     market
                                                                  • Drives additional
                                                                     operational costs
                                                                     (e.g. trace activity)
                                                                  • Inhibits effective
                                                                     management of
                                                                     unplanned events

     ORWG December 2020                                                                               35
Next steps

 Consultation closed on 9 December 2020
 MOSL to work with Proposer to consider the 20 responses received

 Panel recommendation in February 2021
 Ofwat to consider change proposal
 Implementation in: May/August 2021, depending on Ofwat’s decision

ORWG December 2020                                                    36
Questions?

ORWG December 2020                37
Bilateral Transactions Programme - Update

John Gilbert, Programme Director
Agenda

           Headlines
                                  “   Our primary objective [for this business plan] is to
                                      make the market an easier place to do business in.

                                      The most significant market improvement that many
                                      members and the regulator want is a faster, simpler,
           Programme plan            more reliable way of managing bilateral interactions
                                      between wholesalers and retailers.
           Code change process
           AOB                       This will be the most fundamental
                                      development since market opening.

                                                                           ”
                                                                                   MOSL 2020/21 Business Plan
 ORWG December 2020                                                                                             39
Headlines
    Programme: full steam ahead
           Full Business Case approved 30 September
           Trading Party CEOs updated
           Expect to announce closing of £420k in-year funding gap in January
           Met ‘accelerated delivery of C1’ challenge and looking at additional CGI support in Q4

    Development: excellent progress - but timescales remain challenging
           Process analysis by OAG/TAG: Meter verification (C1) and Meter replacement (B5)
           C1.R (Retailer-initiated C1 process) user requirements complete - now with technical team
           C1.W (Wholesaler) process analysis shows close matching – good news
           Development: 11th two-week ‘sprint’ began today
           Invaluable input by advisory groups
           Demo of portal and first process on 21 October
           Priority order all 67 done – output to be considered by MOSL Business Owner/OAG in January
    ORWG December 2020                                                                               40
Headlines (continued)

    Key docs* reviewed by Pathfinders issued to trading
     parties today (Tuesday 15 Dec):
           Code Subsidiary Document CSD0601
           XSDs (XML schemas)
           Interface specification for C1 (meter verification)
           Proformas to carry out system comms test (‘ping test’)

    Go-live and implementation
           Implementation, ‘cutover’ and training plans taking shape
           Test strategy issued for review
           Presenting to Contract Managers at next six-weekly planning
            update 27 January                                    *Available at www.mosl.co.uk/bilaterals_latest
    ORWG December 2020                                                                                      41
ORWG December 2020   42
Bilateral Transactions Programme                                              Ofwat                31 July 2021                               30 Nov 2021                                   31 March 2022              30 June 2022                                          30 Nov 2022
Programme Board 14 December 2020                                              CPW070                    Phase 2                                    Phase 3                                          Phase 4                  Phase 5                                             Phase 6
                                                                              timetable               1 process                         +7 processes (total:                         +8 processes (total: 16) +12 processes (tot: 28)                                               +TBC
                                                                                                                                                         8)
                                            2021                                                                                                                                       2022
            Oct         Nov        Dec      Jan         Feb           Mar      Apr        May        Jun        July      Aug           Sept          Oct         Nov        Dec         Jan         Feb        Mar   Apr       May         Jun   July   Aug       Sept        Oct   Nov

                                 Pilot                                                                                                                                        Delivery & integration

Pilot       Dem         Developmen                Software releases
                                                                                                                                  Key
            o                t
                                                                                                                                          New activity
            CPW       Interfac                         Securit                                                                            Amber: in
                                                                                                                                                                                High level plan
            070        e spec                           y test                                                                            progress/at risk

                                  Test                                                                                                    Green: on track
                                  envt
                                                        PathF
                                                         LVI
                                                                                                                                                                                          Reminders:
                                                                                                                                          Activity

                       C1W
                                                         test
                                                                                                                                          withdrawn                                                     67 processes in scope
          C1R                      Ping      Pathfinder                                                                                   Activity complete
        scenari
           os
                      scenari
                        os
                                  testing    HVI Testing                                                                                                                                                Front-end-loaded: 8 processes = “80%”
                       C1R
                                  Priorit
                                     y
                                                        Intern
                                                           al         Notif                          Mandatory
                                                                                                                                          Previous position
                                                                                                                                          & direction of
                                                                                                                                                                                                        Implement over 6 phases
                       stori                                          ic-
                        es
                                  order
                                   revie
                                                         audit
                                                        issued        ation
                                                                                                      adoption
                                                                                                        point
                                                                                                                                          movement
                                                                                                                                                                                                        First process goes live in April
                                   Vali
                                     w
                       XSD/
                       OSD
                                   d-
                                                                                                     (LVI or HVI)                                                                                       Available via portal immediately (optional)
                                   atio
                                   n                                                                                                                                                                    Three-month integration period
               B5                  Rule
                                    B5                                         C1               Trading Party
              Revie                s
                                  Reqm                                         HVI               Integration                                                                                            Adoption mandated at end of July 2020
               w                    t                                                                                                                                                       NOTE:
                                                                                                                                                                                                 
                                                                                                                                                                                        Process priority Speed of rollout will accelerate
                                                                                                                                                                                       order subject to
Other             B5 started                                                         B5 HVI                                   TP integration                                           periodic review
Processes                                                                                           G2 HVI                         TP integration
                                                                                                                                                                                           On course for April 2020
                                                                                                                B1                       TP integration
                                                                                                                HVI
                                                                                                                          C2 H1                TP integration
                                                                                                                           HVI
                                                                                                                     2                C5 F5 HVI       TP integration
                                                                                                                 processes                                                          TP integration
                                                                                                                                                    C6 B3
                                                                                                                 per sprint                          HVI
                                                                                                                                                                C3 I1 HVI                TP integration

                                                                                                                                                                            G4 C4              TP integration
                                                                                                                                                                             HVI                                       Further processes (TBC)            Further processes (TBC)
                                                                                                                                                                                      I8 [X] HVI     TP integration
Implementation - Level 0 milestone plan
                 2021                                                                                                                    2022
   Nov   Dec      Jan      Feb         Mar      Apr        May          Jun    July      Aug         Sept     Oct     Nov       Dec        Jan          Feb       Mar        Apr         May        Jun   July    Aug       Sept          Oct    Nov

                                                                    31 July 2021                              30 Nov 2021                        31 March 2022                           30 June 2022                                  30 Nov 2022
    Ofwat                                                           Phase 2 (P2)                              Phase 3 (P3)                              Phase 4                               Phase 5                                      Phase 6
    CPW070                                                             1 process                     +7 processes (total: 8)                       +8 (total: 16)                       +12 (total: 28)                                       +TBC

  Level 0 Milestones (0-6 months)

                                        Support Services Live                                                               P2 – Benefits Realisation                   P3 – Benefits Realisation
                                                                                                                                                                                                                                 Key
                                                                                                                                                                                                                          On Track

         C1 – Technical Specs Shared                                                                                                                                                                                       At Risk
                                              Training Materials Live                 P2 – Cutover                               P3 – Cutover                 P3 – Performance Cutover
                                                                                                                                                                                                                           Not on Track
                                                                                                                                                                                                                          Completed
                                                   C1 – Go Live                                                     P2 – Performance Cutover                  Support Handover to BAU
                                                                                                                                                                                                                  C1       Meter Verification Process

             LO Milestones                                              Date                                           Status                                            Sign off criteria                             L1 Milestones

                                                                                                                                                                                                                 XSDs Complete
            C1 – Technical                                                                                                                                           Documents live on the                       Data Catalogue Complete
                                                                  16/12/2020
         Specifications Shared                                                                                                                                          MOSL website
                                                                                                                                                                                                                 Interface Spec Complete

                                                                                                                                                                                                                 Support Setup Complete
             Support Services                                                                                                                                           All level 1 milestones                   Resource Training Complete
                                                                  19/03/2021
                  Live                                                                                                                                                         complete

                                                                                                                                                                                                                  Requirements Complete
          Training Materials                                                                                                                                          Training materials live                     Training Sessions Complete
                                                                  26/03/2021
                 Live                                                                                                                                                   on MOSL website
                                                                                                                                                                                                                  Training Videos Complete

                                                                                                                                                                                                                   Process Review Complete
                                                                                                                                                                          C1 process
               C1 – Go Live                                                                                                                                          implemented into live                         User Stories Complete
                                                                  01/04/2021
                                                                                                                                                                       for all interfaces                    Screens/Transactions Implemented

     ORWG December 2020                                                                                                                                                                                                                                 44
Code change process
Code change process

  ORWG December 2020   46
47
Final thoughts

   1.    Bilaterals is a team effort - thank you
   2.    It’s ‘becoming real’
   3.    Q4 is going to be busy
   4.    So is the rest of 2021..
   5.    Are you ready?
   6.    Issues? Queries?                          www.mosl.co.uk/bilaterals

                                                     bilaterals@mosl.co.uk

 ORWG December 2020                                                            48
Data Issues / Improvements
Data issues – CMOS/Remedy users

 CMOS users – October we had 5,404 active users. Today 5,570
    An increase of 166 users since October (from Aug to Oct increase of 120 users)
    CSD006 – Trading Party Administration and Notification Process (Market Codes
     > Codes)
    Trading Parties are responsible for maintaining user accounts on the Market
     Operator Systems, including the termination of accounts as part of the exit
     process for leavers, but always within one (1) week of the user having left the
     Trading Party.
 Remedy users – maximum 10 users per Trading Party – on track

ORWG December 2020                                                               51
Data issues – Notifications (Txxx.M)

   CGI is investigating some notifications that haven’t been sent

   How TPs use the notifications?
      Automated system?
      Ignore them?

ORWG December 2020                                                   52
Data issues – Unplanned CMOS outages – 10 November 2020
   Incident (Outage 2hr 1min)
          The CMOS application (LVI and HVI) was unavailable to all Trading Parties
          It was identified that the deployment of the API Gateway had an incorrect setting
          The incorrect setting was corrected and applied, restoring the CMOS Application (LVI and HVI).

   Root Cause
          The API Gateway was released via the automated release tool, this included a new certificate.
          An incorrect value was entered manually into the automated release tools configuration as the incorrect certificate
           was selected.

   Lessons Learnt and next steps
          All system/server certificates used across CMOS will be revalidated, consolidated and centrally managed by Global
           Technology Operations (GTO)
          Review of certificates within the automated release tool for Production releases to be undertaken
          All release activity to the Production environment will be reviewed by the Change Advisory Board (CAB) prior to
           implementation into the Production environment - Production environment releases will only be performed outside
           of core business hours
          All resilient systems will be upgraded to ensure availability in the event of a failure.
          Additional manual steps will be undertaken to validate all certificates have been installed and bound to the relevant
           components.
ORWG December 2020                                                                                                           53
Data issues – Unplanned CMOS outages – 26 October 2020
   Incident (Outage 2hr 9min)
          MOSL reported that they were unable to access the CMOS portal.
          The CGI support team also advised that the server (MOSL-LVL-DB01) was not reachable.

   Root Cause
          The host (ccc-lpo-host-02) where MOSL-LVL-DB01 resides was restarted in error by an engineer who was managing an
           incident for another client
          The host and cable were correctly labelled, and the job sheet had the correct information on it
          The engineer disconnected the wrong cable – human error.

   Lessons Learnt and actions taken
          In order to prevent a reoccurrence, the teams have reviewed the process for restarting any kit within the CGI
           Commercial Cloud (CCC)
          The physical labels on the host systems within the CCC have all been checked and are correct
          A two-person ruling has been implemented such that each restart request will be checked by a 2 nd person before any
           work is carried out.

ORWG December 2020                                                                                                        54
Data issues – Unplanned CMOS outages – 4 June 2020
   Incident (Outage 1hr 7min)
          CGI lost the ability to manage the secondary firewall
          To rectify this a planned multi-client firewall change was approved by GTO management to restart it
          No outage was expected as the network traffic would transfer to the Primary firewall
          Following the completion of the change an incident was raised as MOSL were unable to access the CMOS application
          The CGI Application Team also confirmed that they were unable to access CMOS production.

   Root Cause
          A firewall rule that allows incoming access to the front-end web servers was corrupted from the CGI internet firewall
          Following discussions with the Senior Comms Engineer he concluded that during the restart, the firewall record had
           become corrupted
          A problem ticket was raised but we have been unable to find any root cause.

   Lessons Learnt and actions taken
          Since this incident we have managed many other Multi Client Changes that involve the failover from the primary to
           the secondary firewall and vice versa, all have completed successfully.

ORWG December 2020                                                                                                           55
Data issues – Unplanned CMOS outages – 17 April 2020
   Incident (Outage 7hr 15min)
          The CGI Application team were unable to login to the CMOS Application and Web servers in the pre-production
           environment
          This caused delays to a pre-production environment deployment due for release that day.

   Root Cause
          A change was required to add Firewall rulesets to allow access to the Qualys - Enhanced Vulnerability Scanner
          During the implementation, the engineer didn’t follow the documented process and didn’t review the underlying
           rulesets that were appended to the existing access-lists
          As a result, access to the Enhanced Vulnerability Scanner was allowed but all outbound traffic to the internet was
           denied.

   Lessons Learnt and actions taken
          The CGI Team has reviewed and updated the Firewall change process to ensure that it includes a two-member review
           by the 3rd Line Comms Team and the MOSL Infrastructure Design Architect before being approved and implemented.

ORWG December 2020                                                                                                              56
Data issues – Unplanned CMOS outages – 11 February 2020
   Incident (Outage 4hr 24min)
          MOSL were unable to access the MPS and MPS2 services hosted in CGI Commercial Cloud (CCC)
          The CGI Development Team were unable to access the Development servers
          A priority 1 incident was raised – it was quickly identified that the incident was affecting multiple Trading Parties.

   Root Cause
          Inter-site links (10 Gig) were decommissioned by Virgin Media following a “cease request” issued by CGI
          The “cease request” was sent correctly by CGI but due to a record management error at Virgin Media, the inter-site
           links were registered incorrectly resulting in the outage.

   Lessons Learnt and actions taken
          Revised the overall “cease request” process. This now includes a requirement for the 3 rd Line Telecoms Team to check
           the Impact Assessment of any cease request and sign off before the “cease request” is issued to vendors
          The issue has been raised with Virgin Media who have identified a training gap - their agent failed to make the
           appropriate checks as defined in the CGI Business processes. The Finance Planner role should check any “cease
           requests” to ensure they have the correct circuit reference and that a change reference has been applied. This process
           has now been added to the CGI internal knowledge base so the Control Bridge Comms Team can also perform checks.
           CGI has also reviewed all other third-party processes

ORWG December 2020                                                                                                                  57
Data issues – Unplanned CMOS outages – 11 February 2020
   Lessons Learnt and actions taken (cont.)
          A vendor reference should have been received when engaging with Virgin Media. If the request is urgent and a
           telephone call is made an e-mail follow up is now required to generate a vendor reference. The reference was not
           received, and no follow up call was made. The correct process has been reiterated to staff to ensure a reference is
           supplied
          CGI has successfully completed a full audit on all 10gig links to ensure that all are recorded and labelled against the
           correct customer
          Proactive monitoring, alerting and priorities for critical devices and ports have been fully reviewed. All alerts are now
           set at P2 priority and the circuit references have been added to the alert messages along with the multi-client name.

ORWG December 2020                                                                                                              58
Data issues – Transaction submission

 HVI Transactions
    Maximum number of transactions to be submitted: 3,600/hour/TP (since the
       end of March increased to 4,000/hour/TP from 8am to 6pm and, 6,000/hour
       between 6pm and 12am and 3:30am to 8am). No transactions to be
       submitted between 12am and 3:30am.
 MVI Transactions
    5,000 transactions/TP/month
    We have increased this since the end of March for specific situations, but
       larger volumes need to be communicated in advance for acceptance and
       planning.

ORWG December 2020                                                           59
Improvements – Observation Log
   Purpose: To simplify the observation/workaround log process internally and
    externally.

   Removed, altered or added
      Defect/Observation/Design                 Closing date (open tab only)
      Transaction 2                             Workaround tab (open)
      Transaction 3                             Workaround tab (closed)
      Transaction 4                             Links added to relevant observation and
      Technical layer
                                                  workaround tabs.
                                                 Columns rearranged to read easier
      Example spreadsheet will be uploaded to the website (CMOS > ORWG > Documents) file: Example -
      Observation Log.xlsx
ORWG December 2020                                                                                    60
Data issues – GlobalSign Certificates

 The Certificate Authority (CA) industry was alerted of compliance implications
  related to the inclusion of a specific extension (OCSP-signing extended key usage)
  in CA certificates which has, under certain conditions, unintended compliance and
  security implications
 GlobalSign PersonalSign issuing CAs "GlobalSign PersonalSign 1 CA - SHA256 - G3
  and GlobalSign PersonalSign 2 CA - SHA256 - G3" are impacted by this issue
 No key compromise or security incident has taken place, and the change is being
  performed solely in the context of remediating a compliance issue and addressing
  any potential, unmaterialized security risk.
 The revocation event of the certificates will take place on 24 February 2021

ORWG December 2020                                                                61
AOB and wrap up

   Slides will be published on the website this afternoon
   Meeting minutes to be published on the website in 2 days (CMOS > ORWG)
   Date of next meeting: 9 February 2021 – virtual meeting
   April meeting: 6 April 2021 – virtual meeting
   Everyone subscribed to the mailing list?

ORWG December 2020                                                           62
Merry Christmas
                              &
                     a great New Year
                       to all of us!!!
ORWG December 2020
You can also read
