Future architecture of the European airspace - Transition plan 2020 2028

Page created by Raymond Cannon

CONTINUE READING
Future architecture of the European airspace - Transition plan 2020 2028
Future architecture
of the European
airspace

                                2028

                         2025

Transition plan   2020
Future architecture of the European airspace - Transition plan 2020 2028
Future architecture of the European airspace - Transition plan 2020 2028
3    Executive Summary

4    Introduction

6    3 measures to put implementation into motion

     6     Measure 1: Launch an airspace reconfiguration
           programme supported by an operational excellence
           programme to achieve quick wins

     10    Measure 2: Realise planned implementations related
           to mature SESAR solutions supporting the
           implementation of cross-border free route,
           air-ground and ground-ground connectivity

     15    Measure 3: Accelerate market uptake of the next
           generation SESAR technologies and services

19   Dependencies on actions within and outside
     the scope of this transition plan

21   Appendices
     21    Roadmaps

     29    Risk management

     31    Master Plan Level 3 update

     35    Analysis of other supporting plans

     48    Terms of reference of the two programmes
           to be launched

     53    Link to SESAR Solutions delivery
Future architecture of the European airspace - Transition plan 2020 2028
Future architecture of the European airspace - Transition plan 2020 2028
Executive summary | 3

Executive summary
The Airspace Architecture Study was presented         Further to these three measures, which are de-
at an event organised by the Sky and Space In-        veloped in this document, this transition plan
tergroup of the European Parliament in March          also proposes how the Airspace Architecture
2019, highlighting that, ‘without an accelera-        Study recommendations can be taken up in ex-
tion of ATM modernisation and complemen-              isting plans that support the implementation
tary changes, the situation of air traffic delays     of the Single European Sky. These include the
will continue to deteriorate to an unprecedent-       proposed update of the European ATM Master
ed level’(1). It proposed a progressive transition    Plan implementation level (Level 3) to ensure
strategy towards the Single European Airspace         that SESAR is fully aligned with the recommen-
System in three 5-year periods, while building        dations of the study. An assessment was also
on known best practices and quick wins, as well       done for other key documents surrounding the
as existing initiatives such as the Single Europe-    European ATM Master Plan and supporting its
an Sky ATM (Air Traffic Management) Research          implementation, such as the network strategy
(SESAR) Joint Undertaking. The rationale of the       plan, the deployment programme, the European
study is that, by enabling additional airspace ca-    plan for Aviation Safety and the European Stand-
pacity, the air traffic management system will        ards Rolling Development Plan (2).
be able to cope with the significant growth in air
traffic, while maintaining safety, improving flight   The implementation of these measures is nec-
efficiency and reducing environmental impact.         essary to address the current capacity chal-
                                                      lenges with short-term actions and to secure
Conscious of the urgency to act to address the        the Airspace Architecture Study implementation
capacity and resilience challenge, this transition    timeline. They have to be seen together with the
plan identifies three key operational and tech-       planned setting-up by 2025 of an enabling frame-
nical measures that need to be implemented in         work for ATM data service providers (ADSPs), ca-
the very short term (2020 to 2025) in order to set    pacity-on-demand services and rewards for early
in motion the transformation changes outlined         movers, which are not further developed in this
in the Airspace Architecture Study.                   plan because they are being progressed directly
                                                      by European Commission services at the time of
These three measures are:                             writing this report. The successful and timely set-
    • launch an airspace reconfiguration pro-         ting-up of such an enabling framework is a key
      gramme supported by an operational              prerequisite to the successful implementation of
      excellence programme to achieve quick           this transition plan.
      wins;
                                                      Taken together, the three proposed measures
    • realise the planned roll-out related to         will facilitate putting in motion a successful tran-
      mature SESAR Solutions supporting the           sition towards a Single European Airspace Sys-
      implementation of cross-border free-            tem that leverages modern technologies. A suc-
      route, air-ground and ground-ground             cessful transition will be possible only through
      connectivity;                                   strong involvement from Member States, as well
                                                      as collaboration and commitment from all ATM
    • accelerate market uptake of the
                                                      stakeholders and professional staff. The ap-
      next-generation SESAR technologies
                                                      proach will need to focus on building and main-
      and services in order to prepare the de-
                                                      taining consensus for the transition, including
      fragmentation of Europe’s skies through
                                                      adequate change management and risk man-
      virtualisation and the free flow of data
                                                      agement processes.
      among trusted users across borders.

                                                      2
                                                         The Network Strategy Plan is owned by the Network
                                                      Manager, the Deployment Programme by the SESAR
                                                      Deployment Manager, the European Plan for Aviation
                                                      Safety by the European Aviation Safety Agency and the
1
   Airspace Architecture Study, Executive Summary,    European Standards Rolling Development Plan by the
https://www.sesarju.eu/node/3253                      European ATM Standards Coordination Group.
Future architecture of the European airspace - Transition plan 2020 2028
4 | Fututre architecture of the European airspace – Transition plan

1 Introduction

1.1 Context                                                  be implemented based on an agreed roadmap,
                                                             building on the recommendations described in
                                                             the AAS, and that a new market for ATM data
The ‘proposal for the future architecture of the
                                                             service providers should be created.
European airspace’ (the Airspace Architecture
Study, or AAS) was developed by the Single Euro-             In this context, in April 2019 the European
pean Sky ATM (Air Traffic Management) Research               Commission asked the SESAR JU, in close co-
Joint Undertaking (SESAR JU) in close coordina-              operation with the Network Manager and Euro-
tion with the Network Manager. It reconfirmed                control, to develop ‘a transition plan regarding
that, ‘without an acceleration of ATM modernisa-             the operational and technical dimensions of the
tion and complementary changes, the situation of             target architecture defined in the airspace ar-
air traffic delays will continue to deteriorate to an        chitecture study’.
unprecedented level’ (3). In other words, the status
quo is not an option.                                        In view of the worsening of the capacity situa-
                                                             tion and the fast-growing flight delays affecting
Handed over to the European Commission (4) on                the European network, generating unnecessary
5 February 2019, the AAS was publicly present-               extra costs to airlines, negative environmental
ed on 5 March 2019 at an event organised by                  impact and degradation of passenger experi-
the Sky and Space Intergroup of the European                 ence, the Commission services have recently
Parliament (SSI) and the Commission services.                treated the move towards the implementation
Since then the AAS has been made public (5).                 of the AAS as urgent and asked the SESAR JU
It contains proposals to address the airspace                to focus on the actions and programmes that
capacity and resilience challenges, both in the              aim to set the proposed AAS transition strategy
short term and in the medium to long term, by                in motion, with a focus on short-term solutions
combining airspace configuration changes and                 to the capacity crunch.
new technologies to decouple the service pro-
vision from the local infrastructure, by enabling            1.2     Objectives and scope
cybersecure data sharing and by progressively
increasing the level of automation support.                  The AAS gives a clear overview of the concepts
                                                             and changes that will allow the building of a
The conclusions and recommendations of the                   more efficient European upper airspace. Howev-
AAS have been well received by the aviation                  er, it has not developed a transition plan to move
community, which expressed broad support in                  from paper to reality. In addition, the requisite
principle. In particular, the AAS recommenda-                involvement and commitment of different stake-
tions were taken on board by the report of the               holders and the need to gradually develop to-
Wise Persons Group on the future of the Sin-                 wards a cross-border service-oriented approach
gle European Sky (6), which was submitted to                 make it indispensable to have a document that
the Commission in April 2019. The group rec-                 links all aspects and aviation communities.
ommended that a Digital European Sky should
                                                             The Wise Persons Group recommendation
³ Airspace Architecture Study, Executive Summary,
                                                             No 4 calls for the implementation of ‘a Digi-
https://www.sesarju.eu/node/3253                             tal European Sky based on an agreed roadmap
4
    Hereafter ‘the Commission’.                              building on the recommendations described
5
   Airspace Architecture Study, Executive Summary,
                                                             in the Airspace Architecture Study’. It is nec-
https://www.sesarju.eu/node/3253                             essary to provide very short-term answers to
6
   The Wise Persons Group on the future of the               the capacity crunch quickly, and the process of
Single European Sky was established by the European          selection of the next wave of SESAR research
Commission in 2018 to provide recommendations on the         and development (R&D) is ongoing; therefore,
future direction of European air traffic management:         the present transition plan is not yet a full im-
https://ec.europa.eu/transport/sites/transport/files/2019-
                                                             plementation plan with associated detailed
04-report-of-the-wise-persons-group-on-the-future-of-
the-single-european-sky.pdf                                  roadmaps, going all the way up to the com-
Future architecture of the European airspace - Transition plan 2020 2028
Introduction | 5

plete implementation of the intended Single              This document thus contains an initial ‘transi-
European Airspace System, the end goal of the            tion plan regarding the operational and tech-
AAS, with a target date of 2035. For now, it is          nical dimensions of the target architecture de-
a plan for how to set the operational and tech-          fined in the airspace architecture study’, with a
nical dimensions of the AAS in motion, with a            marked focus on short-term implementation
focus on the initial set of actions to be under-         measures. It includes airspace reconfiguration
taken in 2020-2025 and a higher-level view of            considering traffic hot spots and exploiting op-
how to ramp up the R&D needed for full deliv-            erational excellence for quick wins (Measure
ery of the AAS recommendations.                          1), as well as existing SESAR implementation
                                                         commitments that need to be secured, and
The Commission services have taken owner-                sometimes accelerated, during the third refer-
ship of addressing the regulatory and service            ence period (RP3) (Measure 2). As it is already
business model aspects of the AAS, which are             foreseen that the capacity relief from these
therefore out of the scope of this technical/            implementation measures will most likely be
operational plan. However, the team working              exceeded by traffic growth over the next couple
on this technical/operational plan has stayed            of years, the plan also contains a description
in periodic and close contact with this parallel         of the measures that will allow full leverage
work, to allow the good alignment of all dimen-          of digital technologies by accelerating SESAR
sions of the AAS’s implementation. It should             delivery (Measure 3), thus enabling and sup-
be stressed that the success of the implemen-            porting the timely transition towards the Sin-
tation of the present transition plan is subject         gle European Airspace System.
to the timely and successful conclusion of the
work on these regulatory and service business
model aspects.

Figure 1: The scope of this operational and technical transition plan in relation to the AAS transition strategy
Future architecture of the European airspace - Transition plan 2020 2028
6 | Fututre architecture of the European airspace – Transition plan

Each of these measures is further elaborated                • Measure 3: Accelerate market uptake of
in the next chapter.                                          the next generation of SESAR technolo-
                                                              gies and services, to prepare the defrag-
    • Measure 1: Launch an airspace recon-
                                                              mentation of European skies through
      figuration programme supported by an
                                                              virtualisation and the free flow of data
      operational excellence programme to
                                                              among trusted users across borders.
      achieve quick wins.
    • Measure 2: Realise planned implemen-               The success of this transition plan will be pos-
      tation related to mature SESAR solu-               sible only through collaboration and commit-
      tions supporting the implementation of             ment from all ATM stakeholders, including pro-
      cross-border free-route, air-ground and            fessional staff as well as Member States.
      ground-ground connectivity.

2 Measure 1: Launch an airspace
reconfiguration programme supported
by an operational excellence
programme to achieve quick wins

In 2018, there was an all-time record of 11 011          This action covering structural airspace bot-
434 flights in the network, an increase of 3.8 %         tlenecks indicates that a high number of
compared with 2017. En route air traffic flow            ACCs have started to show structural sector-
management (ATFM) delay was 1.73 minutes                 isation problems, with a high traffic demand
per flight compared with the EU-wide perfor-             being recorded in elementary sectors. While
mance target for the year of 0.5 minutes. It             this was the case for a high number of ACCs
was double the 2017 figure and resulted in a             in the Functional Airspace Block Europe Cen-
total of 19.1 million minutes of delay. A simi-          tral (FABEC) area, similar problems started to
lar situation is expected for 2019. The capacity         appear in central and south-eastern Europe
performance outlook included in the network              and on the south-west axis. Urgent action is
operations plan 2019-2024 indicated that ca-             required to start addressing these structural
pacity performance targets are at stake if ur-           airspace design problems and to avoid their
gent structural improvements are not put in              further aggravation in the longer term. To this
place in the short to medium term. Up to 33 air          effect, the Network Manager proposed the cre-
traffic control centres (ACCs) in Europe will not        ation of three major seamless airspace re-sec-
meet the required capacity targets over RP3. As          torisation projects to be developed on the basis
a result, the Network Manager’s ‘7 Measures              of operational requirements. They were already
for 2019’(7) were agreed to address capacity is-         discussed and agreed in the context of the net-
sues in the short and medium terms. One of the           work collaborative decision-making (CDM) pro-
actions included in these measures addresses             cesses and will be executed with the involve-
structural airspace bottlenecks.                         ment of all the operational stakeholders, with
                                                         a particular emphasis put on the air navigation
                                                         service provider’s (ANSPs’) involvement. This
                                                         was fully aligned with the short term conclu-
                                                         sions of the AAS.

7
   Network Manager, Eurocontrol, 2019 (https://www.
eurocontrol.int/news/seven-measures-counteract-severe-
delays)
Future architecture of the European airspace - Transition plan 2020 2028
Measure 1 | 7

The development and implementation of those                   The goal is to take concrete steps for ensuring
major airspace-restructuring projects is based                the defragmentation of the European airspace
on existing mature operational concepts —                     and the delivery of the required operational
free-route airspace, advanced flexible use of                 benefits. The two programmes will be executed
airspace (A-FUA) (8), cooperative traffic man-                separately, as they involve different operational
agement, etc. — and technologies to enable                    and technical expertise, but close coordination
swift development and implementation. Based                   between the two will be ensured throughout
on the outcome of the Airspace Architecture                   their development and implementation. The
Study, such airspace-restructuring actions, ac-               two programmes will be implemented gradual-
companied by an operational excellence project                ly and will take into consideration other major
and supported by the implementation of the                    projects under development and implementa-
technological support set out in the context of               tion. The need to progress towards seamless
the Pilot Common Project (PCP) (9), have the                  cross-border operations will also address sys-
potential to address the considerable challeng-               tems’ connectivity and interoperability, and im-
es of the RP3 performance targets and deliver                 provement of operational procedures.
the required performance by the end of RP3.
                                                              This milestone is supported by several solu-
                                                              tions, enabling the implementation of the ATM
                                                              functionalities of the PCP (further elaborated
    High-level description (*)                                by the Deployment Programme and the ATM
                                                              Master Plan Level 3) that are now in the imple-
    Launch airspace re-configuration pro-                     mentation phase, such as:
    gramme by promoting a collaborative pro-                     • automated support for dynamic sector-
    cess that would involve all relevant stake-                    isation;
    holders. This includes an analysis of areas of
    inefficiencies at network level, validation ac-              • extended arrival manager (AMAN);
    tivities and delivery of an optimised airspace               • enhanced demand-capacity-balancing
    organisation in compliance with agreed air-                    (DCB) tools such as Collaborative NOP
    space design principles, and based on ECAC                     (Network Operations Plan), Short-Term
    wide free-route traffic flows.                                 ATFM Measures (STAM), traffic complex-
    This new initiative would be complemented                      ity and target-time management;
    by an operational excellence programme,                      • advanced airspace management (ASM)
    which would aim at identifying best-in-class                   system including the integration of re-
    operations and capture quick wins (through                     al-time airspace data and further en-
    changes in operational procedures, opera-                      hancement of rolling air traffic flow and
    tional utilisation of resources, smaller adap-                 capacity management (ATFCM) process-
    tations to systems, etc.) among all stakehold-                 es and systems.
    ers and effectively support their harmonised
    implementation to reduce delays.
                                                              2.1 Optimised airspace
    (*) Extract from the Airspace Architecture Study.         reconfiguration, addressing
                                                              the hot spots
                                                              In the context of the Network Manager’s ‘7
                                                              Measures for 2019’, the Network Manager ini-
8
   The implementation of the A-FUA concept is to be           tiated an action ‘addressing structural airspace
conducted in accordance with the provision of Commission      bottlenecks’. This action has been tackled in
Regulation (EC) No 2150/2005 of 23 December 2005 laying       full alignment with the approach defined in the
down common rules for the flexible use of airspace,
notably its Article 4, and will require further work on its
                                                              AAS. The approach described below has al-
associated CDM process before implementation.                 ready been agreed through the network CDM
9
   Commission Implementing Regulation (EU) No                 Processes and is in progress in the FABEC
716/2014 of 27 June 2014 on the establishment of the Pilot    area. It will be followed for the other identified
Common Project supporting the implementation of the           hot spots.
European Air Traffic Management Master Plan.
Future architecture of the European airspace - Transition plan 2020 2028
8 | Fututre architecture of the European airspace – Transition plan

It will address, for 2020-2025 a structural ap-              discussed as part of the action ‘addressing
proach to airspace sectorisation focusing on                 structural airspace bottlenecks’ included in
                                   FOCUS ON HOT SPOTS FOR GRADUAL IMPLEMENTATION BETWEEN 20
a number of hot-spot interfaces as described,                the Network Manager’s ‘7 Measures for 2019’,
at a high level, in Figure 2. The 10 hot spots               and based on the current capacity situation in
identified here are numbered only for ease of                various parts of the network as extensively dis-
                                                                                                                                   Axis UK
reference, roughly from west to east, without                cussed in the Network CDM process.                             1
                                                                                                                                        Sp
hierarchy or sense of priority. They are already

                                                                                                                            2       Interf
                                                                                                                                       MU

                                                                                                                            3        Inter
                                   2                4
                               UK- France-      Germany
                                  MUAC-         upper and                                                                           Germ
                                                                               Interface                                    4
                                Germany            lower                        Poland-
                                Interface        airspace                       Slovakia
                                                               7           8
                                                    Austria-Czech                                                           5         Sw
                                   Germany-
             UK-Ireland-                             R.– Germany
                                   Switzerl. 3
            France-Spain-                              Interface        6
       1                           Interface                                                                                          Inte
            Portugal axis                                         Austria-              Hungary-                            6
                                                 5               Slovakia-                                                            Slo
                                                                                        Romania-
                                                                  Hungary                                   9
                                            Switzerland          Interface          Bulgaria-Greece-
                                               - Italy                                   Turkey                                    Interfa
                                                                                                                            7         Rep
                                             Interface                                  Interface

                                                                                                                            8     Interfac

                                                                                                                                 Interface
                                                                                                       Turkey-Cyprus-       9      Bulgar
                                                                                                       Greece--Israel- 10
                                                                                                        Jordan-Egypt
                                                                                                          Interface               Interfac
                                                                                                                            10   Greece-I

Figure 2: 10 European bottlenecks to address in the short term

The main goal will be the development of                     The main criteria and assumptions used will be
an optimised airspace structure, based on                    the following:
cross-border free-route airspace (FRA) and
                                                                   • airspace design criteria as defined in the
air traffic service (ATS) route network below
                                                                     Network Functions Implementing Regu-
FRA (if required) with appropriate connections
                                                                     lation (NF IR) (10);
to the terminal manoeuvring areas (TMAs). In
the context of the FRA projects, the connectivity                  • high traffic forecast to ensure sustaina-
to the TMAs (including TMAs covering several                         ble development of the airspace sector-
airports) represents an important factor for                         isation;
appropriate traffic structuring into, out of and
                                                                   • capacity and environment/flight efficien-
around TMAs. It will include the definition of an
                                                                     cy performance;
optimum sectorisation, together with the iden-
tification of the operational resources needed                     • for design and operations, European air-
to deliver the required performance.                                 space considered as a single airspace;

                                                             10
                                                                 Commission Implementing Regulation of 24 January
                                                             2019 laying down detailed rules for the implementation
                                                             of air traffic management (ATM) network functions and
                                                             repealing Commission Regulation (EU) No 677/2011.
Measure 1 | 9

     • FRA cross-border implementation;                Initiatives for dynamic sectorisation are already
                                                       taking place, and their potential for broadening
     • addressing lower and upper airspace
                                                       could be subject to large-scale demonstrations
       and connectivity with the TMAs (includ-
                                                       under SESAR JU auspices.
       ing TMAs covering several airports) and
       continuous climb and descent operations         The existing technical and legal provisions (in-
       (CCO/CDO), reorganisation of airspace           cluding the relevant ICAO annexes and the NF
       above flight level (FL) 410, reconsidera-       IR) allow an expeditious development and im-
       tion (if necessary and in cooperation with      plementation process.
       all operational stakeholders) of the air-
       space classification (on the basis of the       The proposed terms of reference of the Air-
       International Civil Aviation Organization       space Reconfiguration pProgramme, as coor-
       (ICAO) classification), gradual integra-        dinated by the Network Manager, are included
       tion of new entrants, etc.                      in Appendix E.1.
     • including all the developing civil-military
       ATM-related requirements and other              2.2 Operational excellence
       relevant national requirements;
                                                       programme
     • alignment with the European Route Net-
       work Improvement Plan (ERNIP), Part 1,          In parallel with the development and implementa-
       technical specification for airspace de-        tion of the new sectorisation projects that will form
       sign methodology and requirements.              part of the airspace reconfiguration programme,
                                                       an operational excellence programme will be put
Detailed implementation projects during RP3 will
                                                       in place with the aim of identifying and implement-
be derived from and documented in ERNIP Part
                                                       ing ‘best-in-class’ operations and delivering min-
2 and will ensure convergence towards the target
                                                       imum common operational capabilities among all
architecture. They will take into account existing
                                                       stakeholders. This will ensure the achievement of
airspace projects that are in process of develop-
                                                       operational and technical harmonisation aligning
ment and implementation and will address other
                                                       with best-in-class performance and delivering the
developments that are urgently required. The im-
                                                       expected operational performance in line with the
plementation roadmap will also take into account
                                                       AAS conclusions.
local and network priorities, major projects and the
RP3 performance plans. The process is planned to       The airspace reconfiguration programme and the
be finalised by mid-2020. Quick-win projects will be   operational excellence programme will be ad-
identified and implemented starting in 2020/2021.      dressed separately, as they involve different opera-
All the projects will be run through enhanced Net-     tional and technical expertise, but close coordina-
work Manager European Route Network Design             tion between the two will be ensured throughout
(ERND) Function Network CDM processes, involv-         their development and implementation.
ing all operational stakeholders.
                                                       The topics potentially to be covered could include
Even though this is deemed unlikely, as invest-        changes of operational procedures, letters of
ments in mature technology required for the tran-      agreement, application of A-FUA (12) and ATFCM,
sition plan are expected to be found in the RP3        operational utilisation of resources, flight notifi-
performance plans, Member States may ask for           cation and coordination exchanges, harmonised
an adjustment of their costs if they deem it neces-    implementation of new operational concepts (co-
sary to fully implement the transition plan. This is   operative traffic management) and technologies
authorised through Article 28(3)(a) of the Perfor-     (ICAO Flight and Flow Information for a Collabora-
mance and Charging Regulation (11) without being       tive Environment (FF-ICE), system-wide informa-
detrimental to the approved performance targets.       tion management (SWIM)), smaller adaptations to
                                                       systems, systems connectivity and interoperability,
                                                       reasons for different levels of sectors throughput,
                                                       etc. The formal and detailed scope of the topics to
11
    Commission Implementing Regulation (EU) 2019/317   be covered will be decided jointly and collabora-
of 11 February 2019 laying down a performance and      tively by all operational stakeholders.
charging scheme in the single European sky and
repealing Implementing Regulations (EU) No 390/2013
and (EU) No 391/2013.                                  12
                                                            A-FUA principles in footnote 5 also apply here.
10 | Fututre architecture of the European airspace – Transition plan

Detailed implementation projects during RP3            ment Manager (SDM) with regard to the deploy-
will be derived from and documented in the             ment activities under its responsibility.
network operations plan and will ensure con-
vergence towards best-in-class practices. They         Initiatives for quick implementation of more
will take into account existing initiatives that are   forward-looking concepts will be also identified
in process of development and implementation,          for implementation or for large-scale demon-
and will address other developments that are           strations under SESAR JU auspices.
urgently required. The implementation roadmap
                                                       The existing technical and legal provisions (in-
will also take into account local and network pri-
                                                       cluding the relevant ICAO annexes and the NF
orities and major projects. The process should
                                                       IR) allow an expeditious development and im-
be finalised by mid-2020. Quick-win projects
                                                       plementation process.
will be identified and implemented beginning in
2020/2021. The project will be run through an          The proposed terms of reference of the Oper-
enhanced Network Manager NOP CDM process               ational Excellence Programme, as coordinated
involving all operational stakeholders and will        by the Network Manager, are included in Ap-
coordinate, as required, with the SESAR Deploy-        pendix E.2.

3 Measure 2: Realise planned implemen-
tation related to mature SESAR Solutions
supporting the implementation of cross-
border free-route, air-ground and ground-
ground connectivity
Solutions supporting the implementation of the         through existing EU regulations on ATM such
2025 milestone identified in the AAS transition        as the Pilot Common Project. This measure
strategy (see Figure 1) have reached their nec-        therefore reflects those implementation activ-
essary operational and technical maturity and          ities that are particularly relevant to the imple-
are supported by a common agreement for                mentation of the AAS by 2025.
their implementation, as reflected in particular

 High-level description
 Finalisation of the implementation of                 interoperability and data exchange are critical
 cross-border FRA, irrespective of national            to defragment the technical dimension of ATM
 or flight information region (FIR) boundaries,        operations, and thus to move, at a later stage,
 supported by further progress in the imple-           to a virtual centre context.
 mentation of A-FUA, will provide the airspace
 structures required to enable efficient and           Consequently, the implementation of the re-
 flow-based sectorisation afterwards.                  quired airspace structures in 2020-2025,
                                                       supported by the successful and timely de-
 Air-ground data exchange will be essential            ployment of several PCP functionalities, will
 to increase progressively the level of auto-          provide the right framework to address sec-
 mation of the ATM systems. Ground-ground              torisation and operational excellence.
Measure 2 | 11

3.1 ECAC-wide cross-border                                        fuel efficiency. The validation exercises in
                                                                  2019 have confirmed the feasibility of FRA
free-route airspace and advanced                                  implementation with the existing systems
flexible use of airspace                                          and tools, and have underlined the ad-
                                                                  ditional benefits thanks to the use of en-
The implementation of FRA and of A-FUA is al-                     hanced ATC support tools. Cross-border
ready progressing well.                                           FRA in high-complexity environments is
                                                                  already under implementation.
Within the Network Manager’s (NM’s) geo-
graphical area, it is realised through the imple-           In addition, FRA implementation adheres to the
mentation of PCP ATM functionality 3 (AF3) (13)             concept developed as part of ERNIP and relat-
and relevant deployment programme (14) fami-                ed technical specifications for airspace design
lies, as well as relevant ATM Master Plan Level             and airspace management procedures. The co-
3 implementation objectives:                                ordinated implementation is part of the ERND
                                                            function of the Network Manager and is based
     • implementation of FRA, including related             on the airspace design principles included in
       system improvements;                                 the NF IR.
     • A-FUA and ASM systems (ASM tool, re-
                                                            The 2019 implementation status of FRA and its
       al-time harmonised ASM data exchang-
                                                            planned 2024 implementation status, as cur-
       es, rolling ASM/ATFCM process, prede-
                                                            rently included in ERNIP Part 2 — ARN (ATS
       fined airspace configurations).
                                                            Route Network) Version 2019-2024, are indicat-
     • In the SESAR Solutions catalogue (15),               ed in Figure 3. The detailed planning is includ-
       FRA is achieved by the following.                    ed in ERNIP Part 2 — ARN Version 2019-2024,
                                                            already approved by the Network Management
     • Solution #33: Free route through free
                                                            Board.
       routing for flights both in cruise and ver-
       tically evolving above a specified flight            The FRA implementation to date operates 24
       level. This solution was fully validated by          hours a day, with very few areas being time
       2015 and was already implemented in a                limited, and it went to a very large extent down
       number of ANSPs using flight data-pro-               to TMA levels (including TMAs covering sever-
       cessing (FDP) systems adapted to free-               al airports) or to the lowest level of the areas
       route operations, without either requir-             of responsibility of the air traffic control cen-
       ing new tools or affecting capacity.                 tres concerned. As Figure 3 also indicates, the
     • PJ.06-01: Optimised traffic management               cross-border implementation has expanded
       to enable free routing in high-complexity            significantly, including in areas with highly com-
       and very high-complexity environments.               plex traffic. In some parts of the airspace where
       This Solution has addressed the need                 FRA has not been yet implemented, modern-
       for new tools in complex environments                isation of local system support is planned to
       to support capacity and increased flight/            allow its implementation.

13
    As set out in Commission Implementing Regulation
(EU) No 716/2014 of 24 June 2014 on the establishment of
the Pilot Common Project.
14
    See Article 11 (1) of Regulation (EU) No 409/2013 on
the definition of common projects.
15
    SESAR Solutions Catalogue, 3rd edition, 2019, SESAR
JU (https://www.sesarju.eu/sites/default/files/documents/
reports/SESAR_Solutions_Catalogue_2019_web.pdf)
12 | Fututre architecture of the European airspace – Transition plan

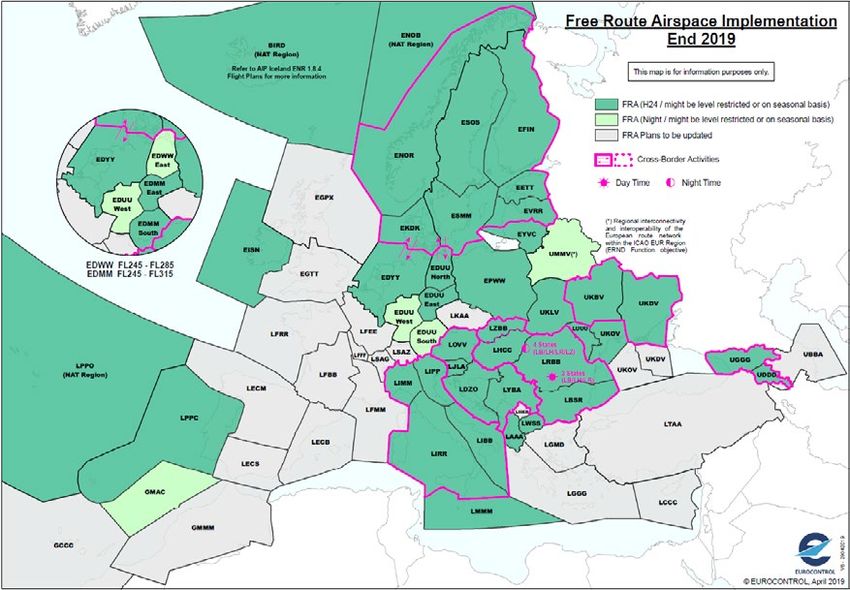

Figure 3: Free-route airspace implementation status at end 2019 and plans till end 2024
Measure 2 | 13

While several cross-border FRA projects have            operational stakeholders through an enhanced
been already implemented or are being im-               network CDM process, in cooperation with all
plemented (BOREALIS, South East Common                  operational stakeholders (17), and will be doc-
Sky Initiative Free Route Airspace - SECSI,             umented in ERNIP by mid-2020 with a plan to
South East Europe Night Free Route Airspace             implement them over the period 2020-2025. The
- SEEN FRA), further efforts will be required           implementation will also continue as part of the
over the period 2020-2024/25 to expand FRA’s            PCP implementation coordinated by the SESAR
cross-border implementation at pan-European             Deployment Manager within the remit of its re-
level, to take fully into account the development       sponsibilities. These developments will include
of airspace structures based on operational re-         connectivity to TMAs (including TMAs covering
quirements and satisfy the needs of major traf-         several airports) and CCO/CDO operations, re-
fic flows. In addition, further adaptation of cur-      organisation of airspace above FL410, review (if
rently implemented projects will be required to         necessary and in cooperation with all operation-
ensure full harmonisation as a major enabler            al stakeholders) of the existing airspace classifi-
for pan-European cross-border FRA imple-                cation (on the basis of the ICAO classification) in
mentation. The implementation of cross-border           some parts of the airspace, gradual integration
FRA will also offer better operational options in       of new entrants, etc. Regarding A-FUA, the es-
addressing decongestion of some critical areas          tablishment, improvement and implementation
of European airspace, especially in high-densi-         of procedures will be done in accordance with
ty areas. That has already been proven in com-          Member States’ prerogatives defined in the re-
plex areas where cross-border FRA has already           lated regulatory framework (18). Furthermore,
been implemented (e.g. SECSI FRA, Italy).               the utilisation by general air traffic of available/
                                                        released ‘special use airspace’ (civil use of re-
In parallel, all the evolving military require-         leased airspace) must be promoted in order to
ments will be integrated into the new airspace          fully reap the benefits of the flexible use of air-
structure to reflect the new needs expressed by         space (FUA) concept.
the military users and to ensure a sound civil/
military utilisation of the airspace. This also in-     The existing technical and legal provisions (in-
cludes separation of air traffic control (ATC) re-      cluding the relevant ICAO annexes and the NF
sponsibilities between general and operational          IR) allow an expeditious development and im-
air traffic, ATC coordination complexity and ef-        plementation process.
fort, air defence notification, embargo handling,
etc. It will be based on the further progressive
implementation of A-FUA, based on the en-               3.2 Air-ground and ground-
hanced network CDM processes in cooperation             ground connectivity through
with all stakeholders.
                                                        exchange of digital information
In the SESAR Solutions catalogue, A-FUA is
achieved by:                                            Connectivity through exchange of digital infor-
     • Solution 31: Advanced flexible use of            mation is needed to enable collaborative man-
       airspace                                         agement of airspace and remote provision of
                                                        air traffic services. These functionalities are
     • Solution 66: More efficient airspace             mature, and planned to be achieved by the
       management                                       timely implementation of objectives defined
                                                        by different PCP ATM functionalities as well as
All the developments described above, to be
                                                        pre-SESAR implementations. These objectives
made within the existing relevant regulations (16),
                                                        are documented in the ATM Master Plan Level
will be coordinated between the Network Man-
                                                        3 and the deployment programme, and are al-
ager, within the remit of its functions, and all the
                                                        ready in the implementation pipeline:

16
    In particular, Commission Implementing Regulation
(EC) No 2150/2005 of 23 December 2005 laying down
common rules for the flexible use of airspace, and
                                                        17
                                                           This process will respect in particular the needs
Commission Implementing Regulations (EU) No 716/2014    and responsibilities of the military and secure full
on the Pilot Common Project and No 2019/123 on the      accountability and buy-in of all operational stakeholders.
network functions.                                      18
                                                             In particular, Commission Regulation (EC) No 2150/2005.
14 | Fututre architecture of the European airspace – Transition plan

   • air-ground datalink;                             to be deployed to reduce telephone coordina-
                                                      tion and release underlying capacity already
   • integration of extended projected profile
                                                      available in the ATM system.
     (EPP) into the ground system;
   • new pan-European network services;               This transition plan recognises that the IOP
                                                      solution is critical to enable the European avi-
   • information exchanges using the SWIM             ation infrastructure to evolve towards higher
     Blue Profile (ATC data exchanges for co-         levels of interoperability, digitalisation and au-
     ordination and transfer, trajectory man-         tomation. A first set of IOP functionality (‘IOP
     agement, etc.);                                  foundation’, including inter-centre mecha-
   • enhancement of online data interchange           nisms) has reached maturity in 2019, leading to
     (OLDI) messages currently deployed, in a         a restart of the standard update process (Draft
     transition phase until full ground-ground        ED-133 A) by the end of 2019. The full func-
     interoperability (IOP) implementation (in-       tionality of the IOP solution will be delivered at
     cluding the exchanges for extended AMAN          V3 maturity in 2020, allowing the completion
     and notifications/coordination between           of an updated Eurocae standard (ED-133) in
     tower, approach and en route ATS units);         2021. The revised flight object IOP standard will
                                                      form the basis for industrialisation and imple-
   • information exchanges using the SWIM             mentation projects. To avoid a loose patchwork
     Yellow Profile (aeronautical data, ASM           approach and to ensure alignment of national
     data, extended AMAN data and net-                industrialisation and implementation activities,
     work-related exchanges);                         a specific IOP implementation project could be
   • interactive rolling NOP data exchang-            of value. It could become the first building block
     es (occupancy counts and traffic-moni-           for full IOP implementation beyond 2025.
     toring volumes, airport operations plan
                                                      The functionalities listed above have been as-
     (AOP) / NOP interfaces including API, dy-
                                                      sessed in the AAS as having the potential to
     namic sectorisation);
                                                      deliver concrete operational performance ben-
   • collaborative flight-planning exchanges          efits. The implementation will continue as cur-
     related to first system activation (FSA)         rently planned, with careful and close monitor-
     messages, ATC flight plan proposals              ing to ensure that the appropriate benefits are
     (AFPs), slot allocation messages) be-            delivered on time.
     tween ANSPs and NM, and enhanced
     tactical flow management system flight           To date, data exchange between ATC and the
     data (EFD) exchanges to support traffic          aircraft is based on very high frequency (VHF)
     complexity;                                      datalink mode 2 technology, with performance
                                                      (latency, bandwidth, etc.) that is not sufficient to
   • extended flight plan (eFPL) based on FF-ICE;     support the growing need for ATM air-ground
   • legacy and non-standardised tower/ap-            data exchanges in the longer term. Therefore,
     proach/ACC flight data exchanges for             development of future communication infra-
     notification and coordination purposes;          structure will have to be prioritised to achieve
                                                      the productivity gains and make efficient use of
   • operational air traffic (OAT) flight planning.   all the other enablers and technologies.
These functionalities need to ensure the rap-
id introduction of a secure digital communica-        Ground-ground connectivity also enables ATM
tions backbone that delivers high-performance         data service provision, aiming to support re-
connectivity for enhanced data exchanges be-          mote provision of ATS and the resilience of the
tween Network Manager, ANSPs, airspace us-            network. This concept supports the emergence
ers and airports. It must also comprise suitable      of new business models with several possibil-
civil-military interoperability elements.             ities, from the status quo to the emergence of
                                                      a new category of service providers, which may
In the same way as an air-ground datalink can         be implemented subject to the outcome of the
reduce voice communication, the automated             parallel study undertaken by the Commission
information exchanges between ground units            services and of the decisions to be taken by
within the same FIR or across boundaries need         regulatory authorities.
Measure 3 | 15

4 Measure 3: Accelerate market uptake of
the next-generation SESAR technologies
and services
The previous two sections (covering Measures 1       Single European Airspace System that will
and 2) aimed to describe short-term implemen-        deliver the ATM performance improvements
tation measures considering traffic hot spots and    needed and fully leverage modern technologies
building on known best practices, quick wins and     such as virtualisation techniques and dynamic
existing SESAR implementation commitments.           airspace configurations, supported by the grad-
                                                     ual introduction of higher levels of automation
However, in 2020-2025, focusing on short-            support as illustrated in Figure 4.
term implementation measures alone will not
enable the timely transition towards the target

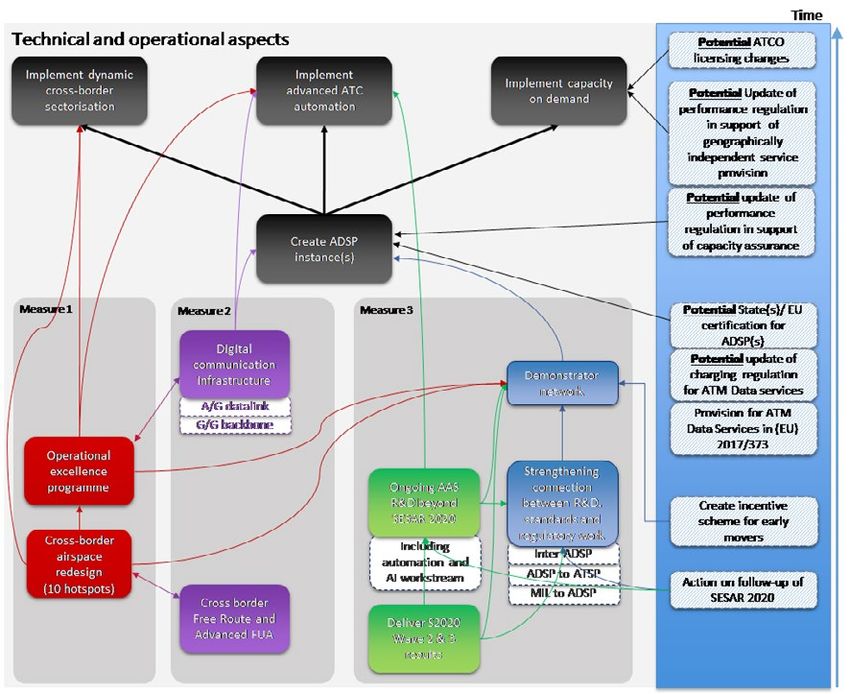

Figure 4: Main technical and operational elements targeted by this measure (framed in red)

This third measure is therefore needed to pre-       including through standardisation and certifica-
pare the defragmentation of European skies,          tion processes involving early movers.
through virtualisation and enabling a free flow of
data across borders among trusted users.             Central to this measure is the proposed gradual
                                                     implementation of an EU network of large-scale
To ensure the timely transition, the remaining       ‘digital European sky demonstrators’, which
R&D should be completed (see further details         must take due consideration of the traffic hot
in Appendix F: Link to SESAR Solutions deliv-        spots outlined previously. This network, tight-
ery), but the industrialisation phase of the next    ly connected to standardisation and regulatory
generation of SESAR technologies and services        activities to fix the industrialisation gap, will be
should also be significantly progressed by 2025,     an acceleration platform for a critical mass of
16 | Fututre architecture of the European airspace – Transition plan

‘early movers’ representing a minimum of 20 %         Demonstrators will test, in live environments,
of the targeted operating environments as de-         the concepts, services and technology support-
fined in the European ATM Master Plan, in order       ing the achievement of the AAS. This will help
to complete pre-implementation activities and         build confidence among the supervisory authori-
maximise the chances of later market uptake           ties and operational staff by building further per-
throughout the network, as laid down in the AAS.      formance and safety evidence.

Figure 5: Fixing the industrialisation gap and accelerating market uptake

Once established, this measure will allow dif-        4.1 Achieving core AAS R&D
ferent parts of the system to be implemented
at different speeds depending on local needs
                                                      The core R&D that underpins the study is fully
while maintaining overall coherence at net-
                                                      covered by the SESAR programme. In accord-
work level. Figure 5 illustrates this proposed
                                                      ance with Appendix E of the AAS, a gap analysis
approach, closing the industrialisation gap
                                                      has been performed to assess the degree of
and simultaneously accelerating market
                                                      coverage of the scope of the solutions delivered
uptake. Section 4.1 explains the underlying
                                                      by SESAR R&D against the completed, ongoing,
principles.
                                                      planned and future R&D within SESAR 2020.
                                                      The outcome of the analysis is shown in Table 1.
Measure 3 | 17

Table 1: R&D analysis

 Stage                                 Remarks
 Completed R&D                         34 % of the required SESAR Solutions have been delivered up to pre-
                                       industrial development and integration (V3)
 Ongoing and planned R&D               32 % of the required SESAR Solutions are expected to be delivered up
                                       to pre-industrial development and integration (V3) at the end of SESAR
                                       2020, i.e. by 2022
                                       23 % of the required SESAR Solutions are expected to have completed
                                       the feasibility research (V2) at the end of SESAR 2020. They will need
                                       further validation towards pre-industrial development and integration
                                       (V3) beyond 2022
 Future R&D                            11 % of the required SESAR Solutions have been defined for future
                                       research within the existing research programme, with the feasibility
                                       research (V2) intended to be complete at the end of SESAR 2020. They
                                       will need further validation towards pre-industrial development and
                                       integration (V3) beyond 2022

Details of this snapshot (20), including the detailed list of Solutions, their planned maturity dates
and their links to the AAS milestones, are available in Appendix F.

Figure 6: Delivery of SESAR solutions in support of the AAS

It should be noted that the AAS was limited in                  4.2 Strengthening connections
scope to focus on the upper airspace only. It is a
consistent subset of the European ATM Master                    between R&D, standards and
Plan, which is leading and structuring Europe-                  regulatory work
an R&D efforts. Consequently, the AAS archi-
tecture remains embedded in a bigger develop-                   In parallel with the standardisation and regu-
ment of air traffic management. The overview                    latory activities, industrial systems, operation-
of the R&D complementary to the AAS is to be                    al procedures and advanced services need to
found in Appendix F.9.19                                        be prepared for implementation, and financial
                                                                investments need to deliver operational ben-
                                                                efits and/or returns. ATM and more generally,

19
    For solutions in the R&D phase, this snapshot presents
the expected maturity date based on the best information
that is available to the SESAR JU at the time of writing this
document
18 | Fututre architecture of the European airspace – Transition plan

the aeronautics industry participate well in the   based on the standardisation roadmap from the
process of developing standards and making         SESAR framework, and inputs on the standard-
rules. Nevertheless, synchronisation and a co-     isation plans of its members (including the mil-
herent approach are necessary to ensure the        itary) and, where needed, other key players in
efficient convergence of regulations and ref-      aviation. The EASCG provides a forum to share
erenced standards and to support acceptable        and discuss standardisation matters between
means of compliance, to prevent regulation         its members to monitor the development of fit-
and standards from lagging behind technology       for-purpose standards.
and industrialisation, creating uncertainty and
delays. This ‘industrialisation gap’ is further    The standards identified so far are often used
explained in Appendix A.3.                         as means of compliance with the regulatory
                                                   requirements. What needs to be considered is
It is very important to identify the regulatory    the need for standards to support product de-
need for standards on a particular topic as ear-   velopment and procurement, which are also
ly as possible in the process, remembering that    important for supporting the implementation of
standards not only complement regulations but      SESAR R&D results and enabling accelerated
also provide an important performance refer-       market uptake.
ence, supporting industrialisation and imple-
mentation. In particular, a robust standards
framework will be essential to support the         4.3 Accelerating industrialisation
move towards service-based ATM provision, to       and market uptake through a
ensure that performance and safety expecta-
tions continue to be met.                          network of ‘digital European sky
                                                   demonstrators’
The provision of SESAR material as well as the
expertise and effort of the SESAR partners is
                                                   A key to success is the capability to provide a
critical in accelerating the standards develop-
                                                   framework and incentives for stakeholders that
ment timeline. An effective iterative approach
                                                   whet their appetite to move beyond the pre-in-
between pre-industrial development and inte-
                                                   dustrial development and integration (V3) and
gration (V3) and standards development needs
                                                   to aim for implementation (V5) and operation
to be found. The involvement of the wider ATM
                                                   (V6). The SESAR JU, Eurocontrol, standards de-
industry and other stakeholders through the
                                                   velopment organisations and EASA/EC should
standards process is necessary and important,
                                                   therefore cooperate closely for a seamless and
as not only the SESAR partners need to imple-
                                                   coordinated transition between these stages.
ment these solutions.
                                                   This would support the development of a stable
Once the need for standards and specifications     and predictable performance-based regula-
has been identified and the feasibility research   tory framework by EASA/EC, and the develop-
(V2) has been completed, then the planning for     ment of industry standards that will be avail-
the pre-industrial development and integration     able in good time. Efficient, effective and lean
(V3) activities in SESAR should be accompanied     processes should be used, not compromising
by a plan for standards development, as well as    in any way the high level of safety and quality
the expected interfaces between the two, i.e.      the aviation community expects. In this coop-
provision of draft and final SESAR material, ex-   eration, the need to develop regulations will be
pert involvement, and coordinated planning and     assessed and will follow the regulatory mecha-
decision-making.                                   nism described above.

The European ATM Standards Coordination            To support closing the industrialisation gap,
Group (EASCG) is a joint coordination and ad-      pioneering live operations with early movers
visory group established in 2015 to coordinate     should be started, aiming to build consensus
the ATM-related standardisation activities that    and gathering further evidence to determine
essentially stem from the European ATM Mas-        if regulation (or amendment of existing regu-
ter Plan, in support of Single European Sky im-    lations) is required. Periodic gap assessments
plementation. It has developed and maintains       should be performed to trigger specific ac-
an overarching European ATM standardisation        tions (research, regulation, standardisation or
rolling development plan (RDP). The RDP is         demonstration).
Measure 3 | 19

Consequently, central to the proposed measure        industrialised platforms (integrated with their
is the gradual establishment and scale-up of a       operational systems) will help to strengthen the
network of digital European sky demonstrators,       business case and is expected to increase the
targeting early movers to accelerate SESAR de-       buy-in from the community, sparking the inter-
livery. The network should become a forum to         est of stakeholders that were not involved in the
share knowledge on how to accelerate the tran-       earlier R&D. Thanks to this measure, all play-
sition towards a Single European Airspace Sys-       ers, including competent regulatory authori-
tem that fully leverages modern technologies.        ties, can mutually learn and exchange practical
It will focus on ‘flagships’ representing break-     expertise related to the introduction of the next
through technologies, starting with a focus on       generation of SESAR technologies. Synergies
virtual centres, dynamic airspace configuration      with the newly established airspace reconfigu-
and solutions boosting automation support that       ration and operational excellence programmes
are nearing maturity. Using the early movers’        will also be sought.

Figure 7: Roadmap: the gradual scale-up of a digital European sky demonstrators network (indicative)

5 Dependencies on actions within and
outside the scope of this transition plan
The Europe-wide harmonised implementation            The scope of this transition plan is limited to
of the AAS architecture requires many actions        the technical and operational aspects. In paral-
from many participants. The envisaged end re-        lel, regulatory aspects will be addressed under
sult can be achieved only if all actions are taken   the direct responsibility of the Commission ser-
in the right order. Not only is synchronisation      vices. This is illustrated in Figure 8.
between regulatory and technical/operational
development key, but also interdependencies
between various actions need to be respected
within the technical/operational development.
20 | Fututre architecture of the European airspace – Transition plan

Figure 8: A coherent stepwise transition

Once all measures are in place, the Eu-            The key dependencies are the following:
rope-wide implementation of fully interop-
                                                      • appropriate decisions taken on the im-
erable air traffic management data service
                                                        plementation of Measure 3, affecting
providers (ADSPs) is enabled. The result is a
                                                        actions beyond the current SESAR 2020
potentially substantial reduction in the num-
                                                        programme, with particular attention to
ber of different FDP systems, making the last
                                                        governance and funding arrangements;
technical and operational innovation actions
much more cost-efficient than the fragment-           • the timely set-up of an enabling frame-
ed situation we have today, and facilitating the        work for ADSPs and capacity-on-de-
implementation of:                                      mand services, focusing on incentivisa-
                                                        tion, including rewards for early movers,
   • advanced ATC automation
                                                        charging and certification;
   • dynamic cross-border sectorisation
                                                      • the timely set-up of an appropriate man-
   • capacity on demand.                                agement process (including, for exam-
                                                        ple, the designation of a project man-
The proposed lines of actions and decisions             ager), without which potential risk could
depicted in the three measures depend on a              be incurred, resulting in the suboptimal
number of prerequisites related to the regula-          achievement of the transition plan.
tory framework and aspects of service provi-
sion, which need to be addressed at European       Details on these dependencies and risk will be
level.                                             found in Appendix A.6 and Appendix B respectively.
Appendix A: Roadmaps | 21

Appendix A: Roadmaps
A.1 Overall logic
Figure 9 is a simplified illustration of the over-      between airspace design and technological
all logic for new actions to be undertaken to           enablers should be achieved by capturing syn-
set the implementation of the AAS in motion. It         ergies between the proposed implementation
emphasises that, in addition to the critical im-        of the new programmes (Measure 1) and the
plementation for mature SESAR Solutions and             launch of a network of demonstrators to accel-
prerequisites (Measure 2), a strong coupling            erate market uptake (Measure 3).

Figure 9: Roadmaps: the overall logic

A.2 Short-term implementation measures addressing hot spots
Measure 1 of this transition plan requires that a       have to be seen together with the planned roll-
number of short-term measures be implement-             out of mature SESAR Solutions identified in the
ed, first focusing on the hot spots identified as re-   European ATM Master Plan in the period 2020-25
quiring immediate action, but also throughout the       (Measure 2), all of which have well defined road-
entire ECAC European airspace, the final imple-         maps and implementation milestones.
mentation deadline being 2025. These measures
22 | Fututre architecture of the European airspace – Transition plan

Table 2: Short-term implementation measures roadmap

 When        What                                            How
 2019        NM and operational stakeholders best efforts    NM prepares to launch an EU-wide airspace
             on ‘7 Measures for 2019’                        reconfiguration  and       operational     excellence
                                                             programme with an initial focus on 10 hot spots

 2020        NM and operational stakeholders — initial delivery NM to launch and monitor with ANSPs, addressing
             of airspace reconfiguration and operational measures related to airspace design and operational
             excellence programme in 10 hot spots               excellence
 2021        NM and operational stakeholders —airspace       NM continues and monitors the initiatives with ANSPs,
             reconfiguration and operational excellence      addressing measures related to airspace design and
             programme in 10 hot spots — delivery            operational excellence
 2022        NM and operational stakeholders — airspace      NM continues and monitors the initiatives with ANSPs,
             reconfiguration and operational excellence      addressing measures related to airspace design and
             programme at network level — initial delivery   operational excellence, with enhanced focus on cross-
                                                             border implementation
 2023        NM and operational stakeholders — airspace      NM continues and monitors the initiatives with ANSPs,
             reconfiguration and operational excellence      addressing measures related to airspace design and
             programme at network level — delivery           operational excellence, with enhanced focus on cross-
                                                             border implementation
 2024/2025   NM and operational stakeholders — airspace      Finalisation of the airspace reconfiguration programme
             reconfiguration and operational excellence      and operational excellence projects; NM initiates
             programme at network level — delivery           dynamic airspace management with virtualised
             NM and operational stakeholders — dynamic       platforms
             airspace management with virtualised network
             platforms initial implementation

A.3 The industrialisation gap
Successful development of a system depends              ATM R&D collaborative projects. It provides a
on implementing adequate methods to ensure              common reference for the assessment of con-
that the planned system is achievable and will          cept maturity and the management of concept
be fit for purpose.                                     development transitions from R&D through
                                                        industrialisation to implementation. Figure 10
The European Operational Concept Validation             provides an overview of the whole life cycle of
Methodology (E-OCVM) is applied in the European         ATM concepts.

Figure 10: The E-OCVM life cycle

Currently SESAR solutions are handed over to            composed of a set of operational and technical
the industry at a V3 maturity level. The hando-         requirements, including their validation re-
ver material, used to make decisions concern-           sults, covering, for example, performance as-
ing transition to implementation, is essentially        sessments.
You can also read
